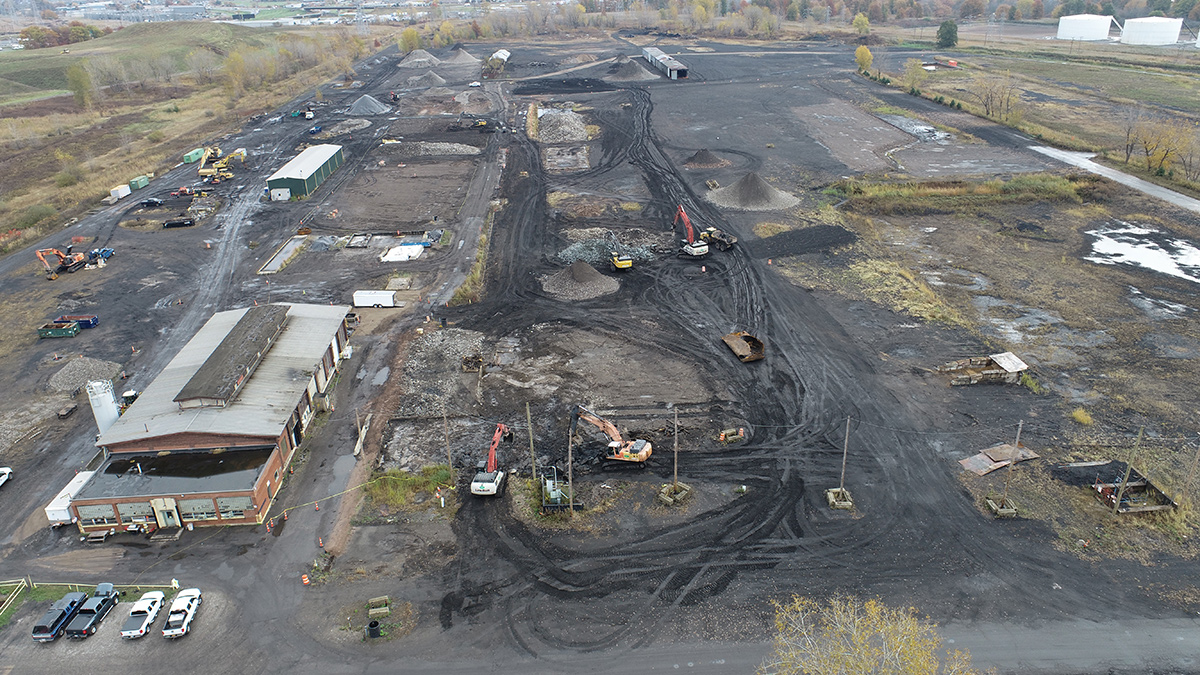

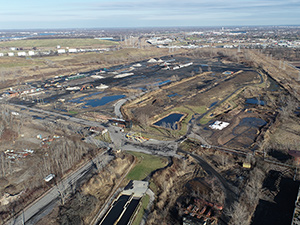

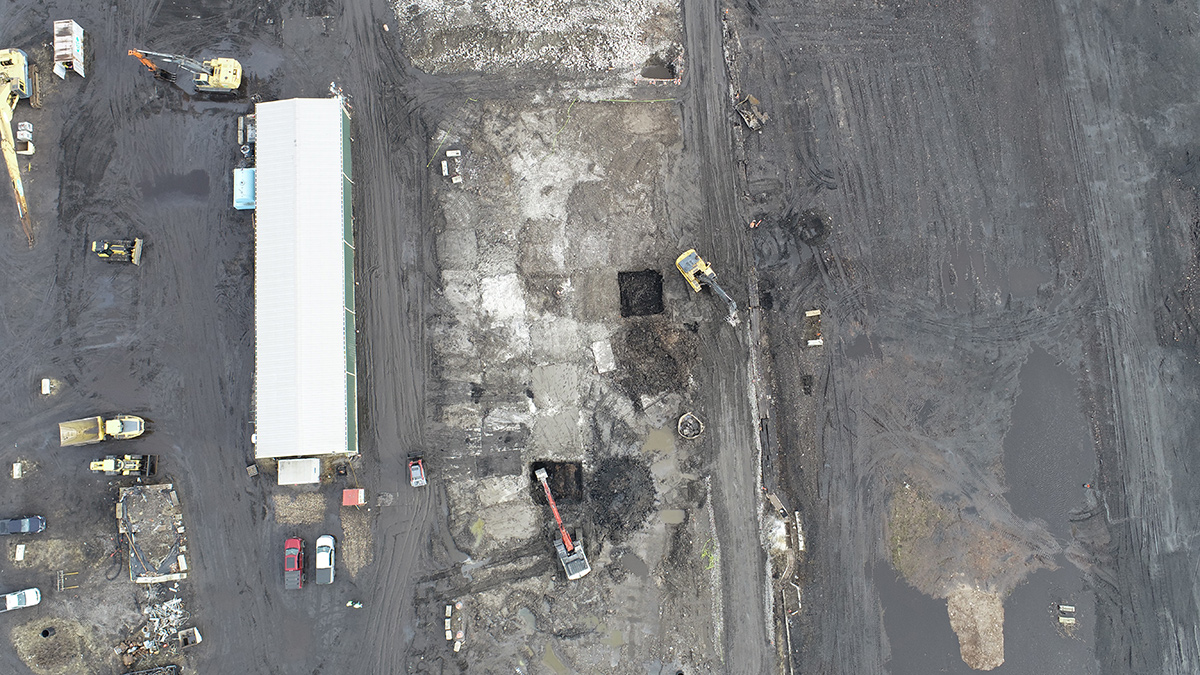

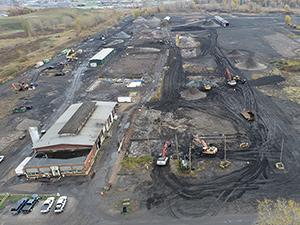

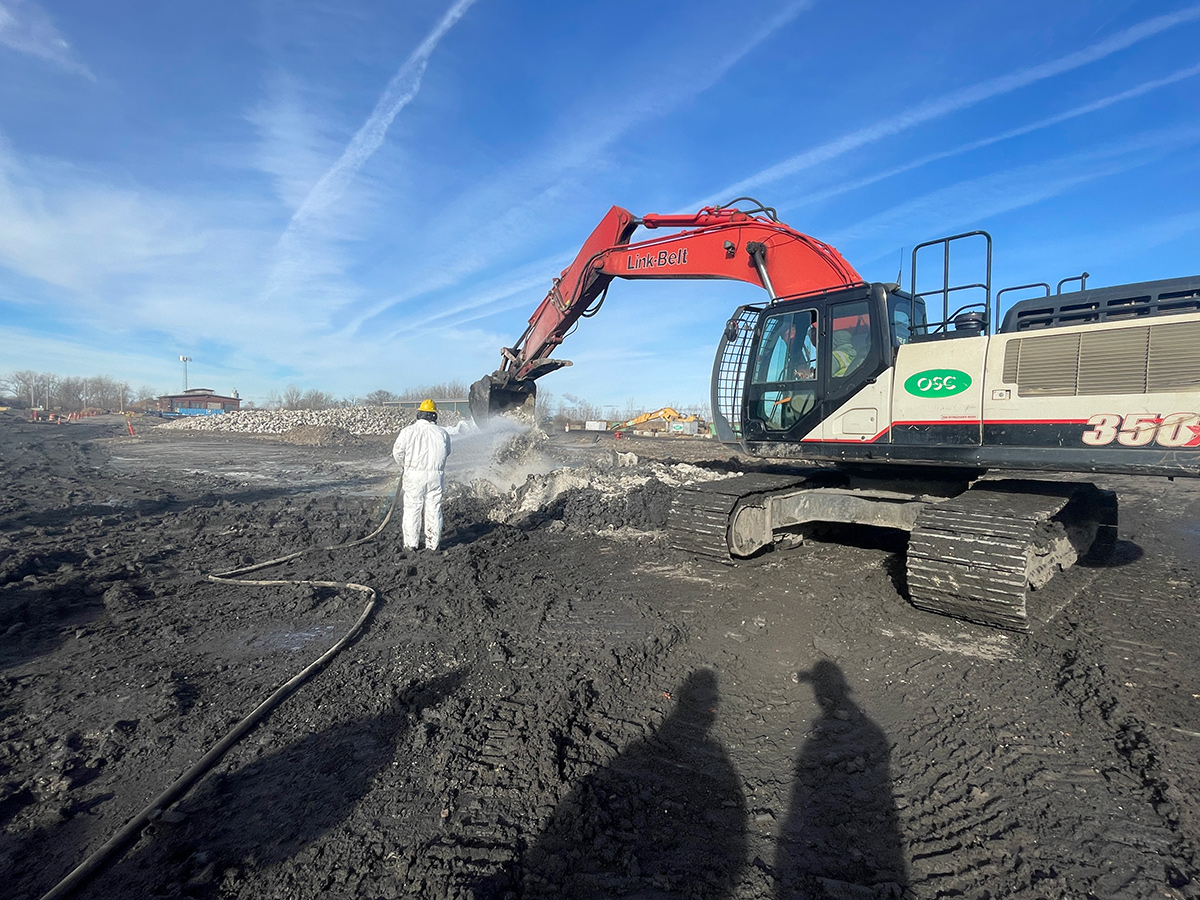

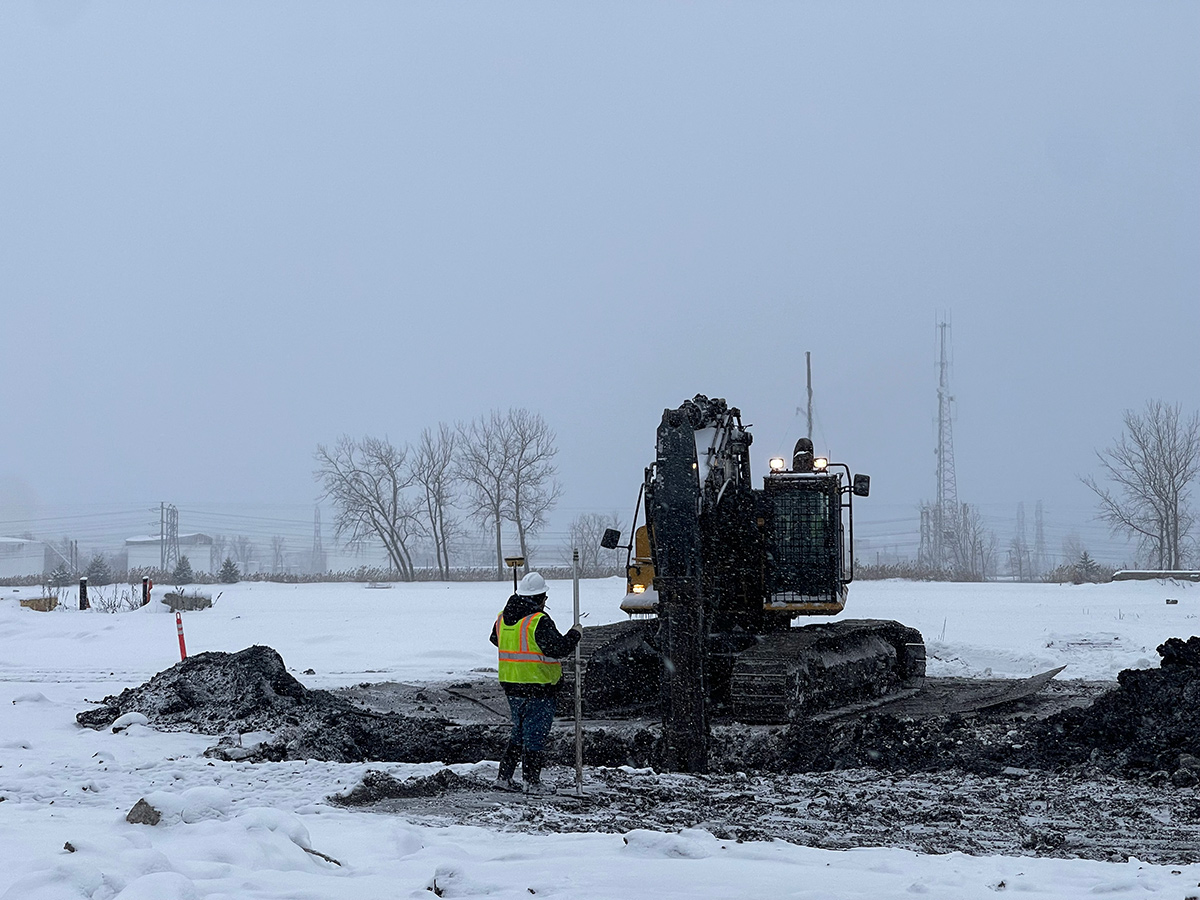

Jaunary 2024 - Solidification, Former Exhauster Building Area
December 2023 - Site from Southwest
November 2023 - Dust Control

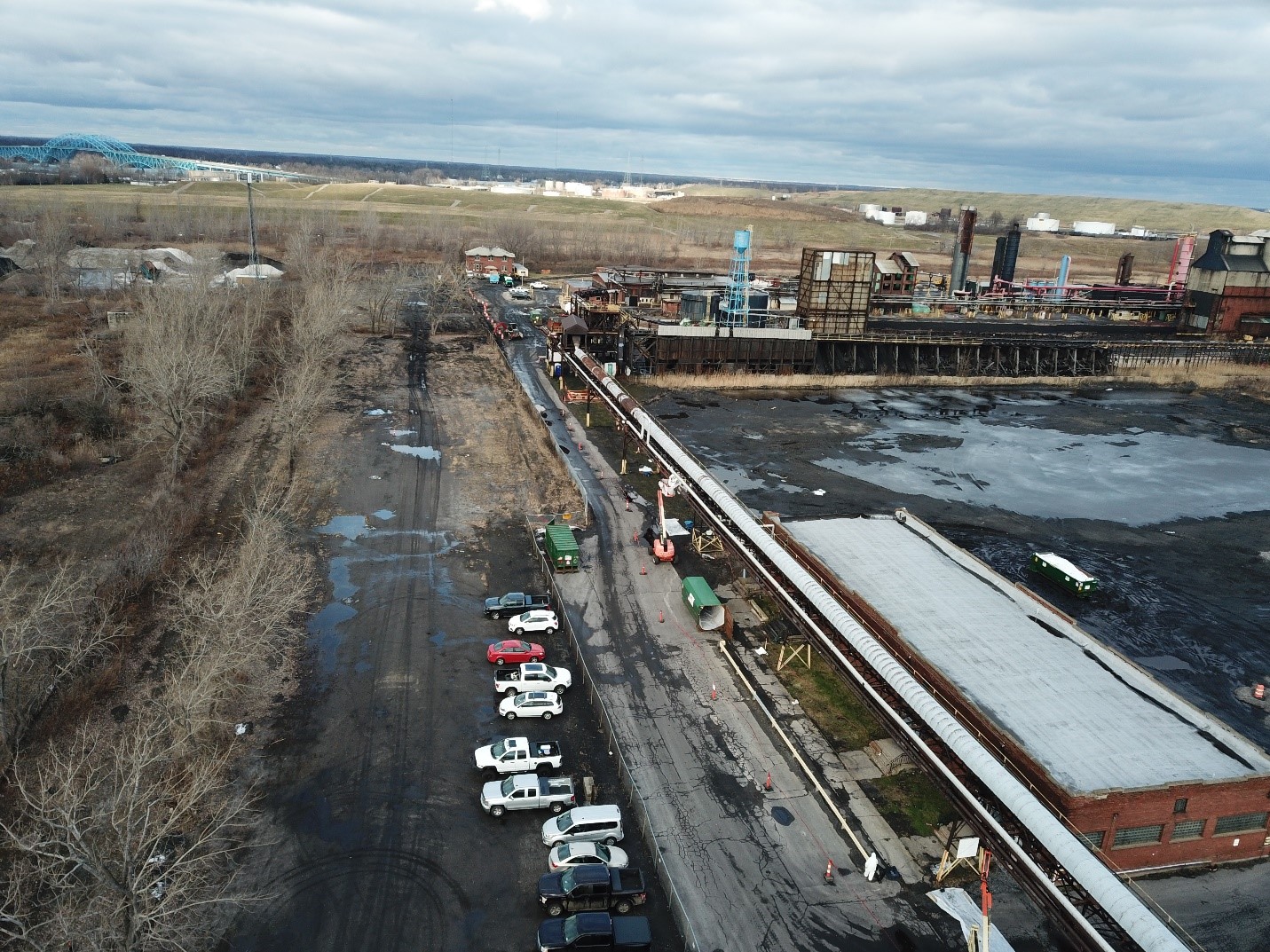

October 2023 - Preparation of Production Area

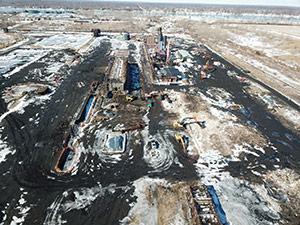

February 2022 - Production Area

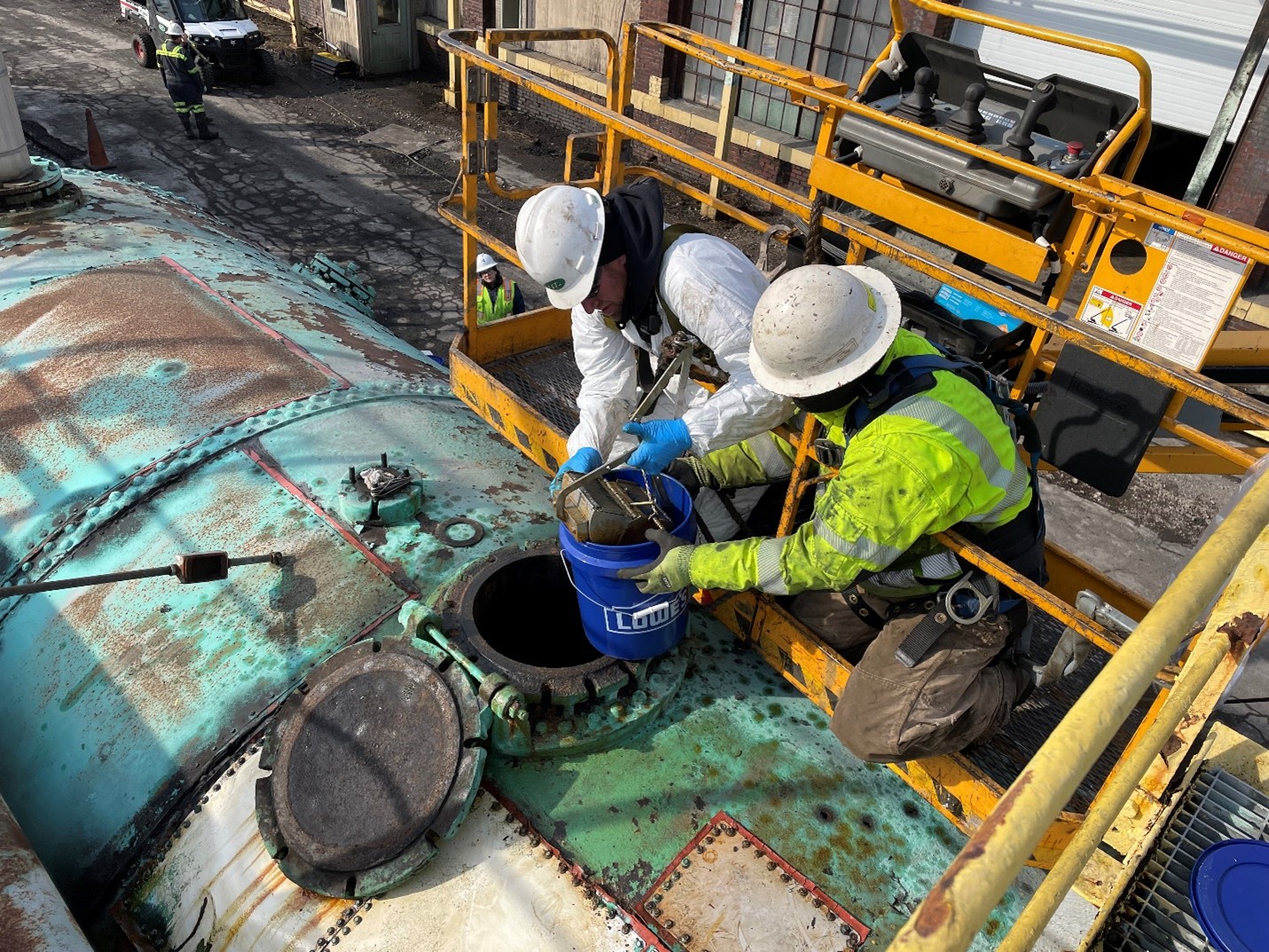

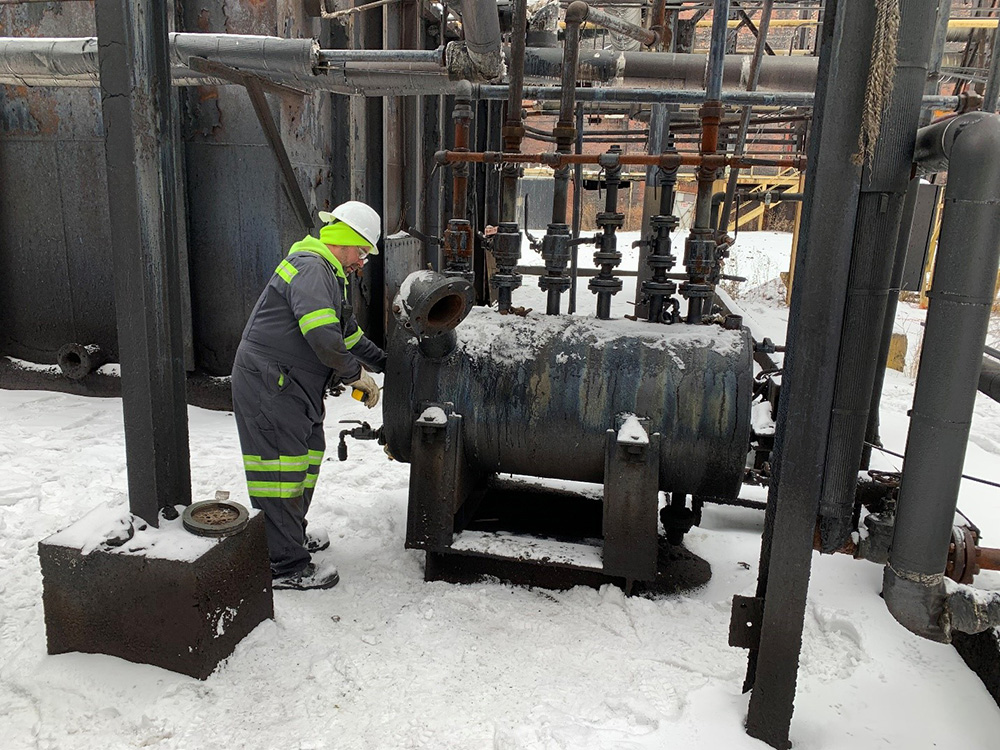

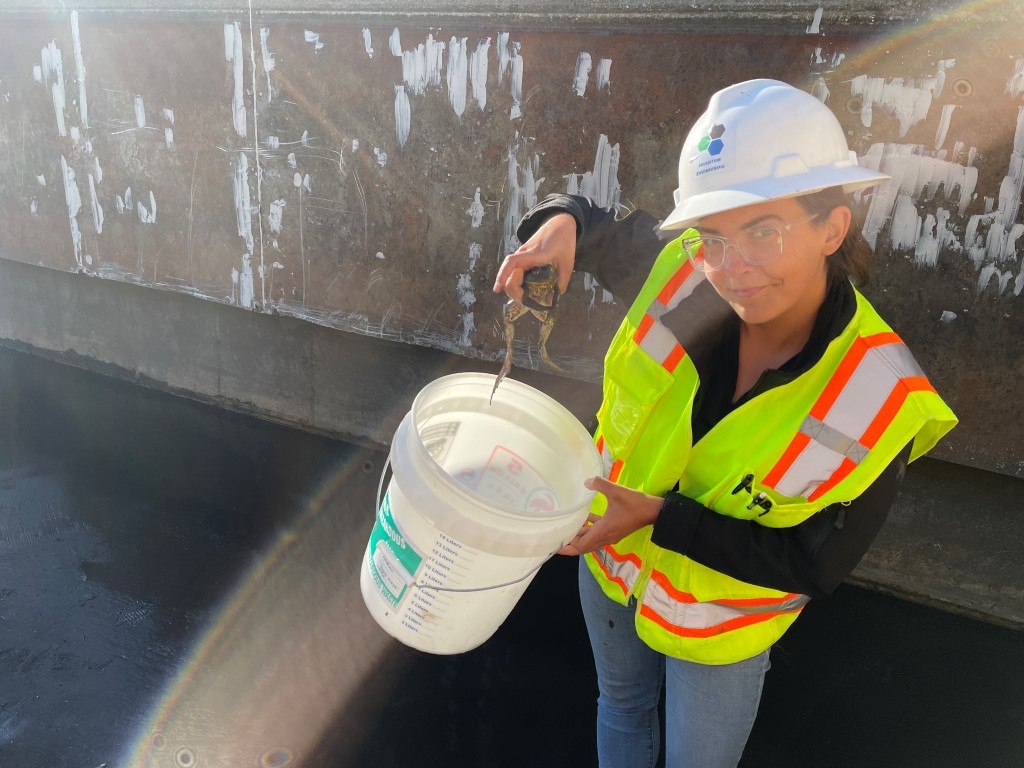

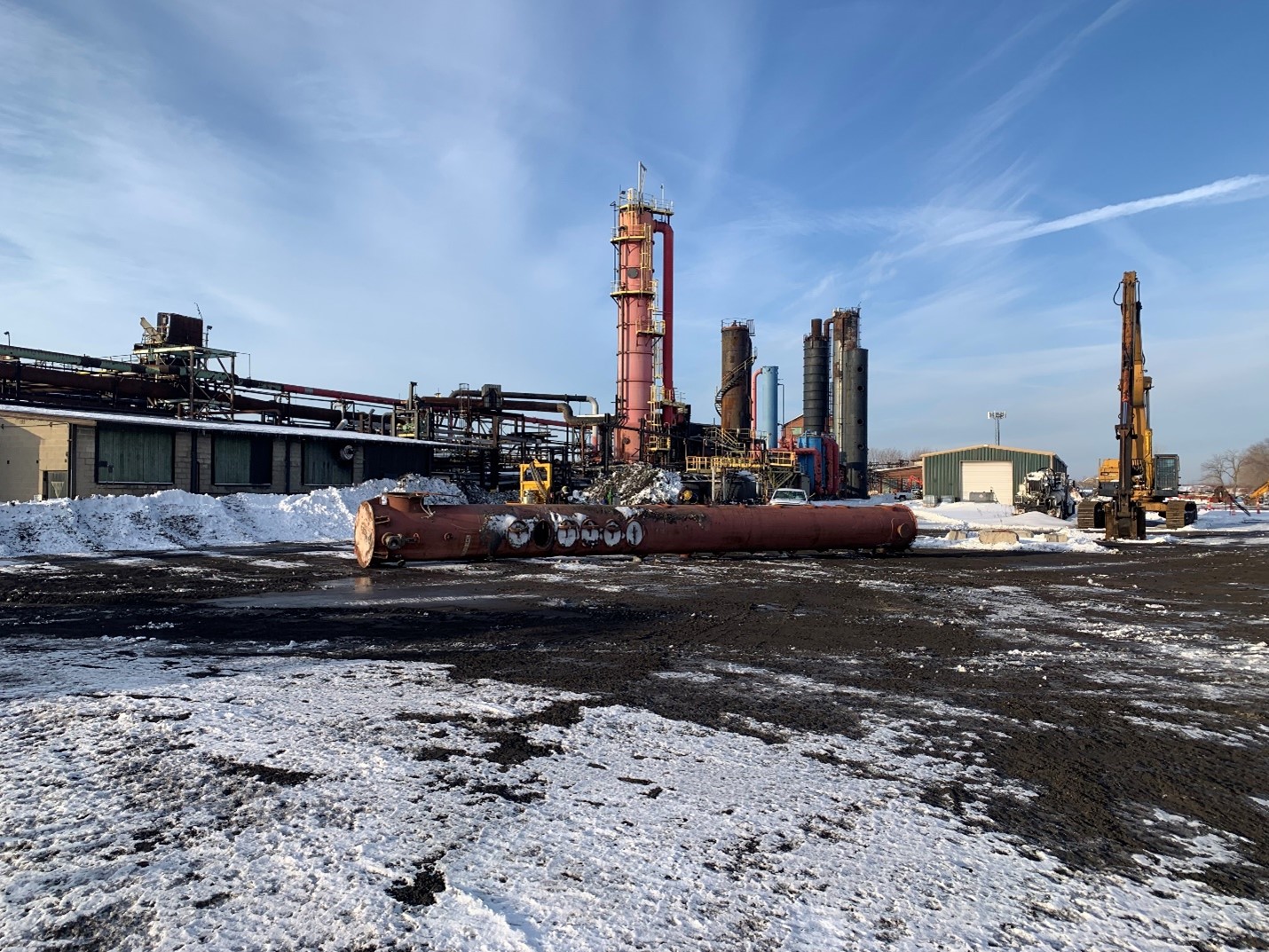

February 2022 - Testing for waste disposal parameters

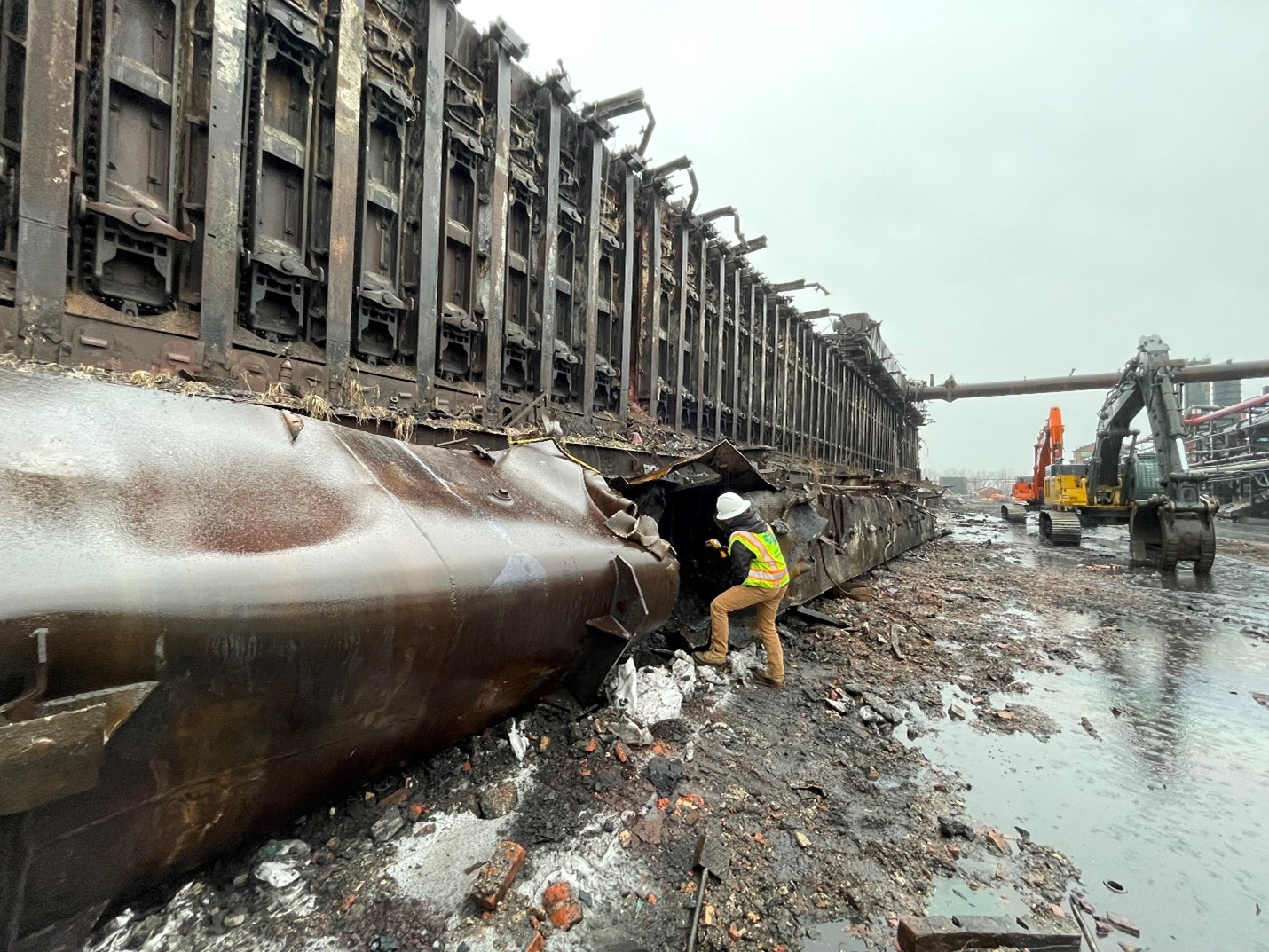

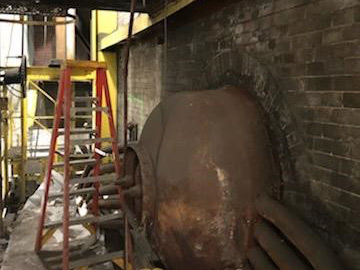

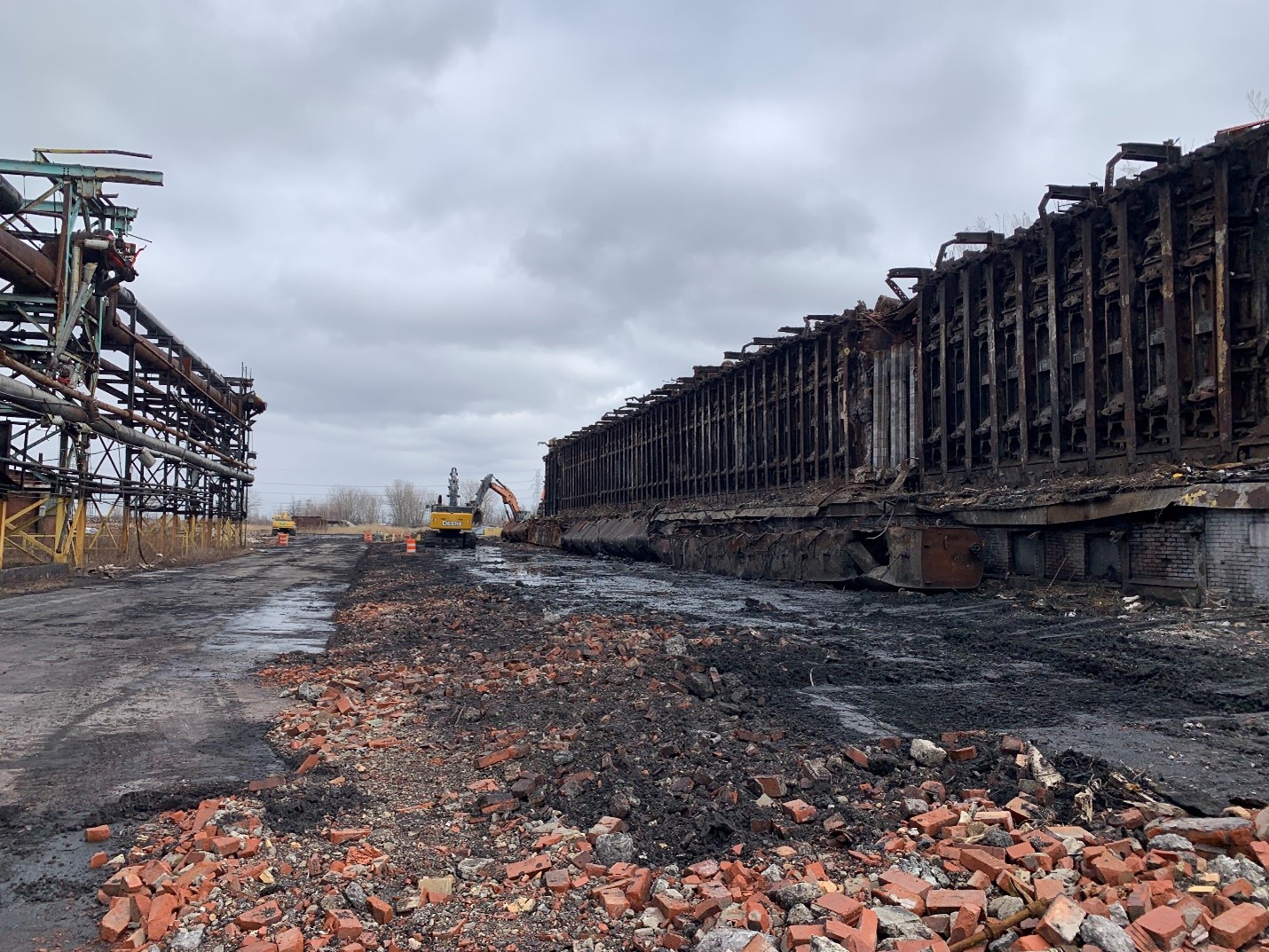

February 2022 - North Side of Battery after successful removal of crossover pipes and collection mains
February 2022 - Inspection - East Collector Main after removal

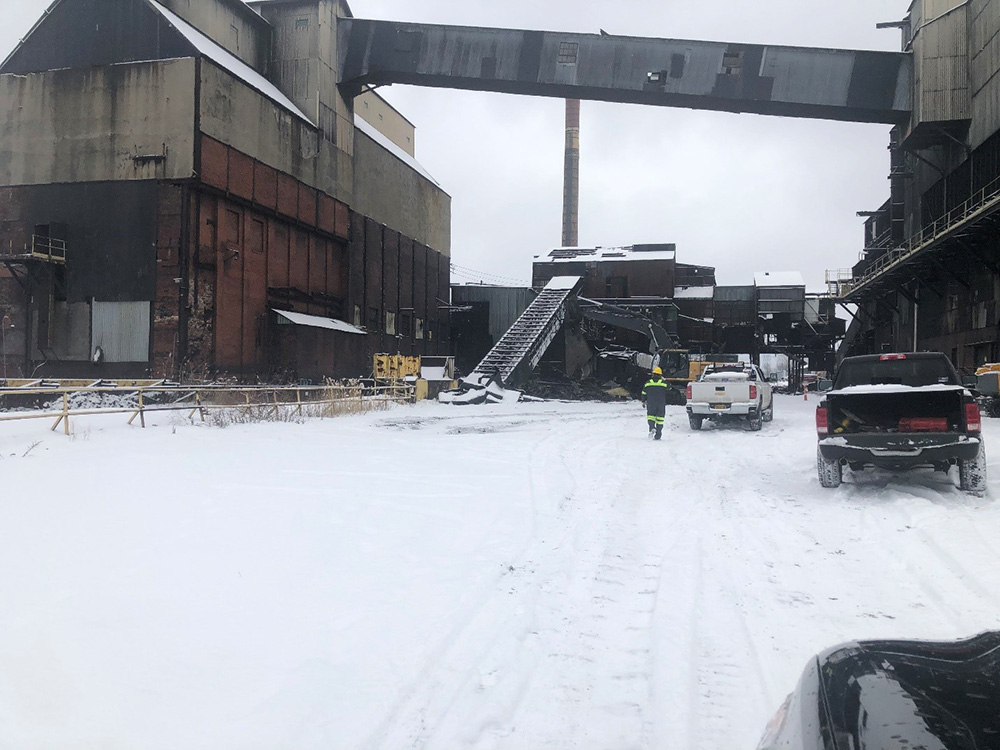

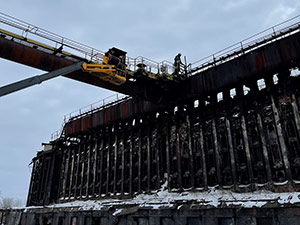

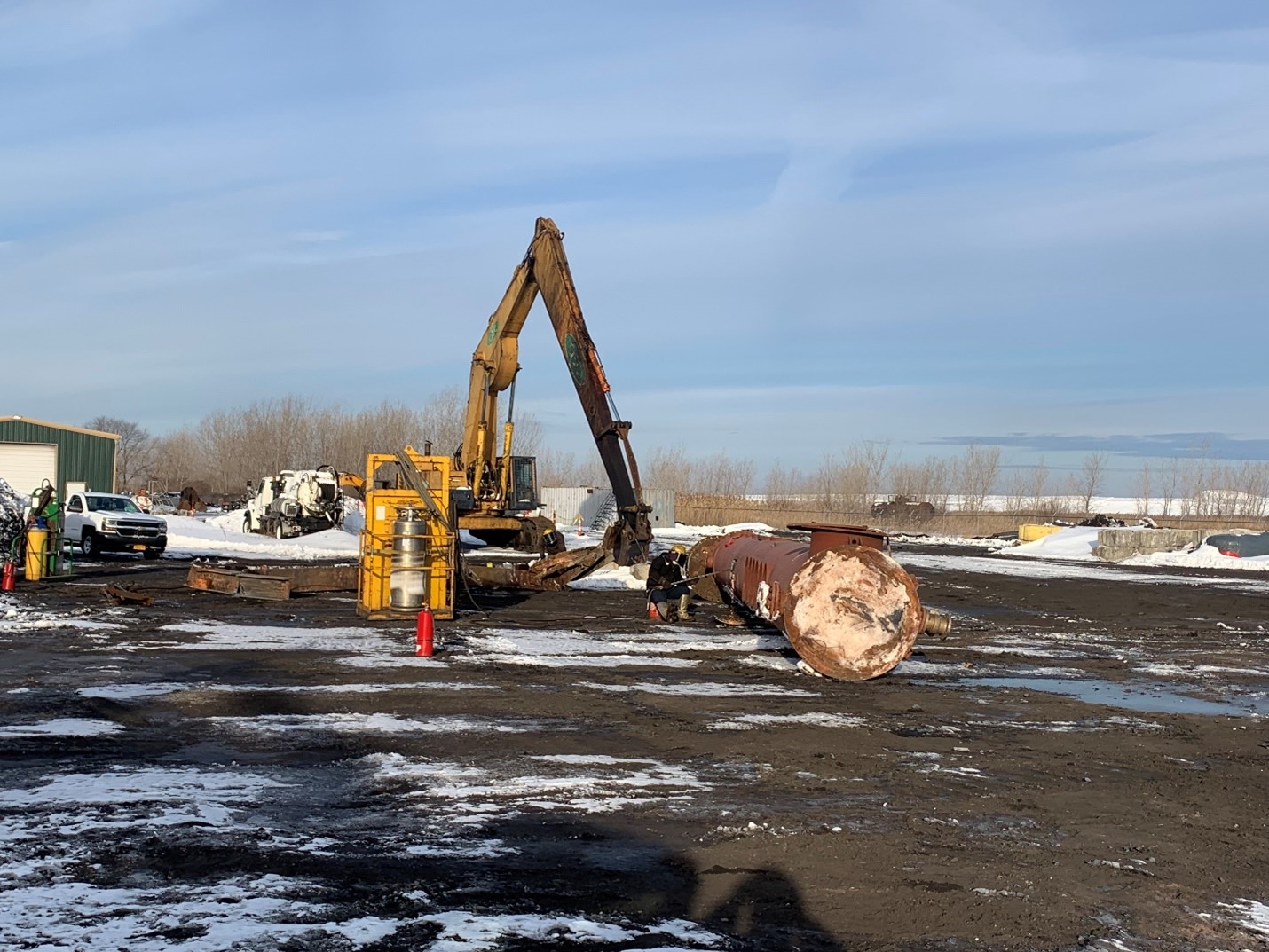

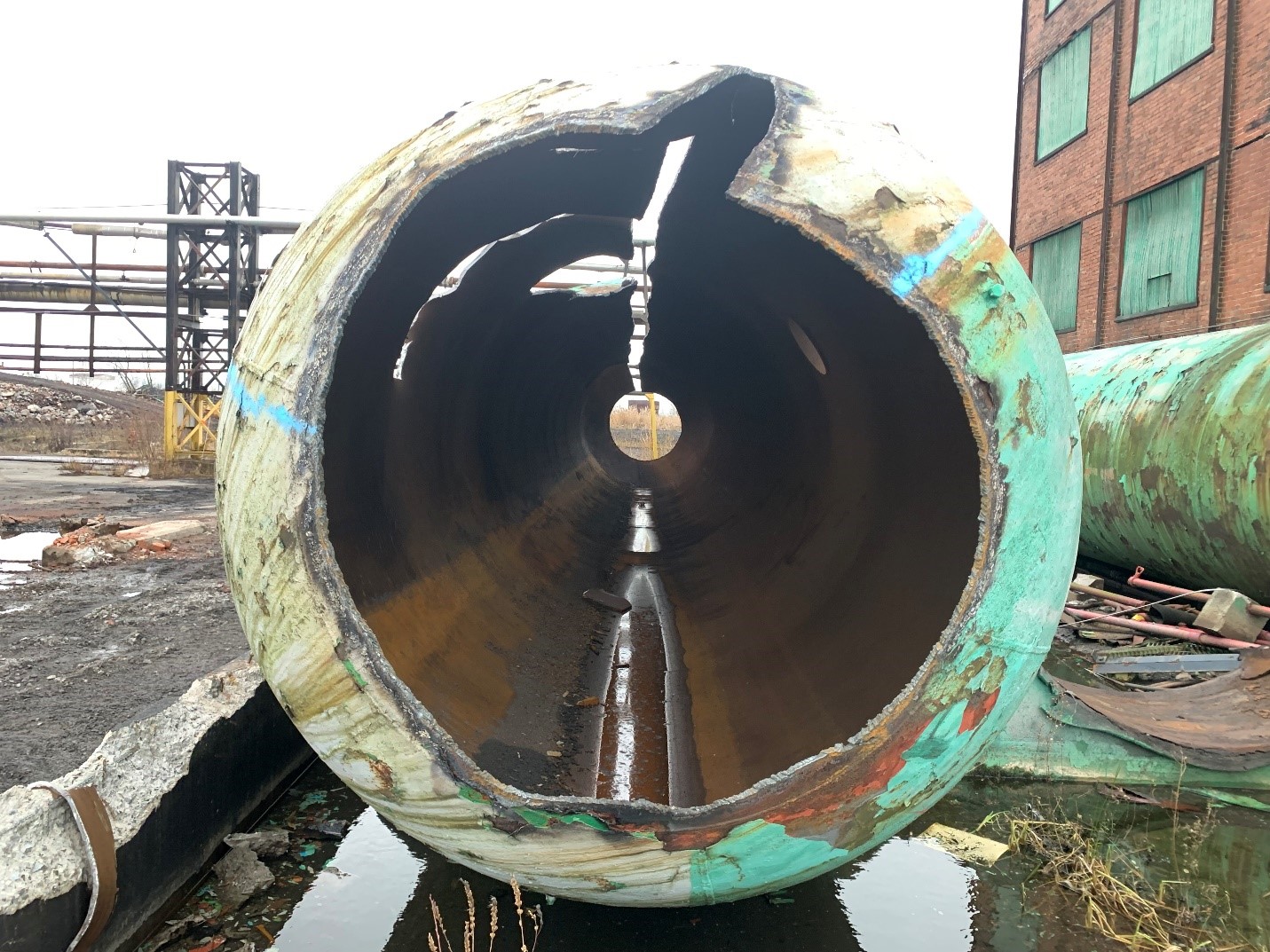

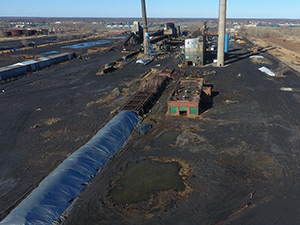

February 2022 - East cross over pipe removal

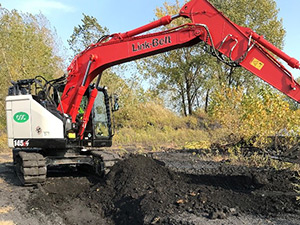

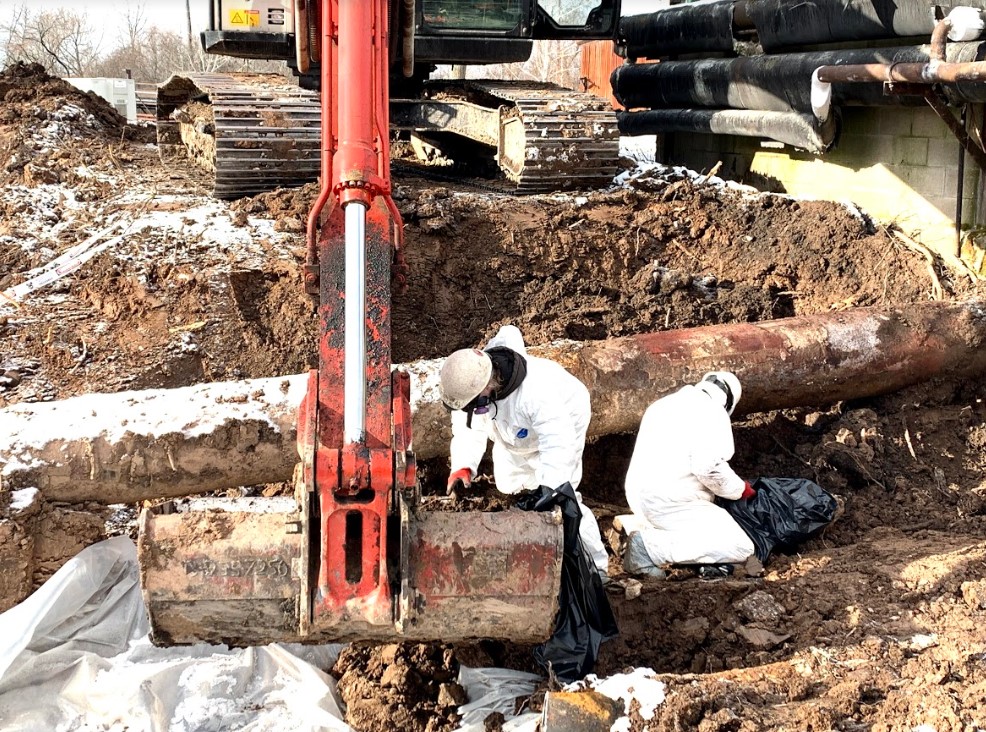

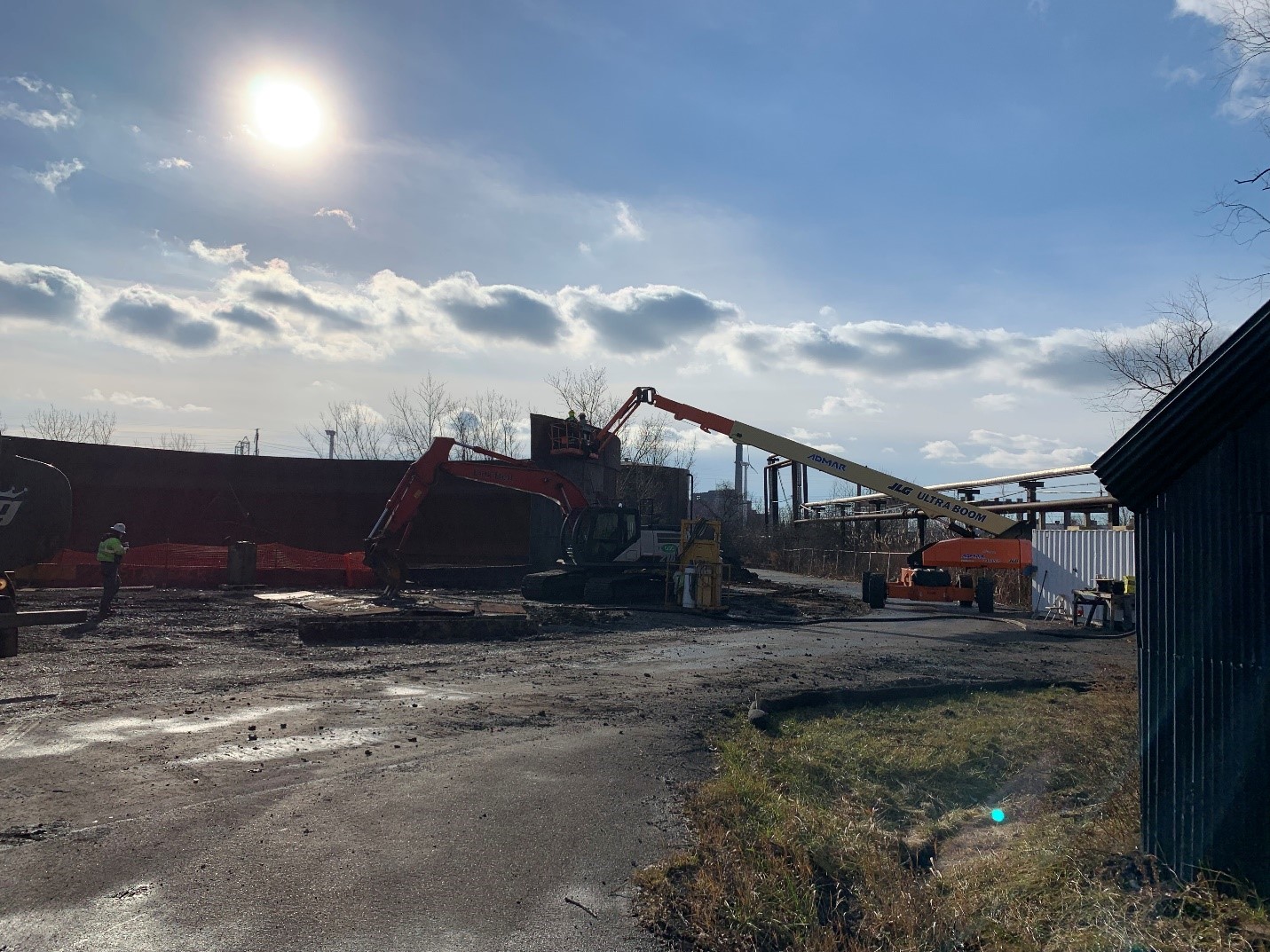

February 2022 - Liquor line removal
February 2022 - Preparing crossover pipes for removal
February 2022 - Preparing crossover pipes for removal
February 2022 - Conveyance line installation northest of manifold
February 2022 - The groundwater manifold at the former maintenance building
February 2022 - Preparing Lime Still for recycling
February 2022 - Lime Still following removal and decontamination

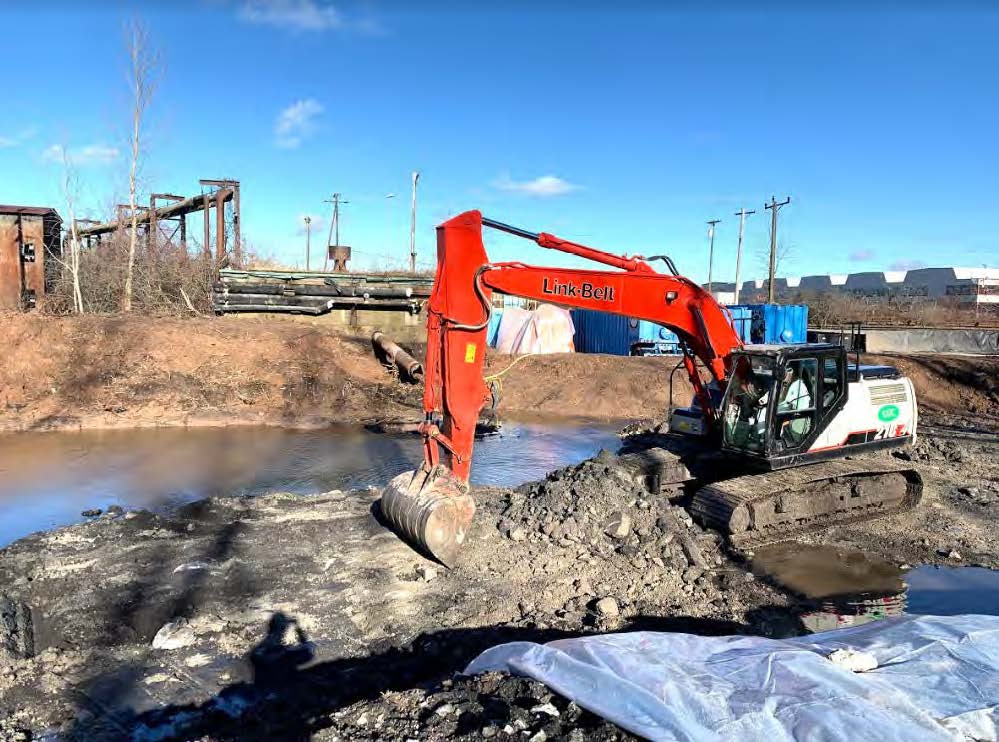

February 2022 - Preparing Quench Pit for COG Pipe
December 2021 - The Site Crew

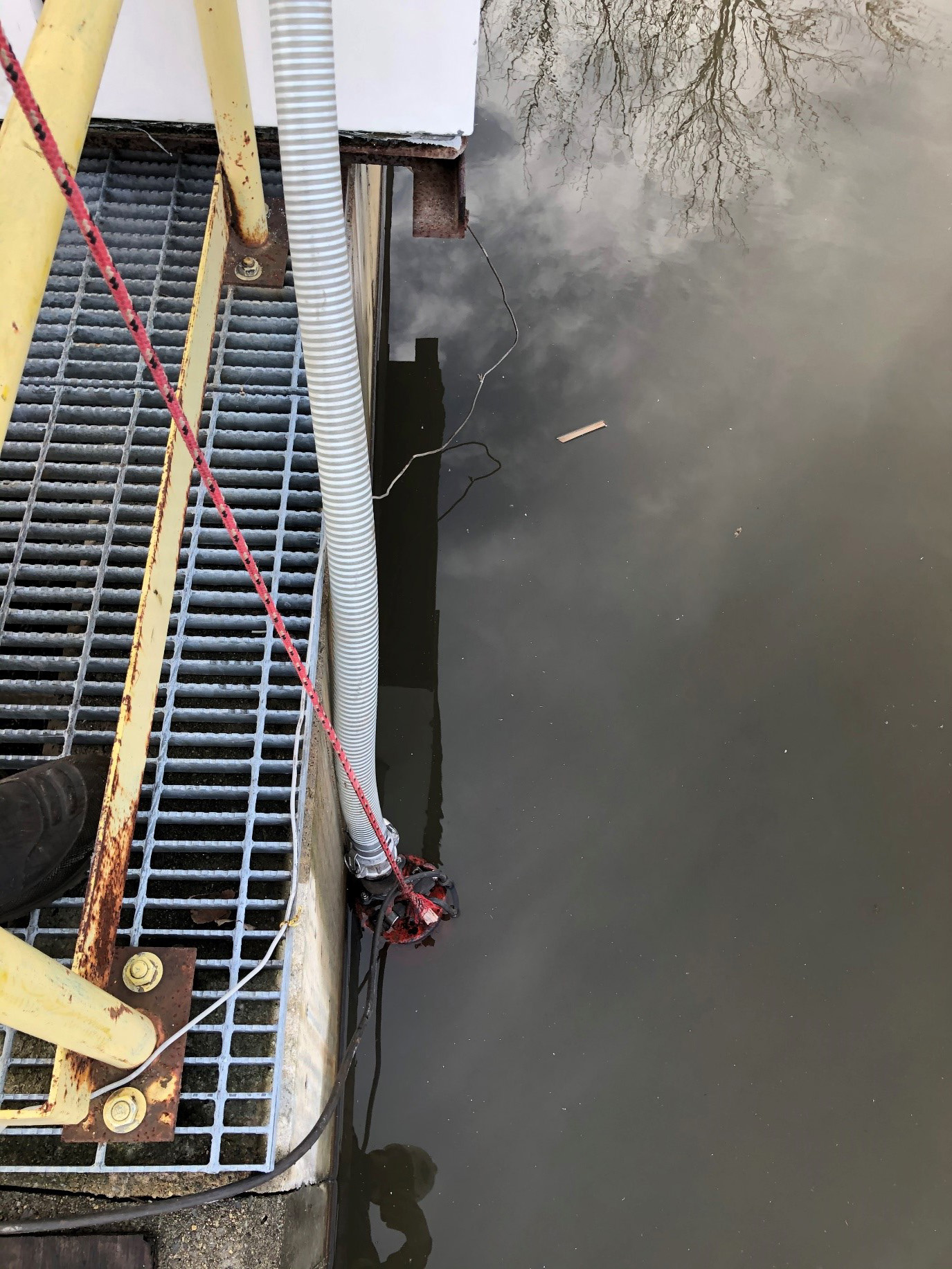

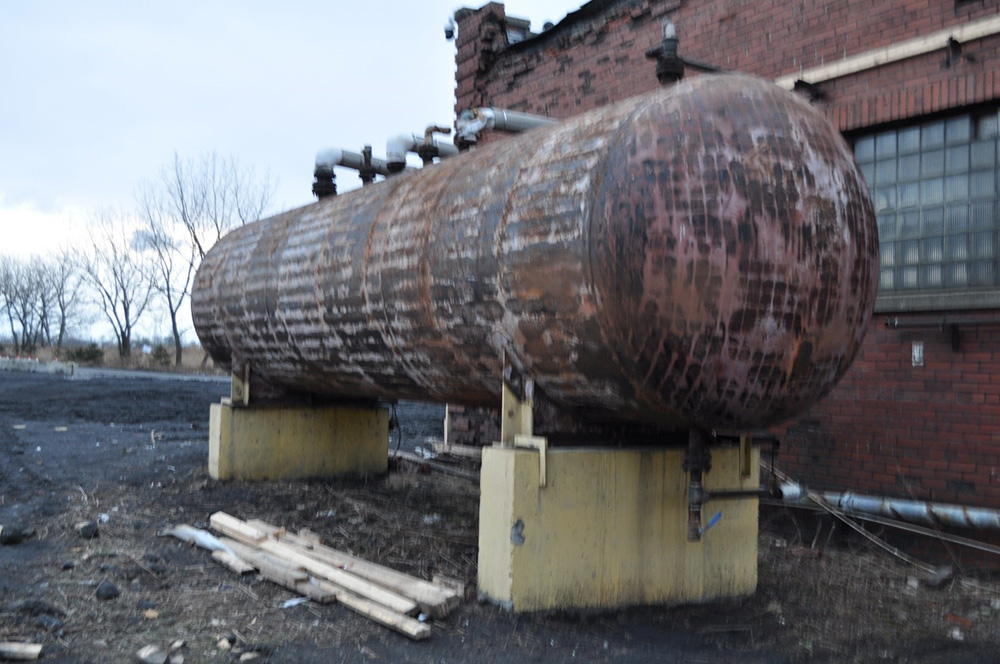

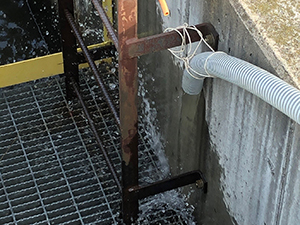

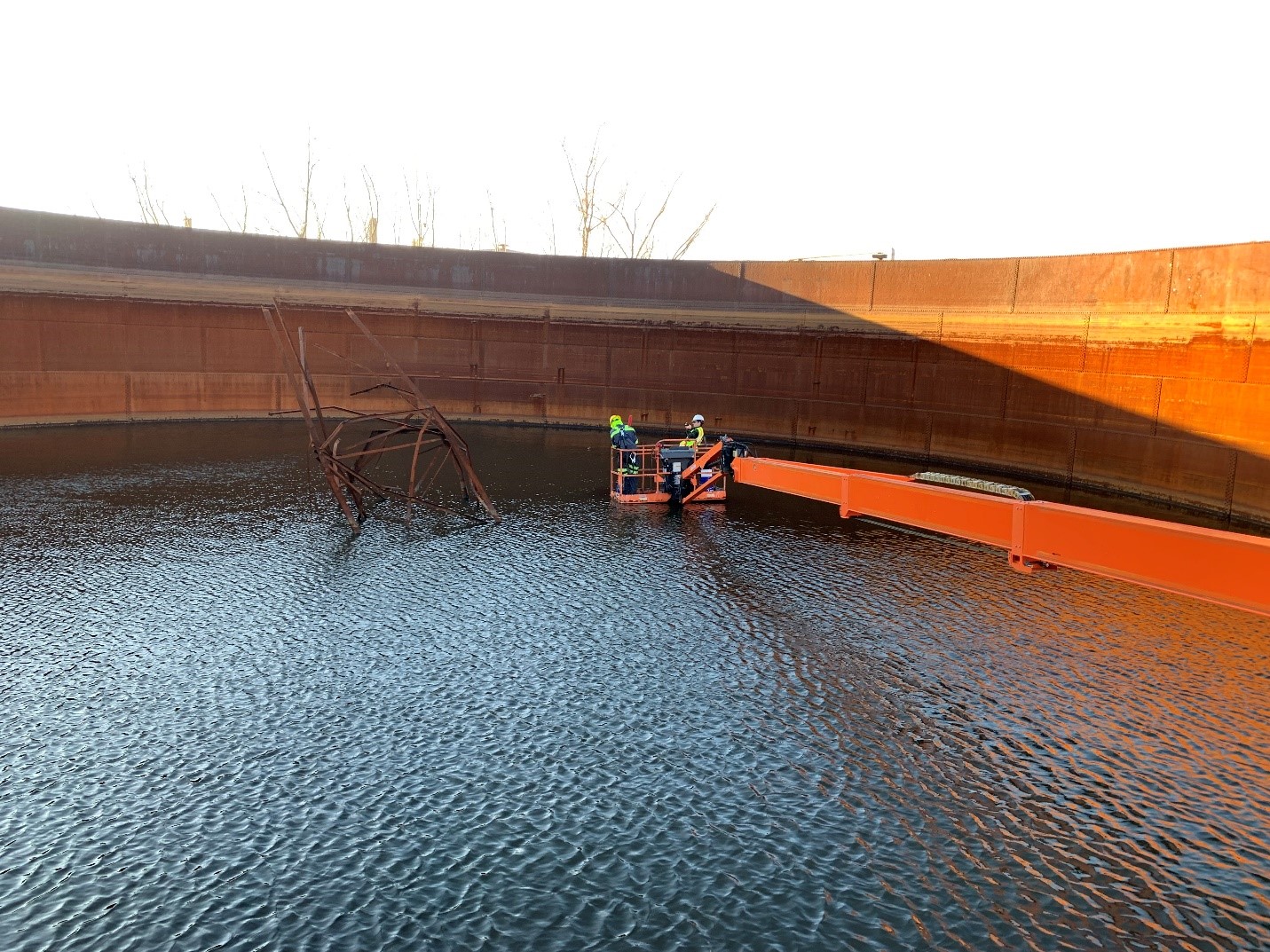

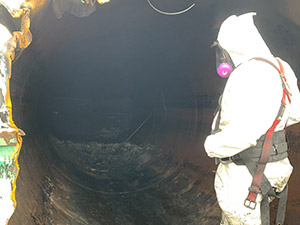

December 2021 - Water treatment equipment - Quench Sump

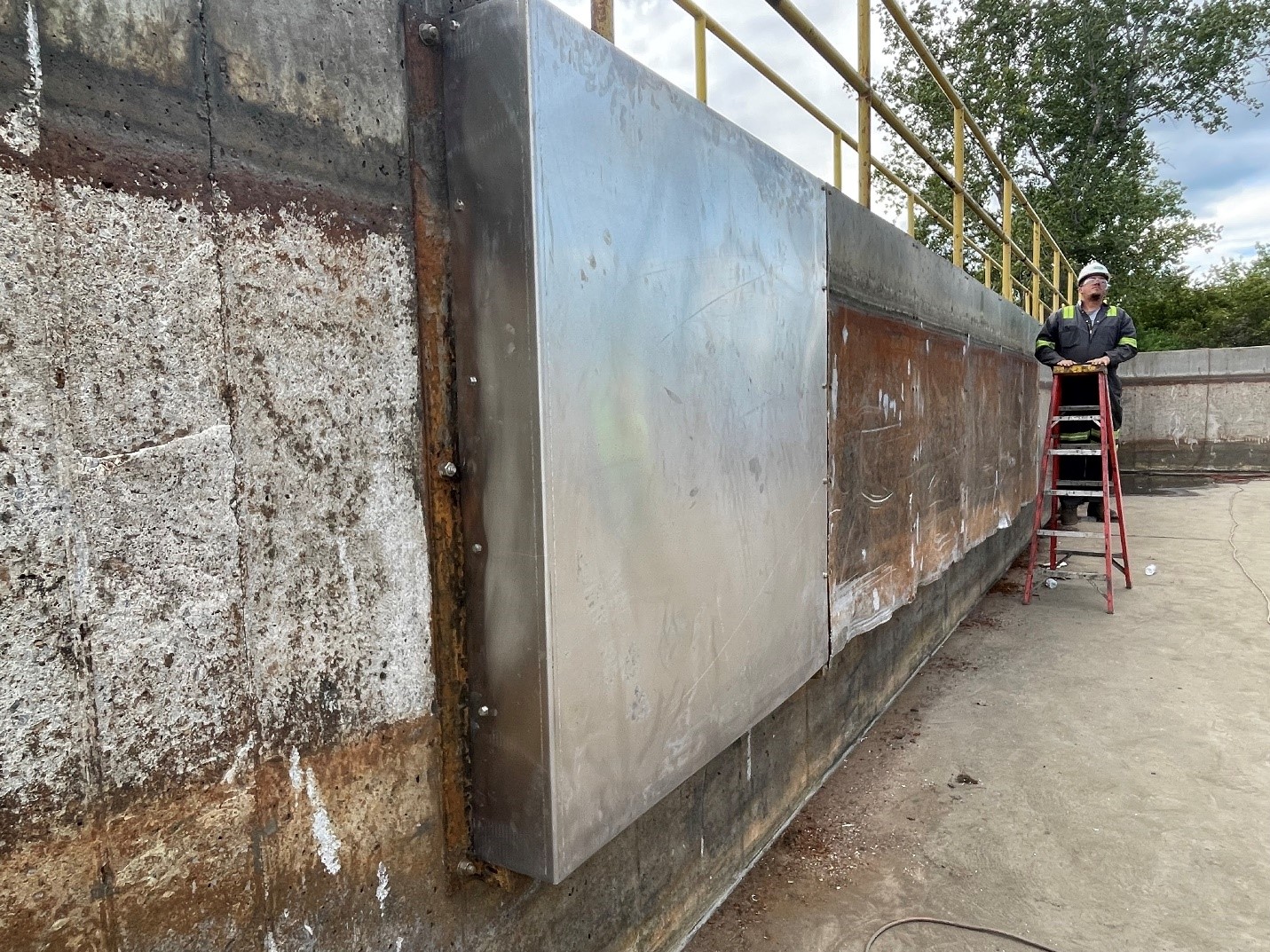

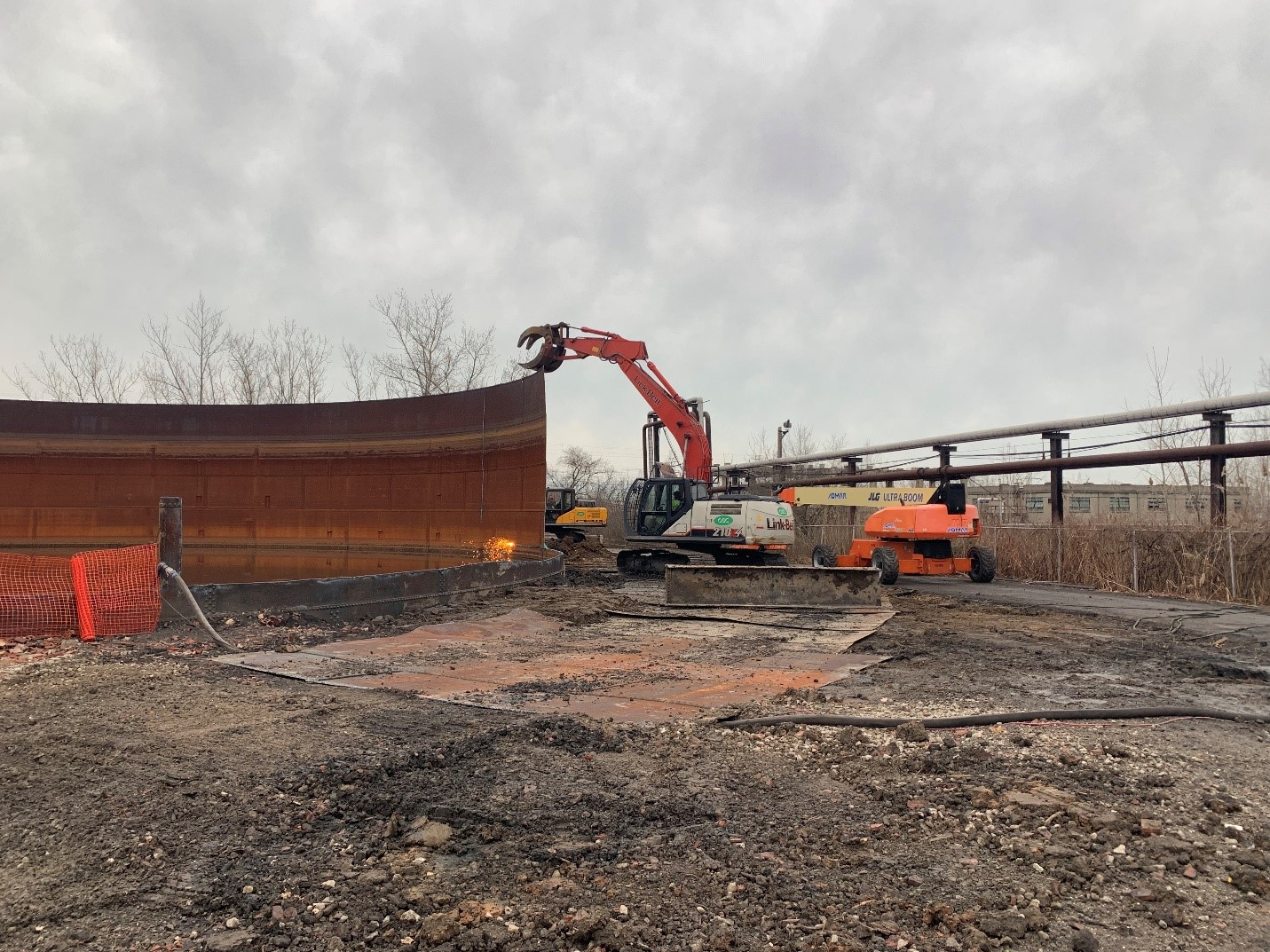

December 2021 - Wall removal - former Wastewater Tank
December 2021 - Wall removal - former Wastewater Tank

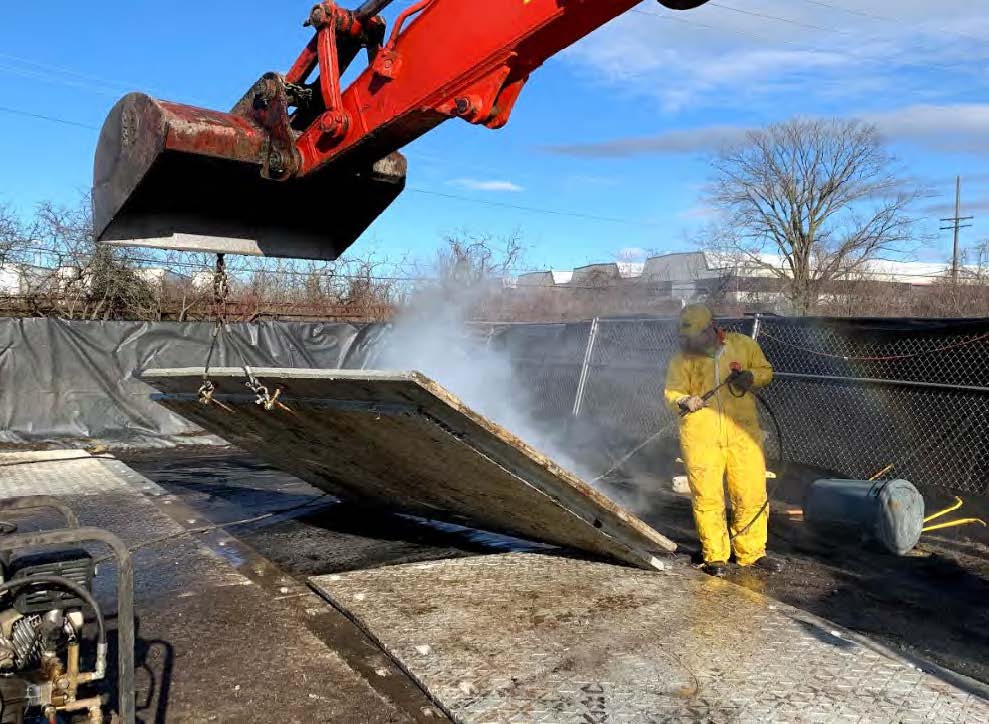

December 2021 - Decontamination - Muck Tank
December 2021 - Stabilized sample preparation

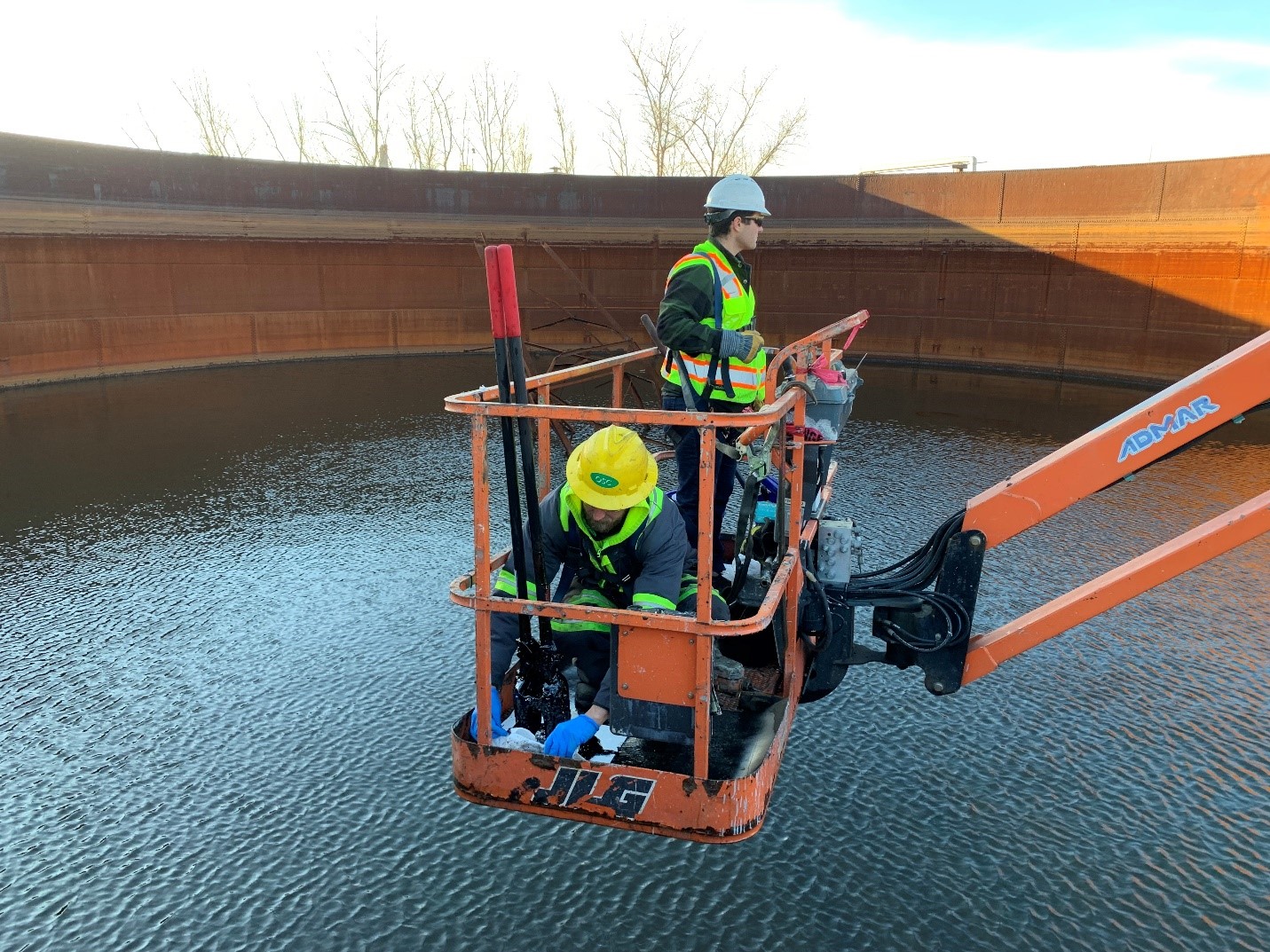

December 2021 - Sludge sampling inside Wastewater Treatment Tank
December 2021 - Sludge sampling inside Wastewater Treatment Tank
December 2021 - Decontaminated tank - Prepared for disposal as ACM
December 2021 - Safety zone around Boiler Bay removal
December 2021 - Separating Boilers - Boiler House

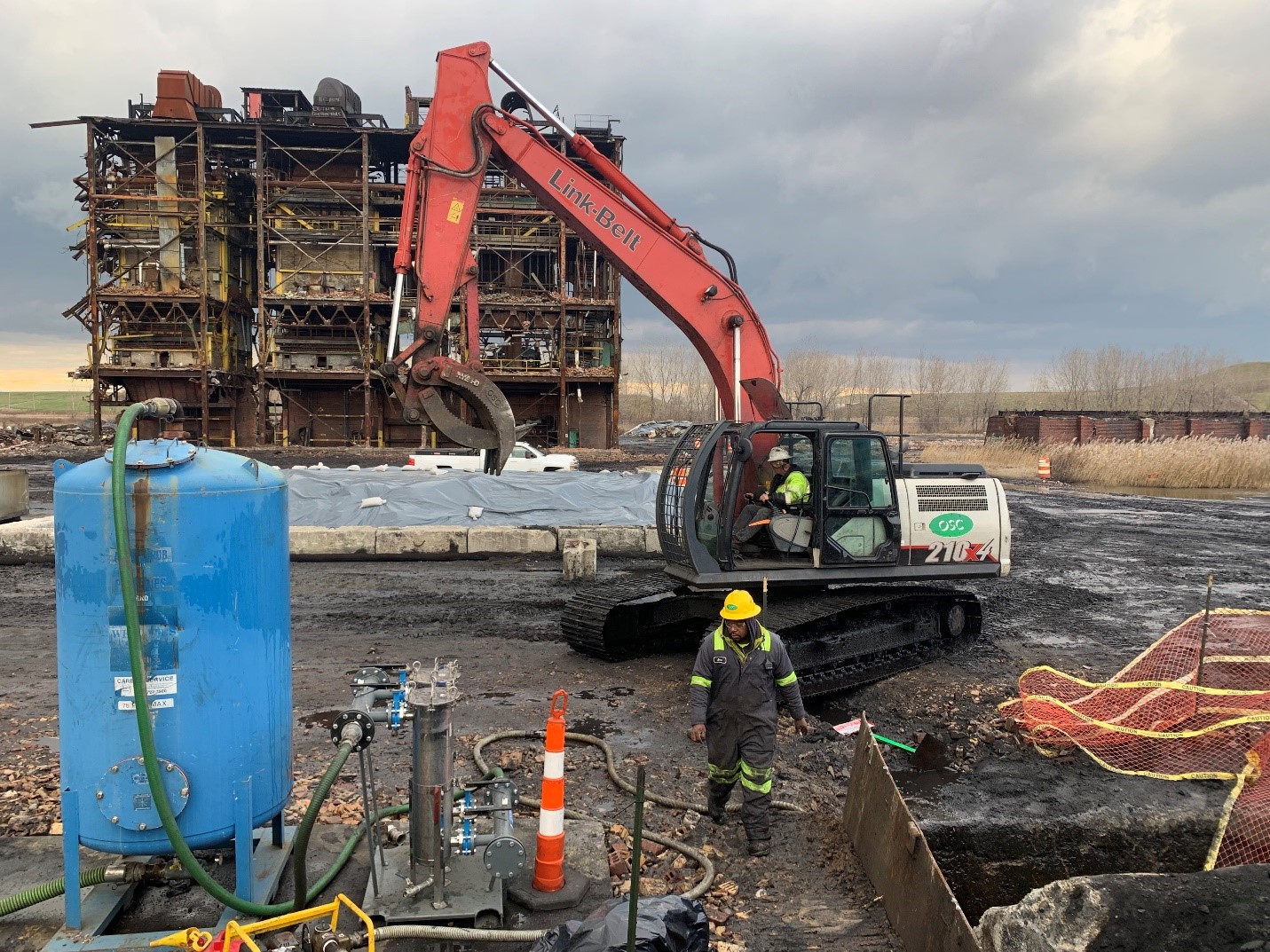

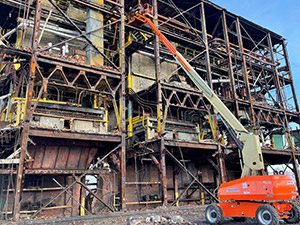

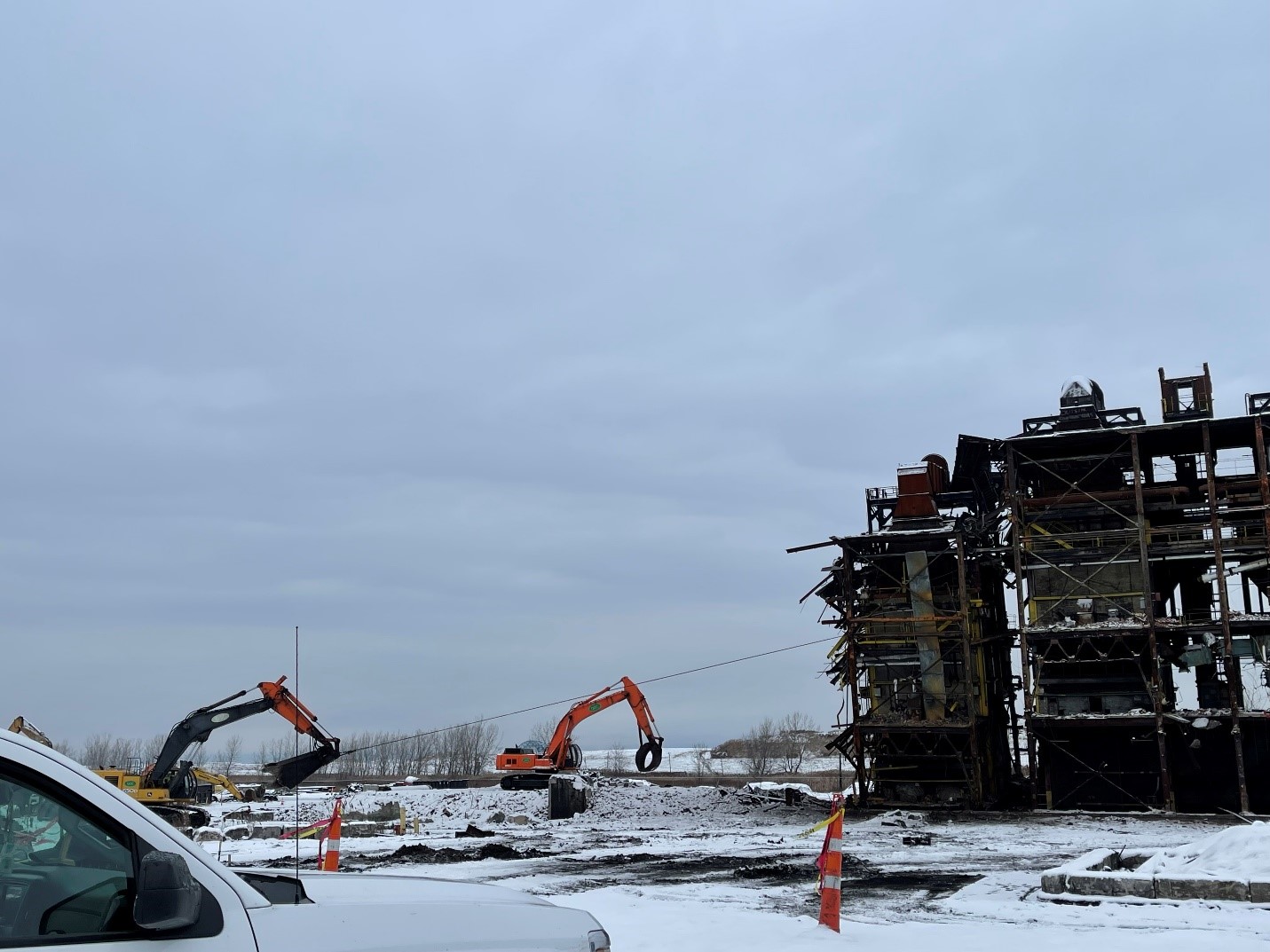

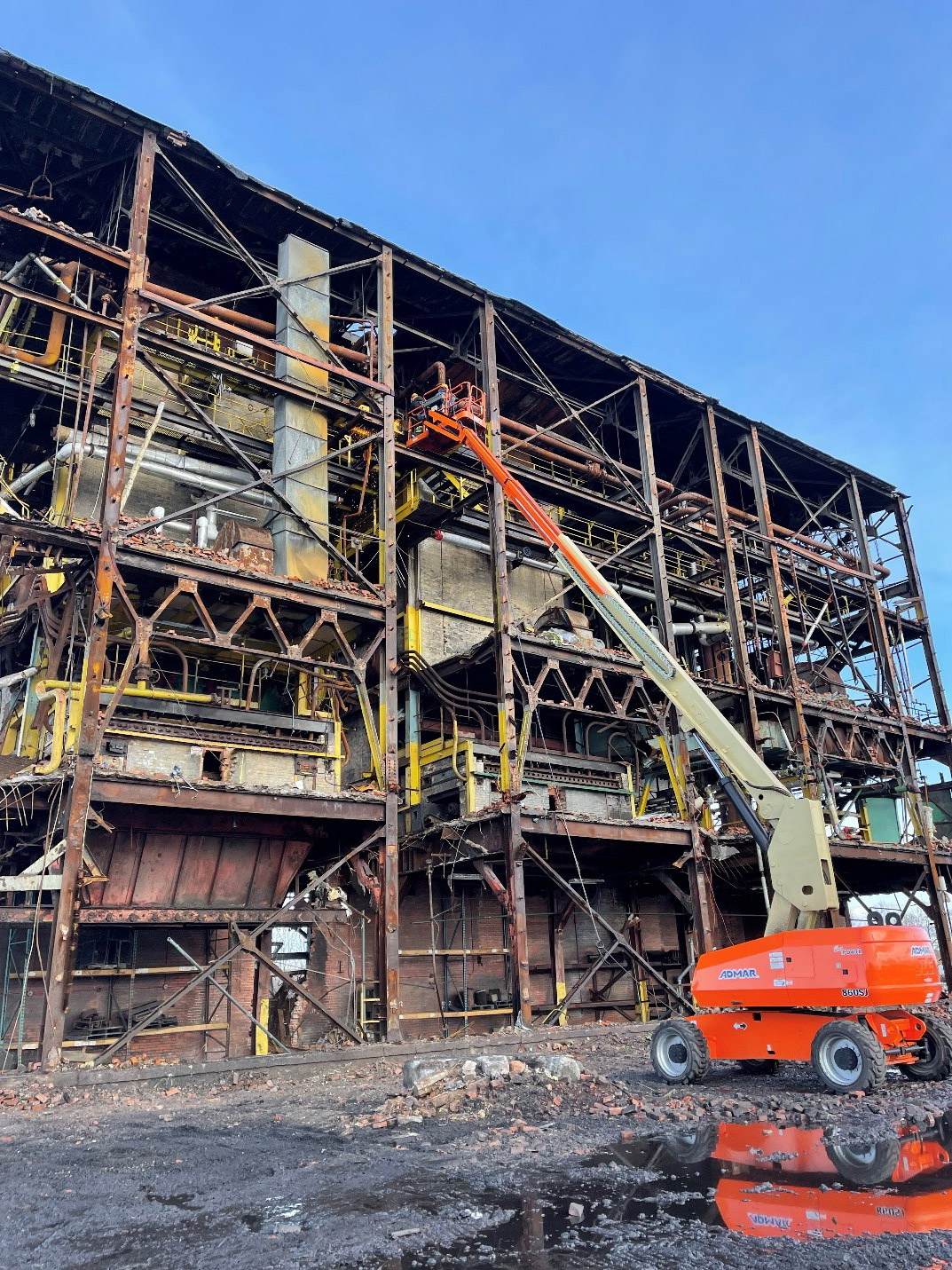

December 2021 - Demolition of Boiler House Cutting Connections between Bays

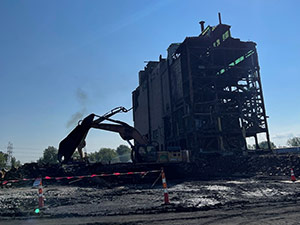

September 2021 - Debris removal from coal charging in preparation for demolition
September 2021 - Stabilized sediment from Settling Ponds

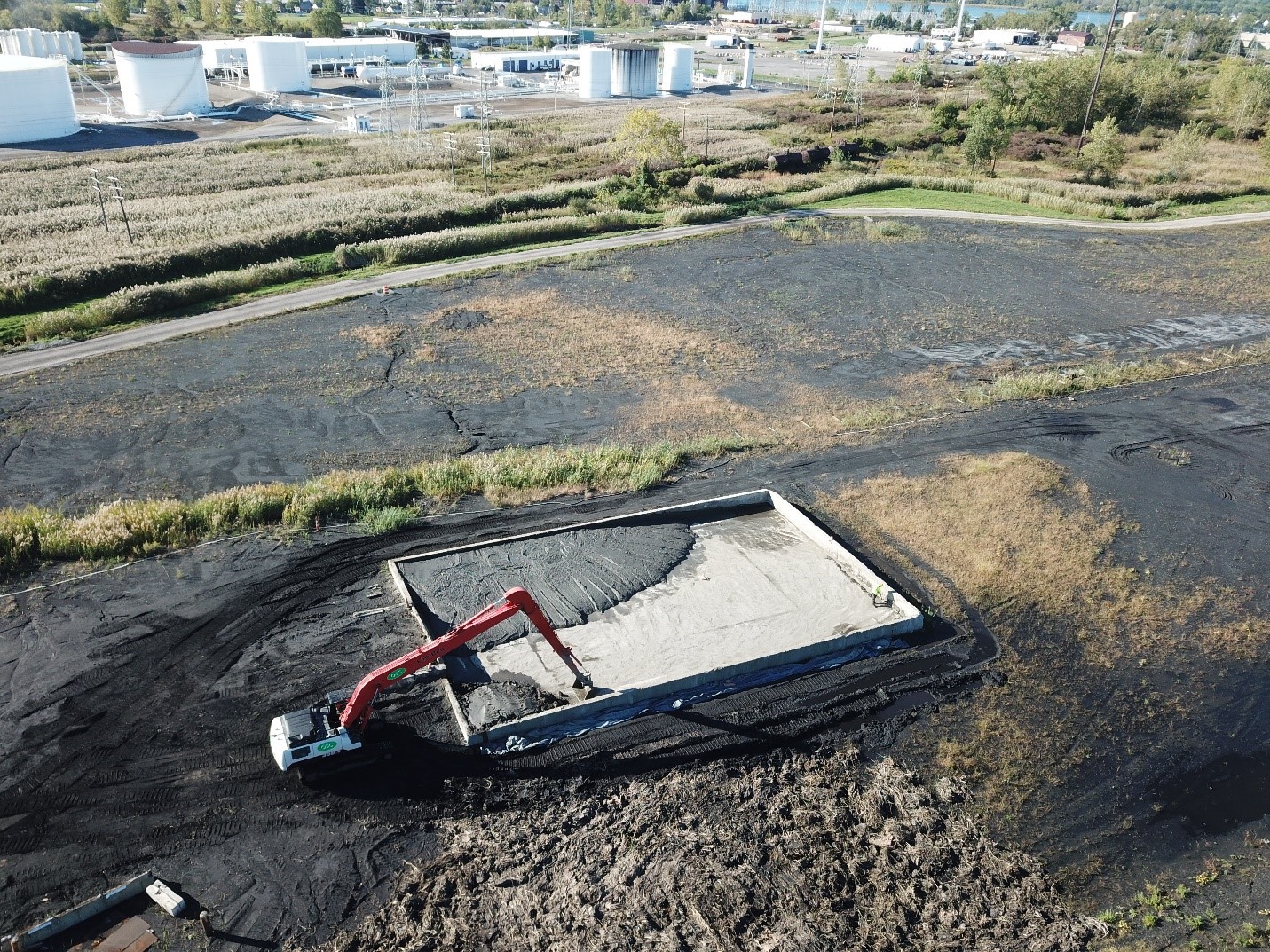

September 2021 - Preparation for cleaning Wastewater Treatment Tanks

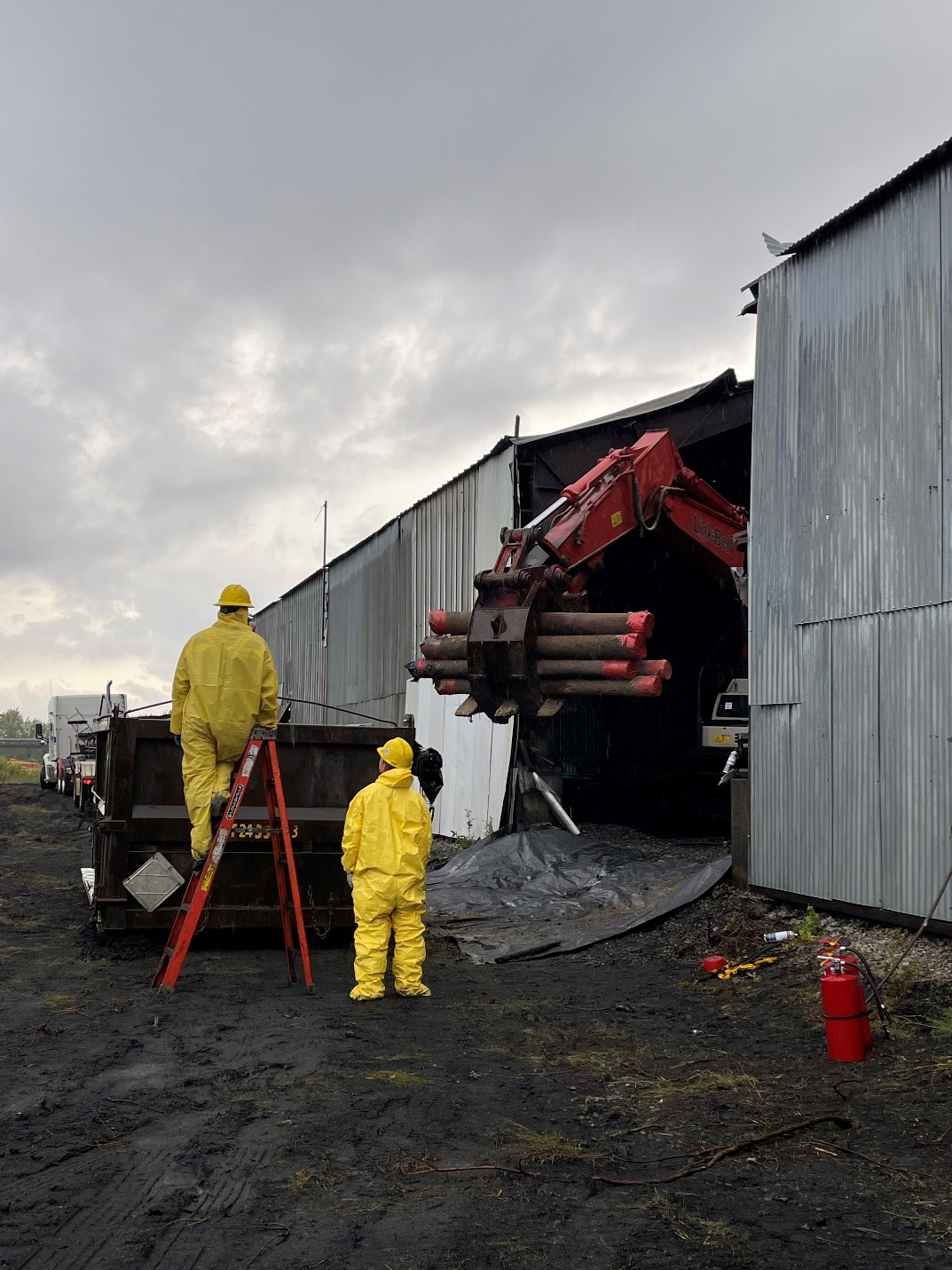

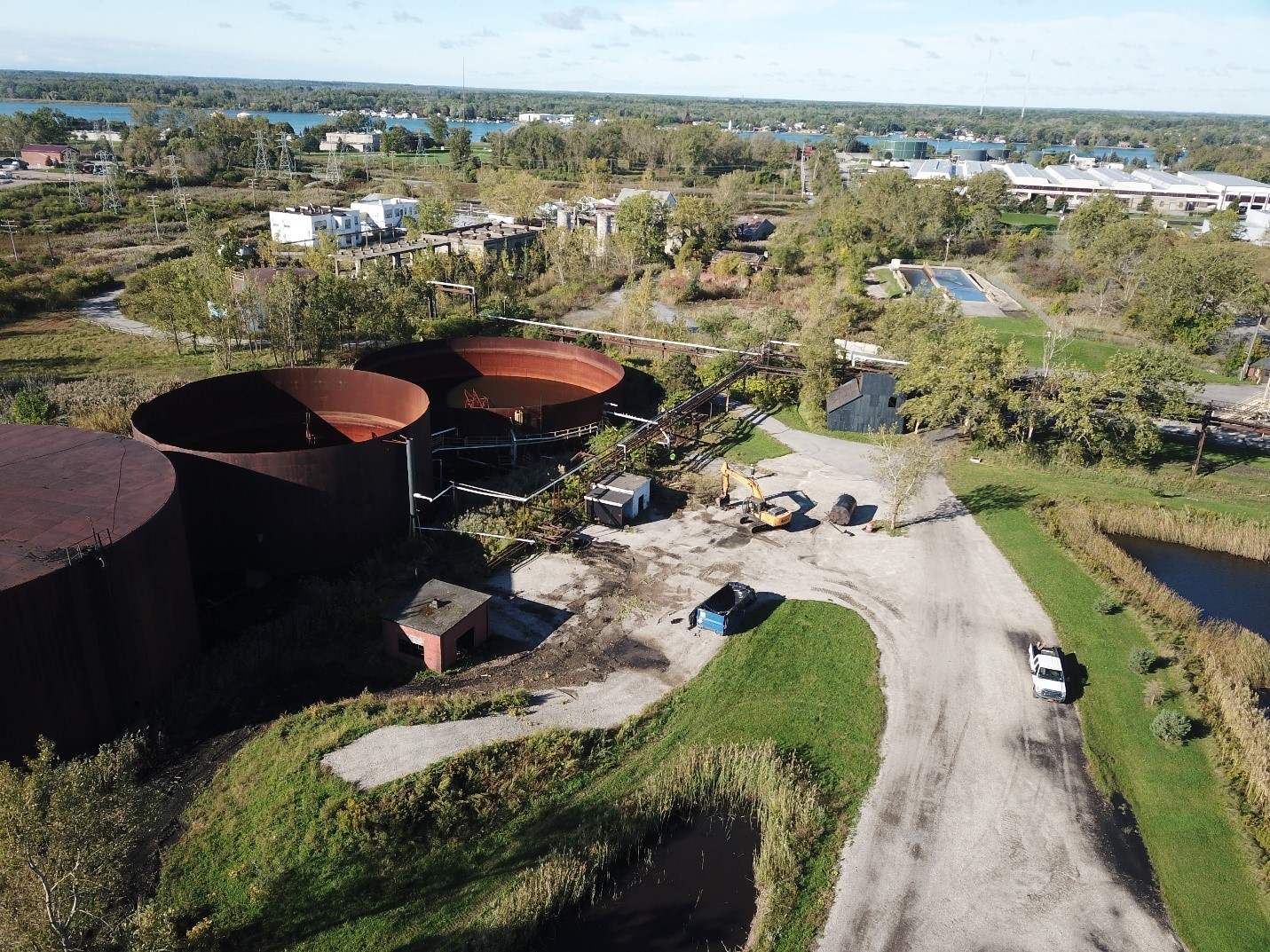

September 2021 - Settling Basins, Site 109 and Surrounding Properties; Site 108 is tree covered property in background by Niagara River
September 2021 - Weir Plate repairs - North Settling Pond

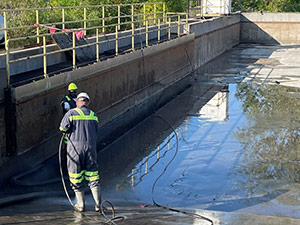

September 2021 - Final cleaning - South Settling Pond
September 2021 - Supervisor inspecting cleaning of Lid Seal Tank
September 2021 - Secondary containment after oil tank removed

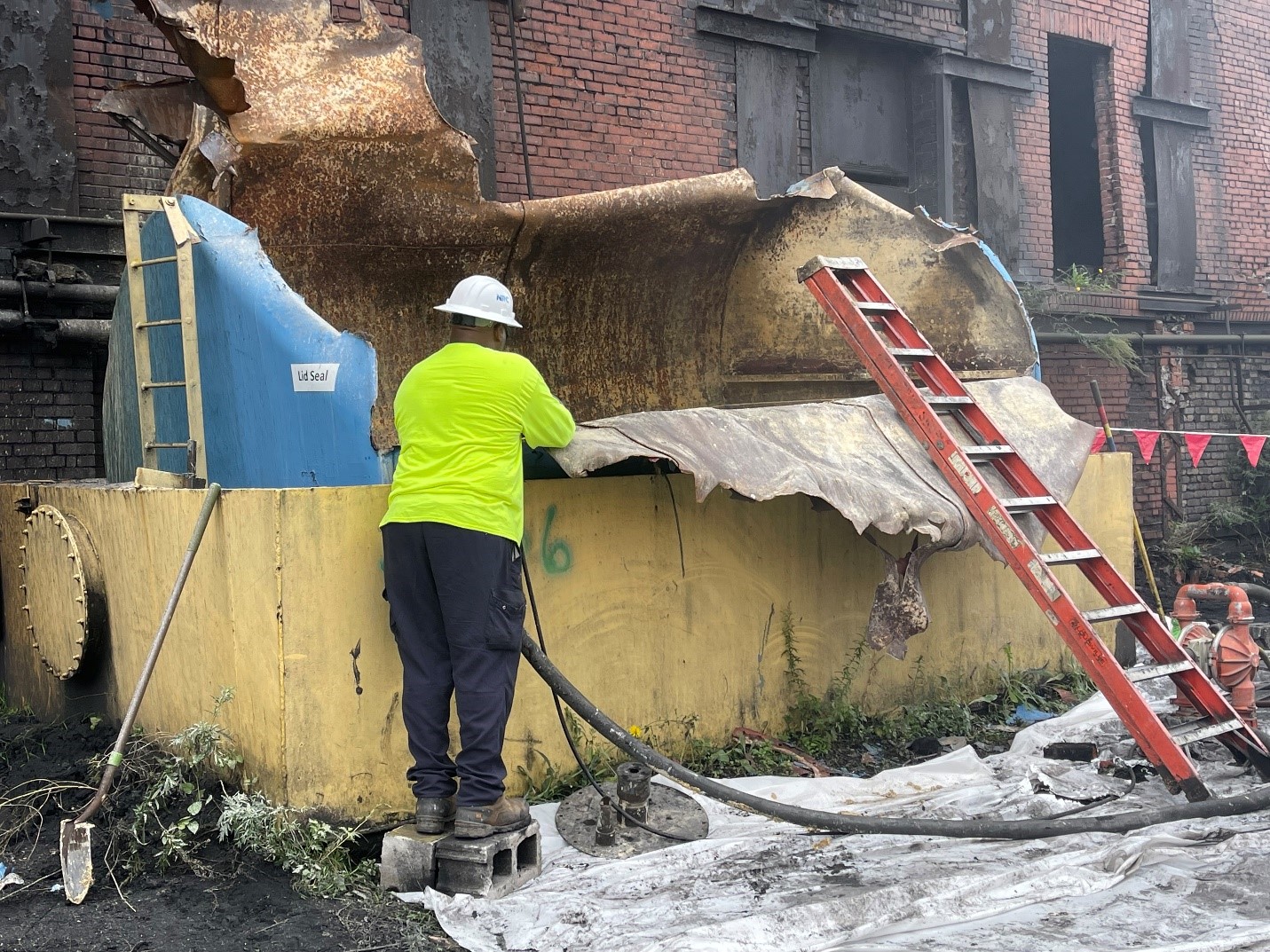

September 2021 - Removing contents of oil tank

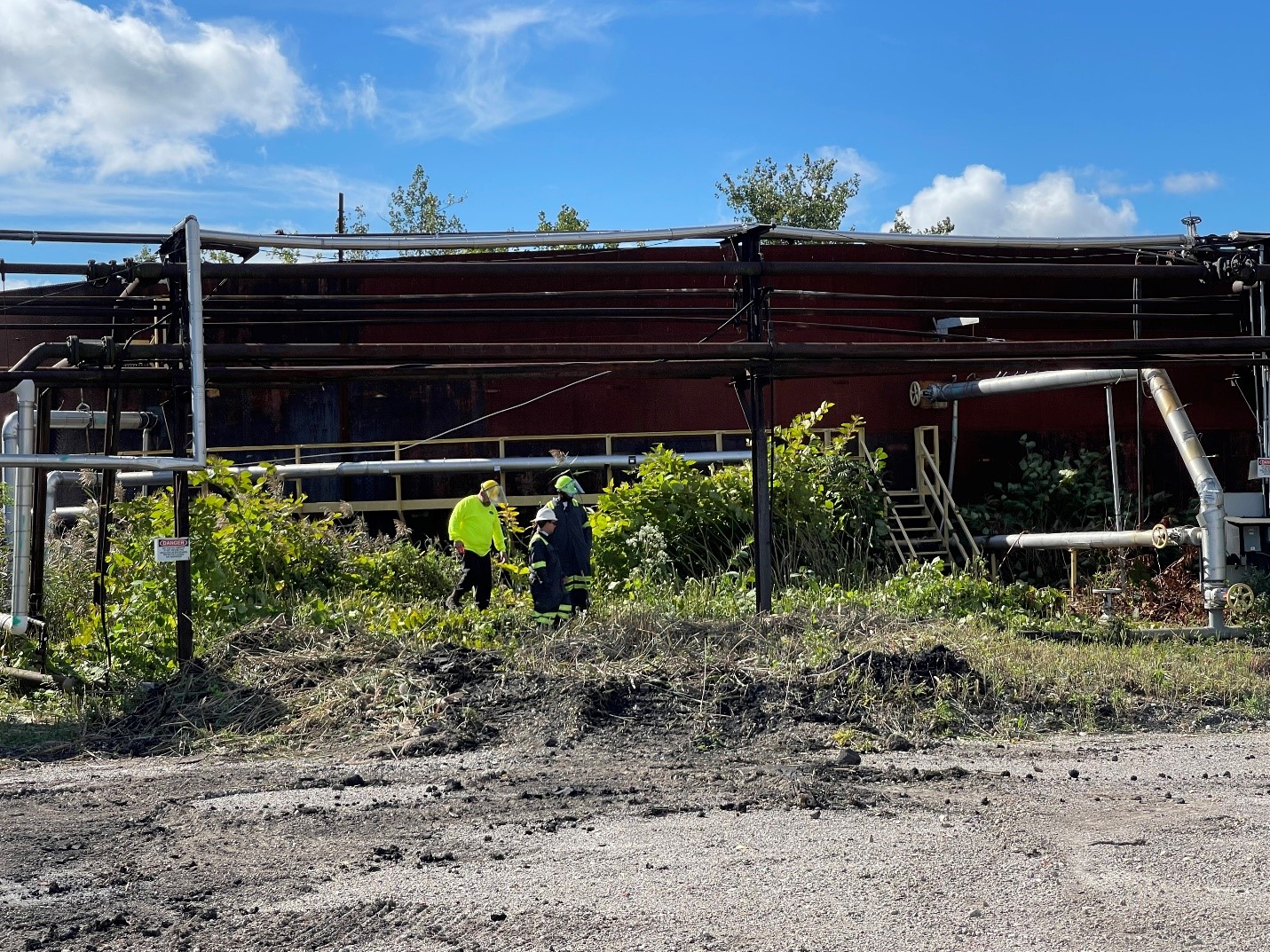

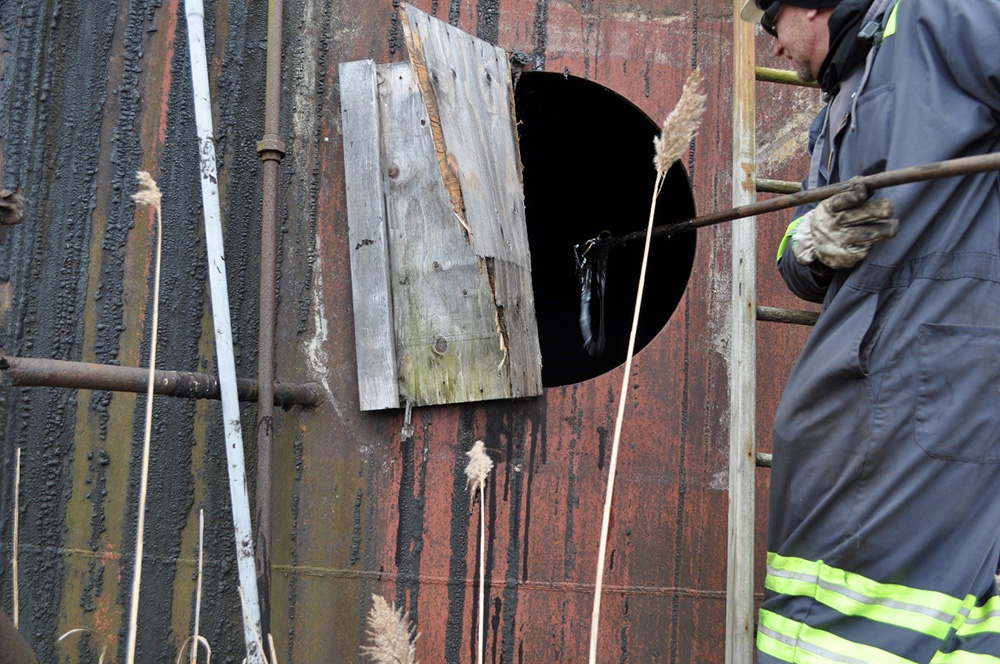

September 2021 - Removal of acid storage tank area
September 2021 - Loading pipe for offsite disposal

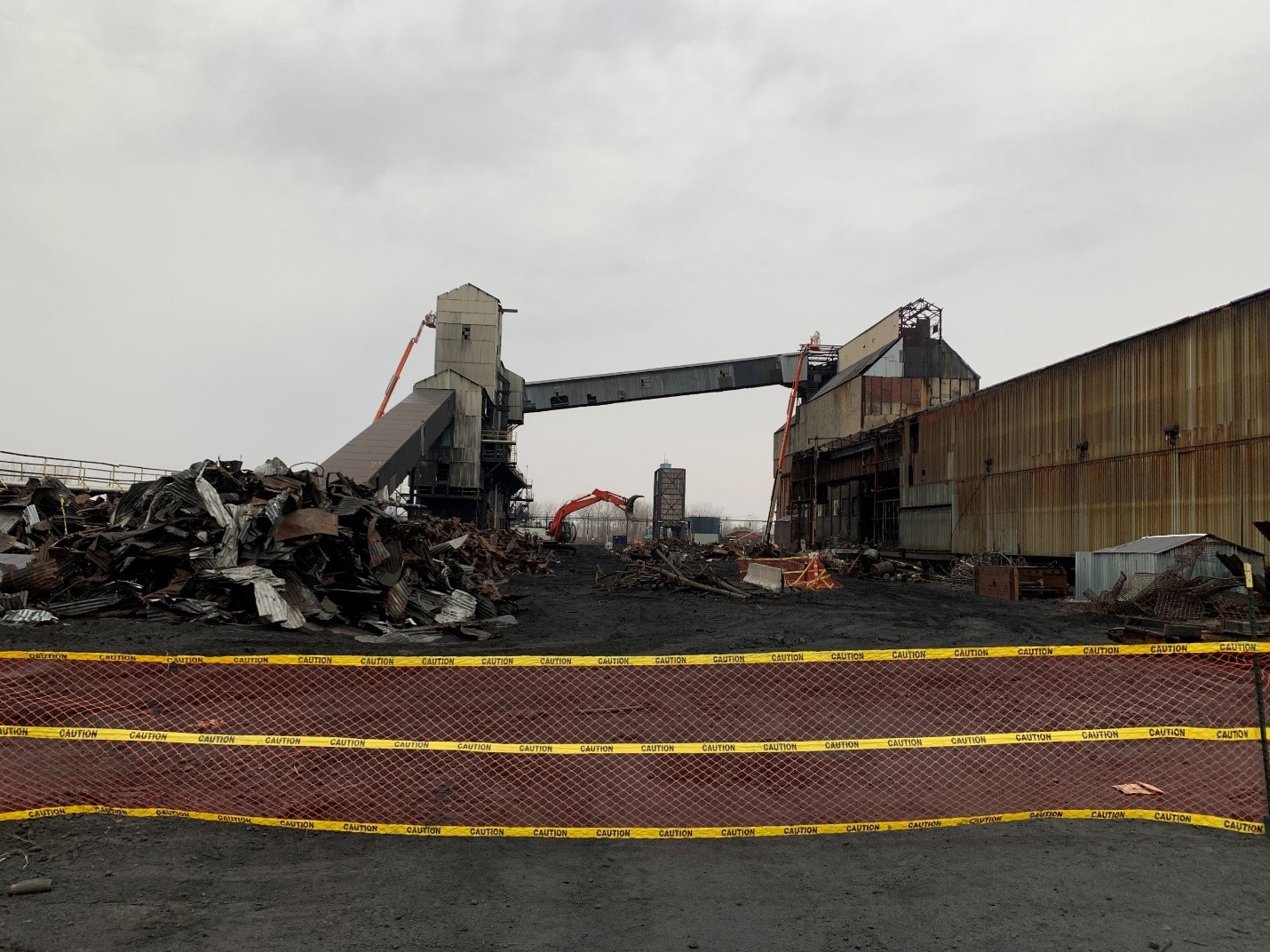

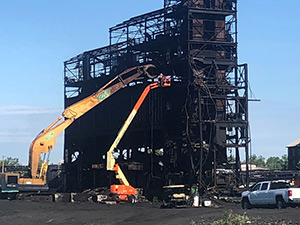

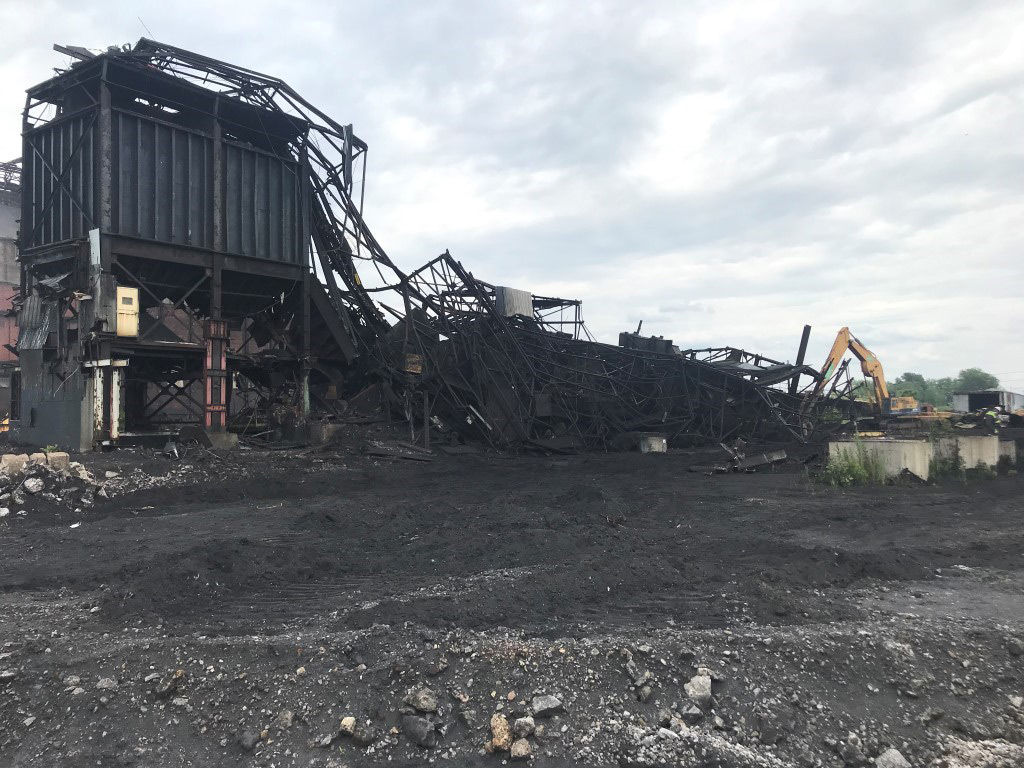

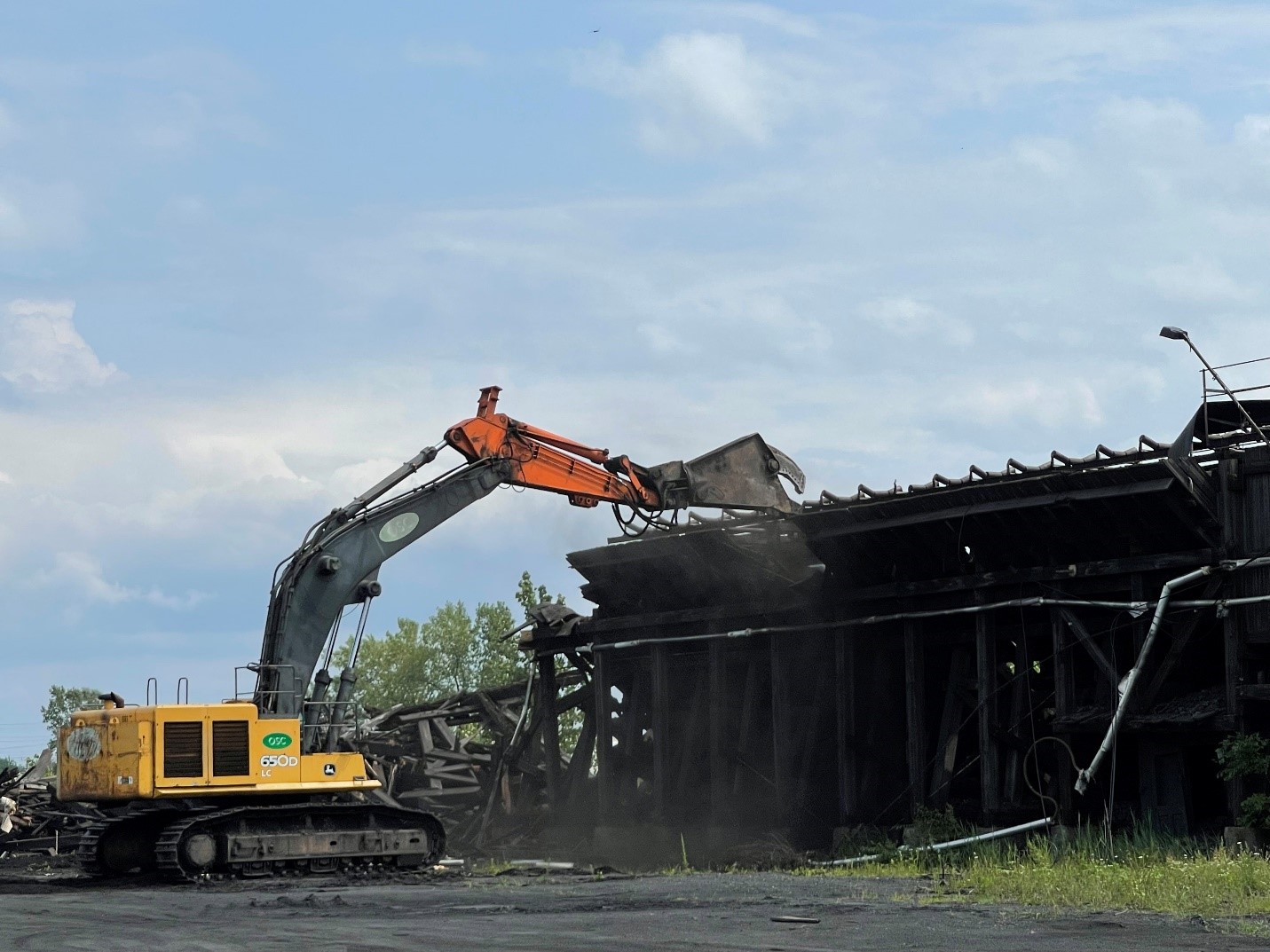

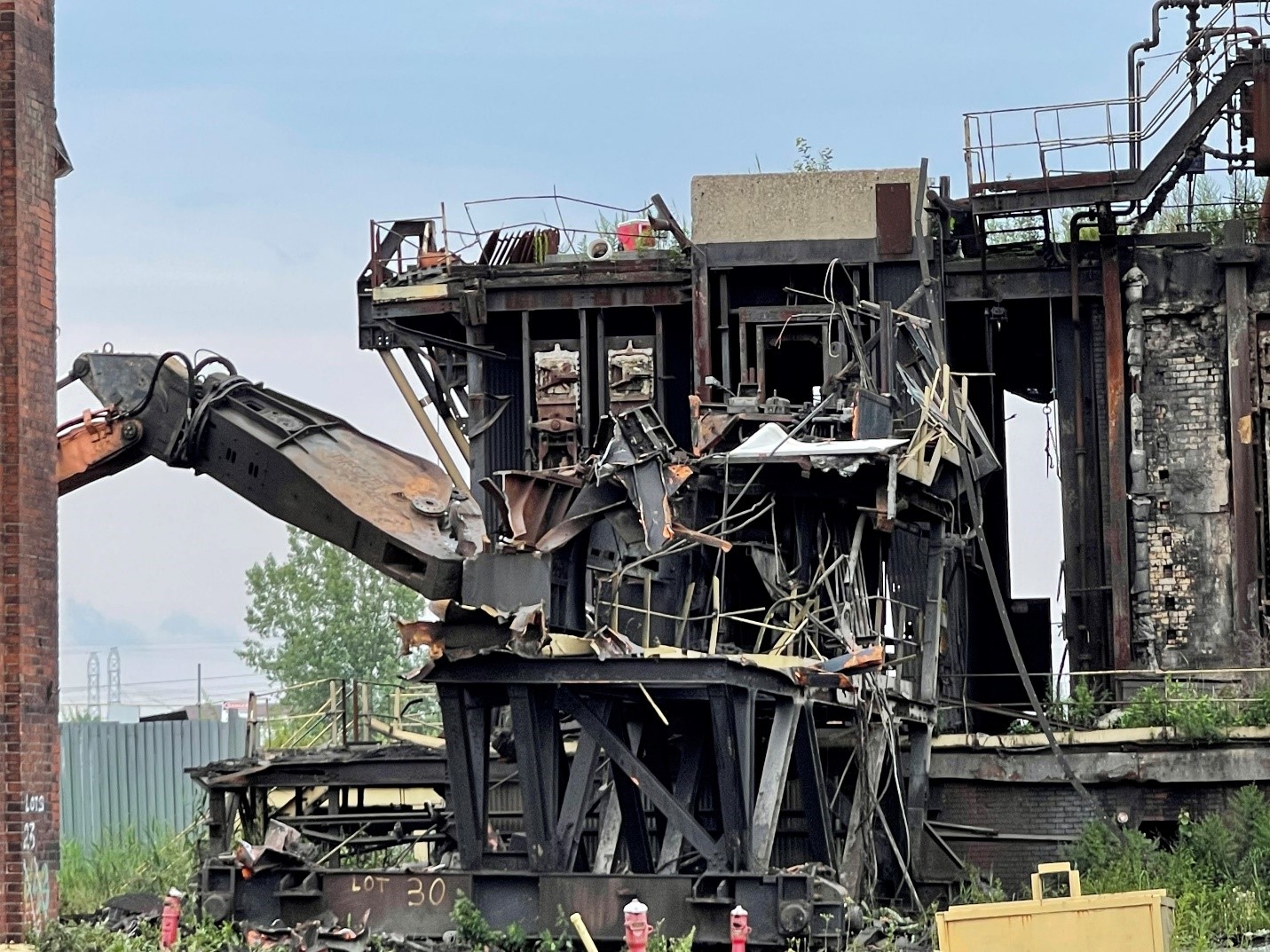

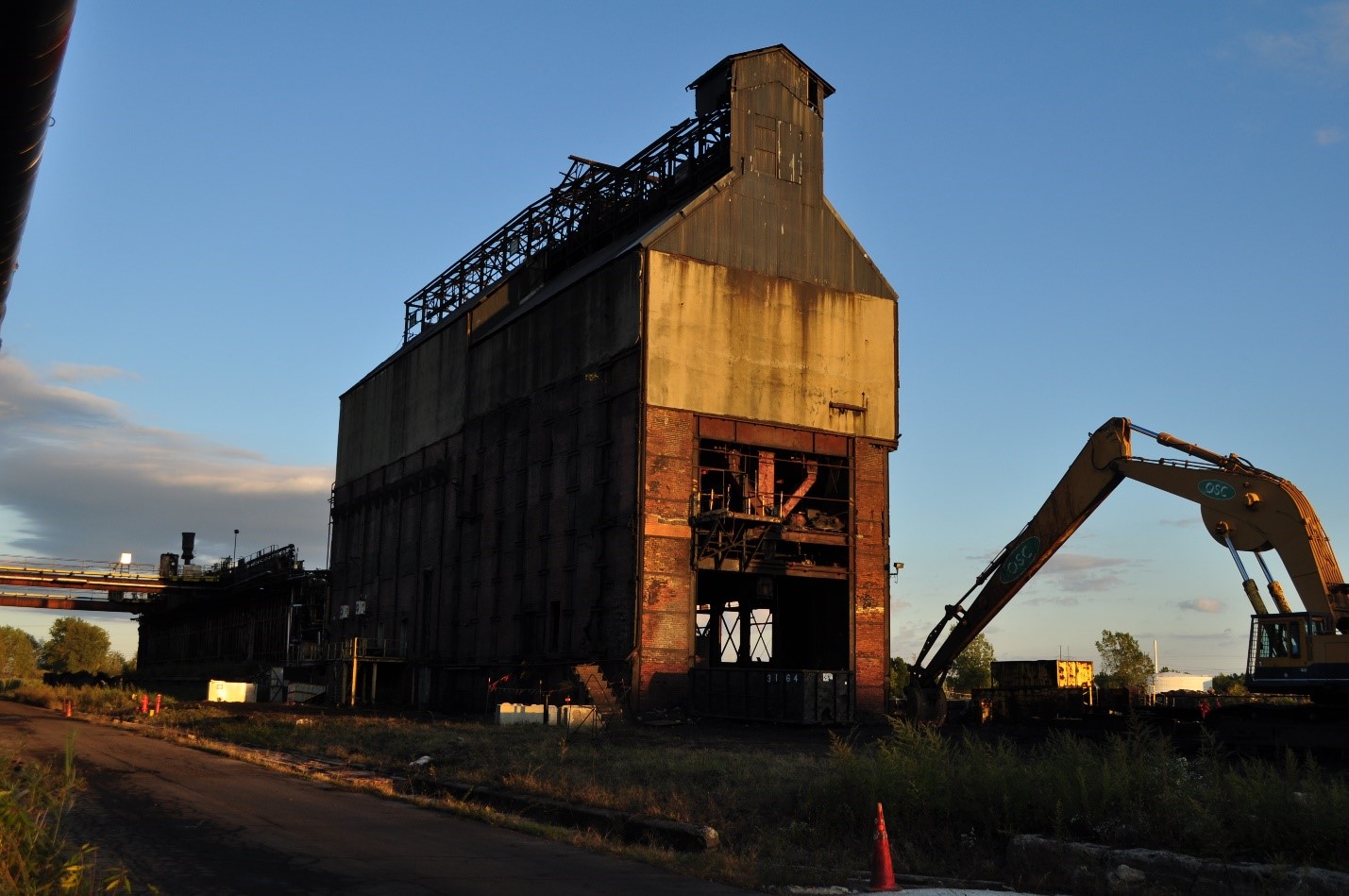

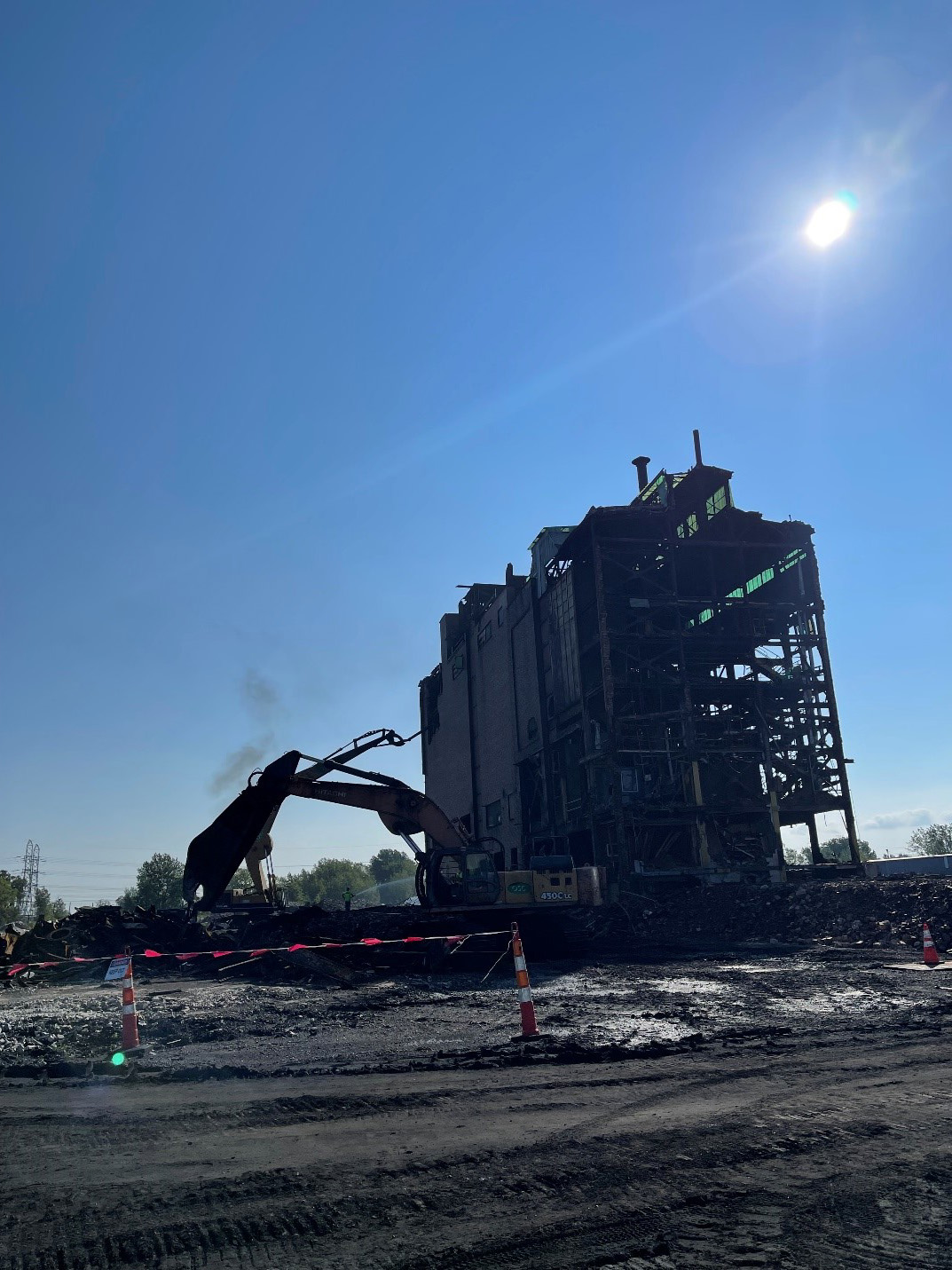

September 2021 - Demolition of Boiler House

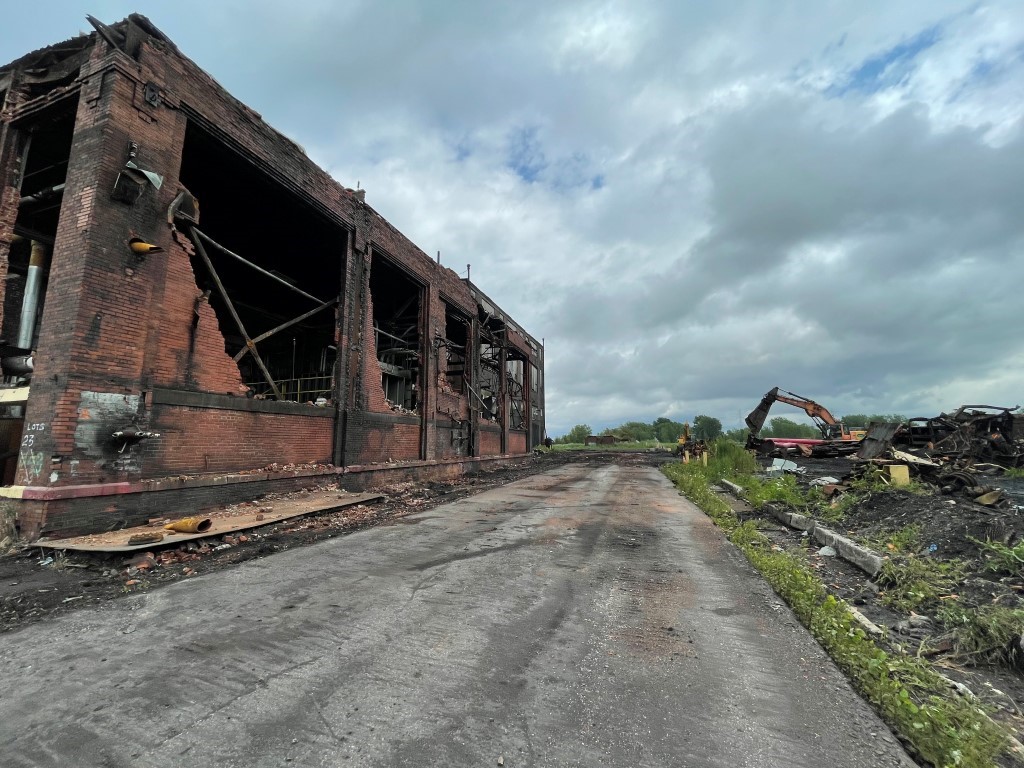

September 2021 - Demolition of Boiler House

August 2021 - Native vegetation reclaiming Coal Yard
August 2021 - Repairing weir plates in North Pond before placing back in service
August 2021 - Cleaned North Settling Pond

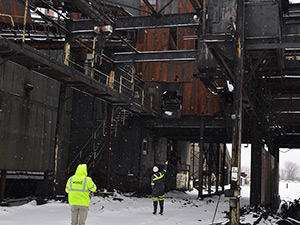

August 2021 - Boiler House after Power House and Water Treatment Annexes were removed (looking Southeast)
August 2021 - Former Mansion, heavy equipment and instrument building location (looking East)

August 2021 - Saving a Curious Frog
August 2021 - Cleaning of North Settling Pond

August 2021 - Testing and evaluating Coke Oven Gas Pipe residuals
August 2021 - Sampling of Coke Oven Gas Pipe contents

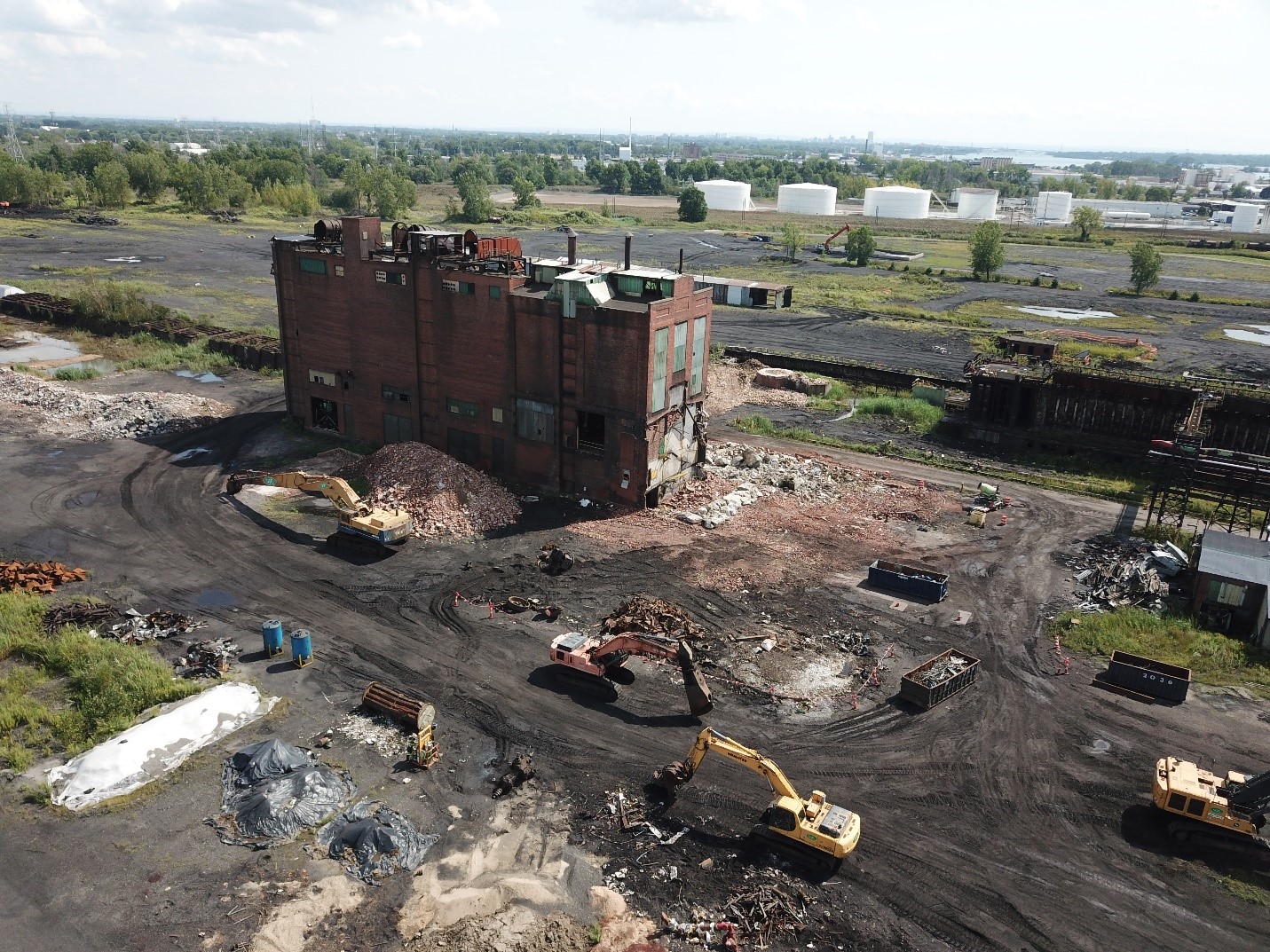

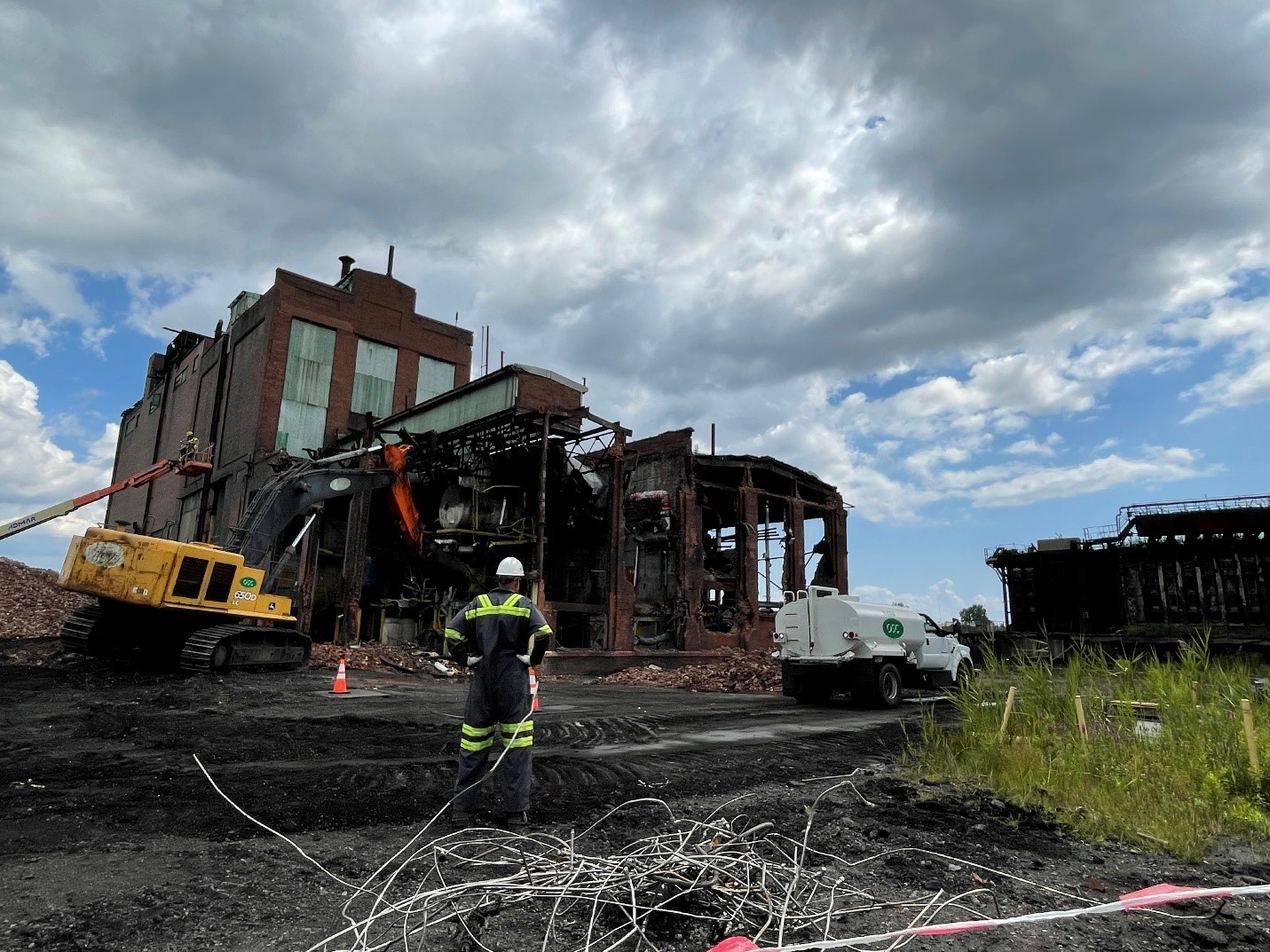

August 2021 - Demolition of Power House
August 2021 - Demolition of Coke Conveyor Trestle
August 2021 - Demolition of Water Treatment Building at Boiler House
July 2021 - Dewatered North Pond

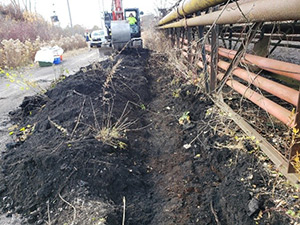

July 2021 - Installation of erosion and sediment control features before pond sediment management

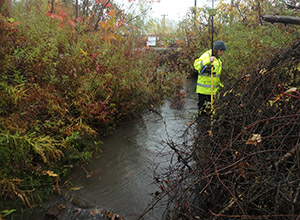

July 2021 - Sampling of coal yard tunnel water
July 2021 - Sampling of coal yard tunnel water

July 2021 - South wall of Power House during demolition

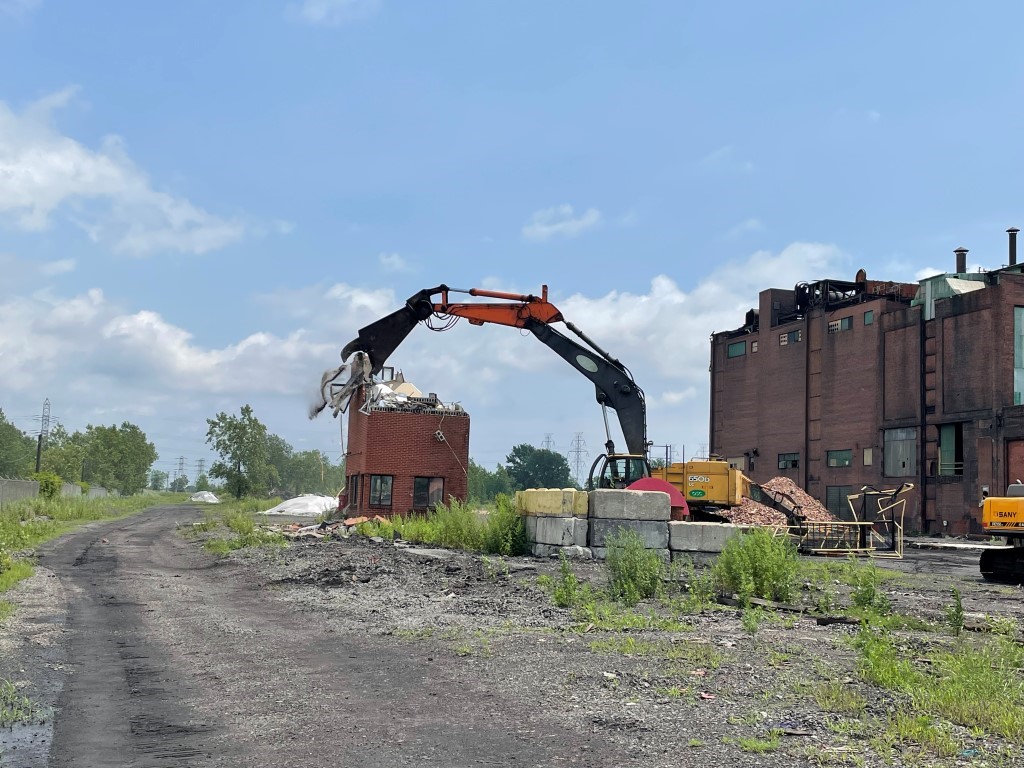

July 2021 - Demolition of west wall of Boiler House/water treatment area
July 2021 - West wall of Boiler and Power House at start of demolition

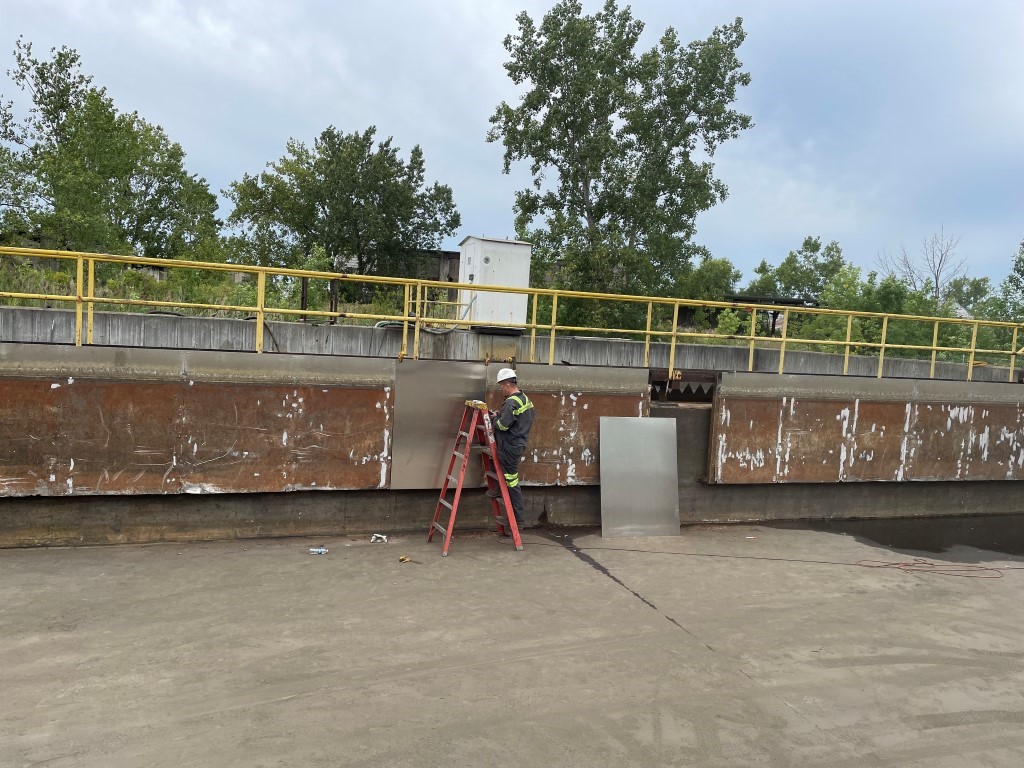

July 2021 - Routine maintenance of stormwater system

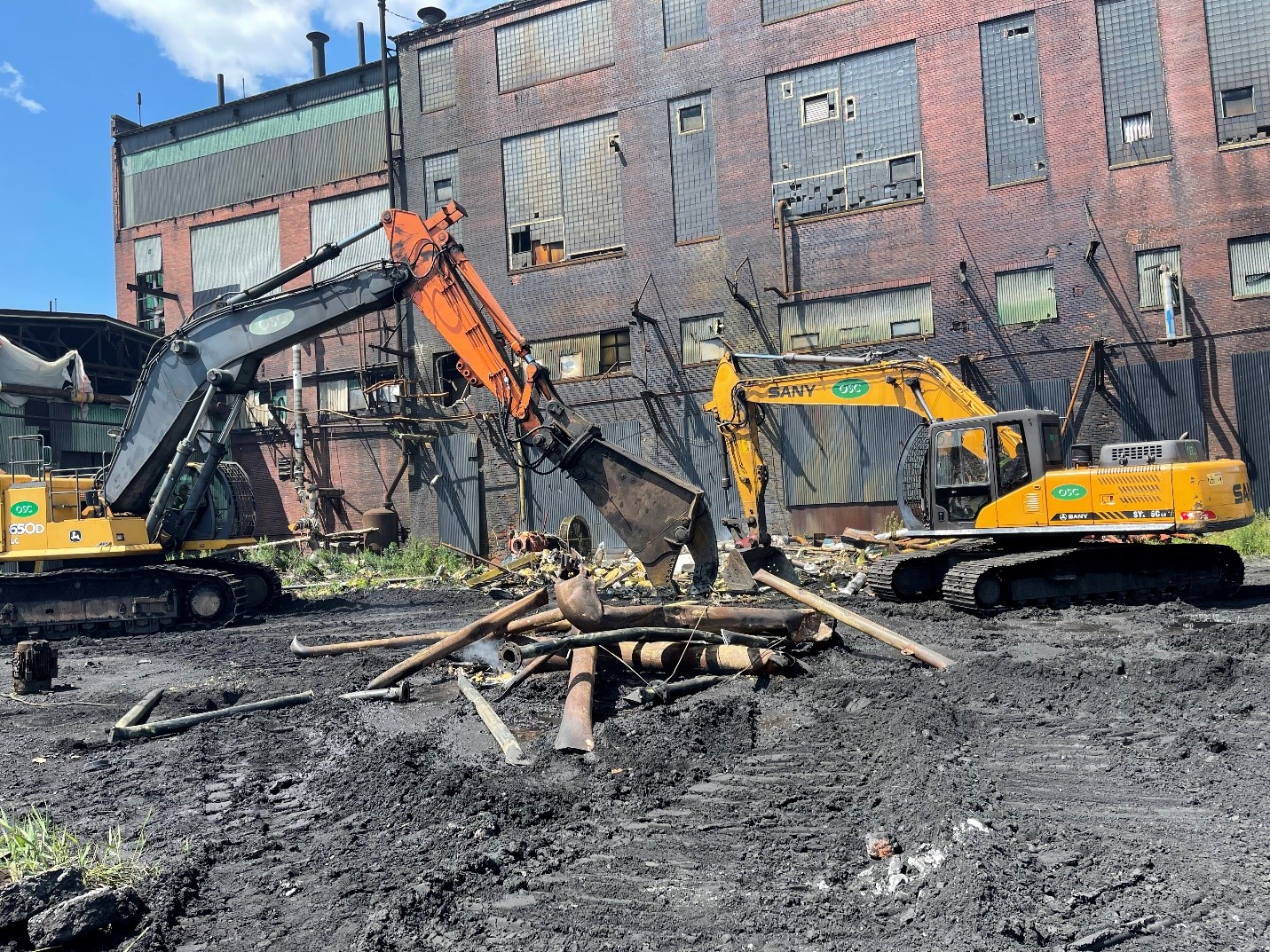

July 2021 - Demolition of the Pusher

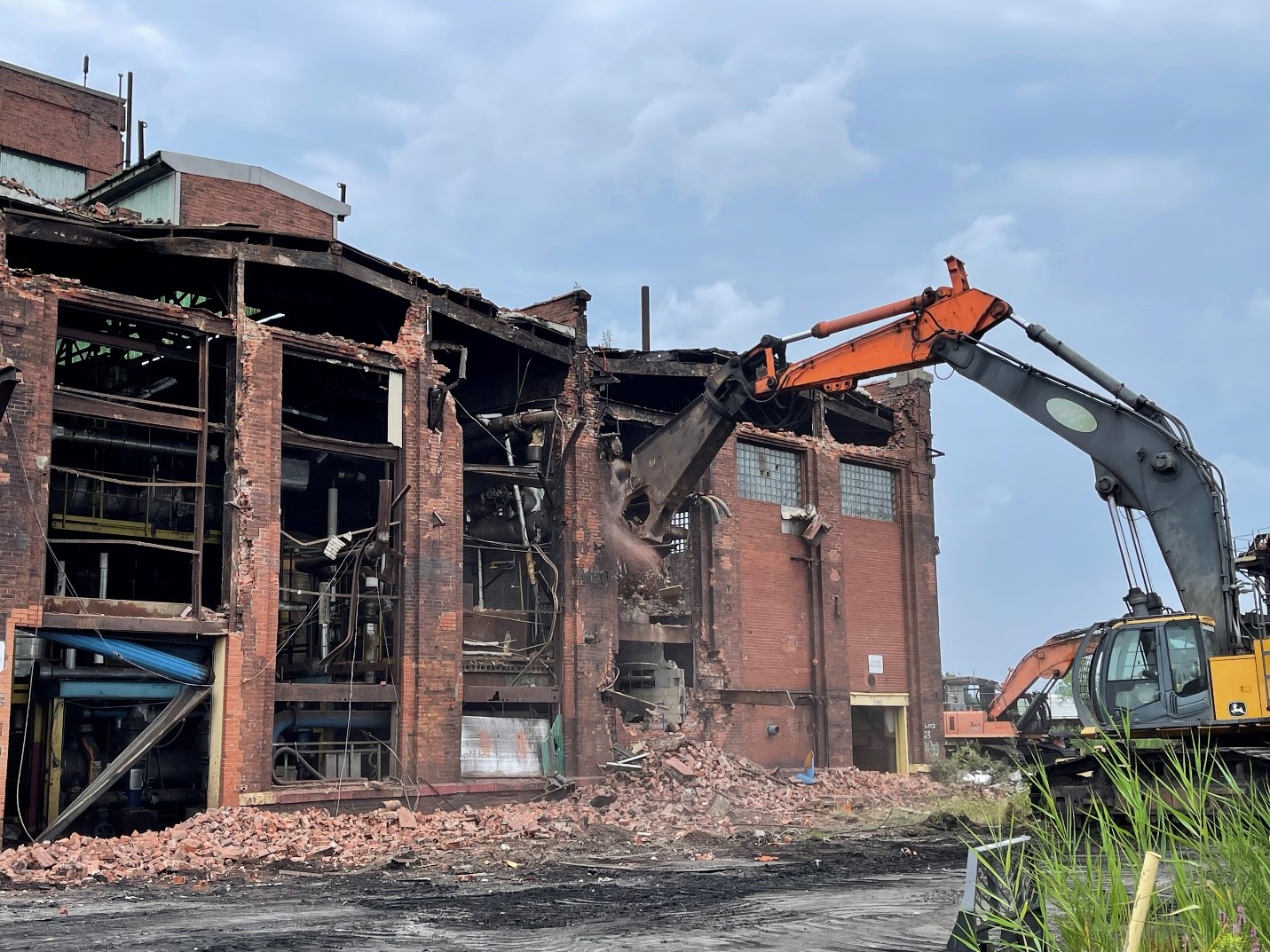

July 2021 - Deconstruction of the Pusher

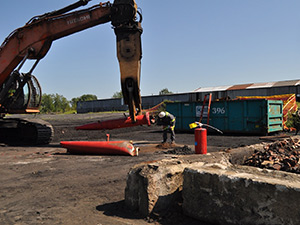

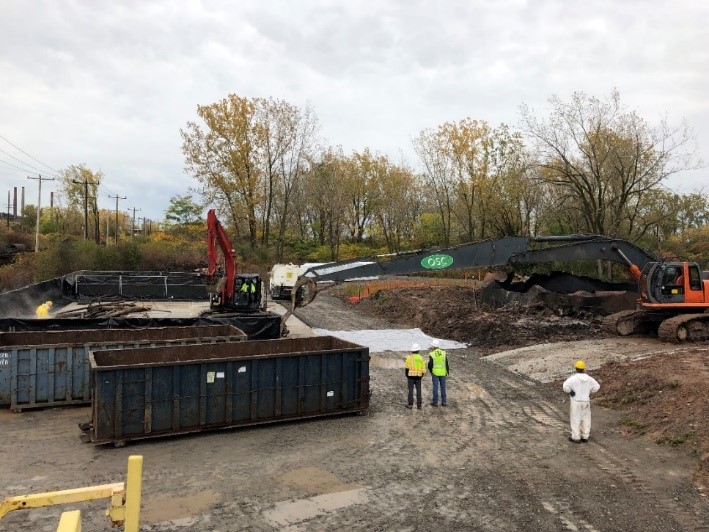

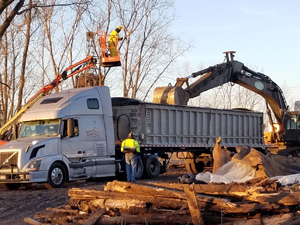

July 2021 - Materials to be cleaned and processed for recycling
July 2021 - Processing equipment from the Compressor Building for recycling
July 2021 - Processing pipe from Boiler House
July 2021 - Processing pipe from Boiler House
July 2021 - Rail scale building demolition
July 2021 - Rail scale building demolition

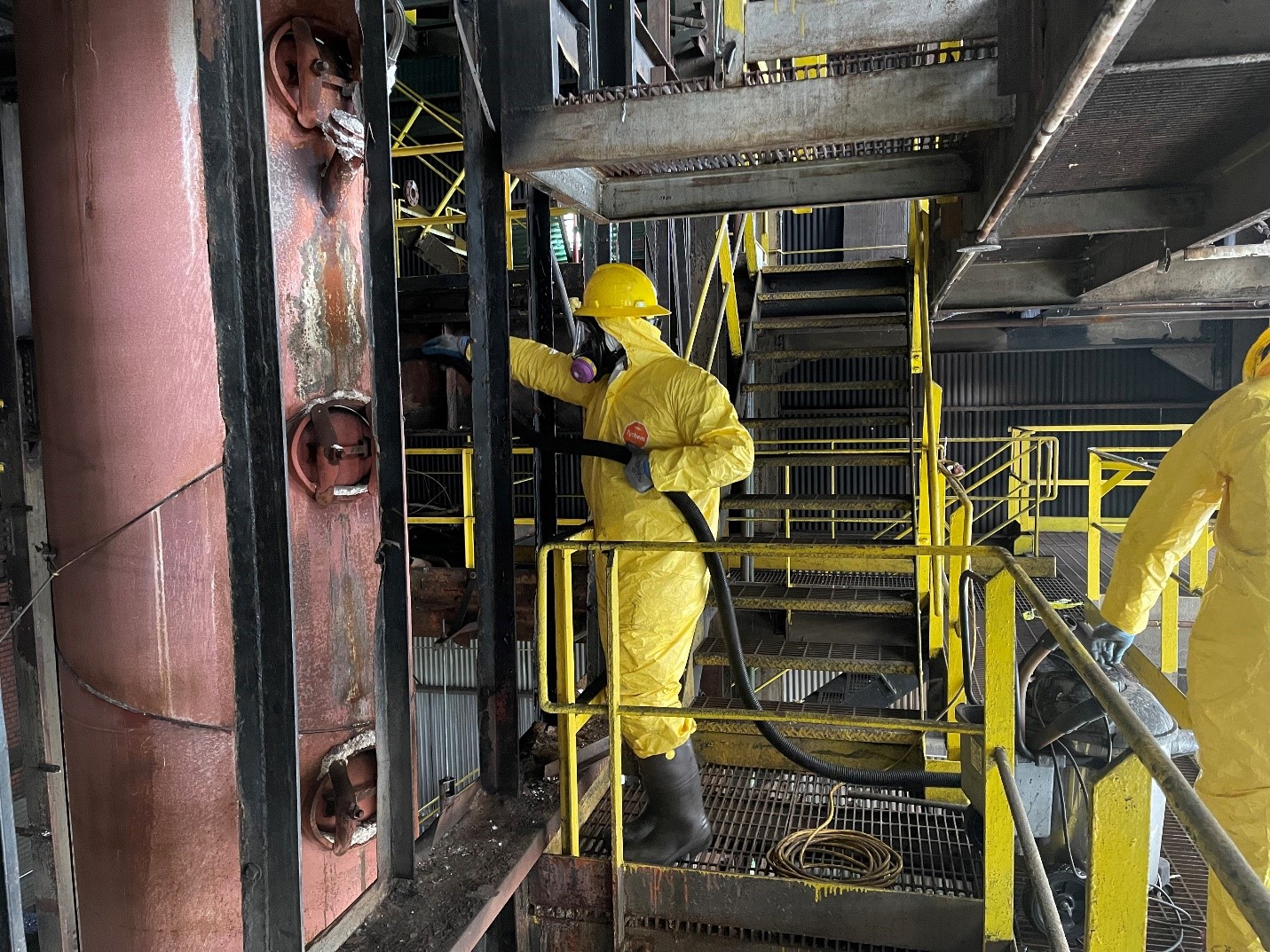

July 2021 - Inspection of exterior surfaces of lime still - Boiler House
July 2021 - Pre-demolition instructions - Boiler House preparation

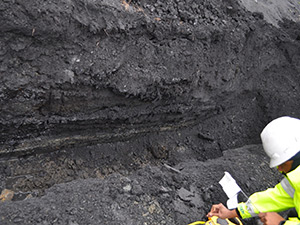

July 2021 - Sampling - Coal Yard Tunnel

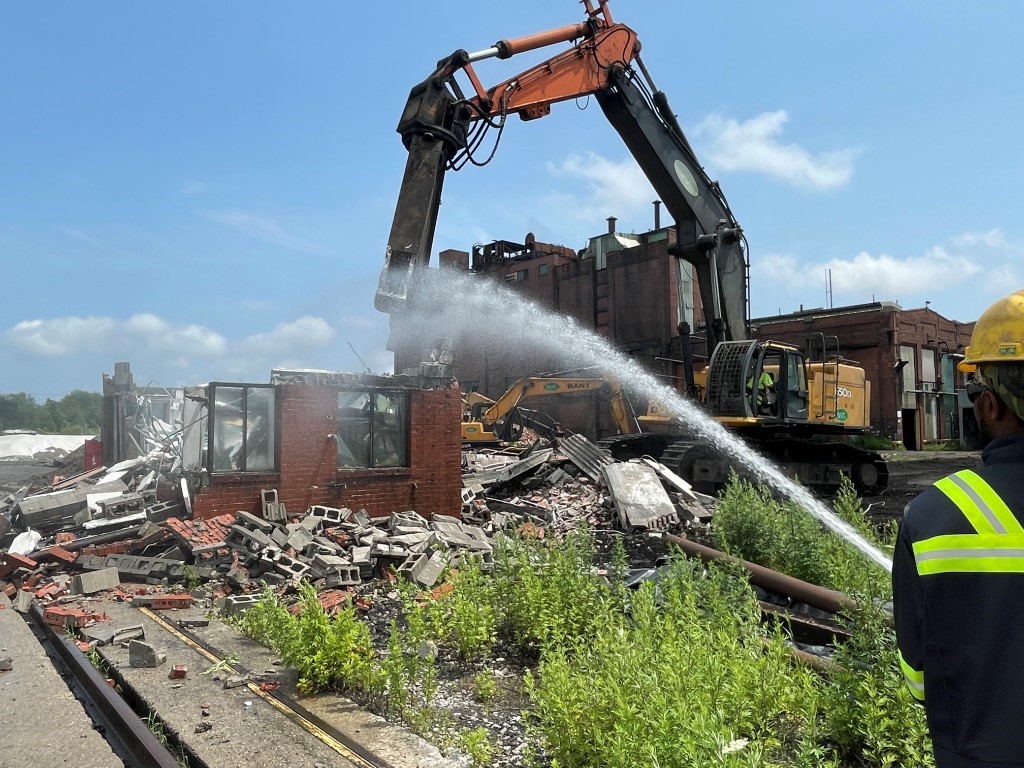

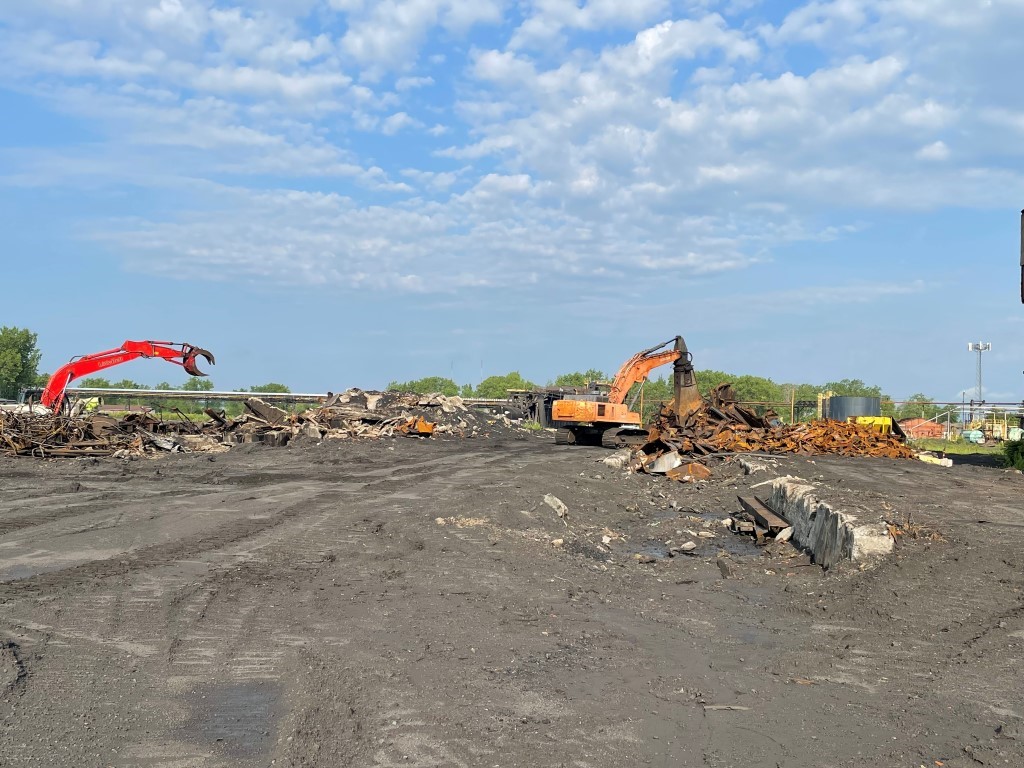

July 2021 - Processing materials for recycling and disposal

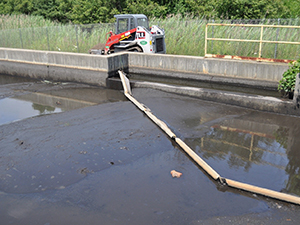

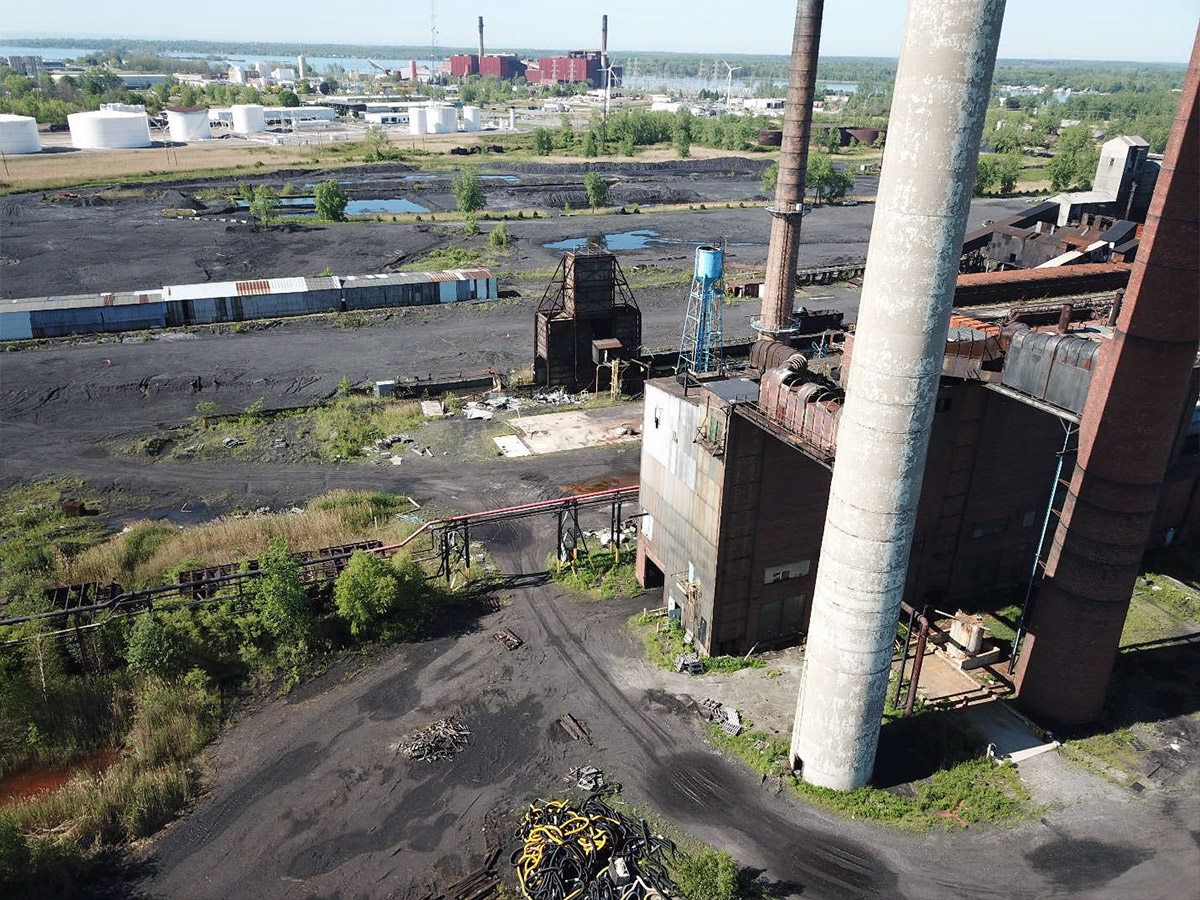

June 2021 - Cutting large pipes to protect surface water system

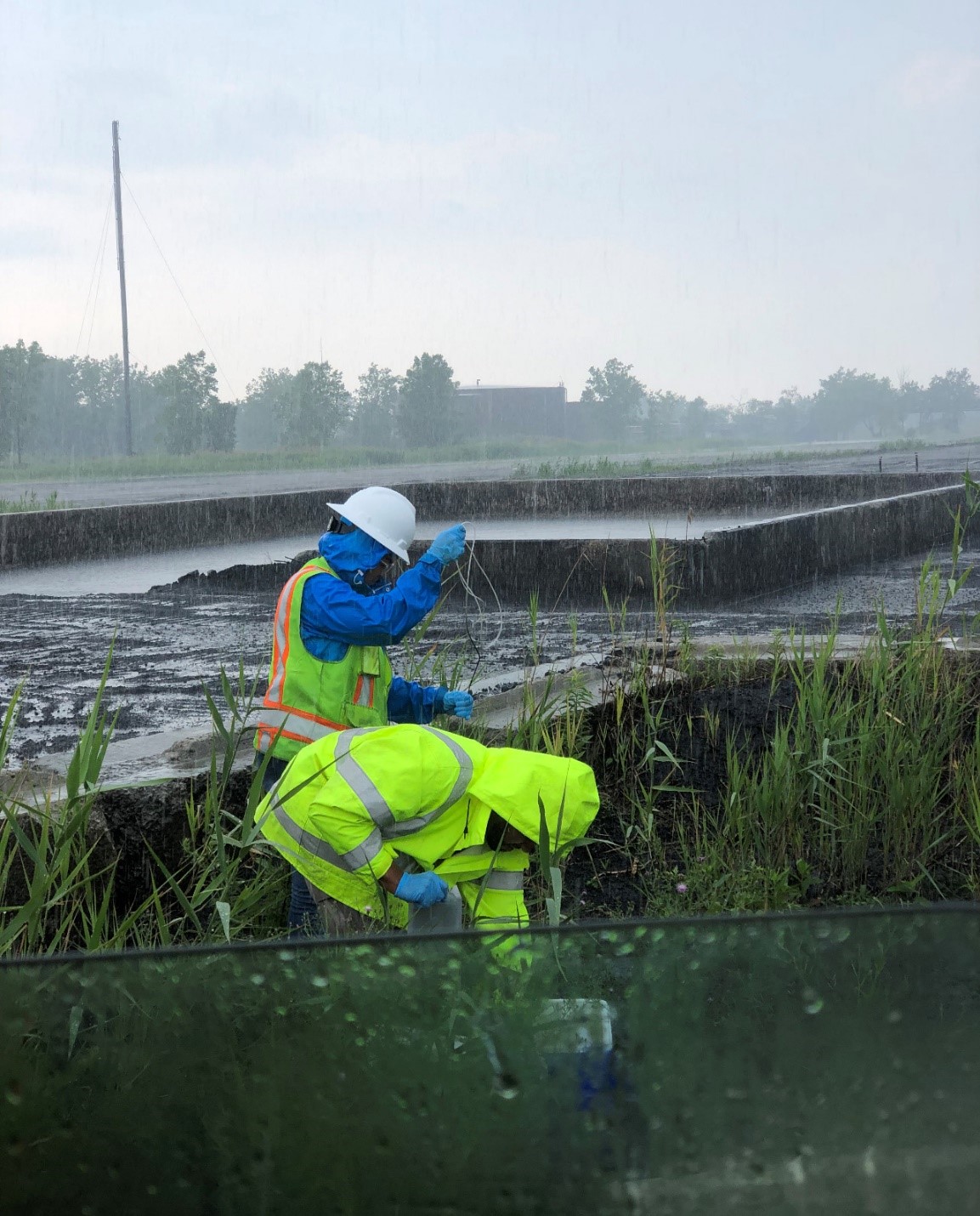

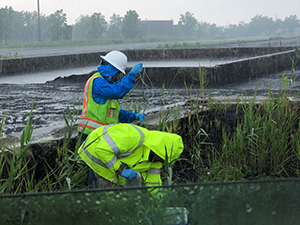

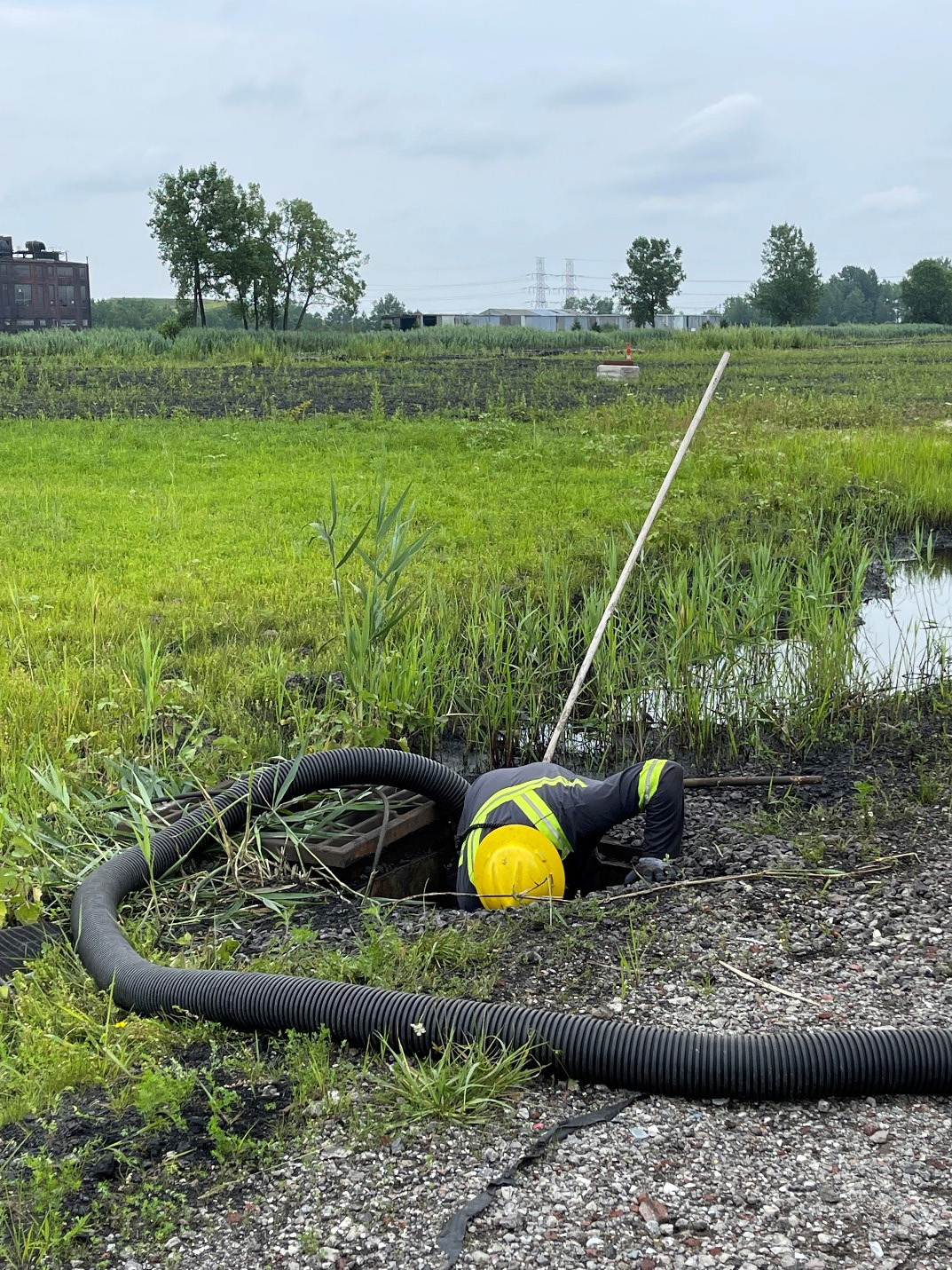

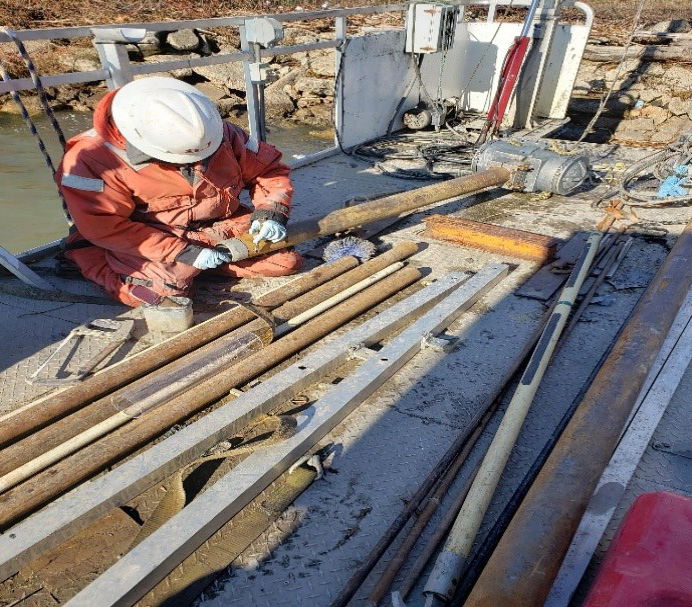

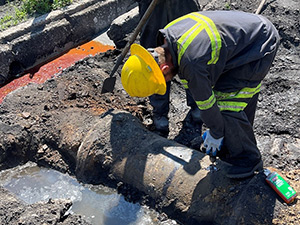

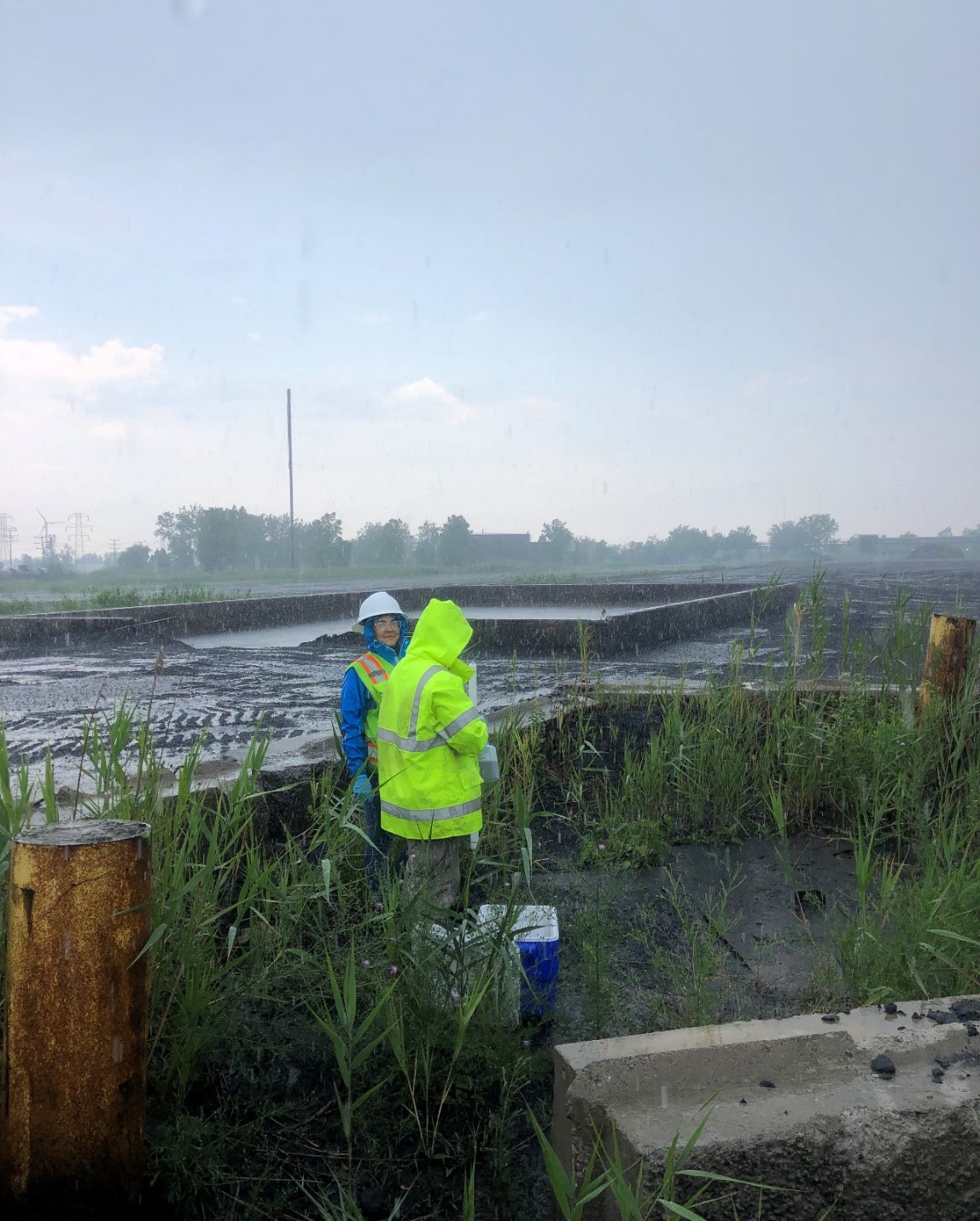

June 2021 - Testing pipe at source of seepage
June 2021 - Finding a major source of seepage

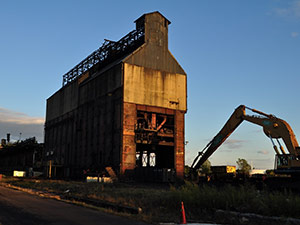

June 2021 - Coal Handling/Breaker Building
June 2021 - Coal Handling/Breaker Building preparation

June 2021 - Sampling Ammonia Liquor Tank

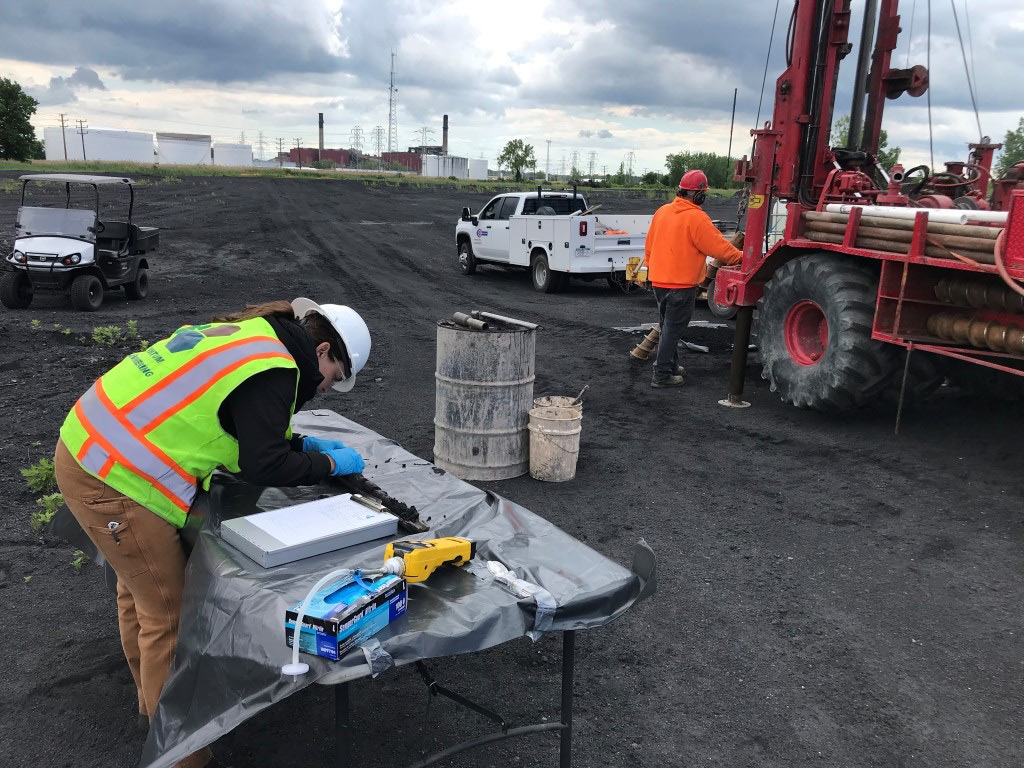

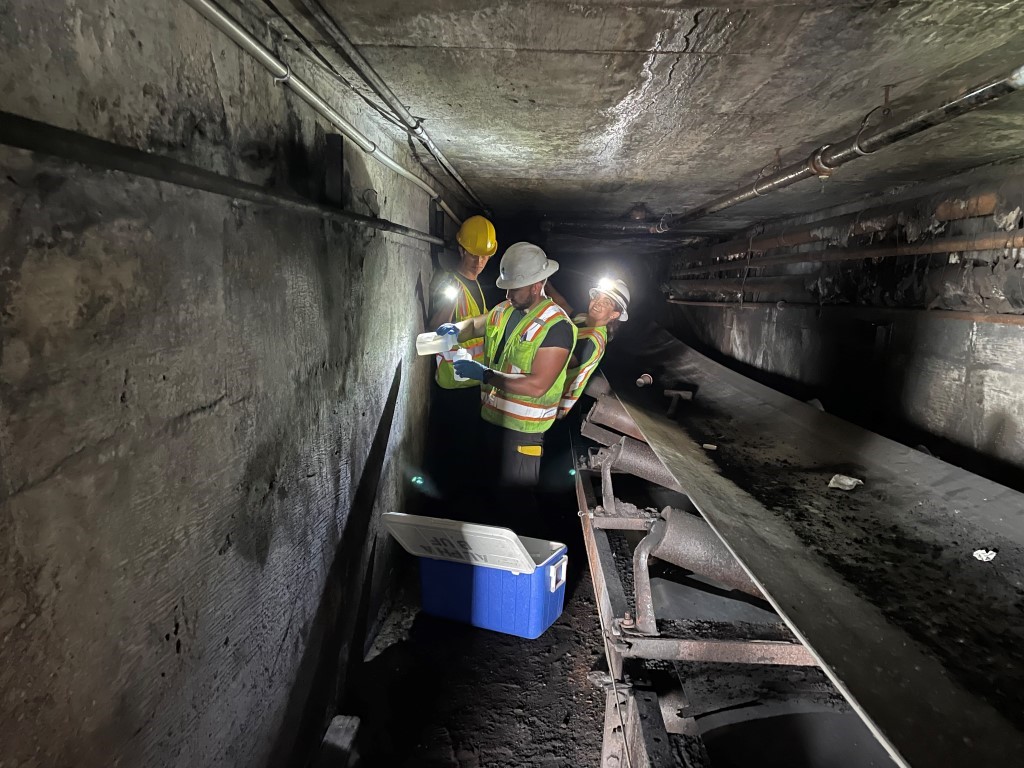

June 2021 - Remedial investigation; logging samples

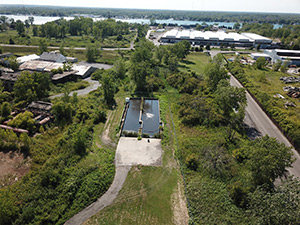

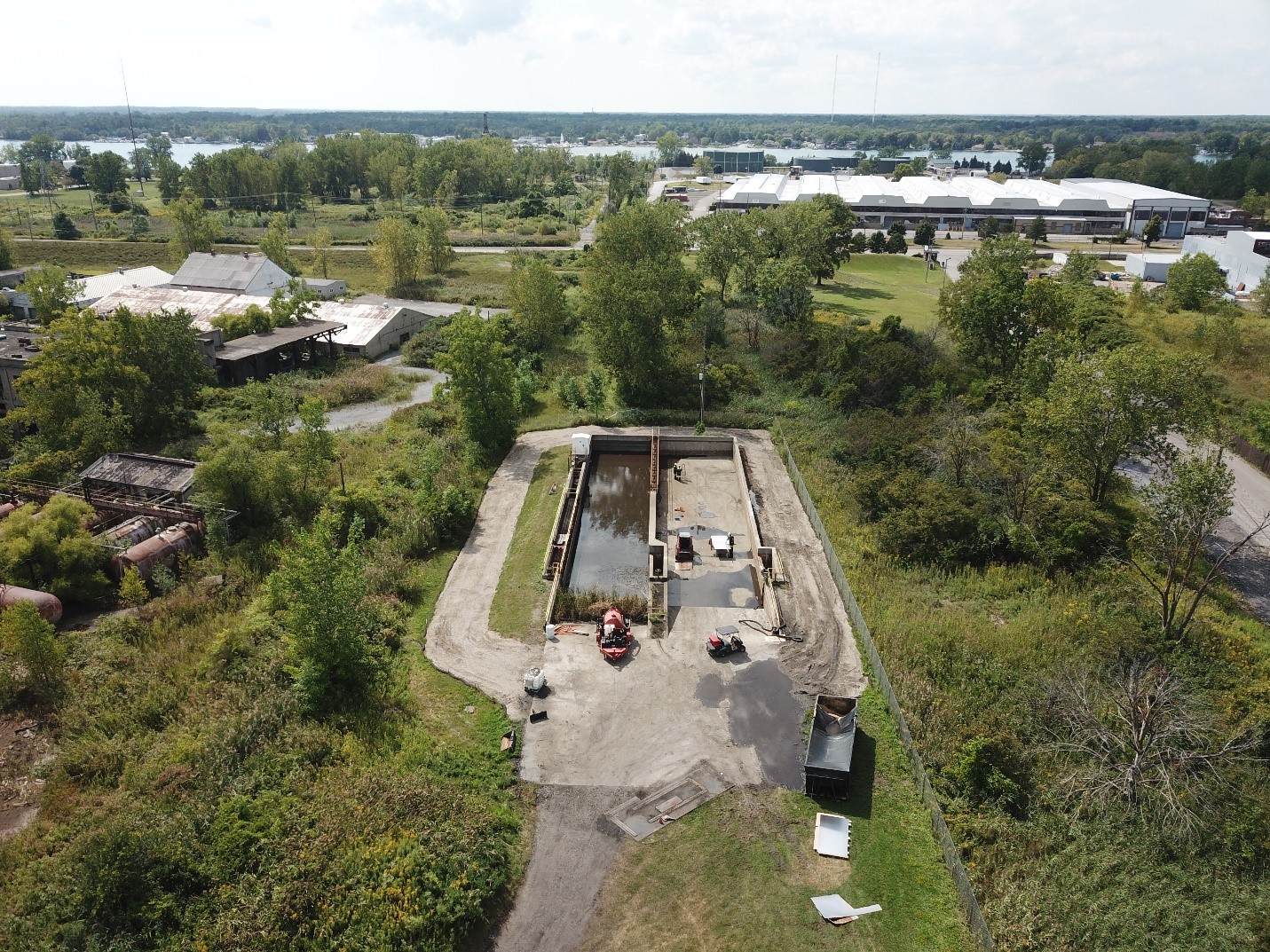

June 2021 - Box Culvert cleaned and sealed

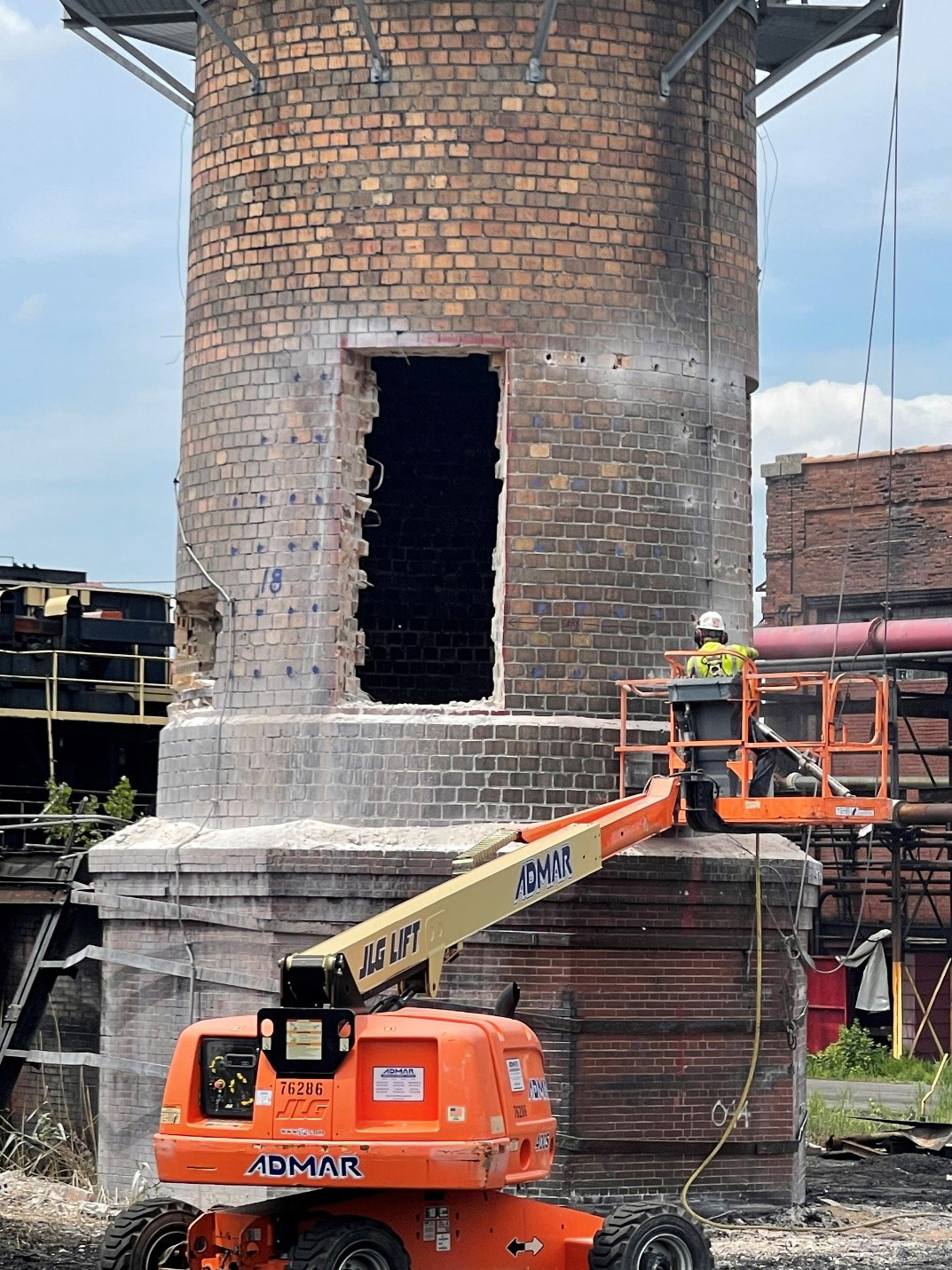

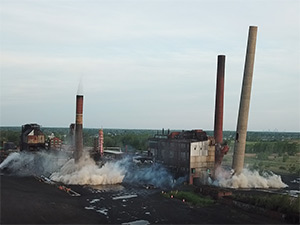

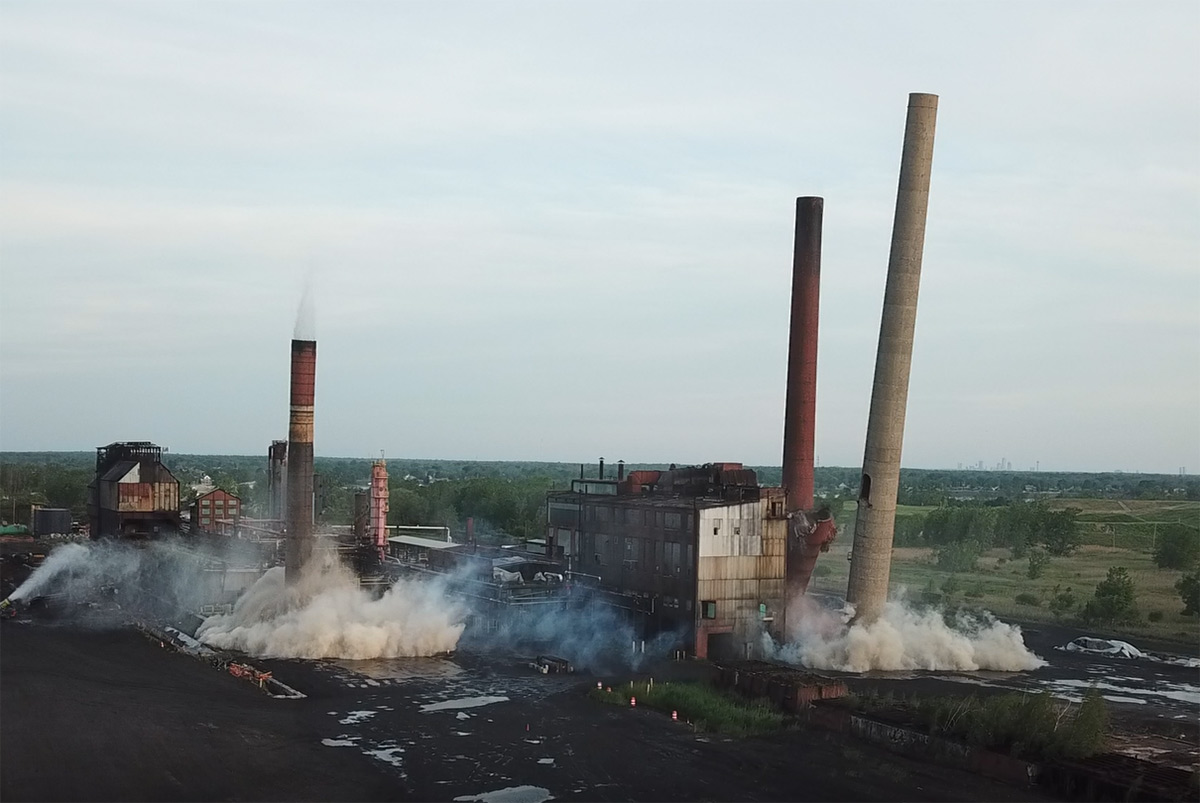

June 2021 - Battery Stack on the ground
June 2021 - Stacks on their way down
June 2021 - Wrapping concrete stack to limit debris at explosives elevation

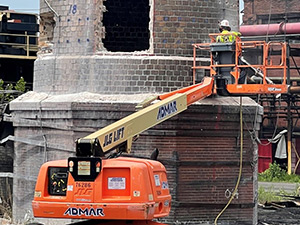

June 2021 - Drilling holes for dynamite in Battery Stack
June 2021 - Dawn of the last day for the Stacks
June 2021 - Coal Handling is down as well

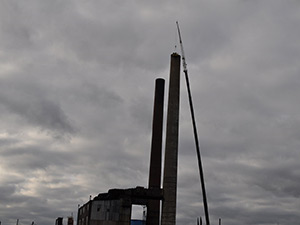

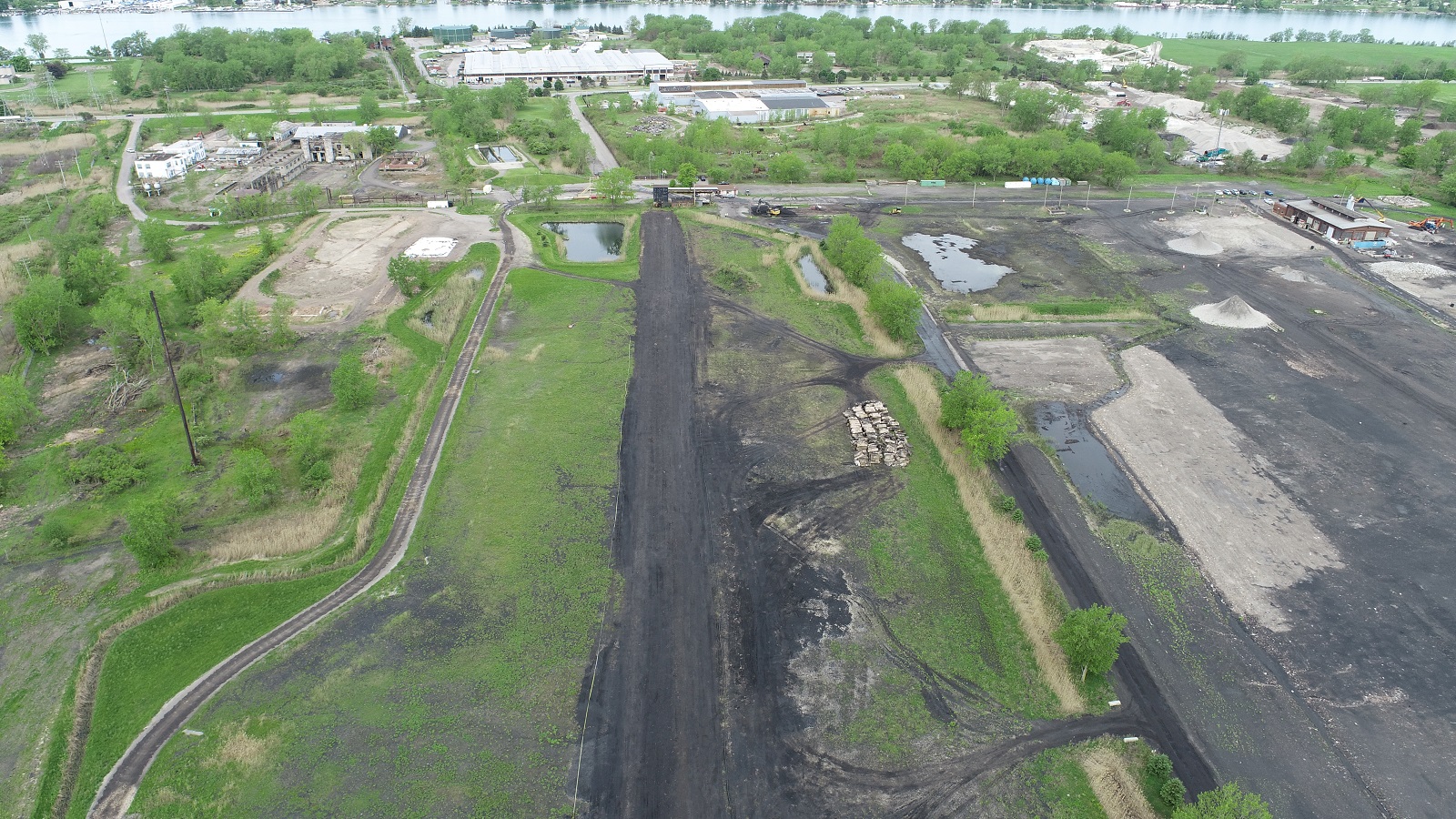

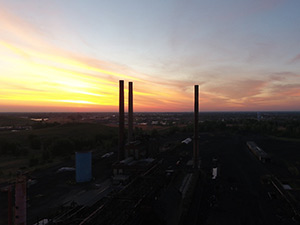

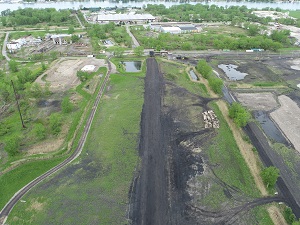

May 2021 - Stack View

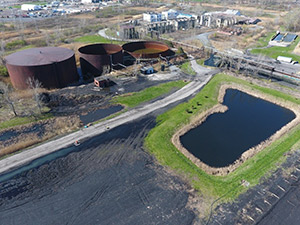

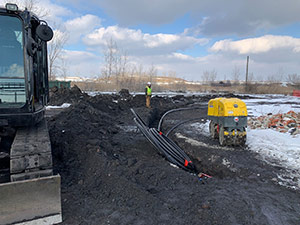

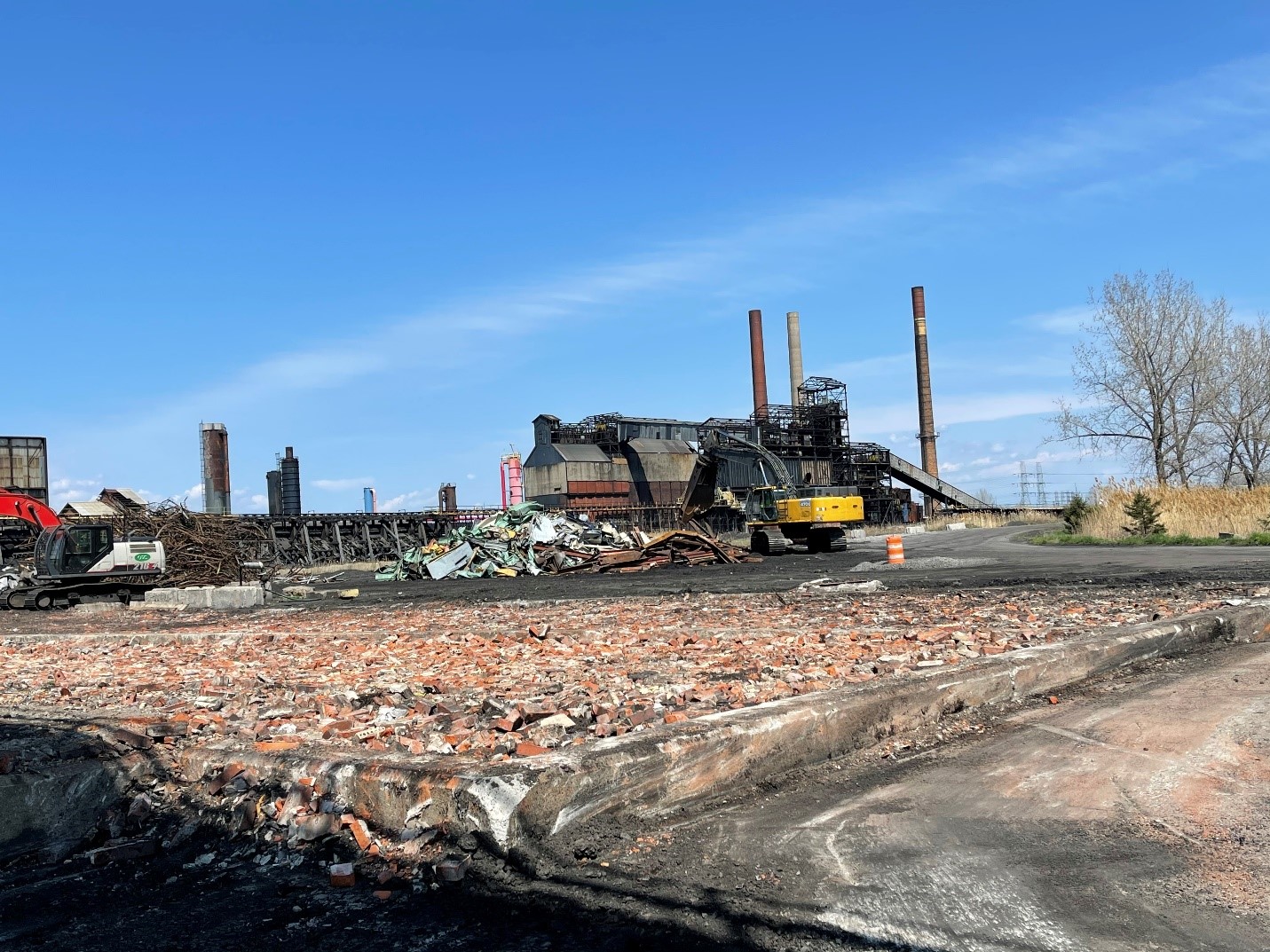

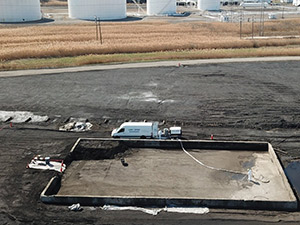

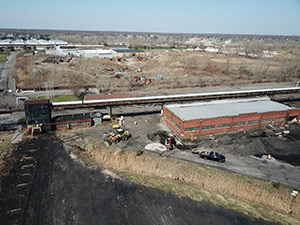

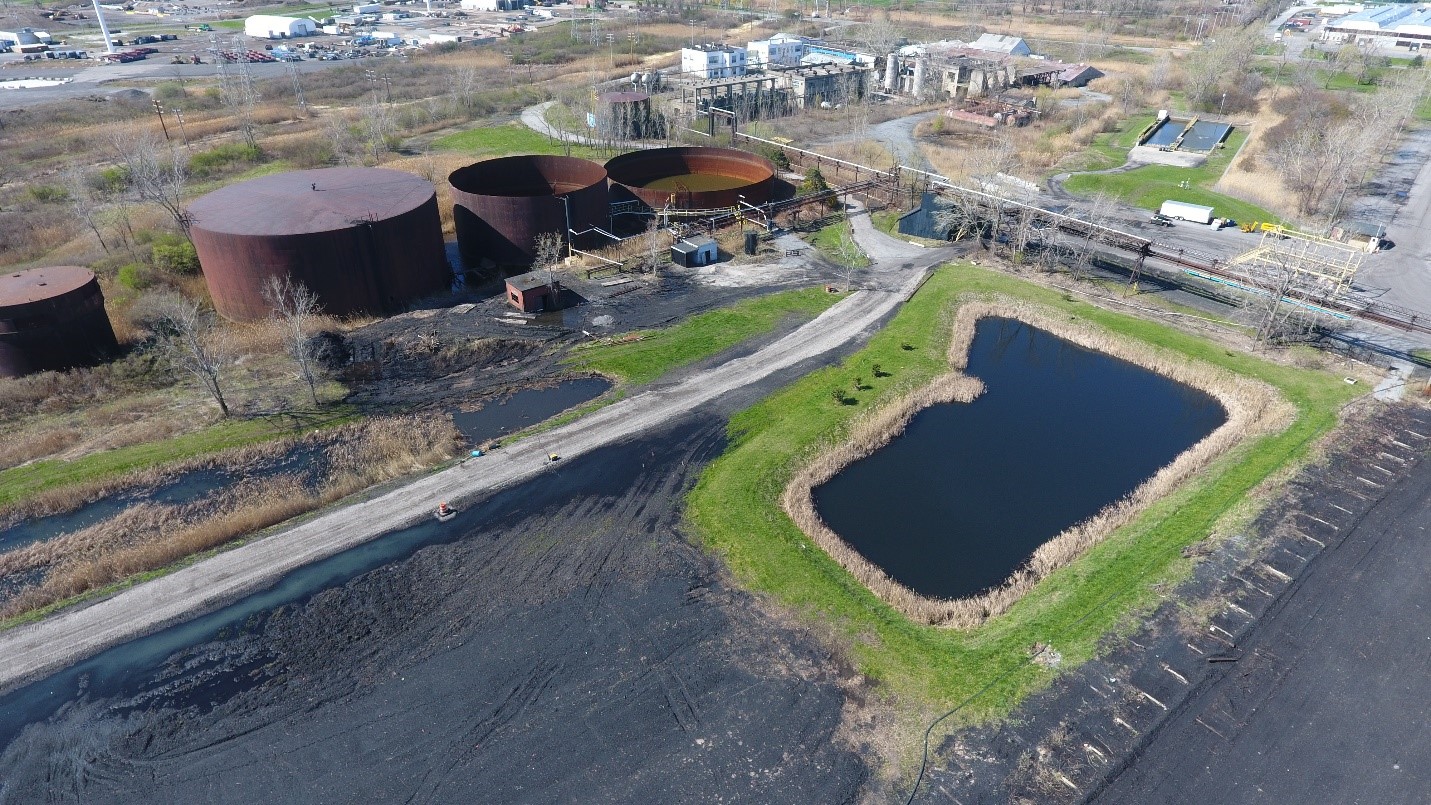

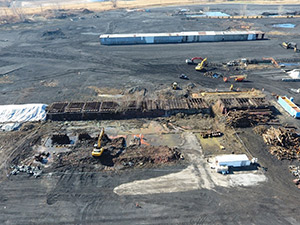

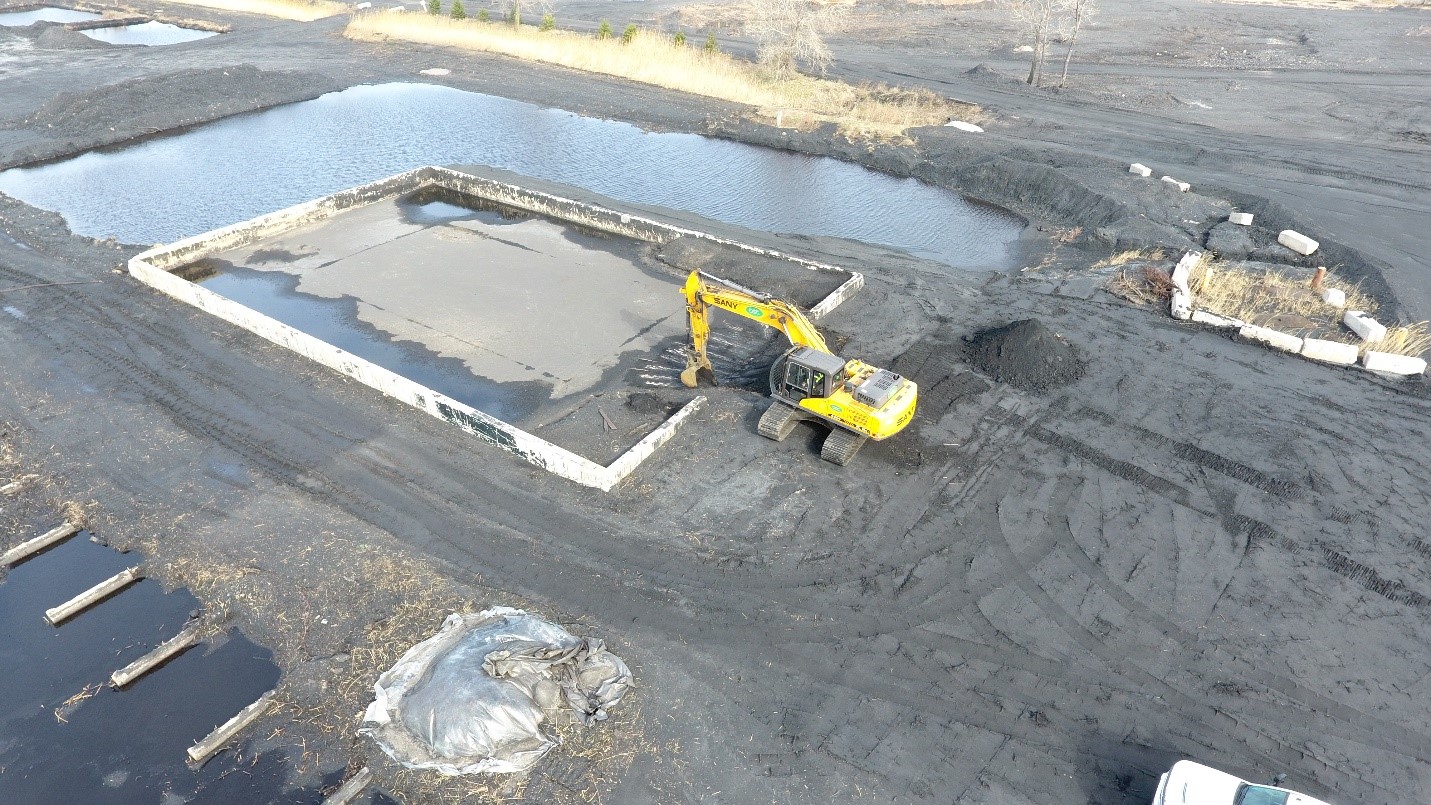

April 2021 - Water Treatment Area preparations for Stack Viewing event

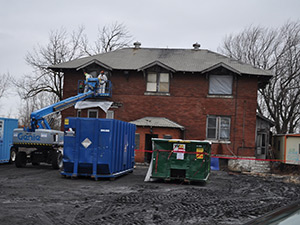

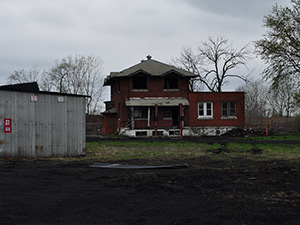

April 2021 - Mansion preparations for demolition
April 2021 - Former Shower Building location

April 2021 - Shower Building

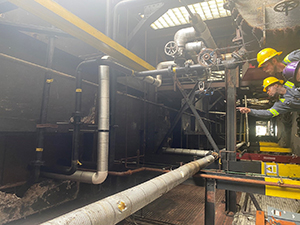

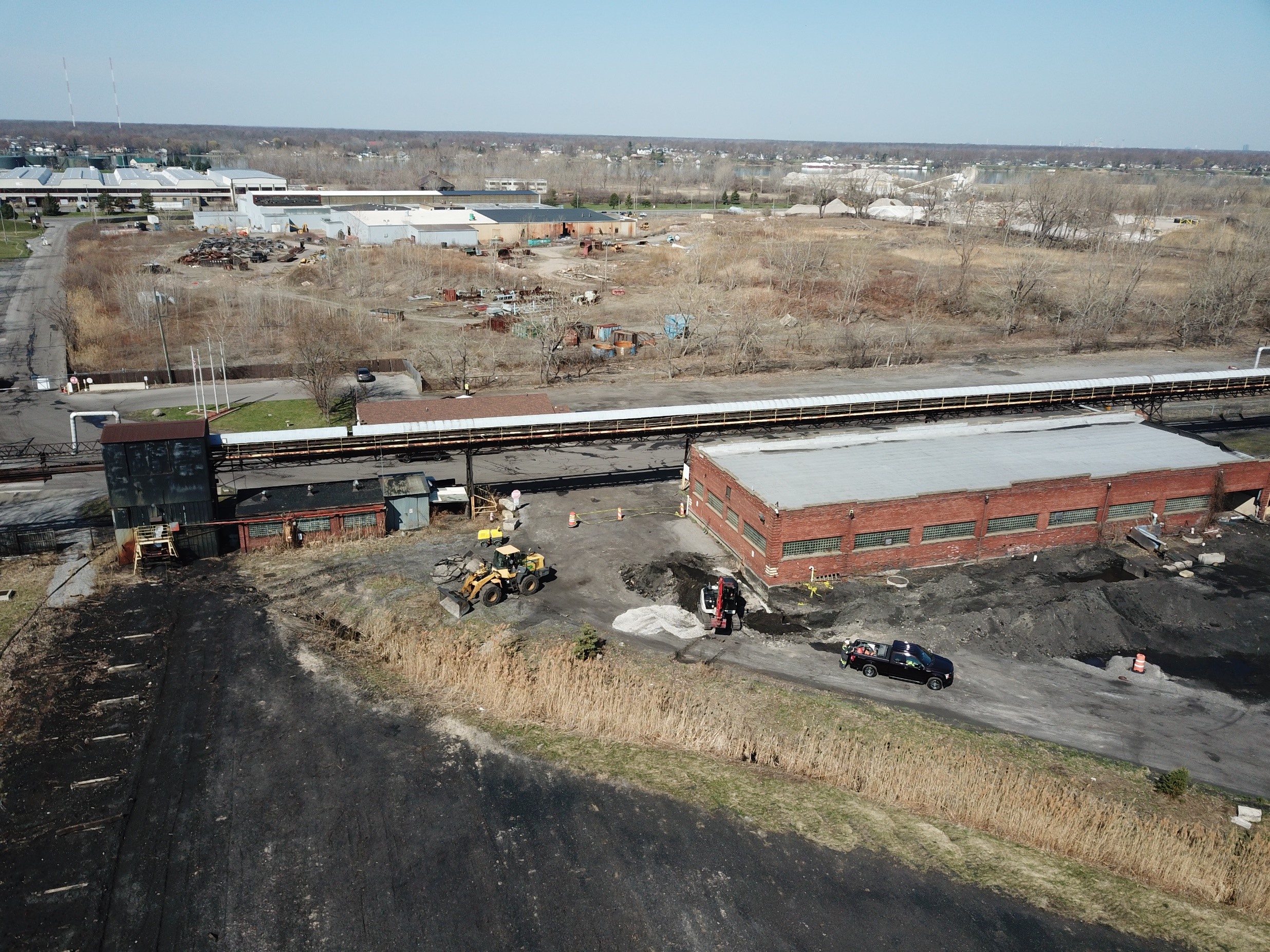

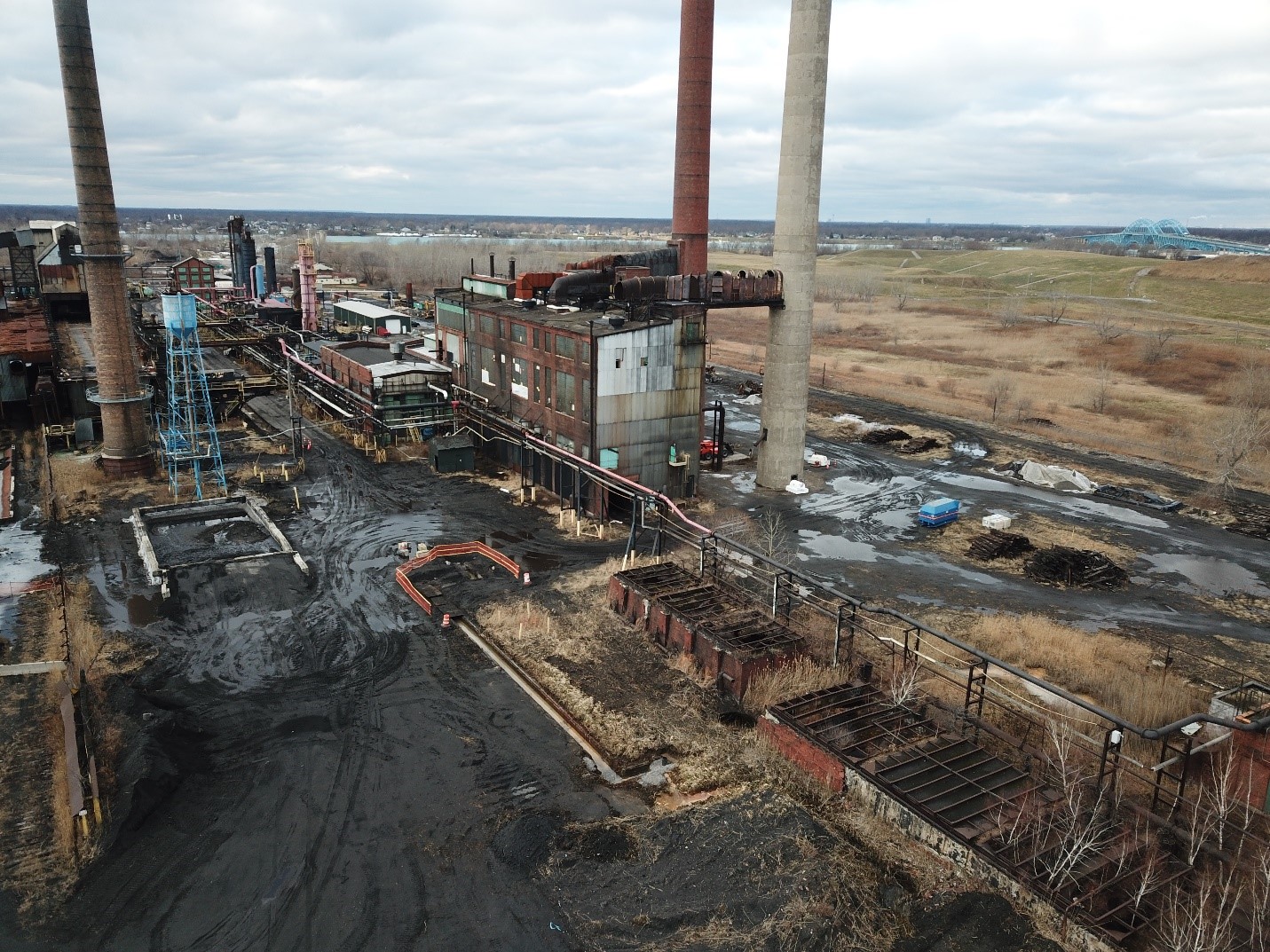

April 2021 - Preparation of Boiler House ductwork for removal
April 2021 - Vacuuming materials from north storm sewer

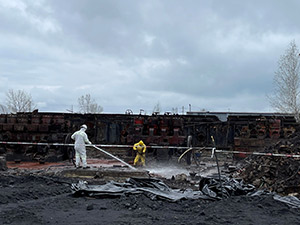

April 2021 - Breaker Building after Asbestos Containing Materials were removed
April 2021 - Decontamination of mixing pad with ice basting and garnet abrasive
April 2021 - Preparing mixing pad for decontamination
April 2021 - Power washing former Compressor Building debris
April 2021 - Compressor Building demolition

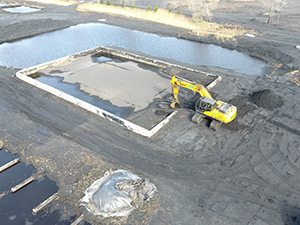

April 2021 - East Quench Tower demolition

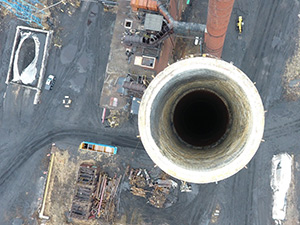

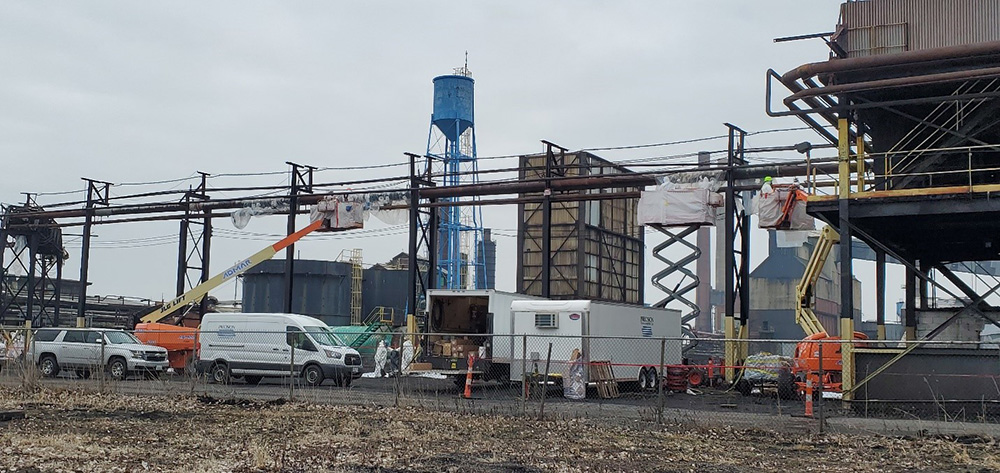

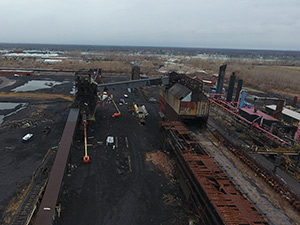

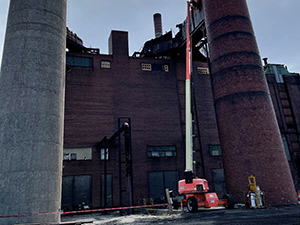

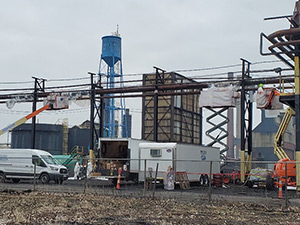

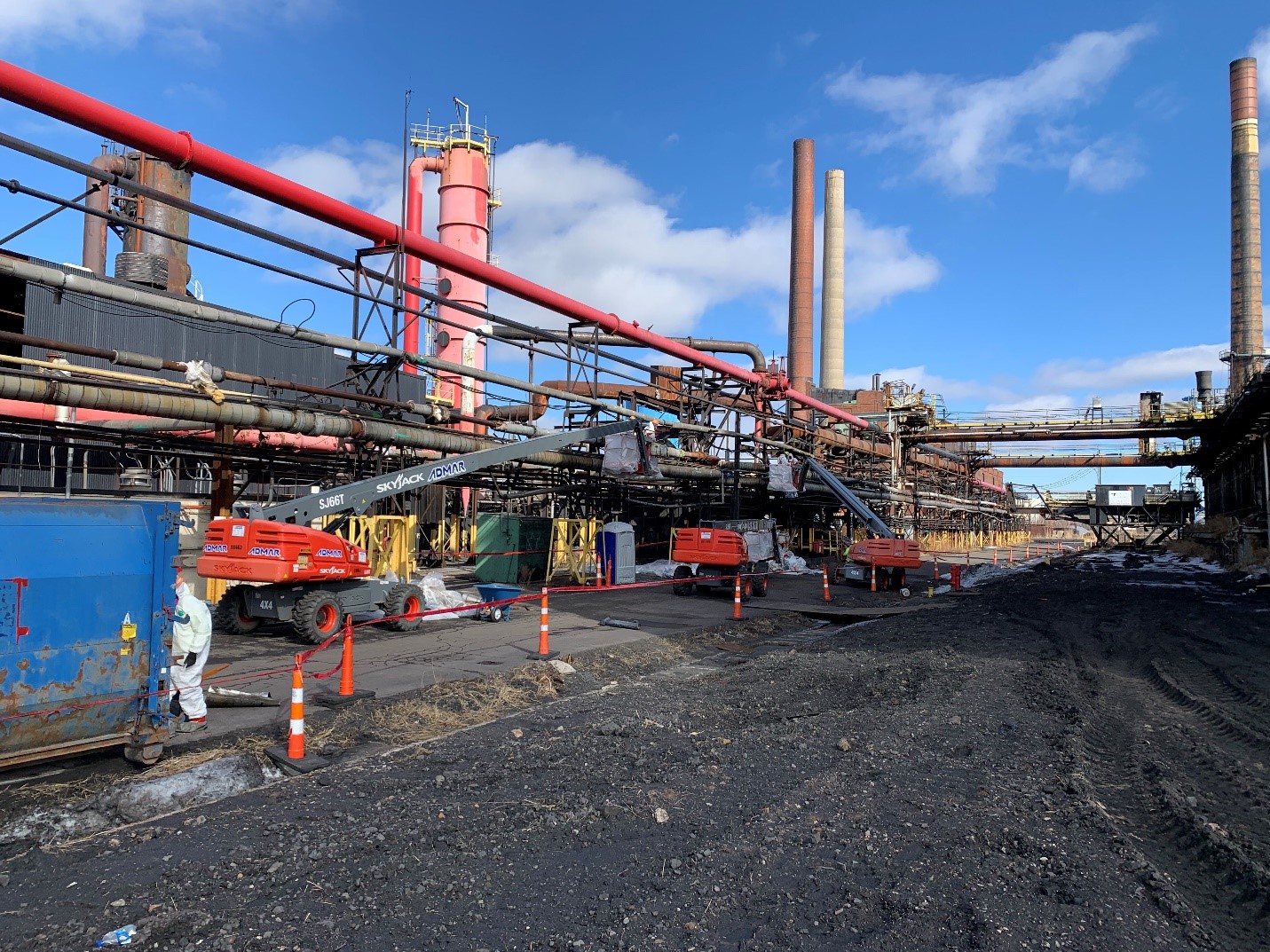

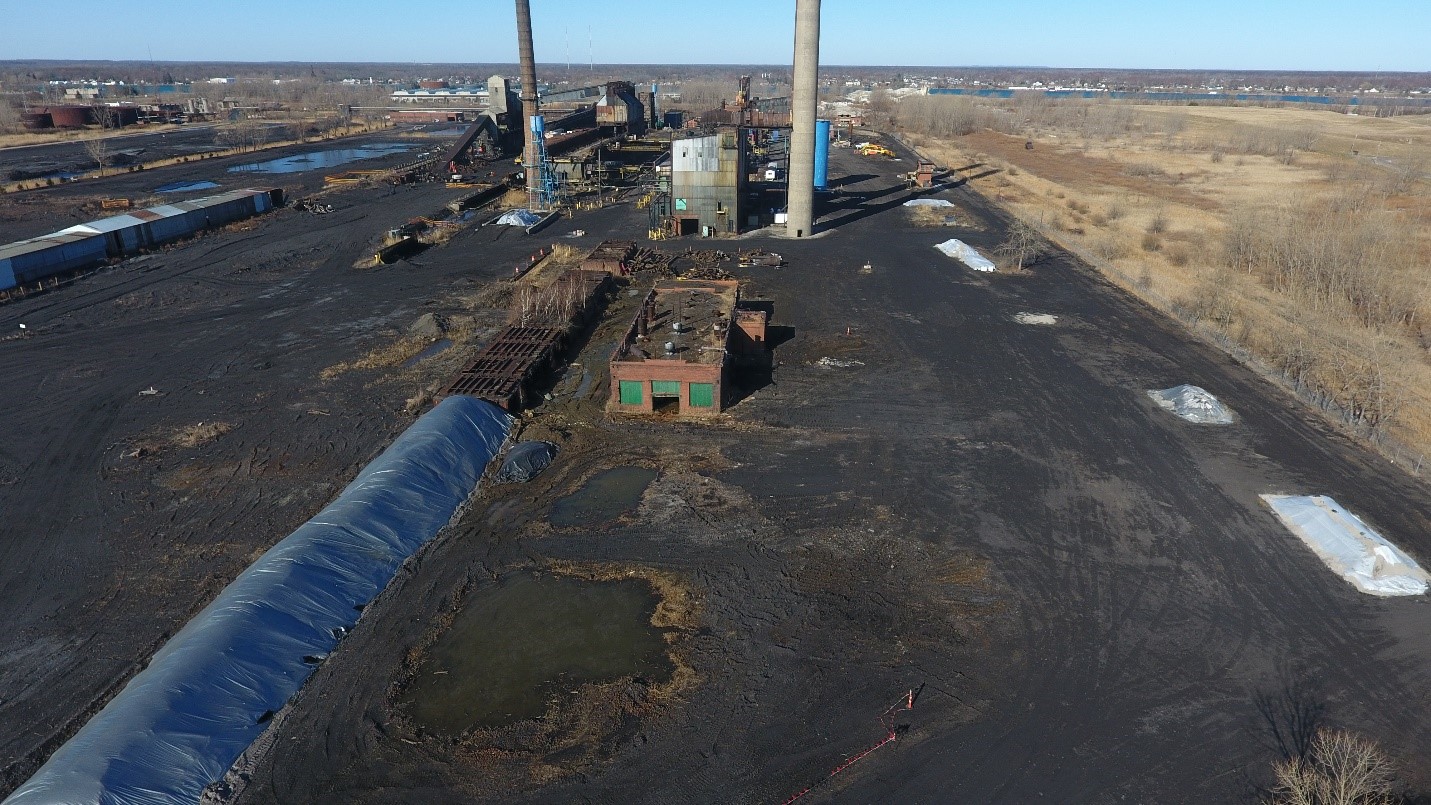

March 2021 - Northeast stack inspection

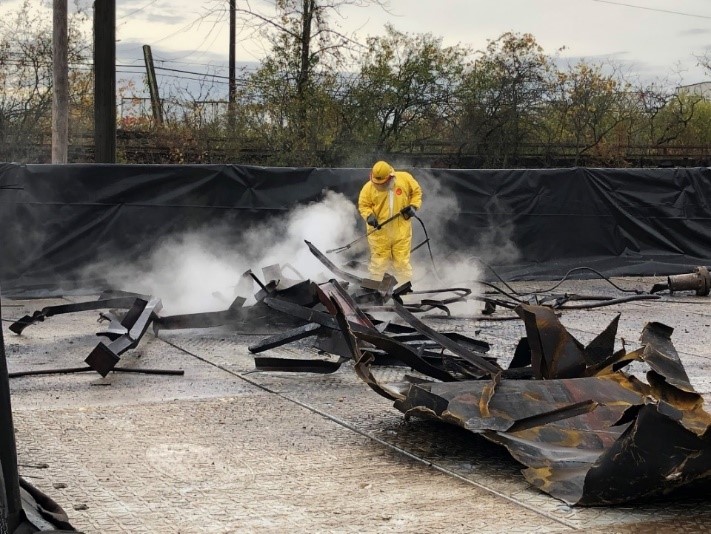

March 2021 - Transferring cleaned debris from work area to stockpile
March 2021 - Washing asbestos from debris - compressor building

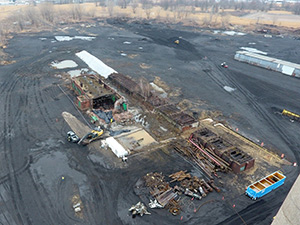

March 2021 - Controlled demolition - compressor building
March 2021 - Asbestos abatement - coal-handling building roof

March 2021 - Compaction of surface roads to limit dust and erosion
March 2021 - Asbestos abatement - coal-breaker building
March 2021 - Gas Holder location, after removal

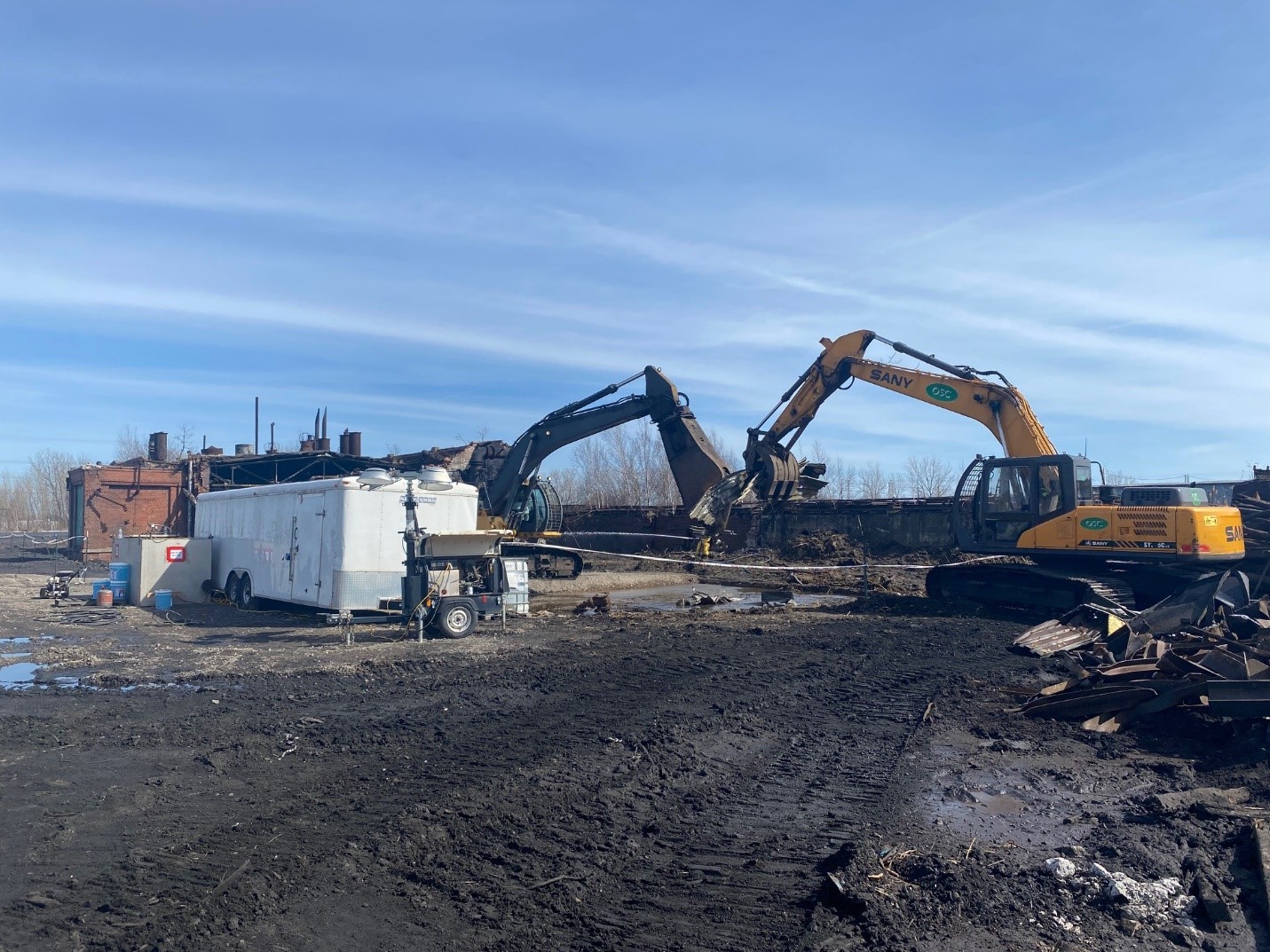

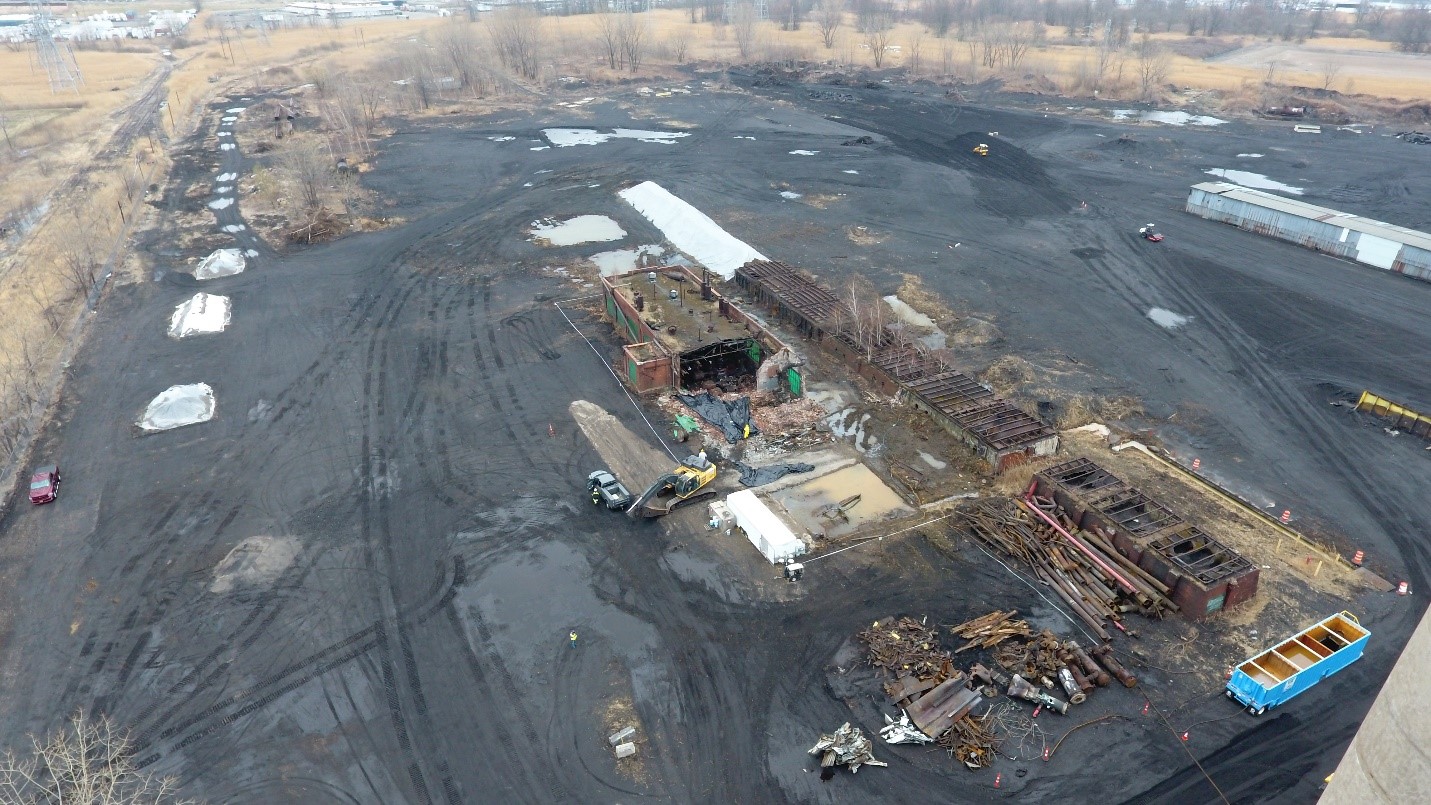

March 2021 - Management of demolition debris from coke handling

March 2021 - Coke-handling building location, after structure is on ground

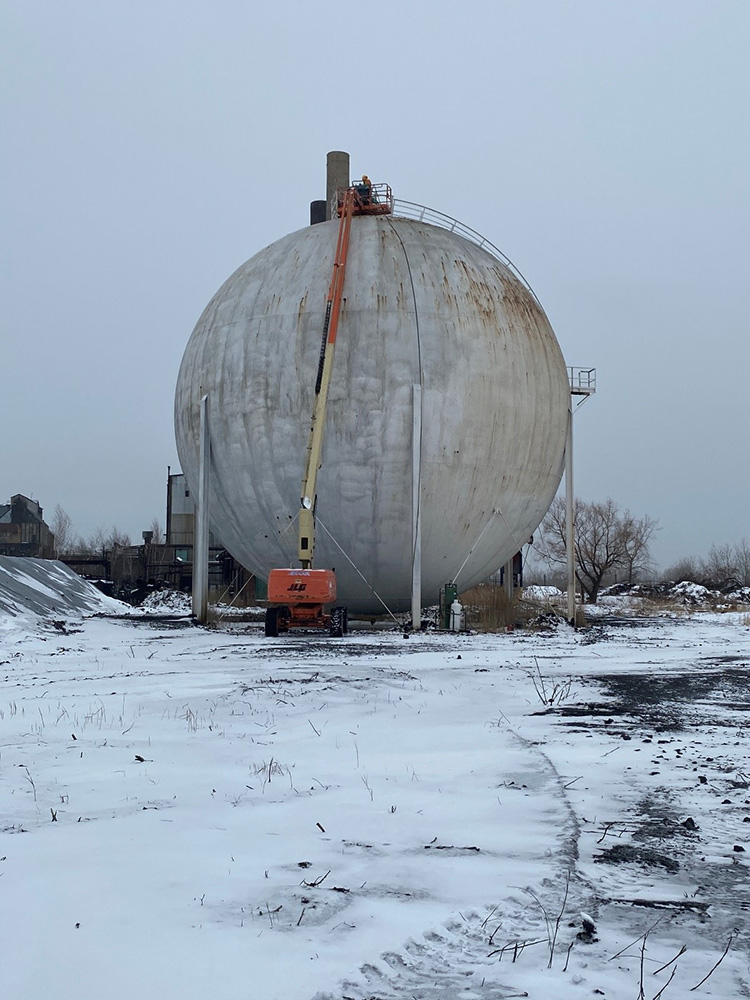

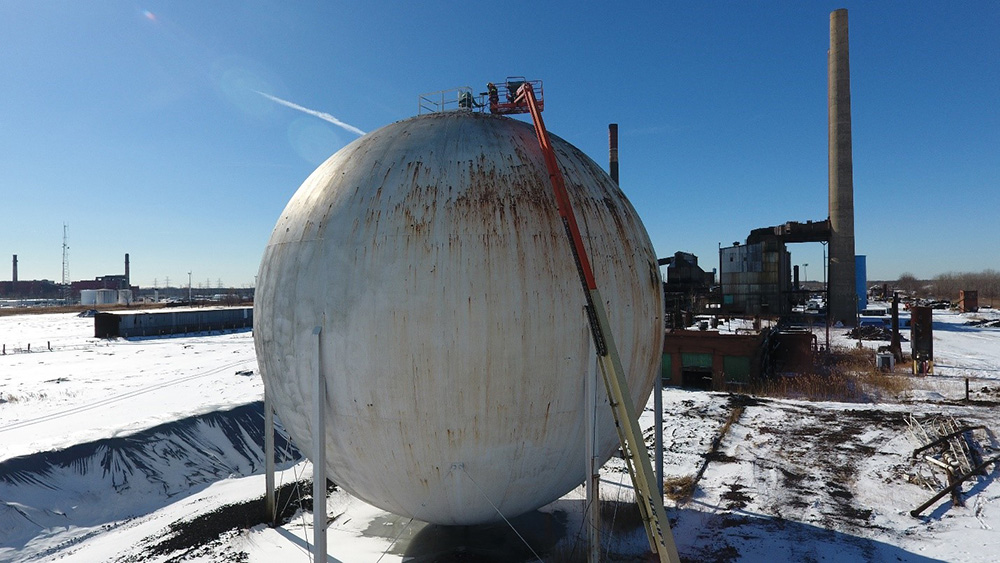

March 2021 - Gas Holder (aka Gas Ball) final above ground cutting

March 2021 - Cutting the Gas Holder to size for recycling

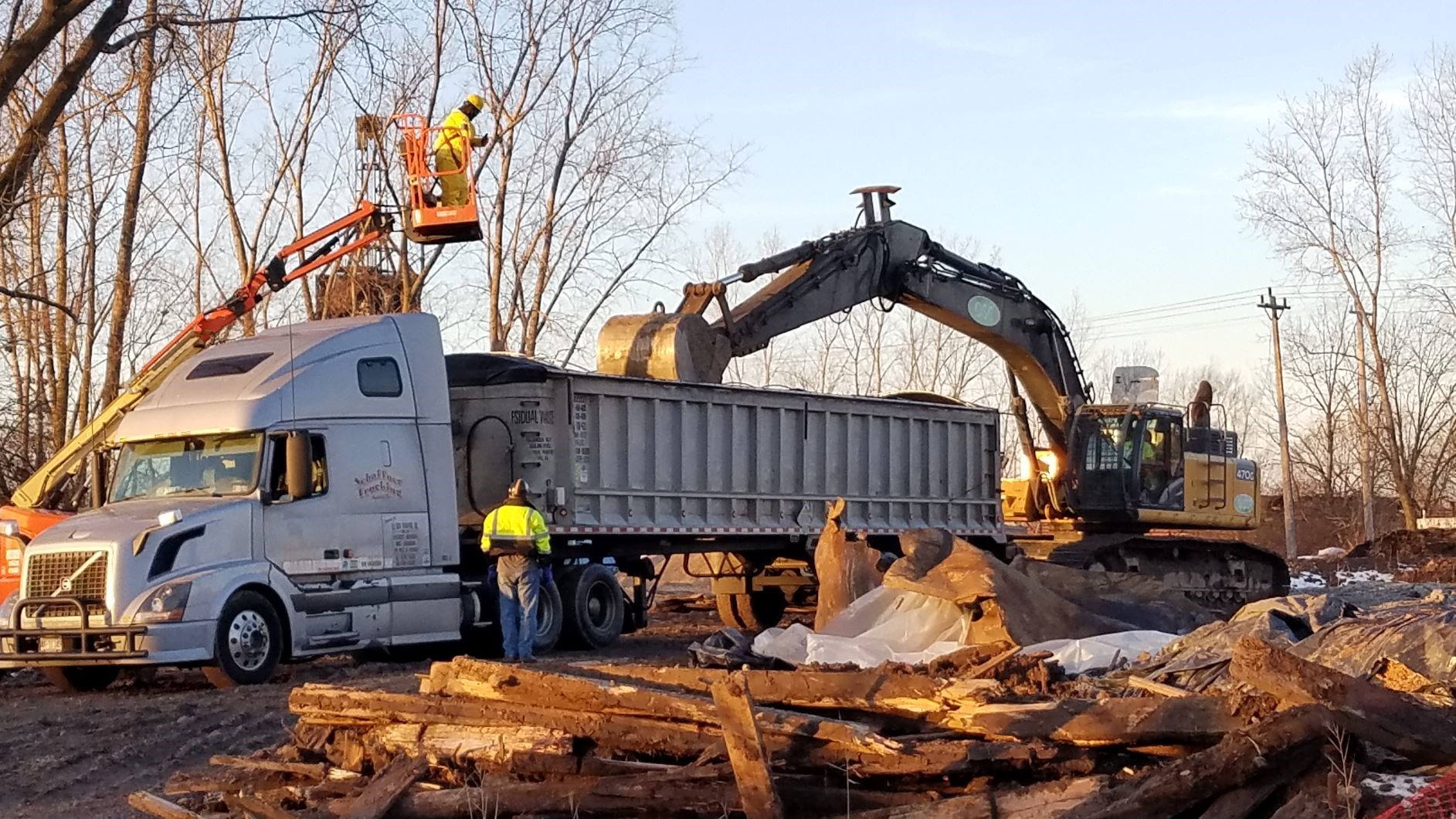

March 2021 - Railroad ties being loaded for offsite disposal

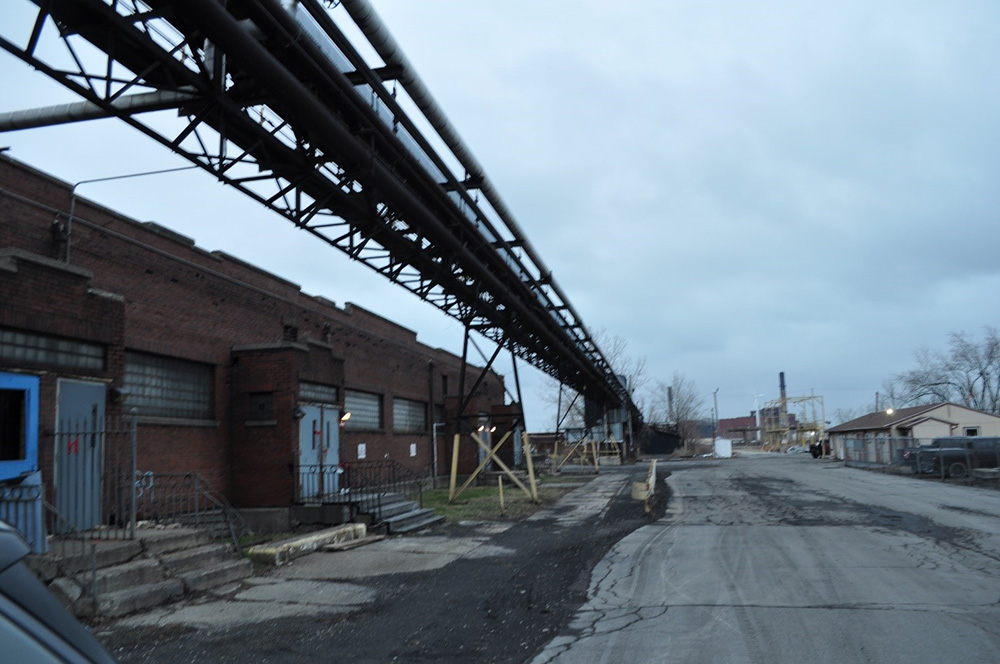

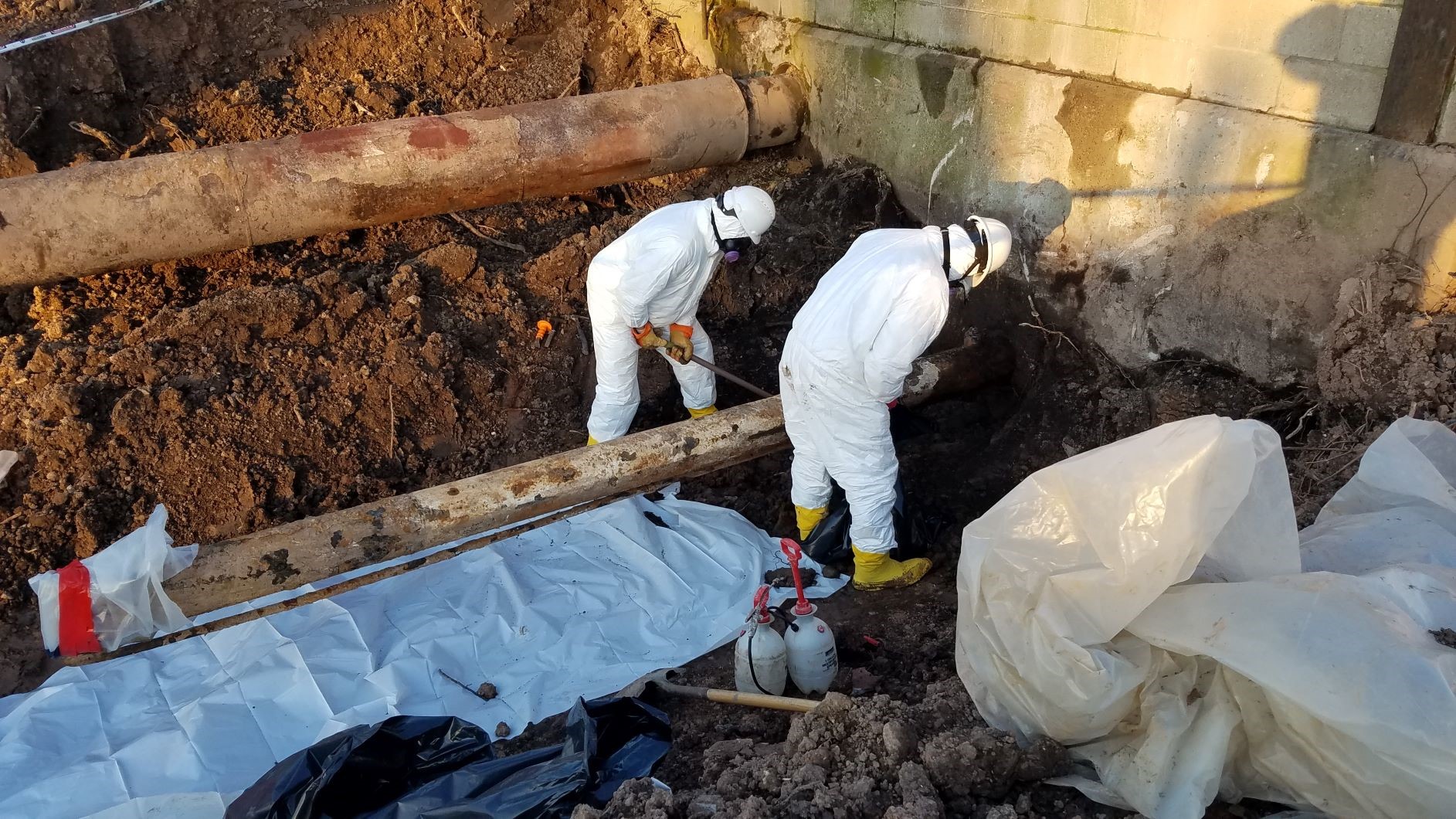

March 2021 - Asbestos abatement of overhead pipes along 'Broadway'

February 2021 - South Side of Coal Crusher building prepared for removal of Asbestos-Containing Materials; Breeze Crusher building and mezzanine removed

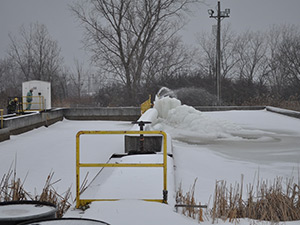

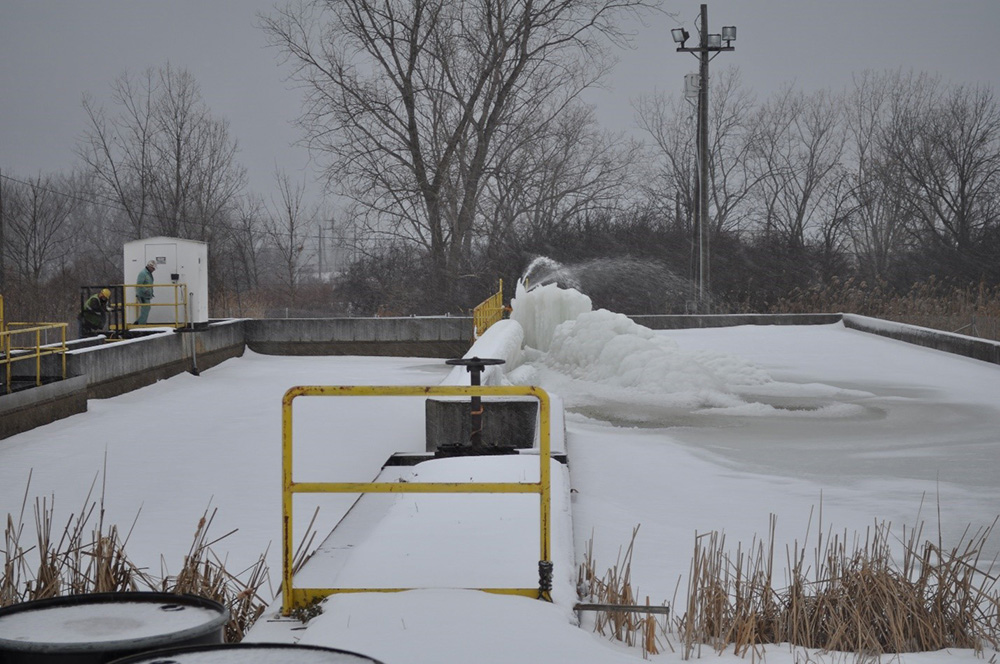

February 2021 - Treated storm water

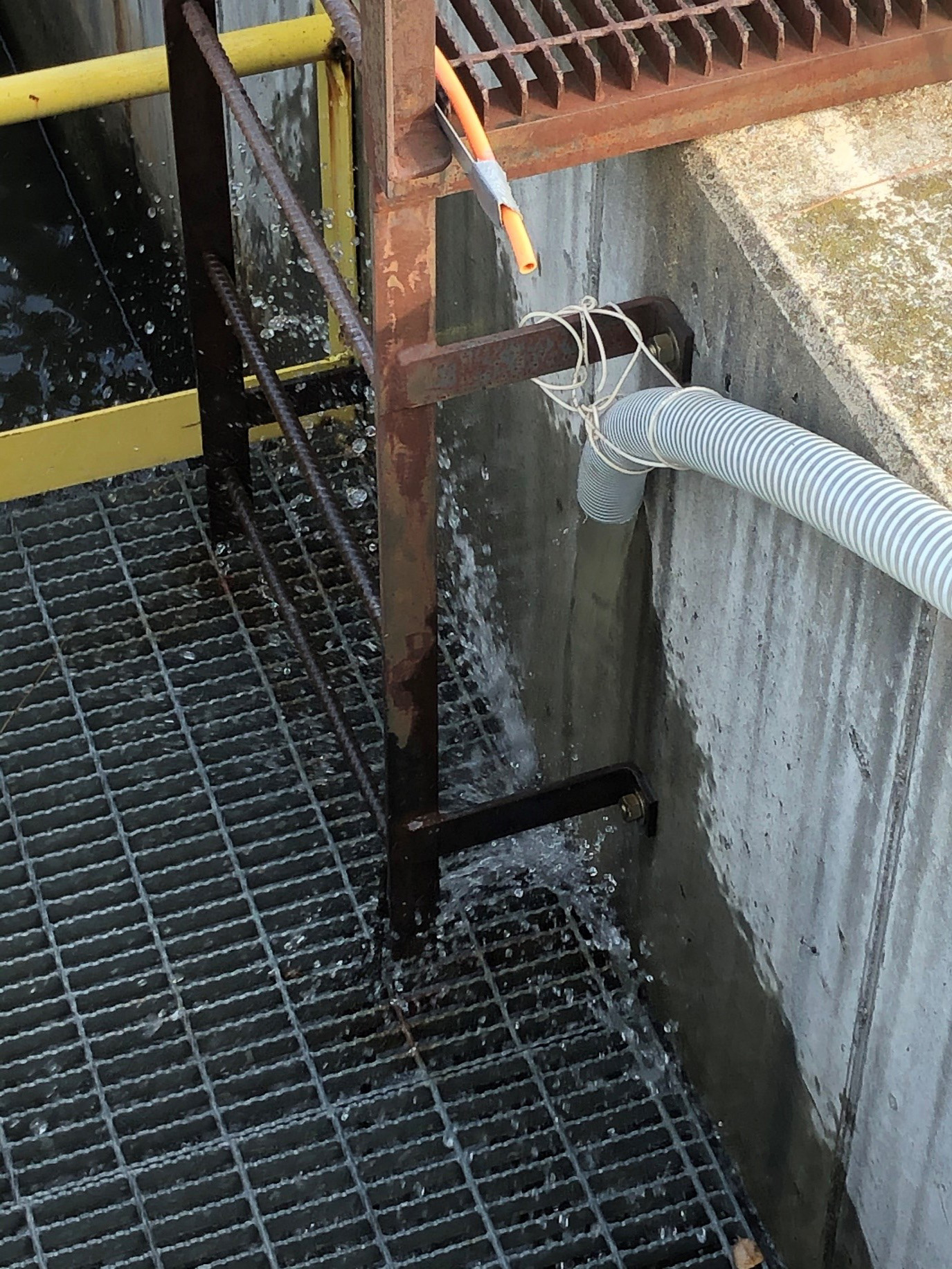

February 2021 - Water management - pump inspection

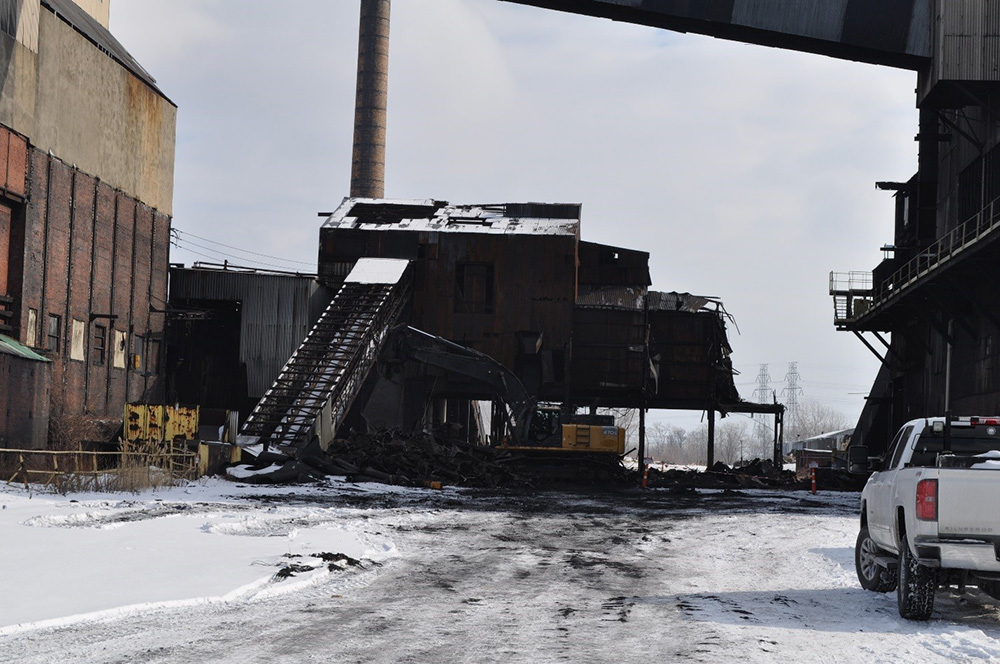

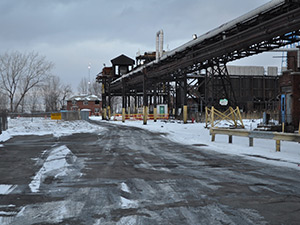

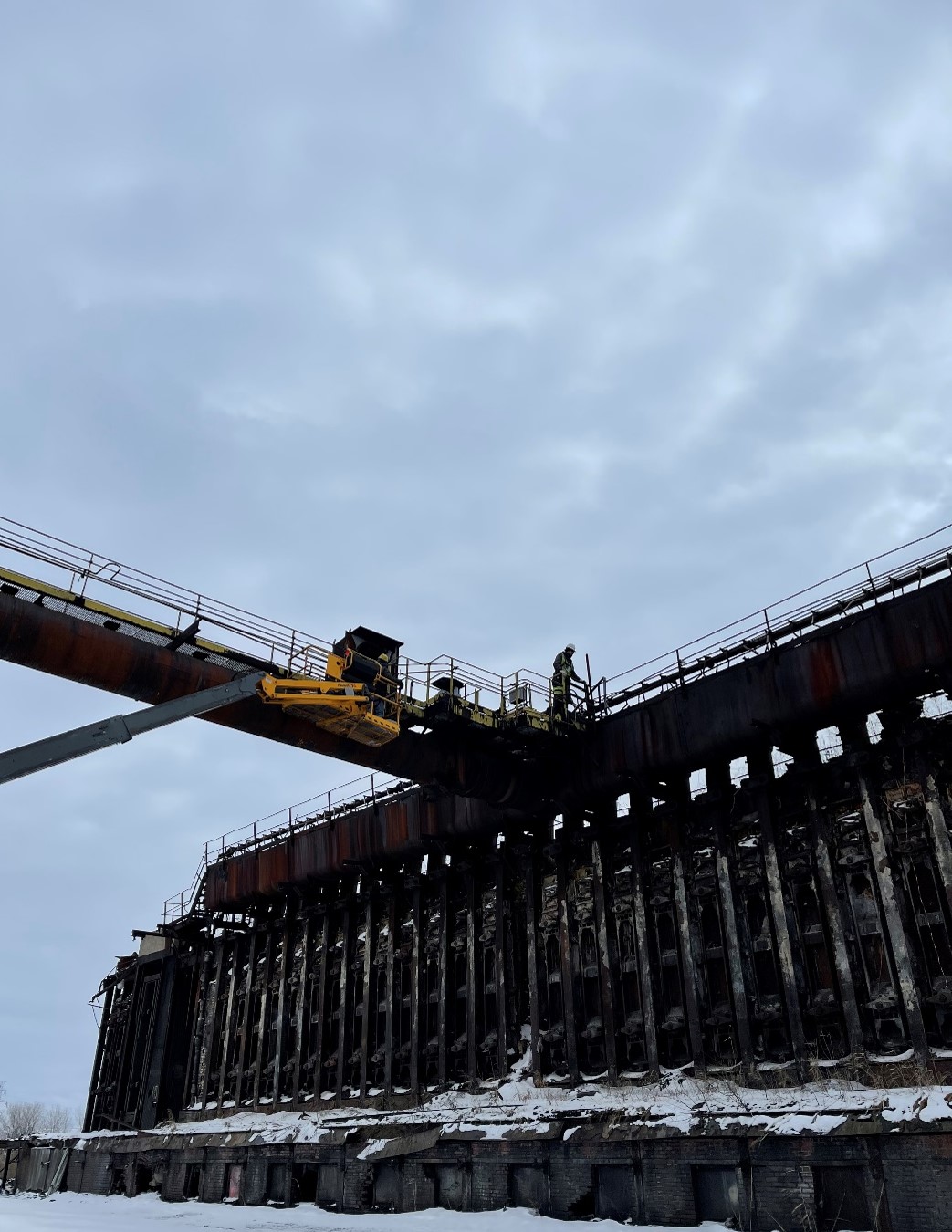

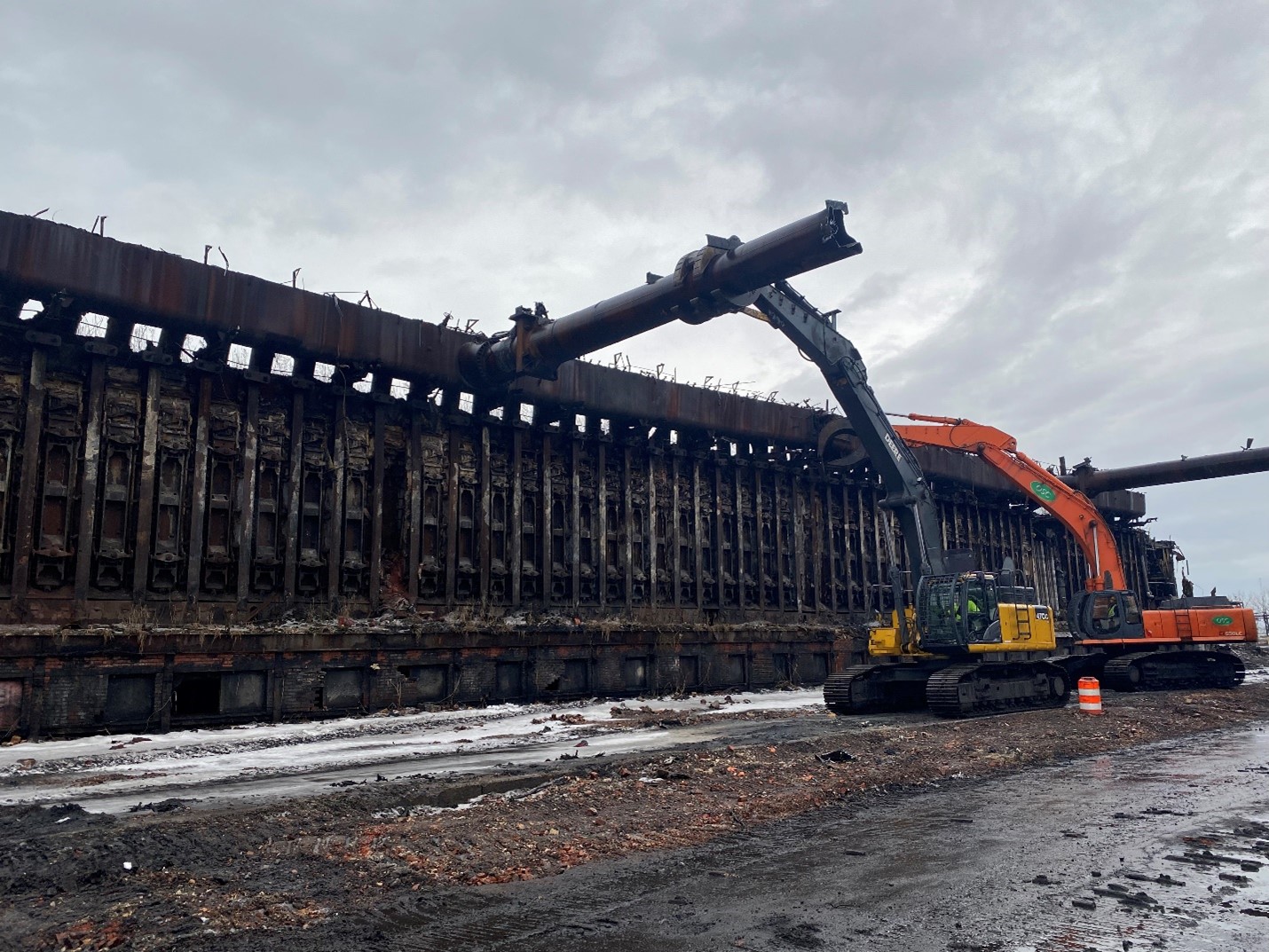

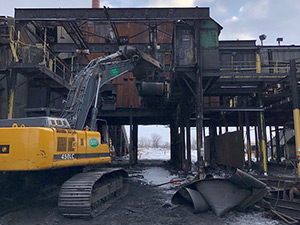

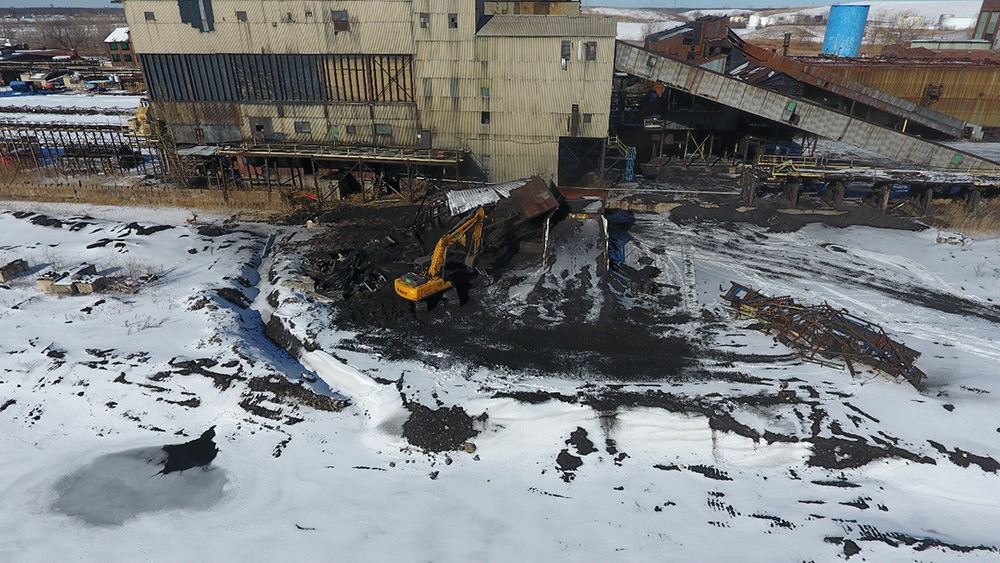

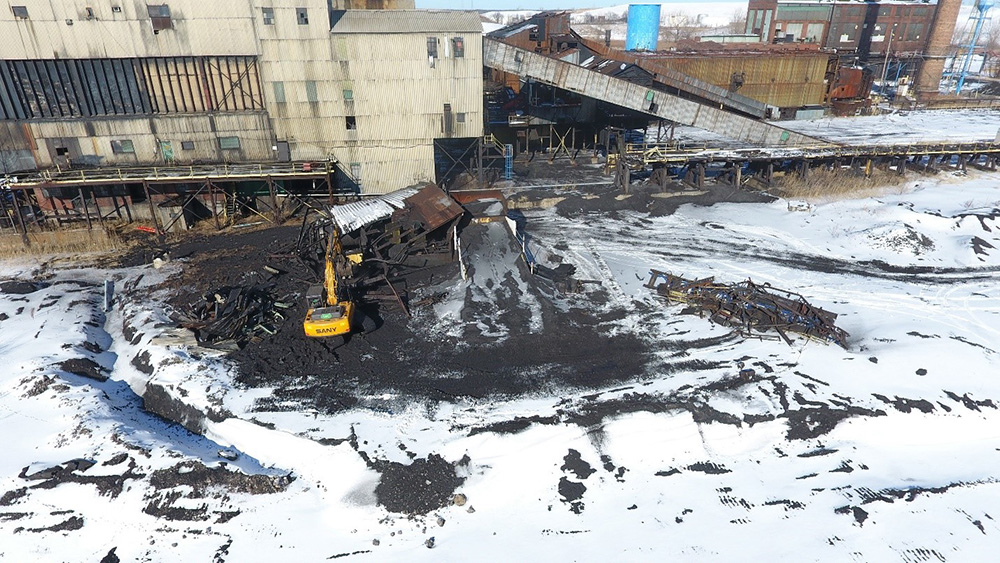

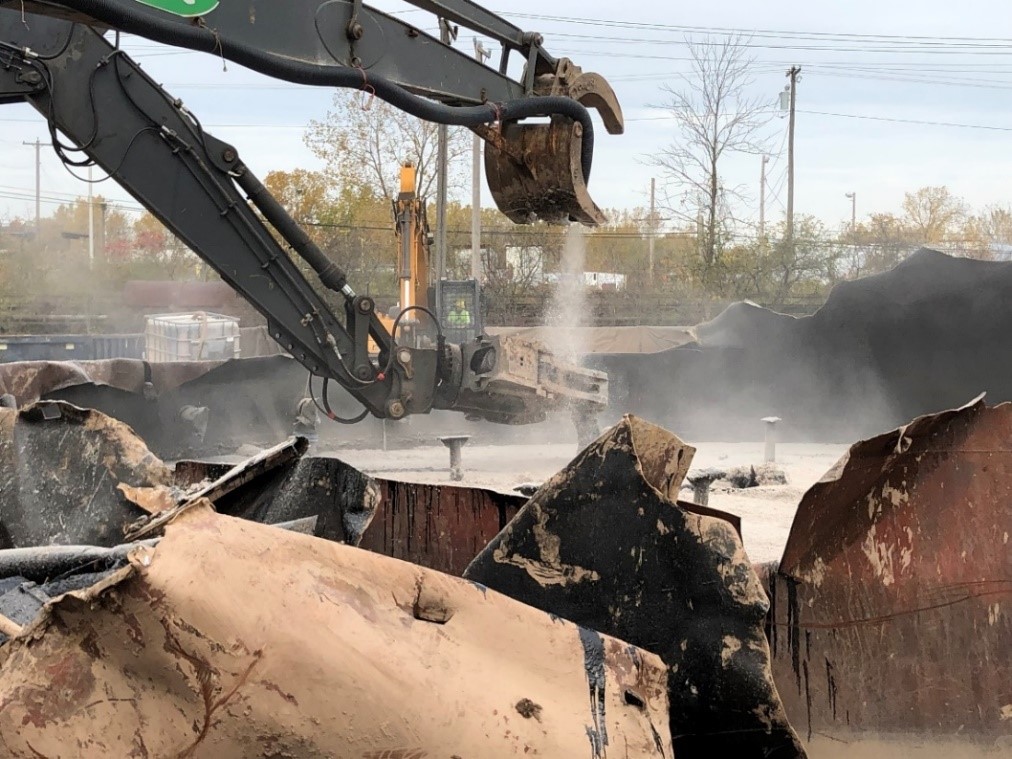

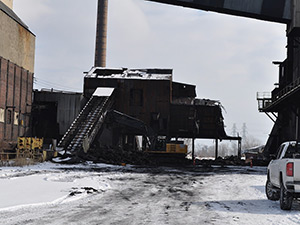

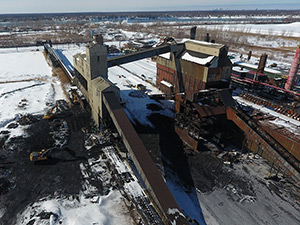

February 2021 - Coke handling after material processing; demolition pending final removal of Asbestos-Containing Materials
February 2021 - Demolition - Coke-handling building (looking east); more than 50 percent removed

February 2021 - Air monitoring station during tank storage tank sampling

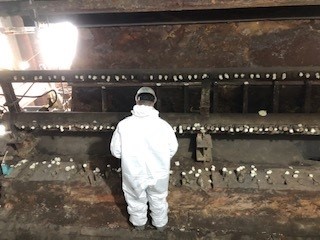

February 2021 - Section of boiler - Asbestos-Containing Materials free
February 2021 - Asbestos-Containing Materials abatement - Boiler House

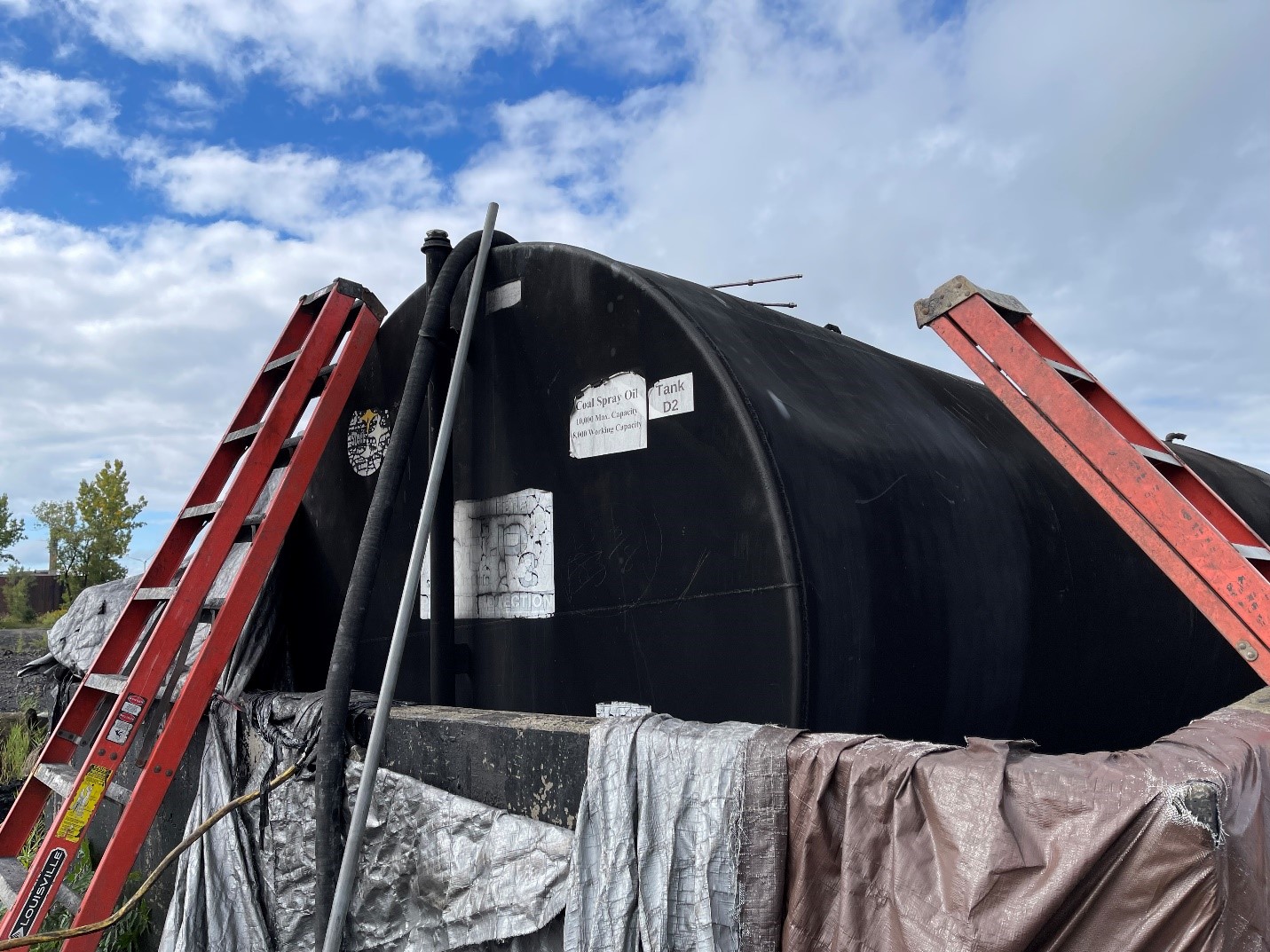

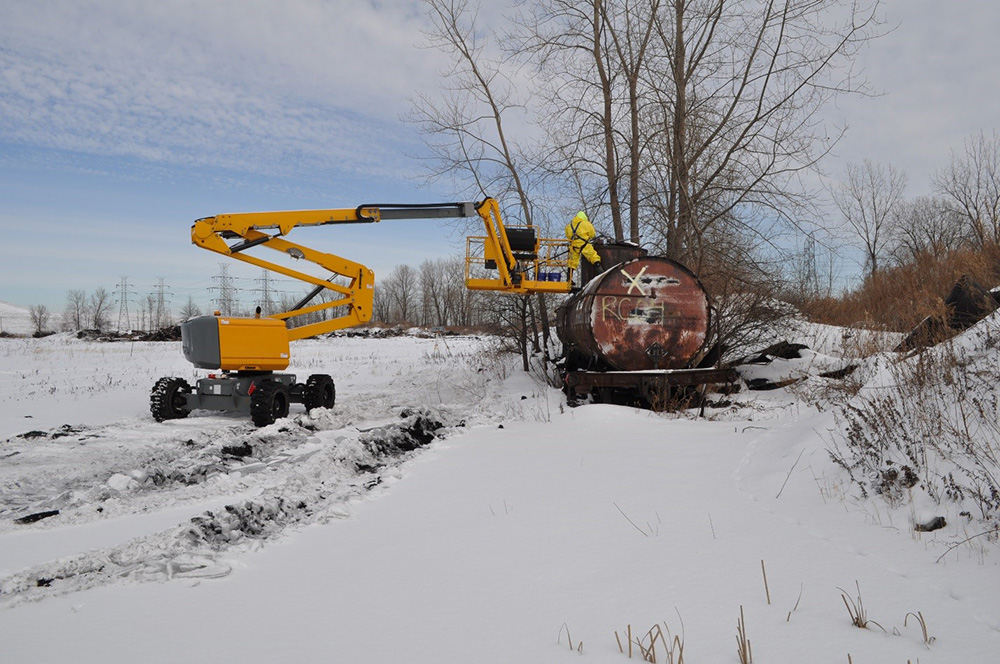

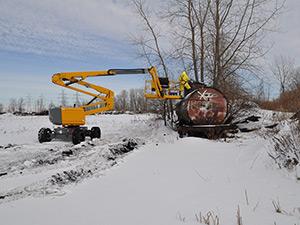

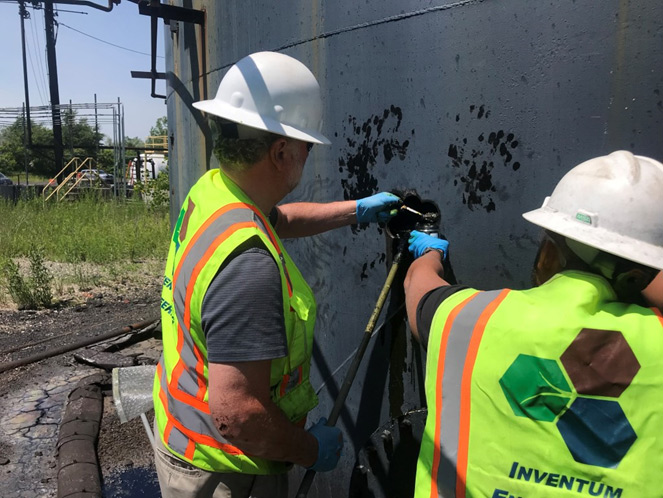

February 2021 - Tank sampling - tar management area
February 2021 - Sampling rail car
February 2021 - Sampling rail car
February 2021 - Sampling waste oil tank

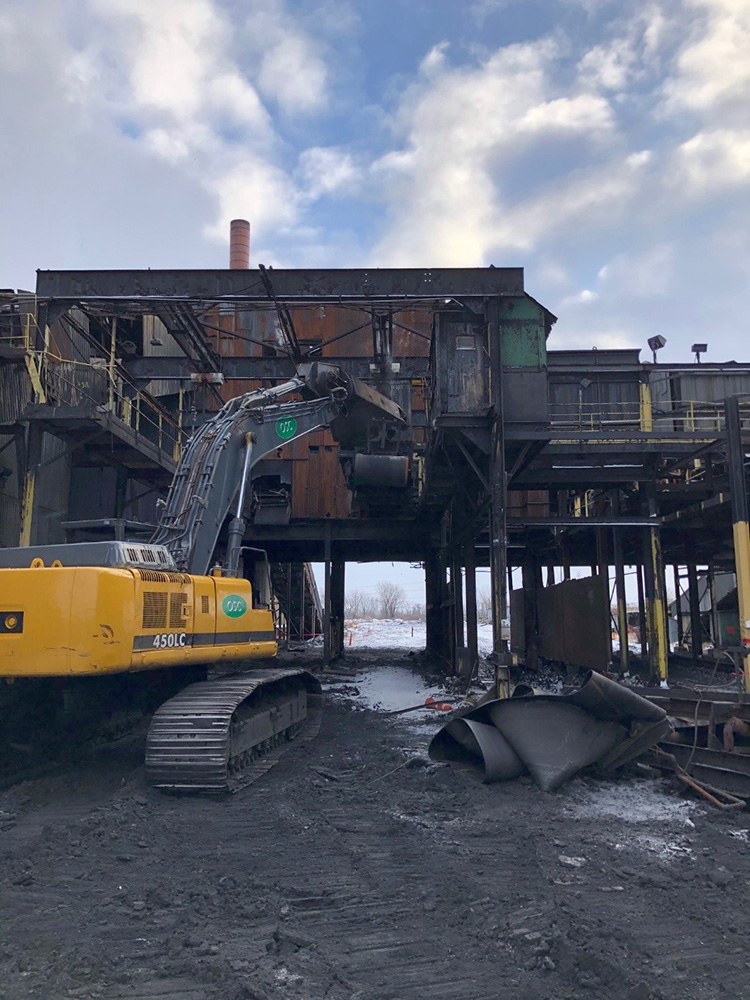

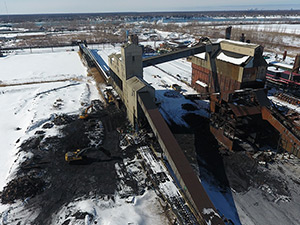

February 2021 - Coke-handling demolition (looking Northwest)
February 2021 - Coke-handling demolition
February 2021 - Processing metal from coke-handling building

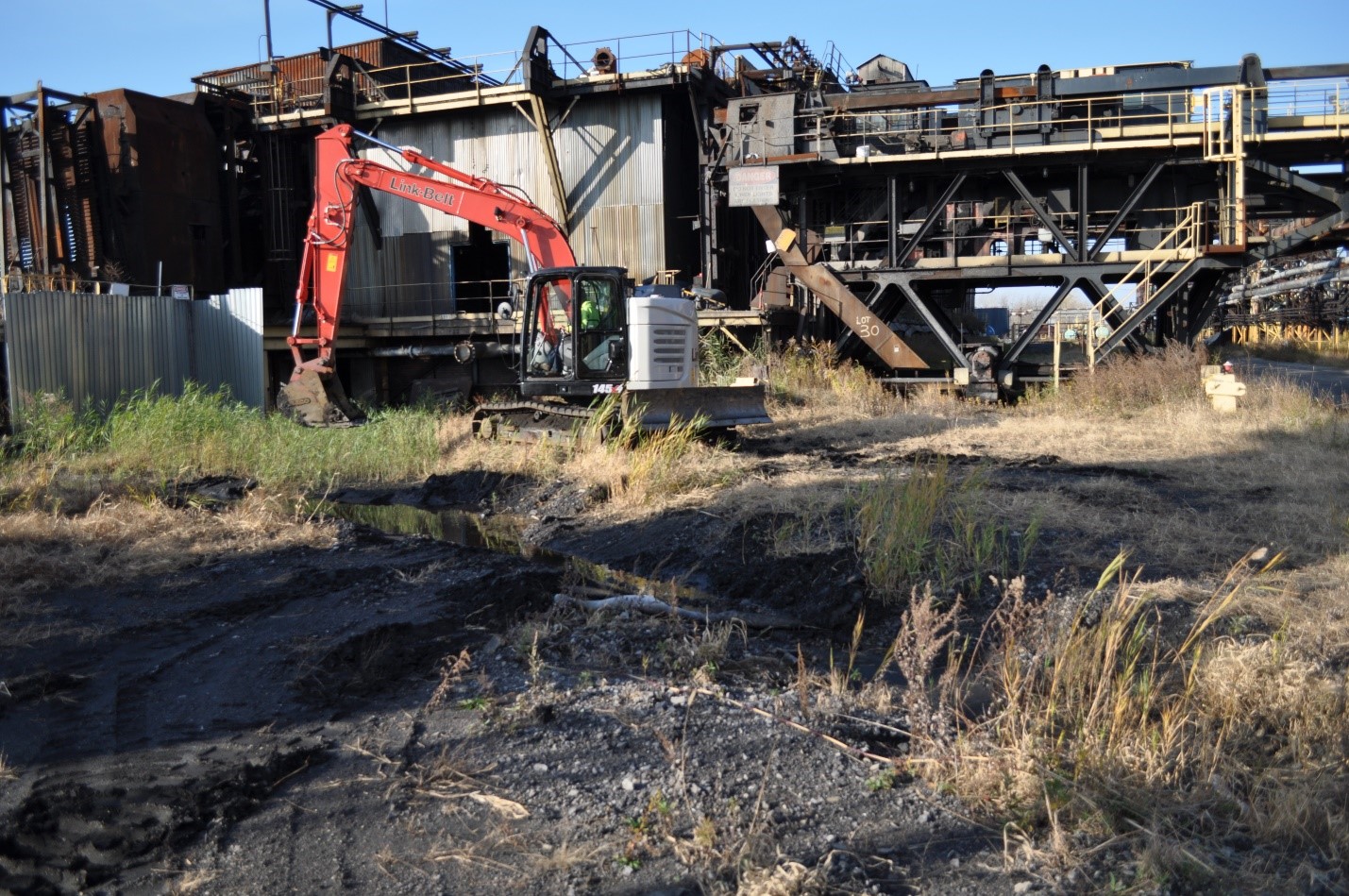

February 2021 - Sorting recyclable materials from Breeze Crusher (aka Ball Mill) building
February 2021 - Breeze Crusher (aka Ball Mill) building demolition; creates access for abatement of Asbestos-Containing Materials of Coal Crusher building

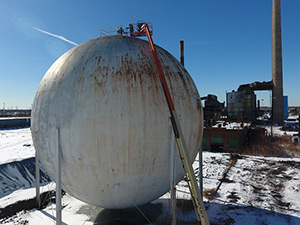

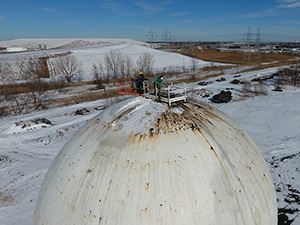

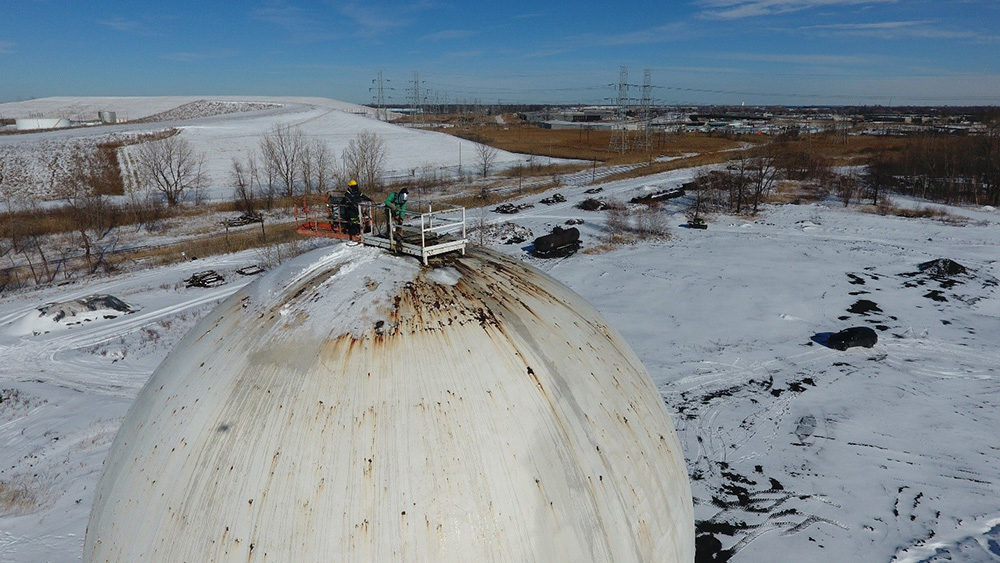

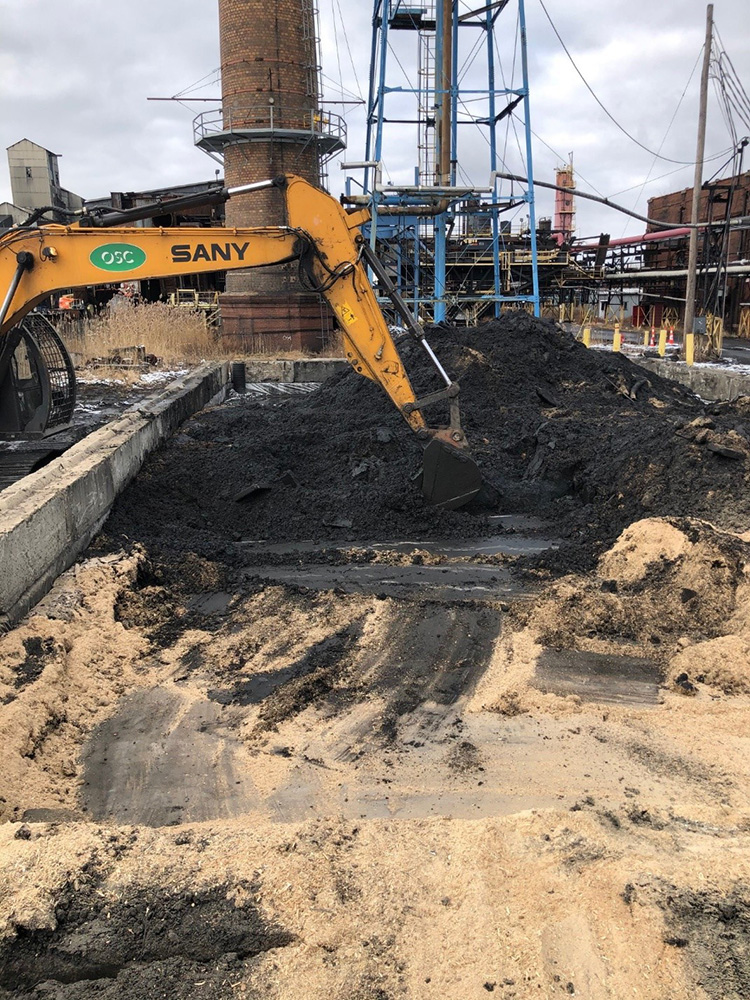

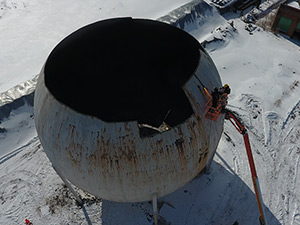

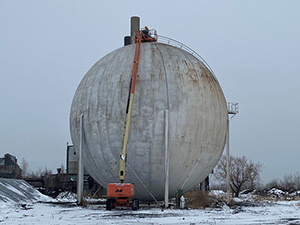

February 2021 - Top removed from Gas Holder
February 2021 - Top removed from Gas Holder
February 2021 - Ladder removed from Gas Holder
February 2021 - Removing ladder and platform from Gas Holder
February 2021 - Preparing the Gas Holder (aka Gas Ball) for demolition

January 2021 - Cleaning Mansion sump

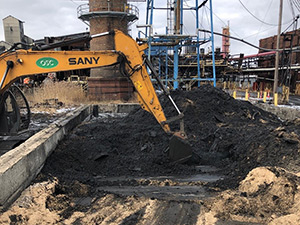

January 2021 - Stabilization of sediment from box culvert

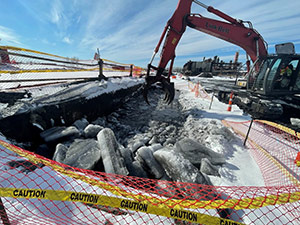

January 2021 - Sediment removal - box culvert
January 2021 - Pre-demolition survey - Coke Handling building
January 2021 - Removing conveyors to allow Asbestos-Containing Materials abatement

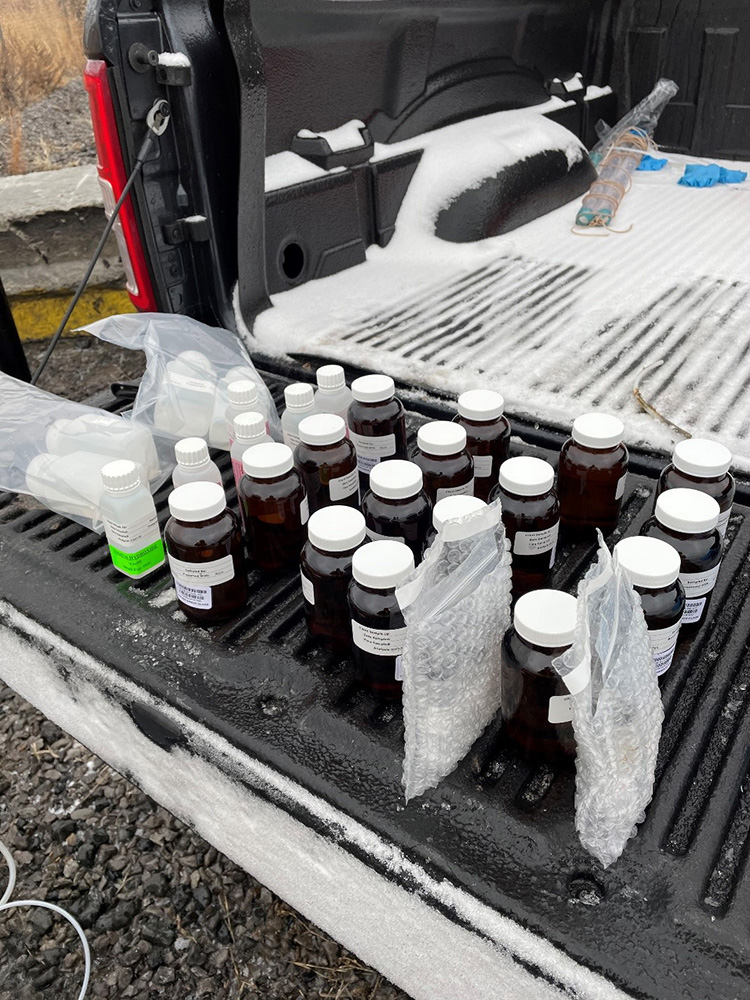

January 2021 - Sample bottles for a single well sample

January 2021 - Southwest pipe rack and Mansion - asbestos free

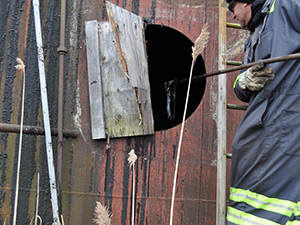

January 2021 - Asbestos-Containing Materials abatement - Mansion
January 2021 - Former hot water tank - asbestos free
January 2021 - Southwest pipe rack - asbestos free
January 2021 - Removing Asbestos-Containing Materials west of Coke Rail Yard

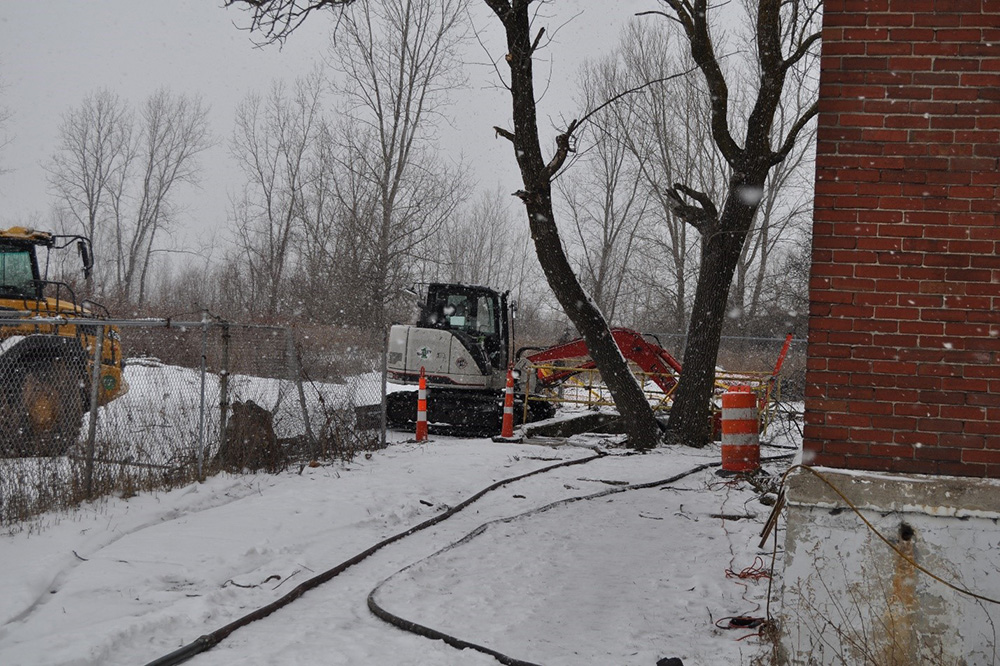

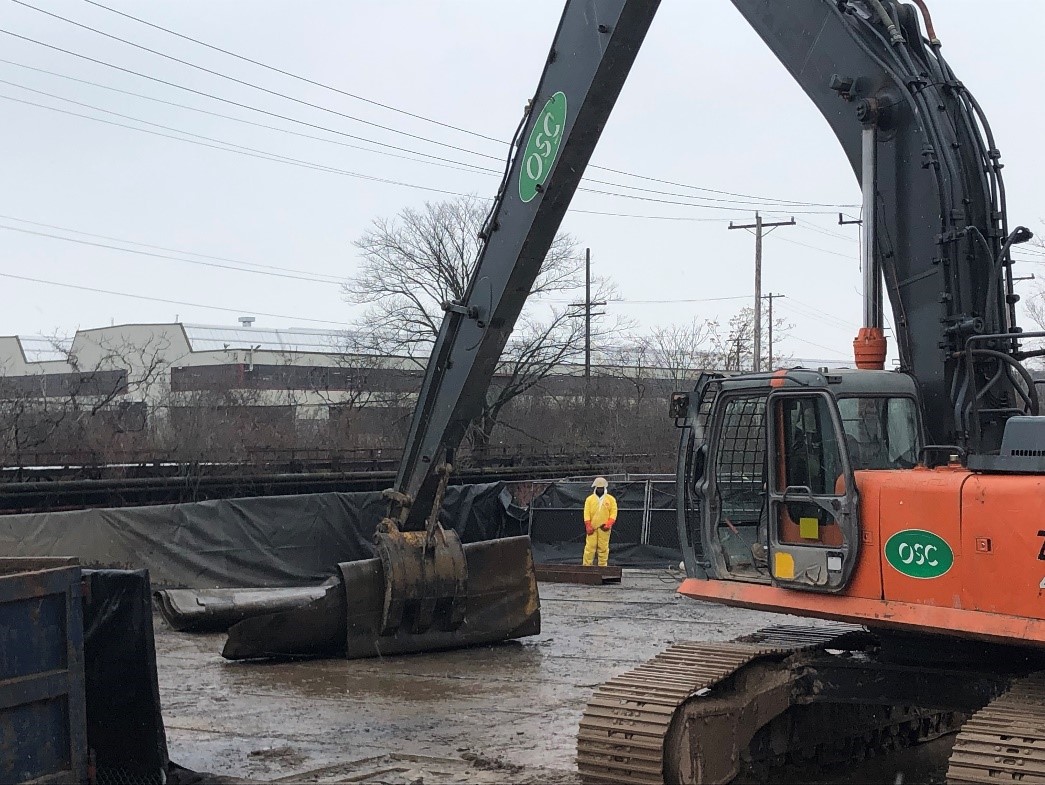

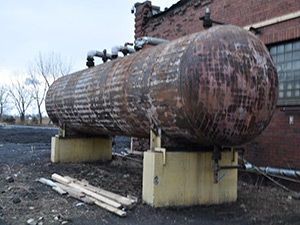

January 2021 - Checking depth of liquid

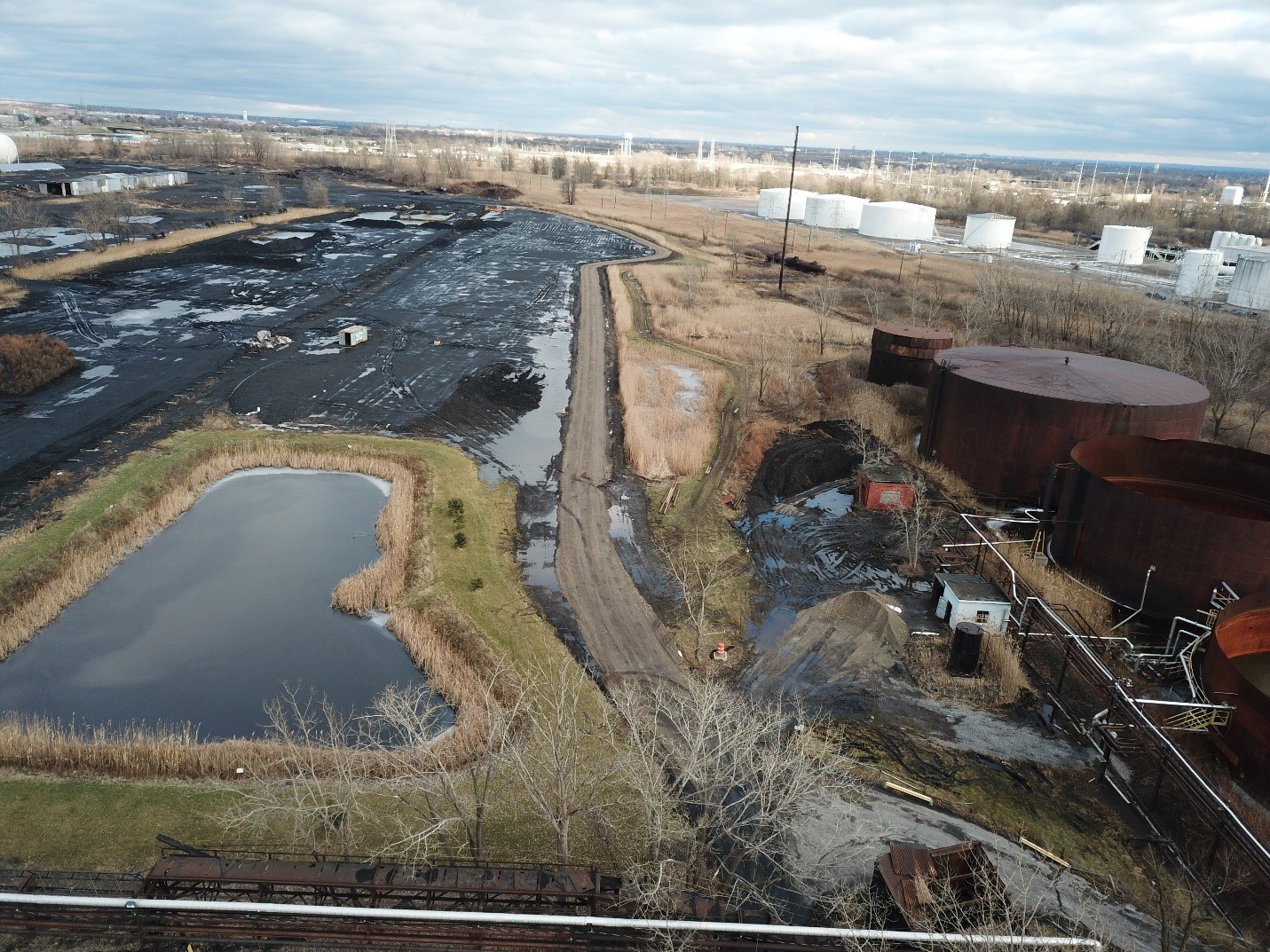

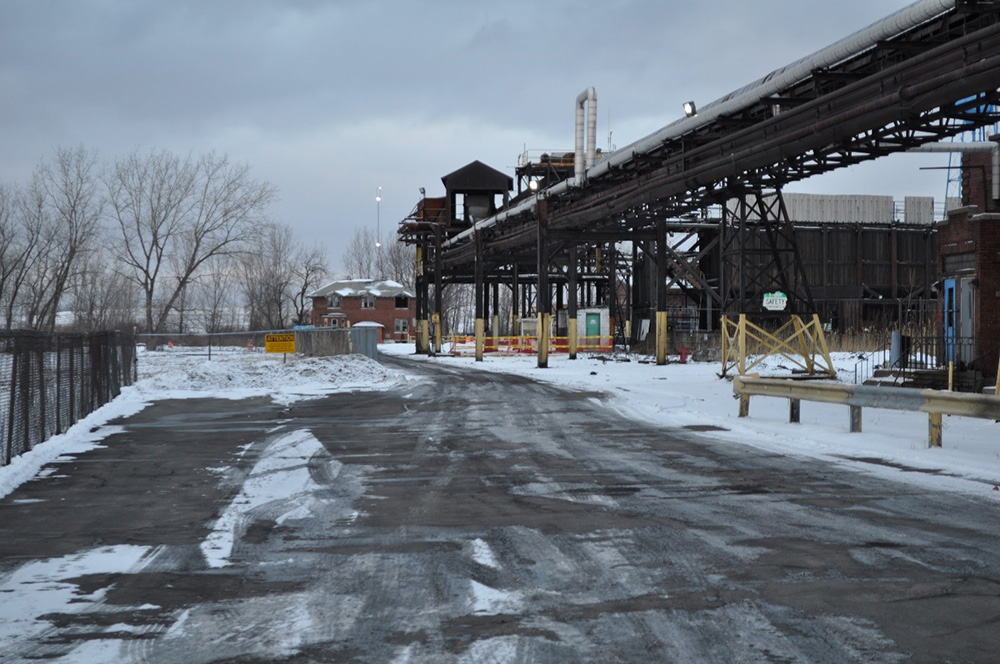

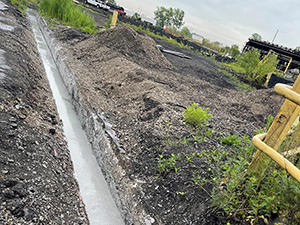

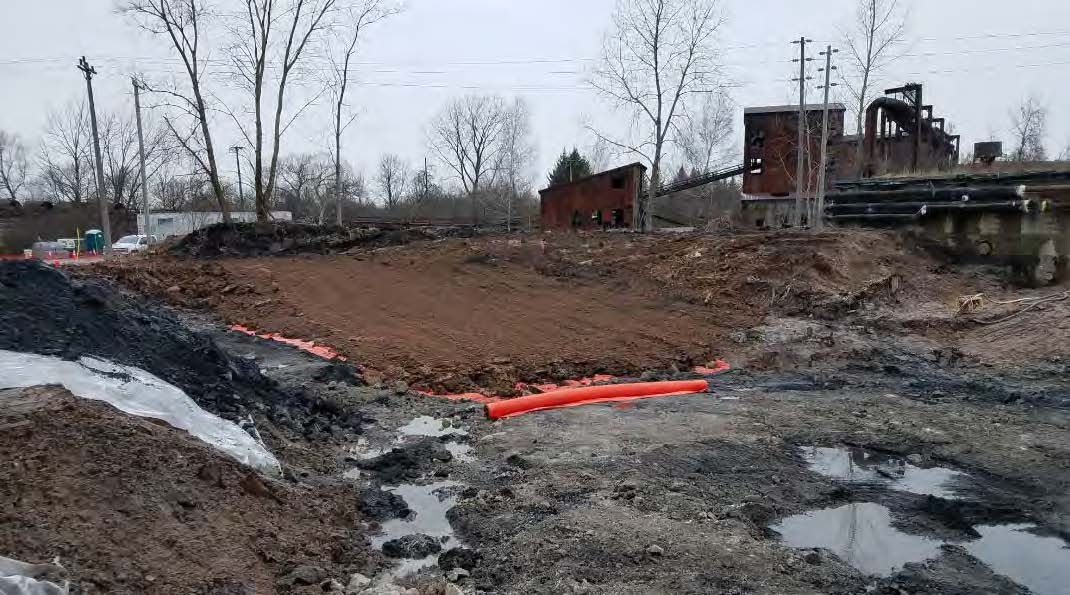

December 2020 - Reconstructed South Ditch Road and regraded South Coal Yard

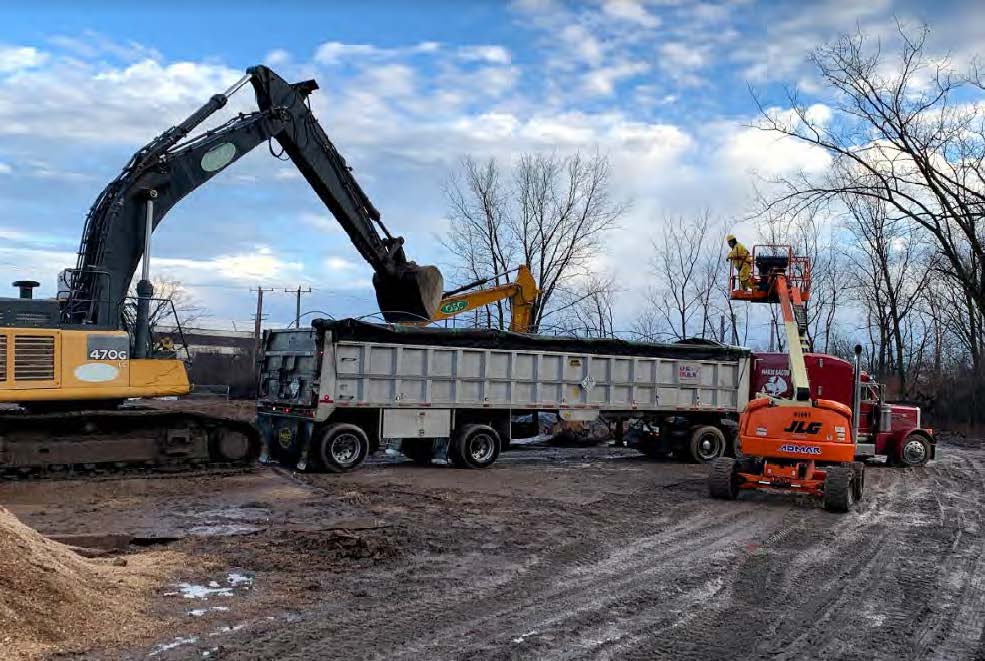

December 2020 - Staging area for Water Management Interim Remedial Measure

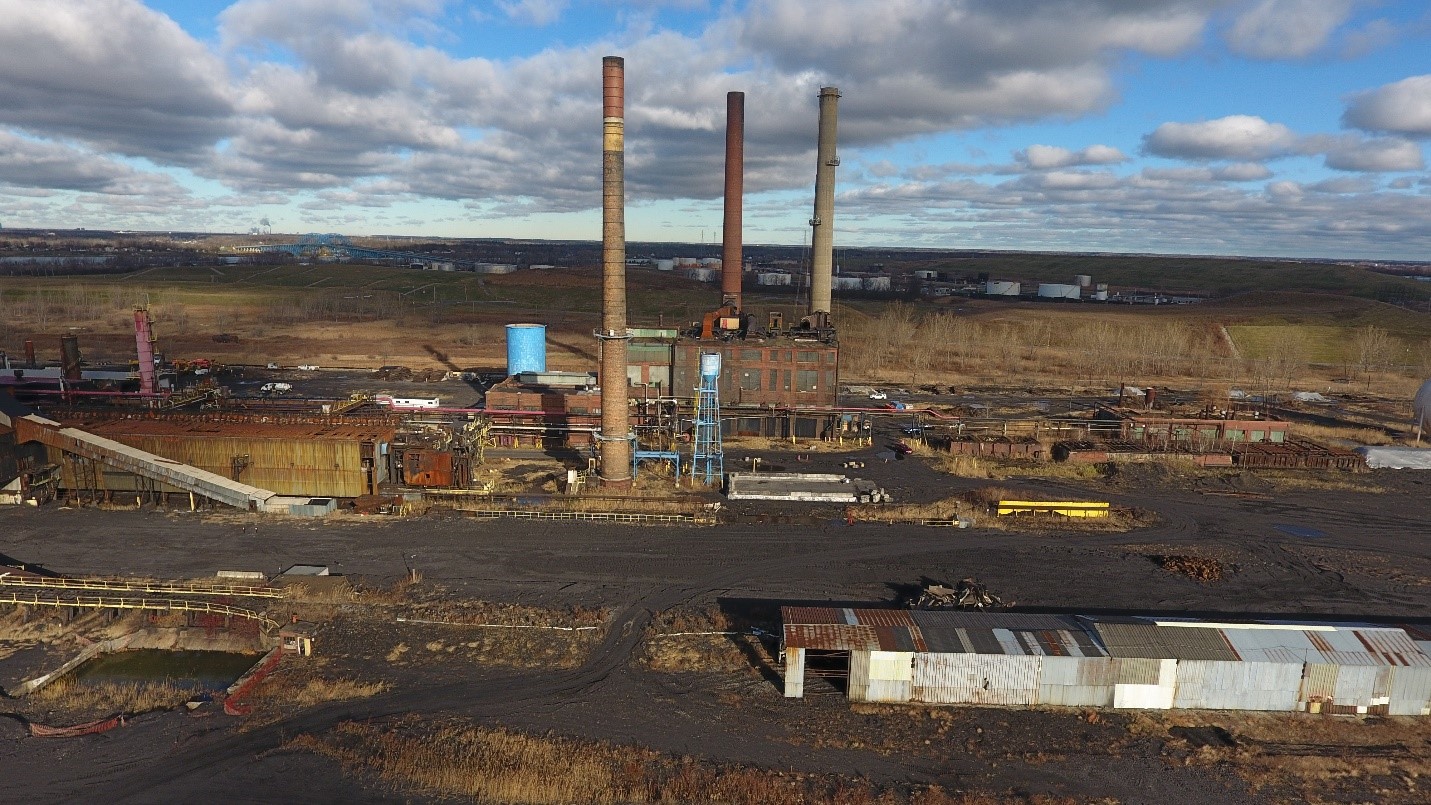

December 2020 - Stacks following asbestos abatement
December 2020 - South Ditch and reconstructed South Ditch Road
December 2020 - Asbestos abatement - overhead piping
December 2020 - Asbestos abatement - overhead pipe rack near electrical building
December 2020 - Filtered water discharge
December 2020 - Pump installation

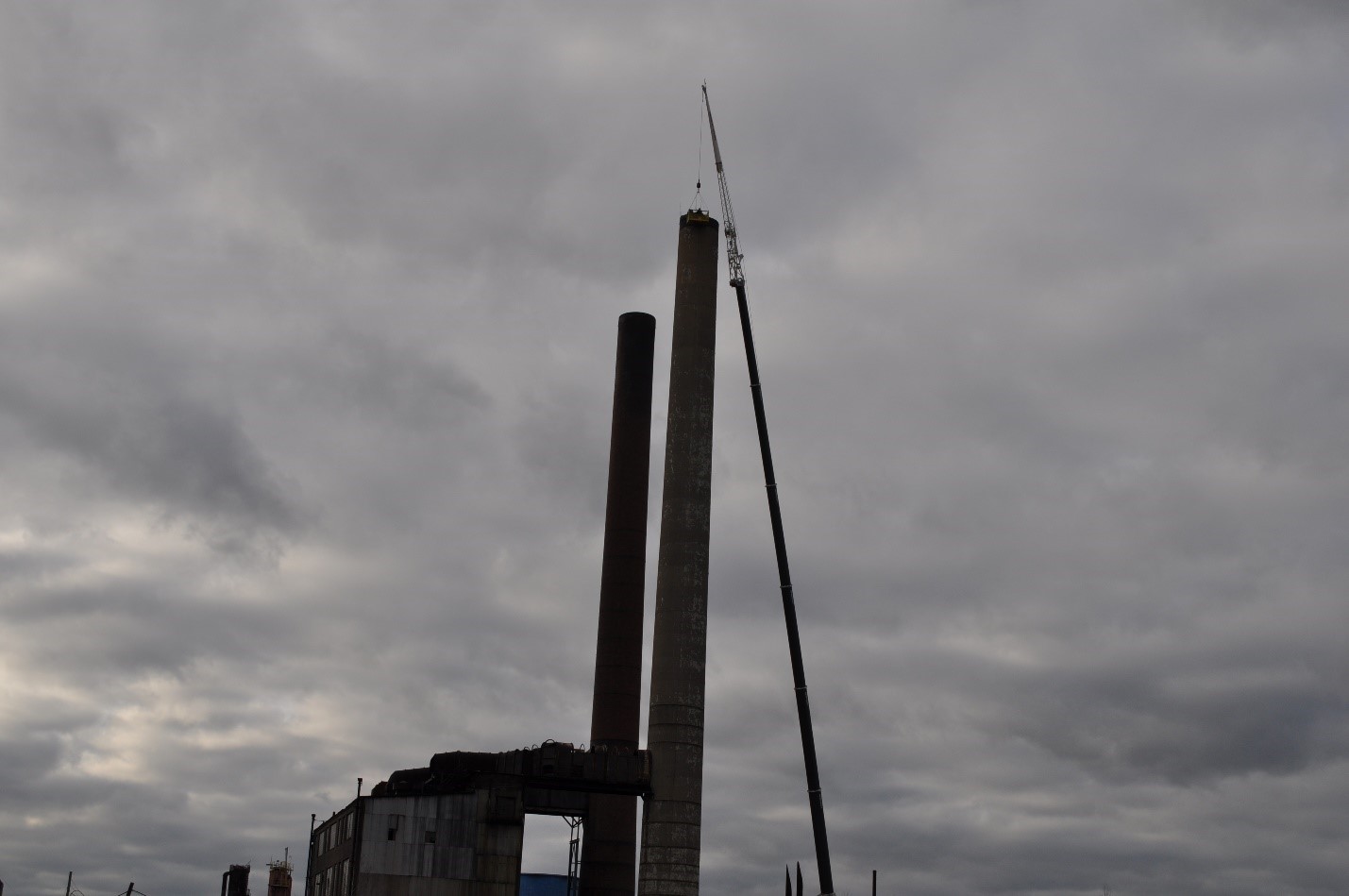

November 2020 - Asbestos abatement - concrete stack at Boiler House

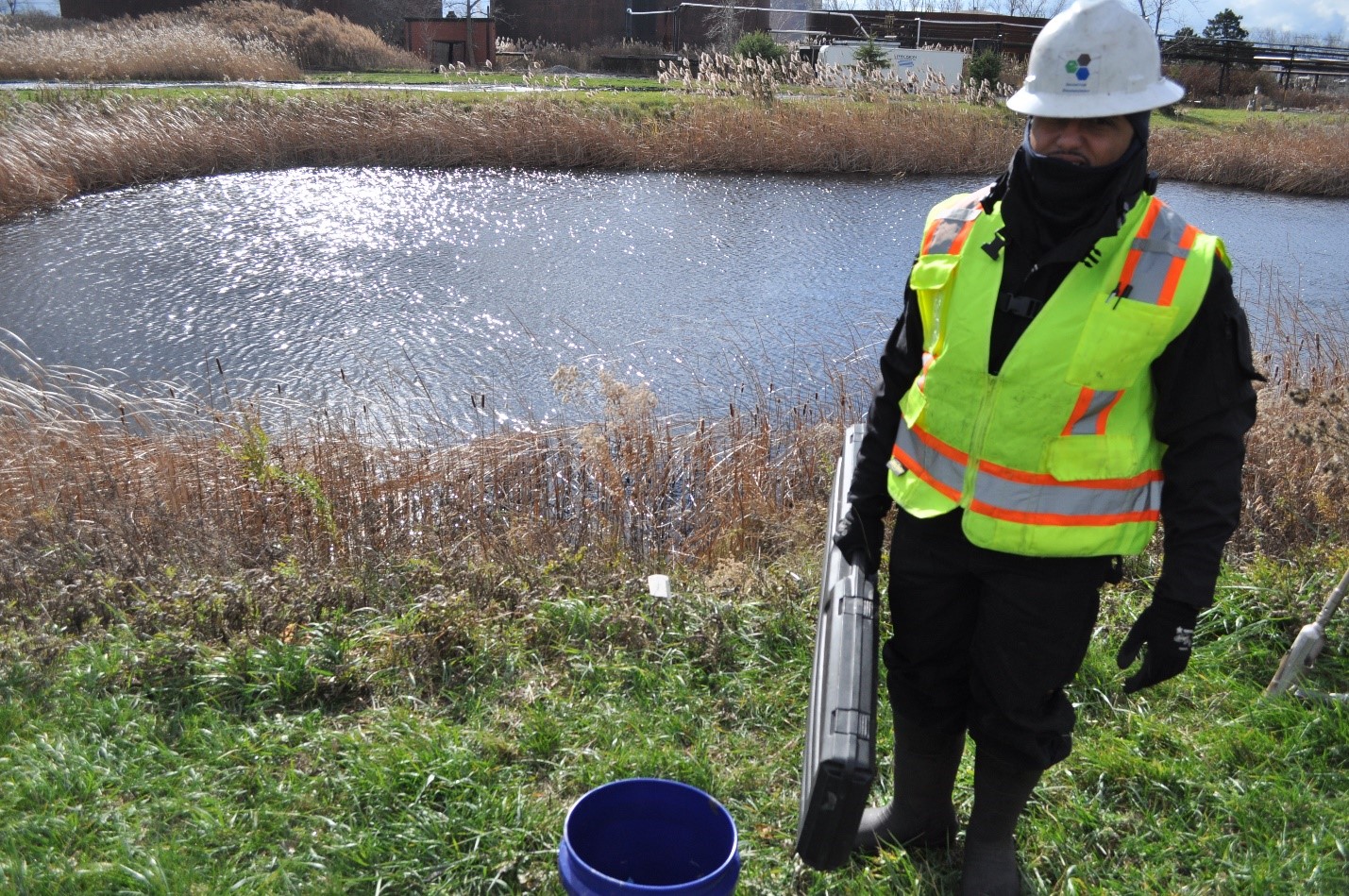

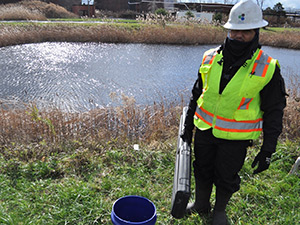

November 2020 - Sediment sampling - Stormwater Retention Basin

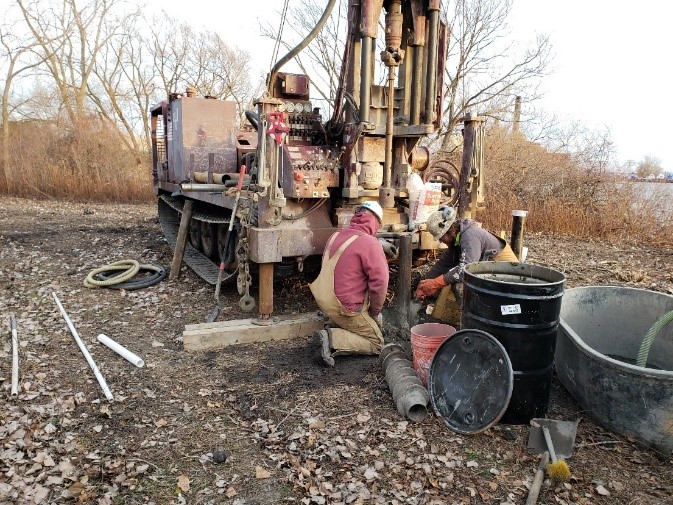

November 2020 - Drilling - west end of former Coke Rail Yard

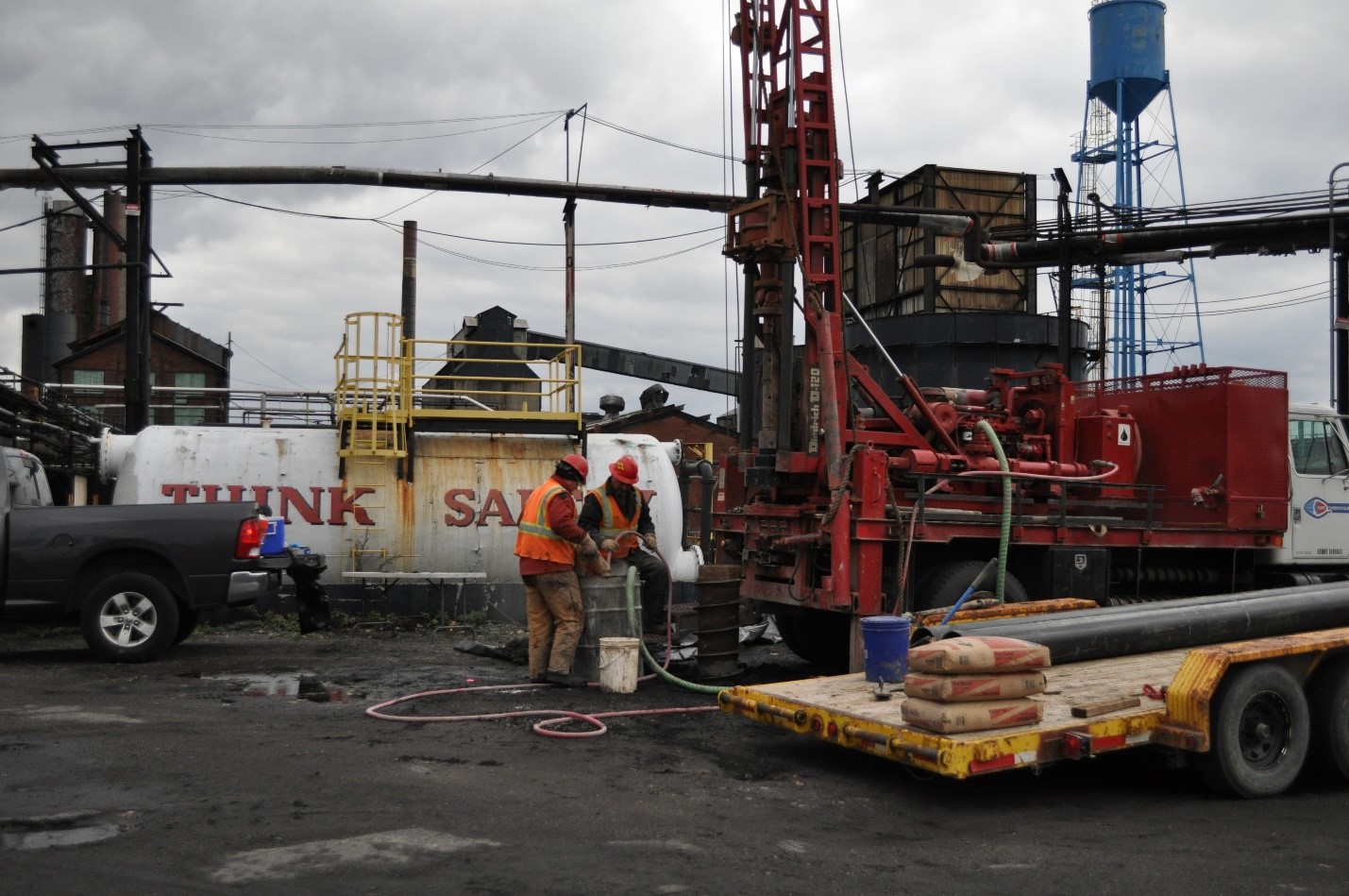

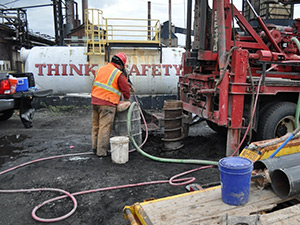

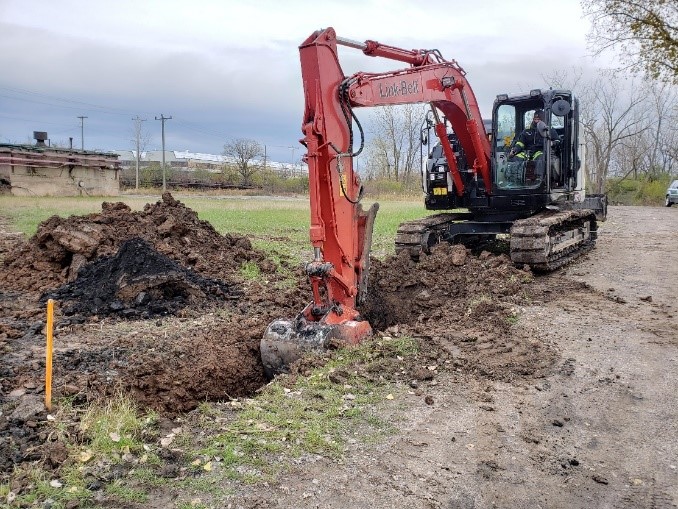

November 2020 - Drilling to set well casing - west end of production area

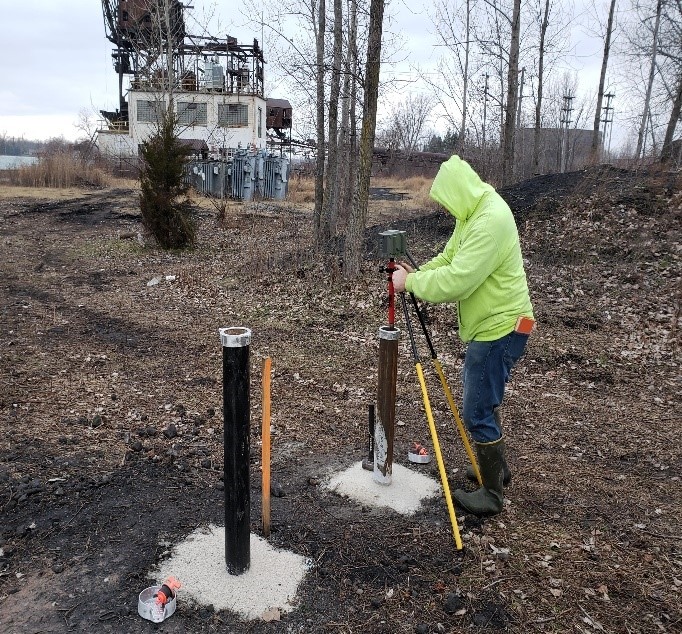

November 2020 - Drilling to set well casing - west end of production area

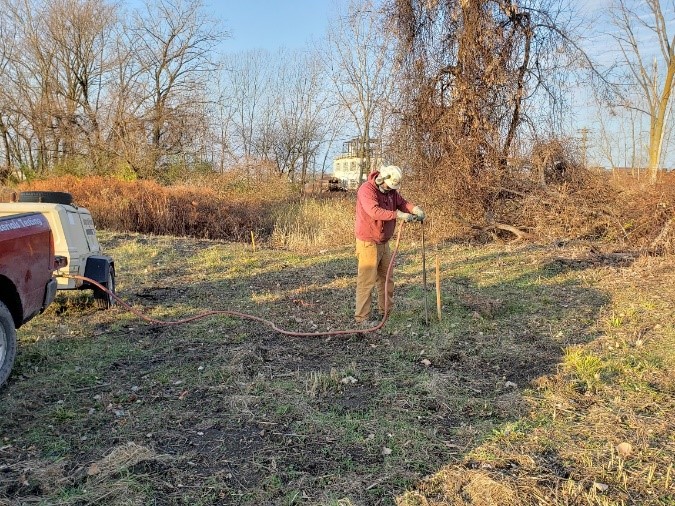

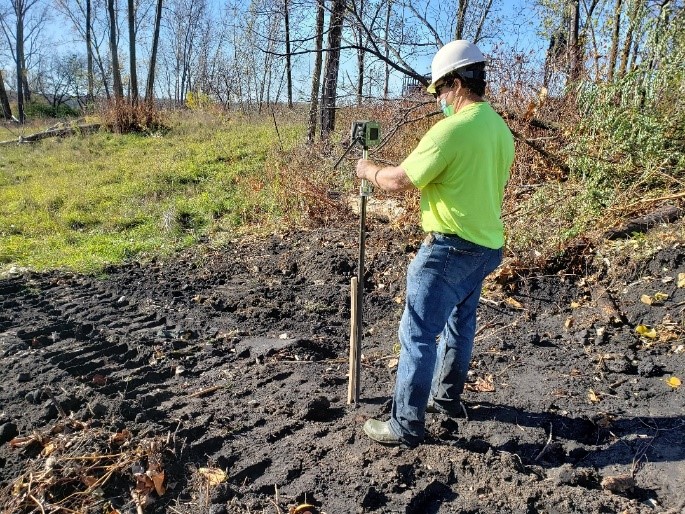

November 2020 - Setting flagging for GPS positioning

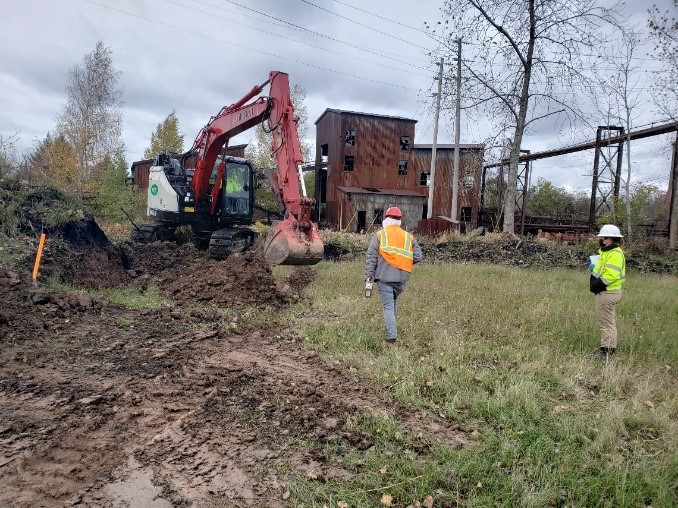

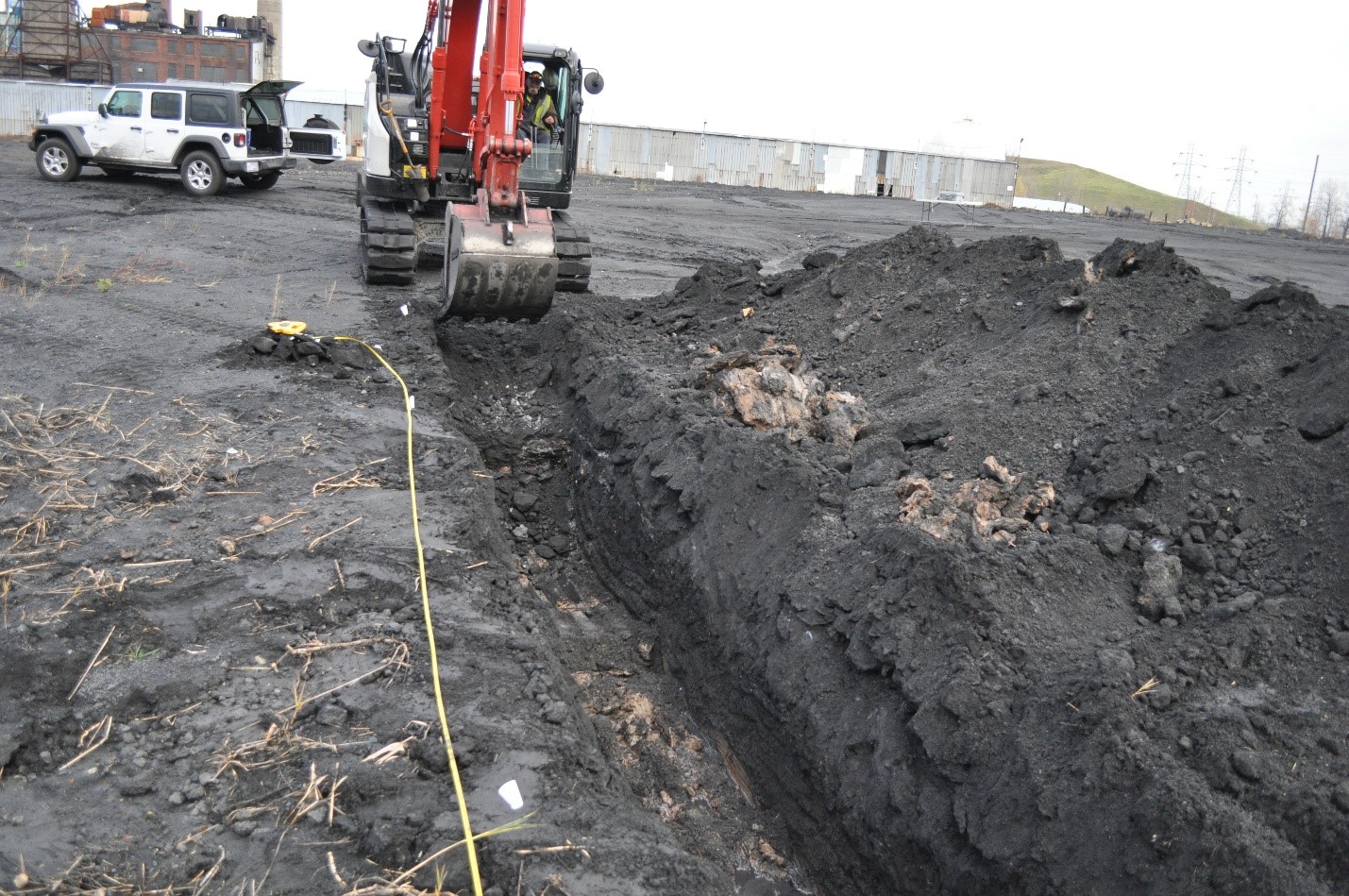

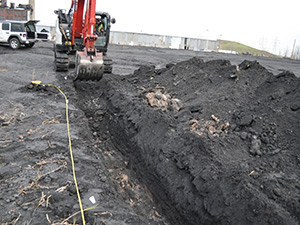

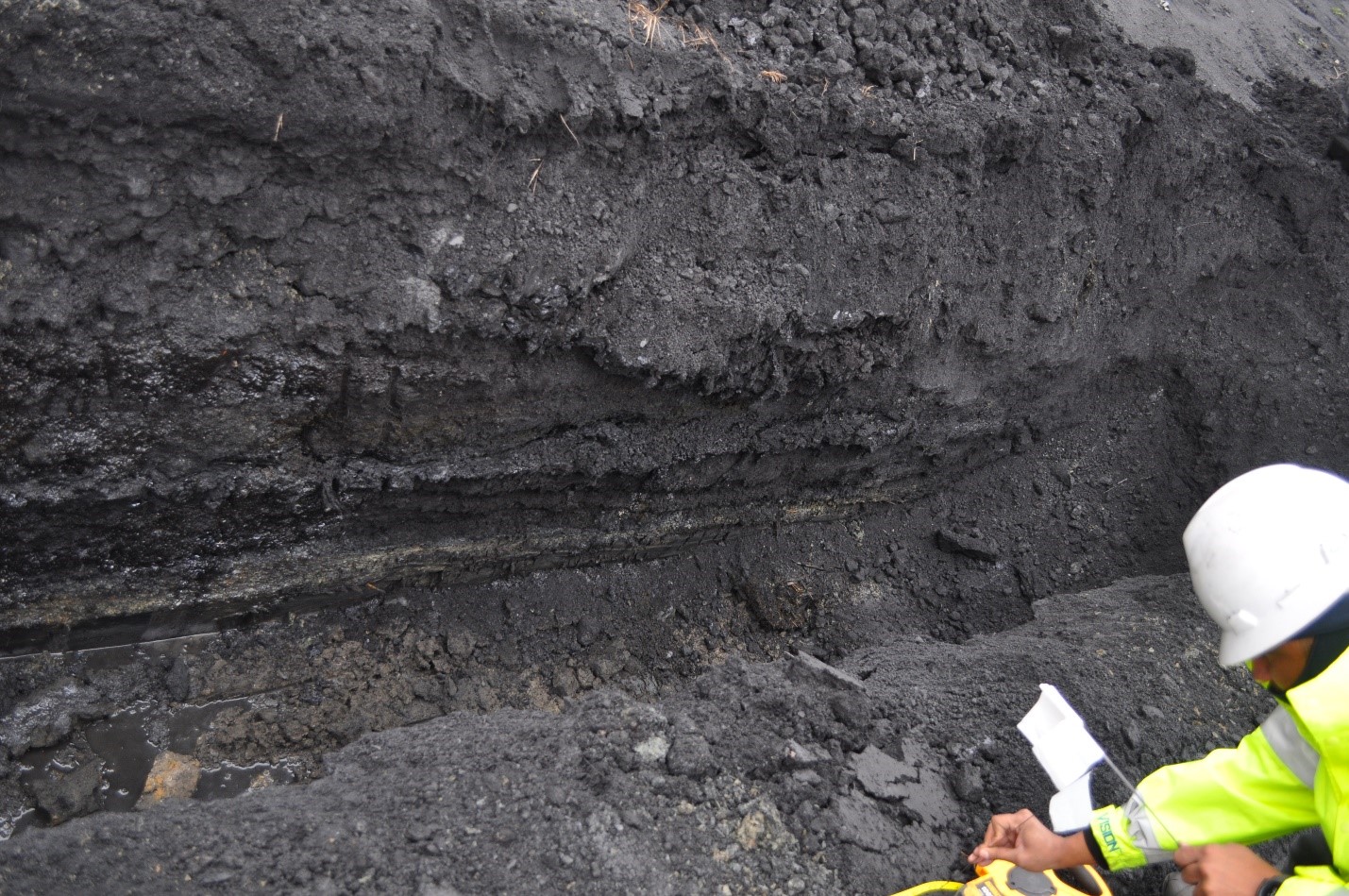

November 2020 - Test trench - east end of Coal Yard
November 2020 - Test pit excavation - east of Battery

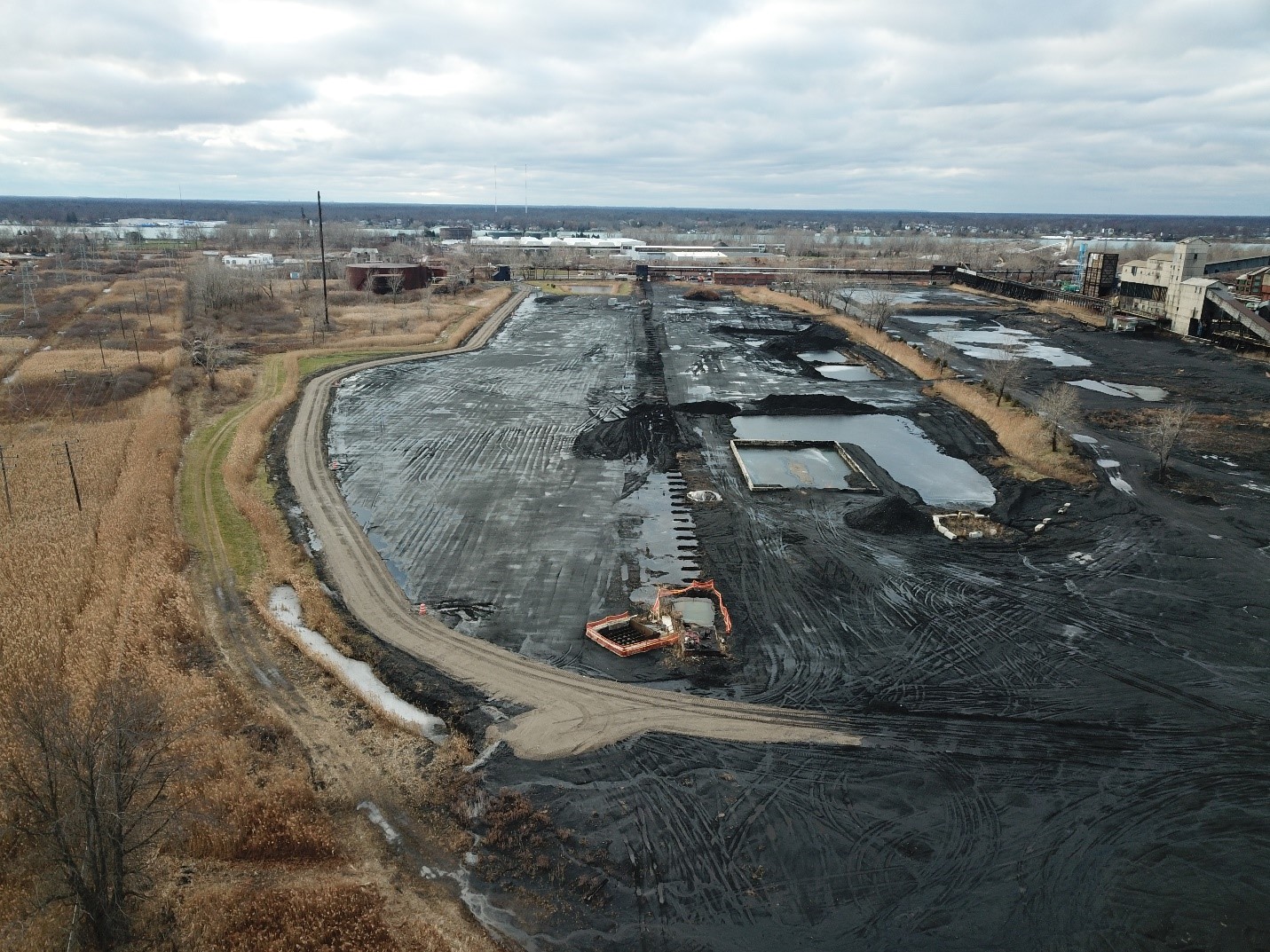

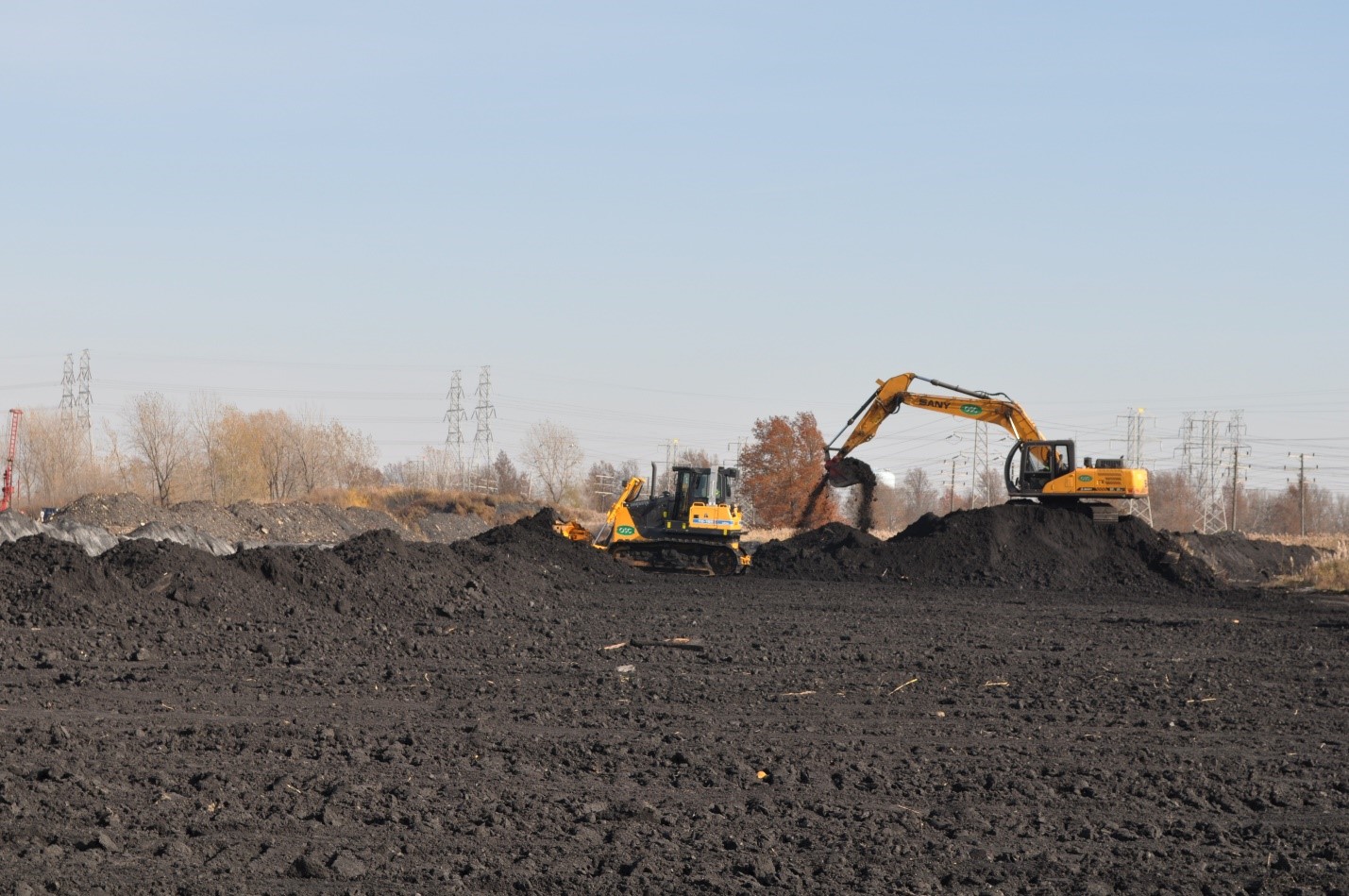

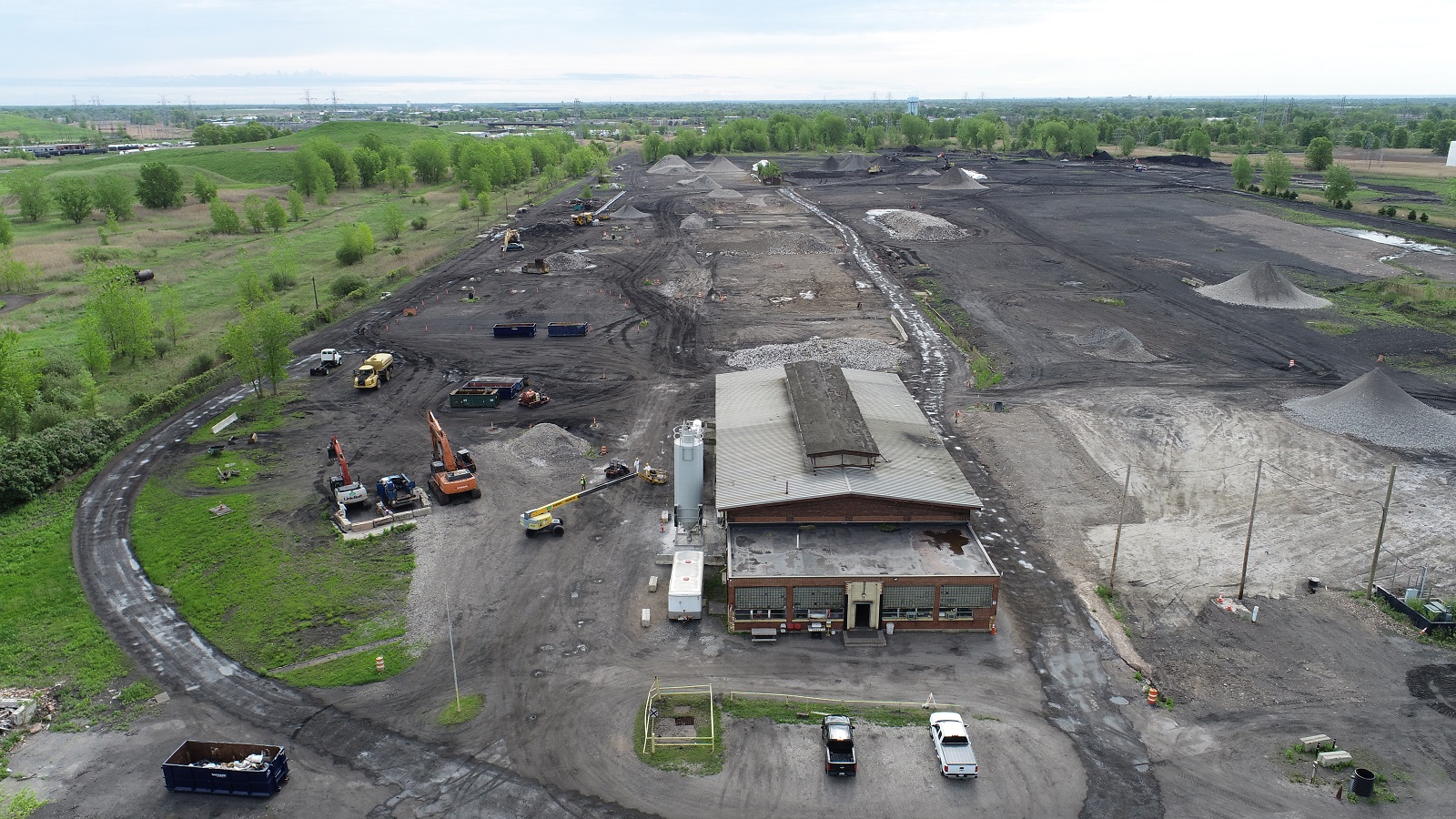

November 2020 - Regrading of South Coal Yard

November 2020 - Production area looking east

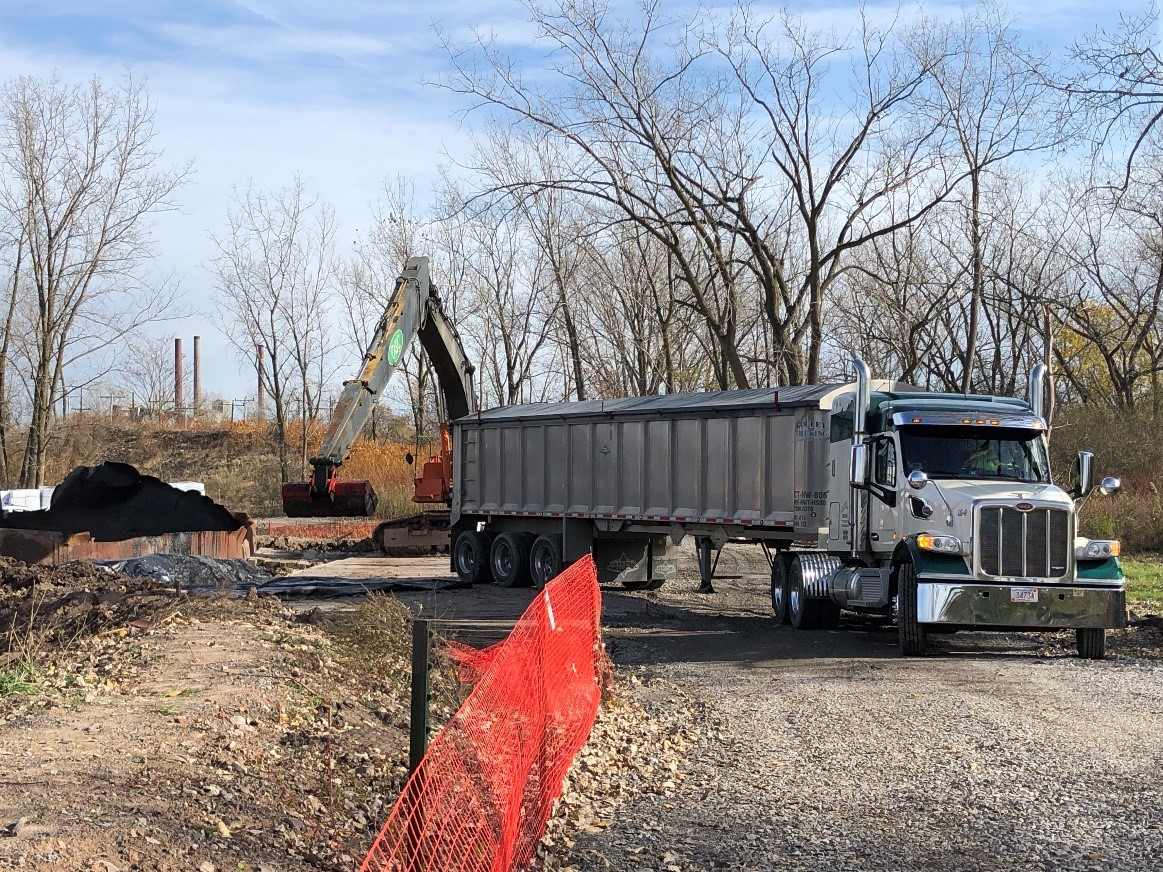

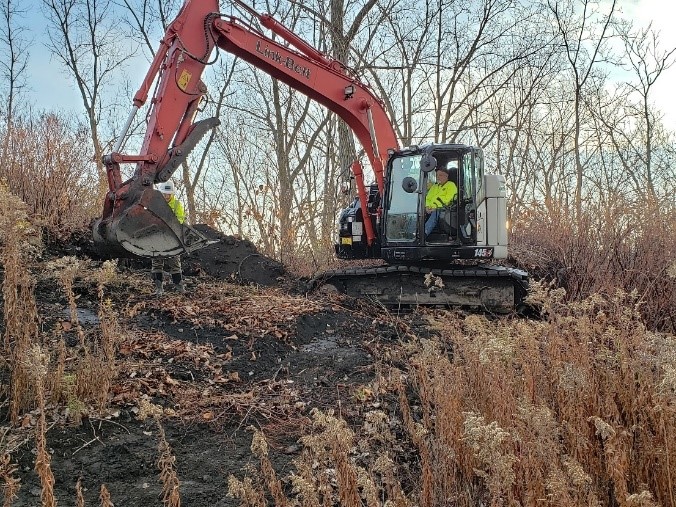

November 2020 - Removal of the coal conveyor and stacker-reclaimer

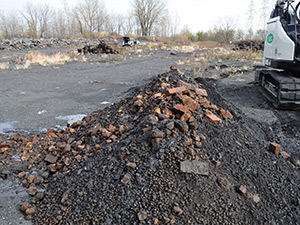

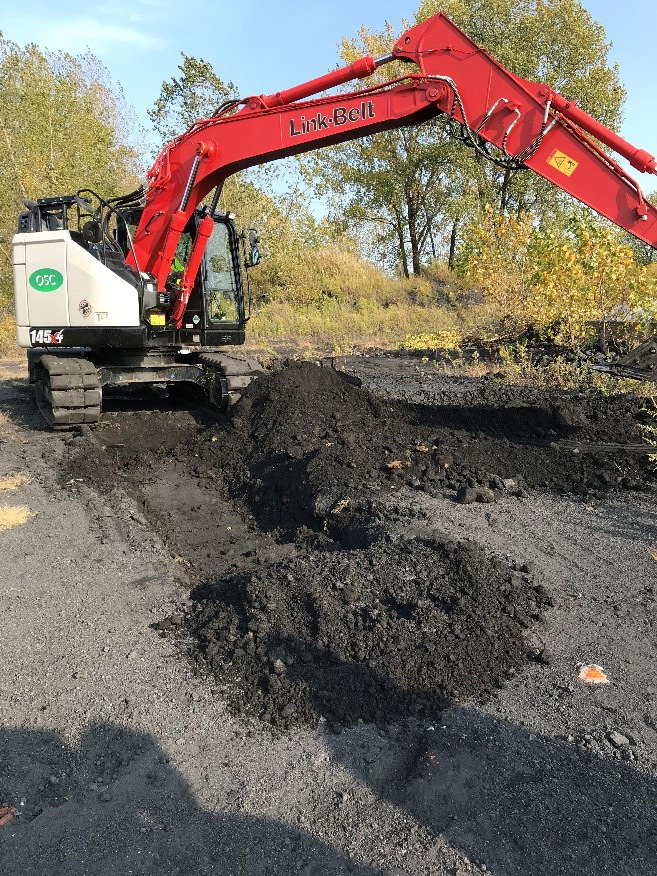

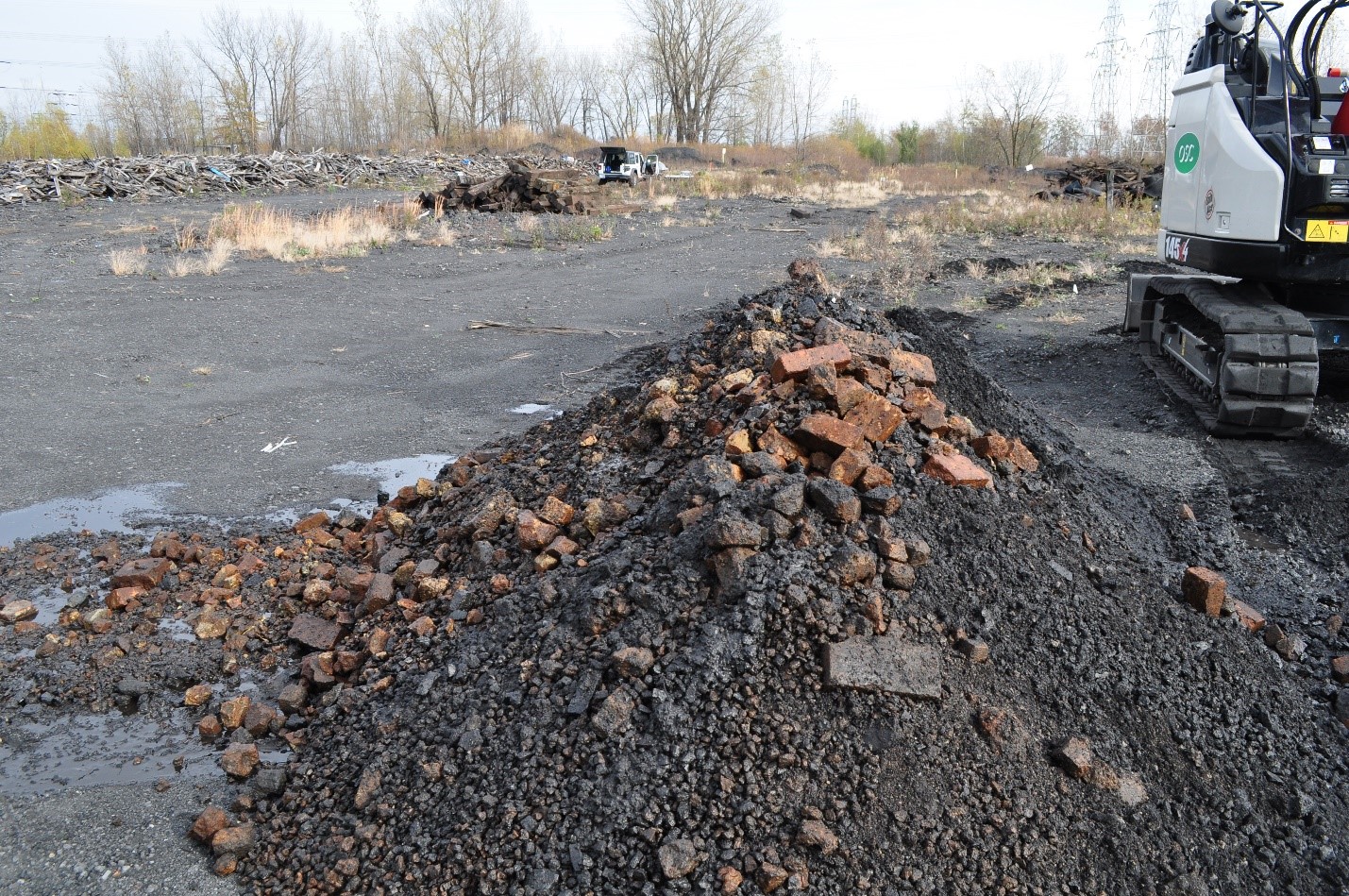

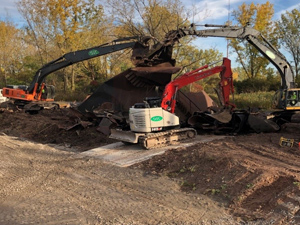

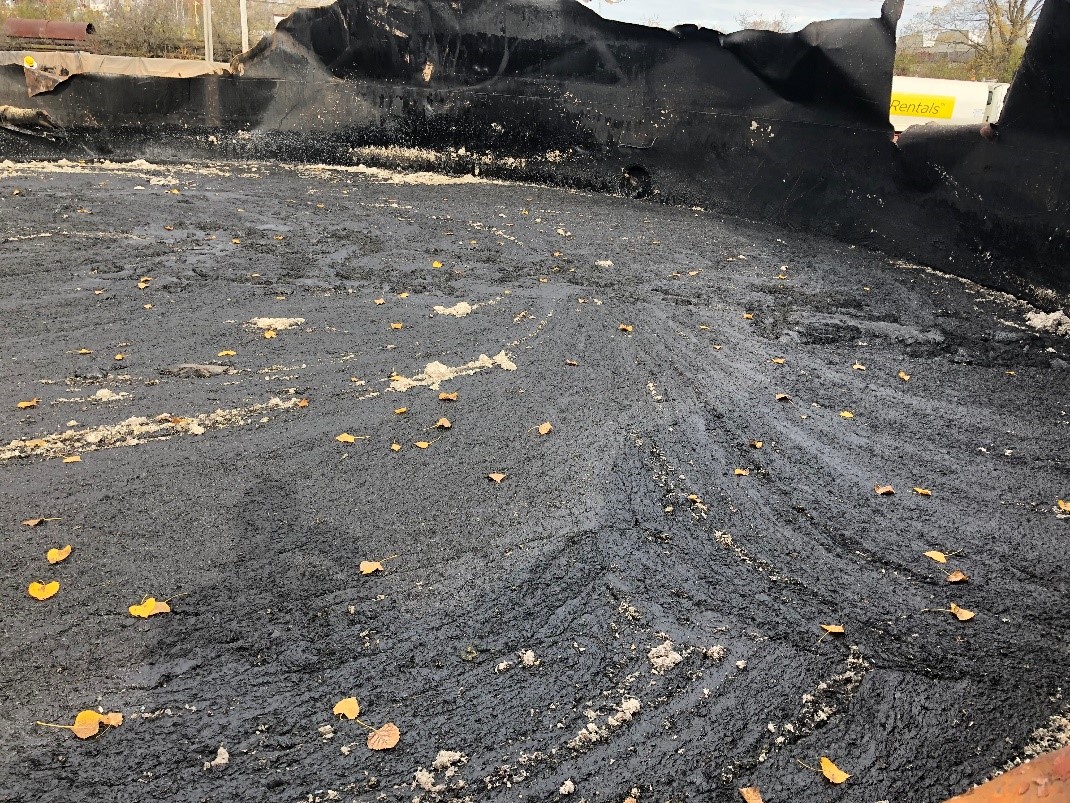

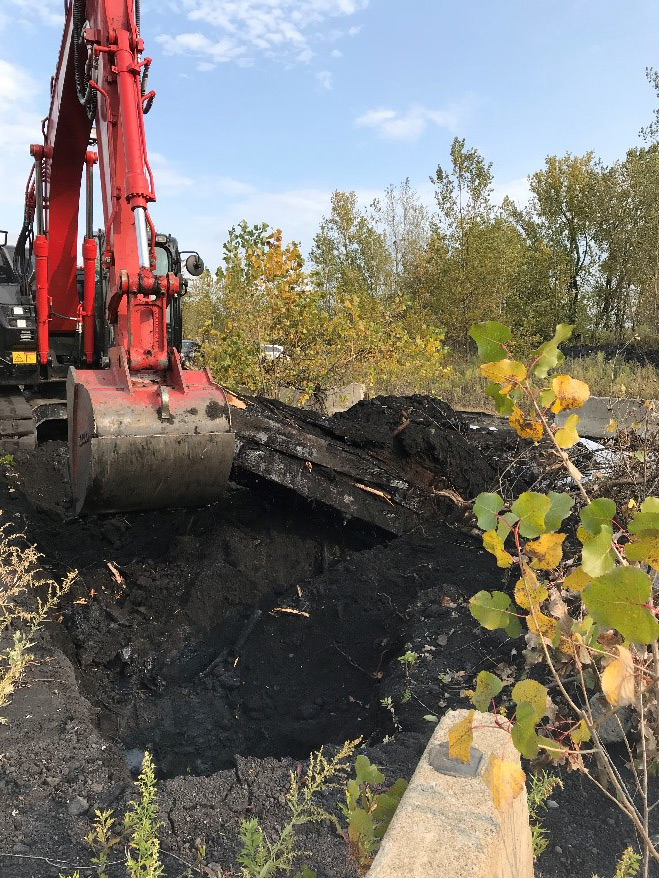

October 2020 - Typical fill

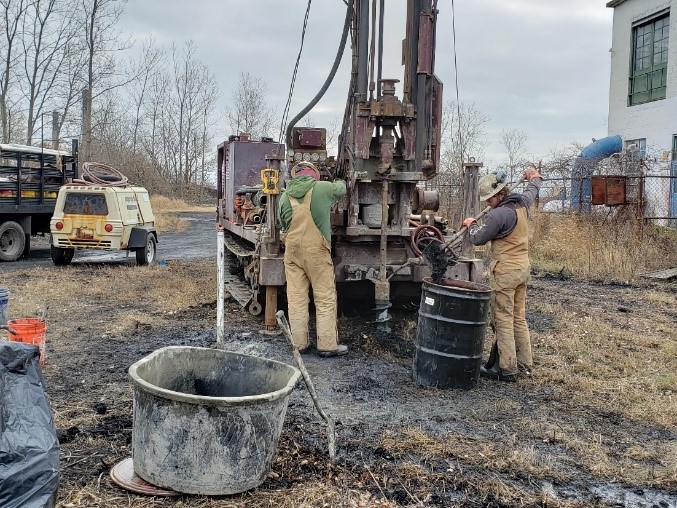

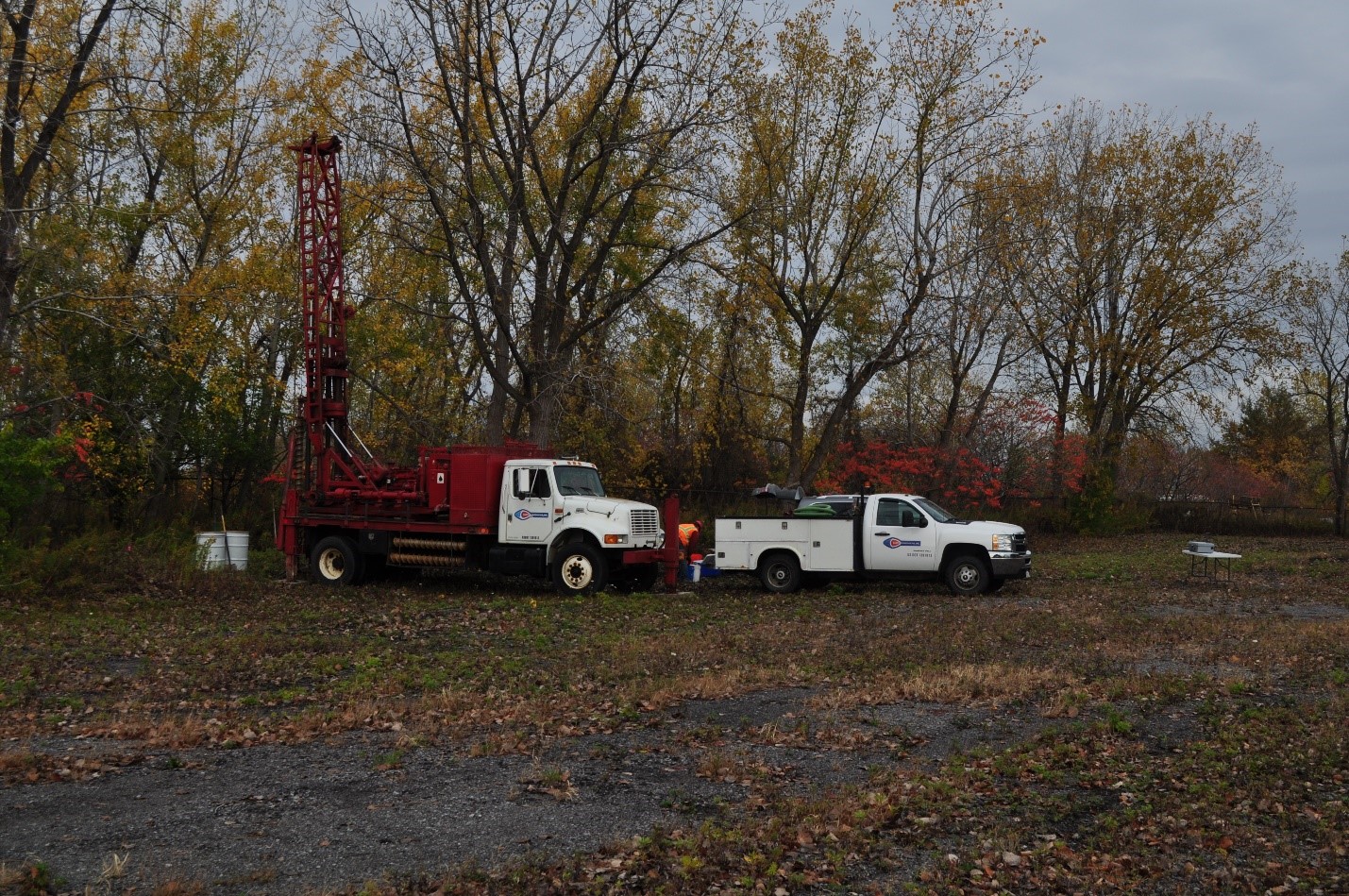

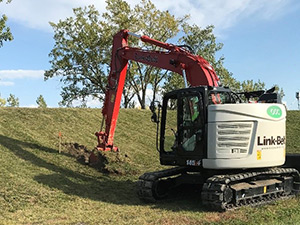

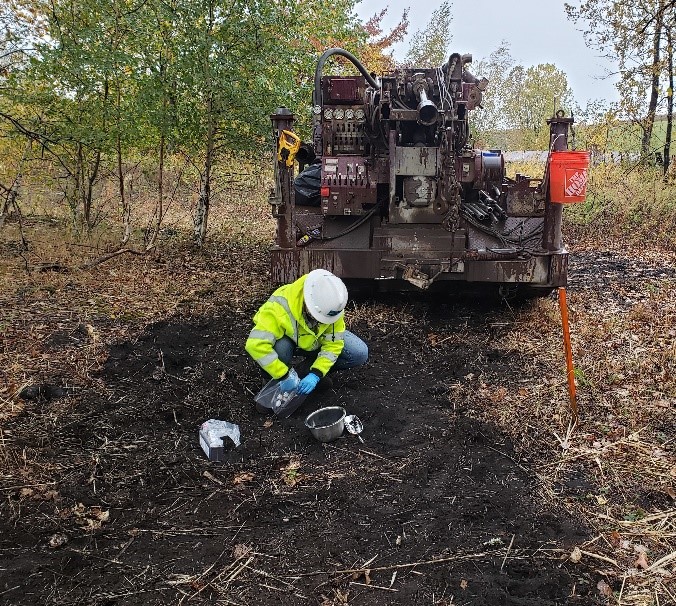

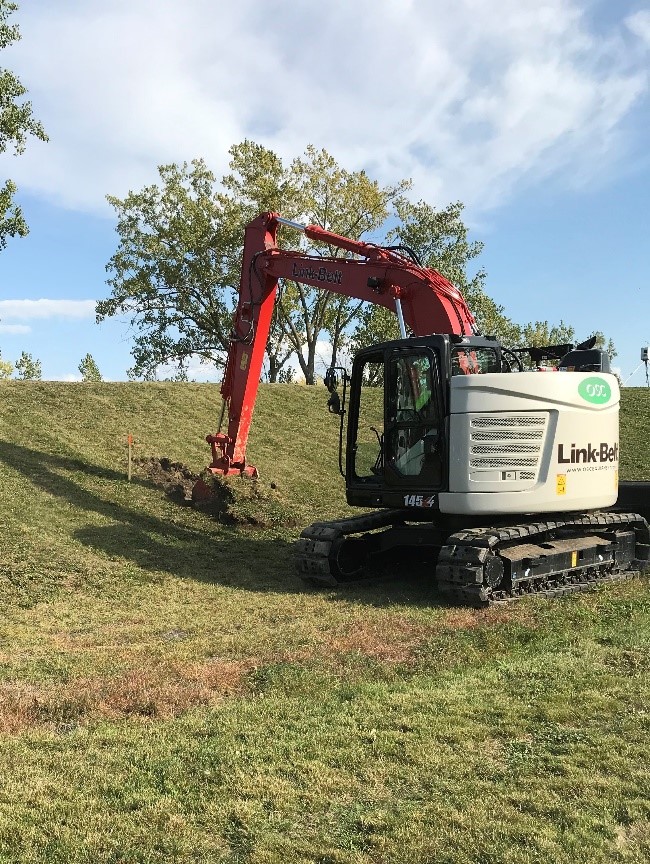

October 2020 - Initiation of drilling along west property line

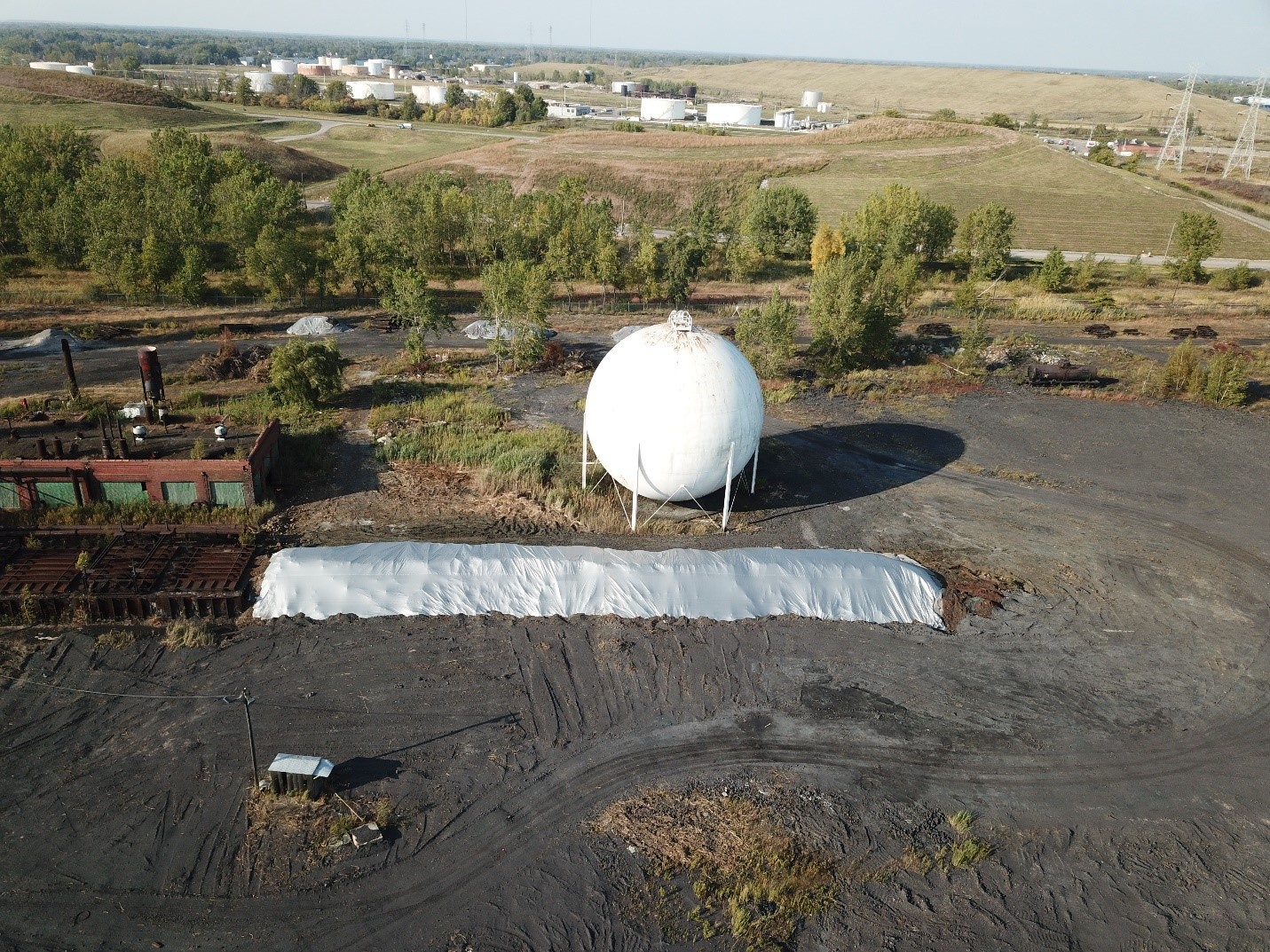

October 2020 - Iron oxide pile protected from weather
October 2020 - Test trench - north property line abandoned water line IRM

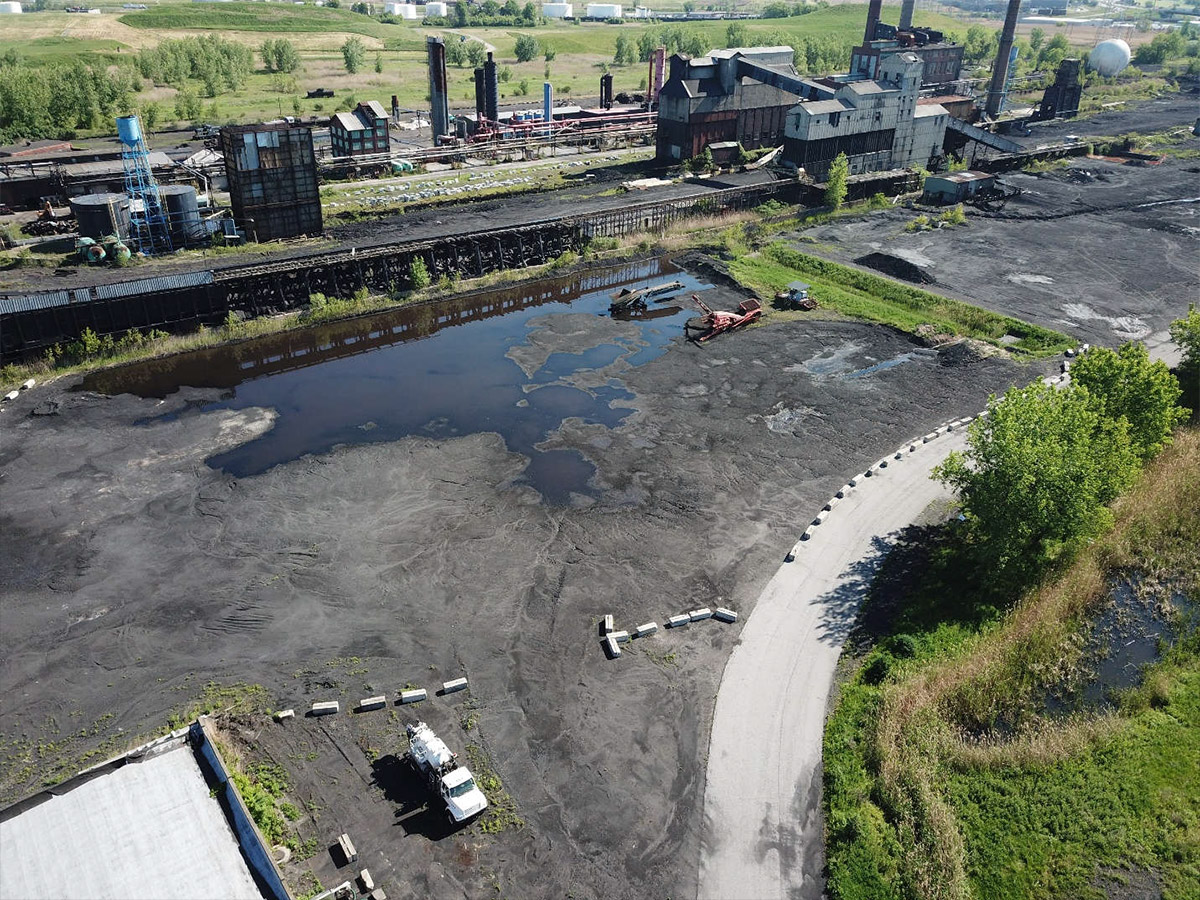

October 2020 - Aeration of sedimentation ponds
October 2020 - Dewatering mixing pad in preparation for closure

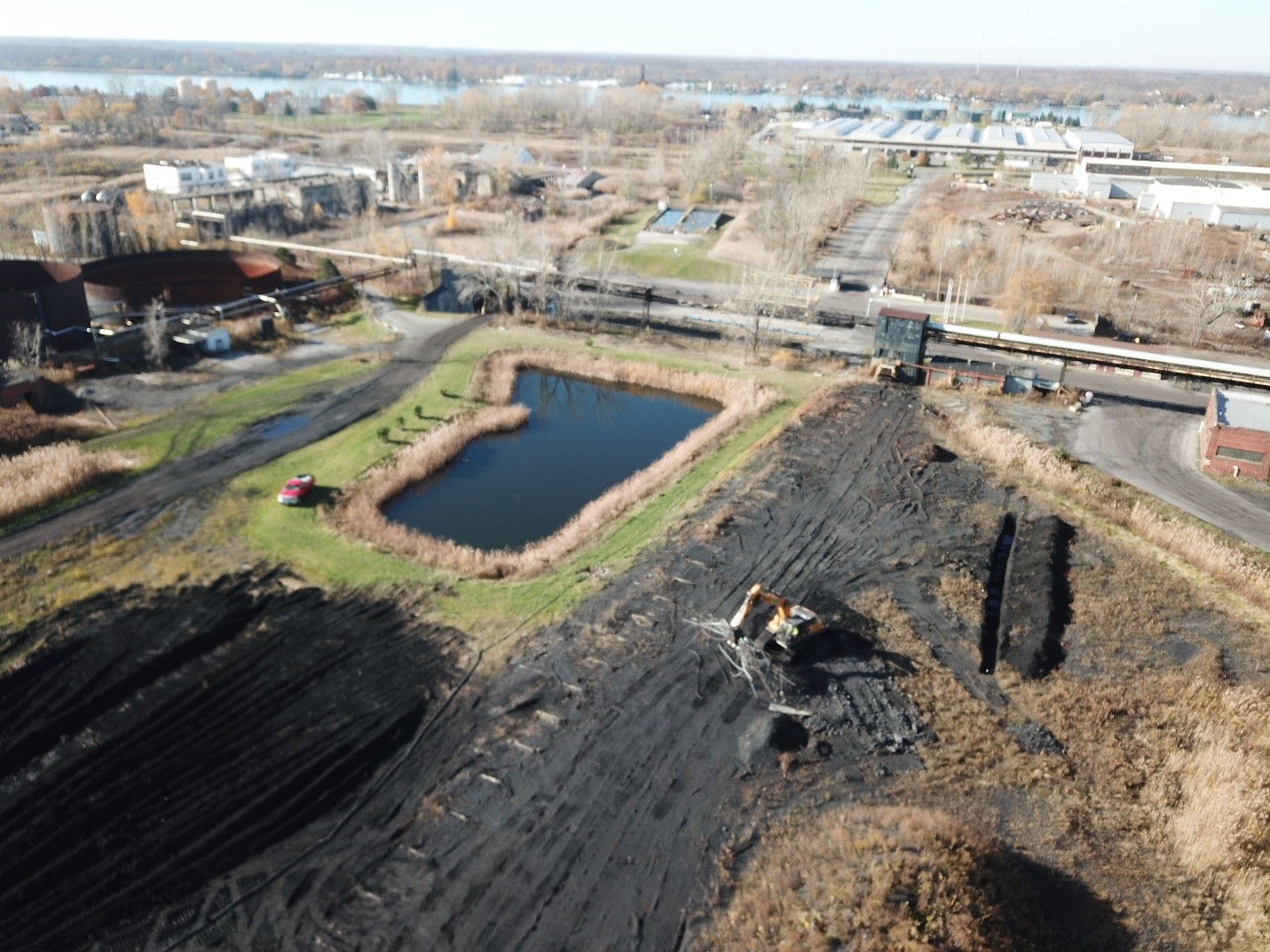

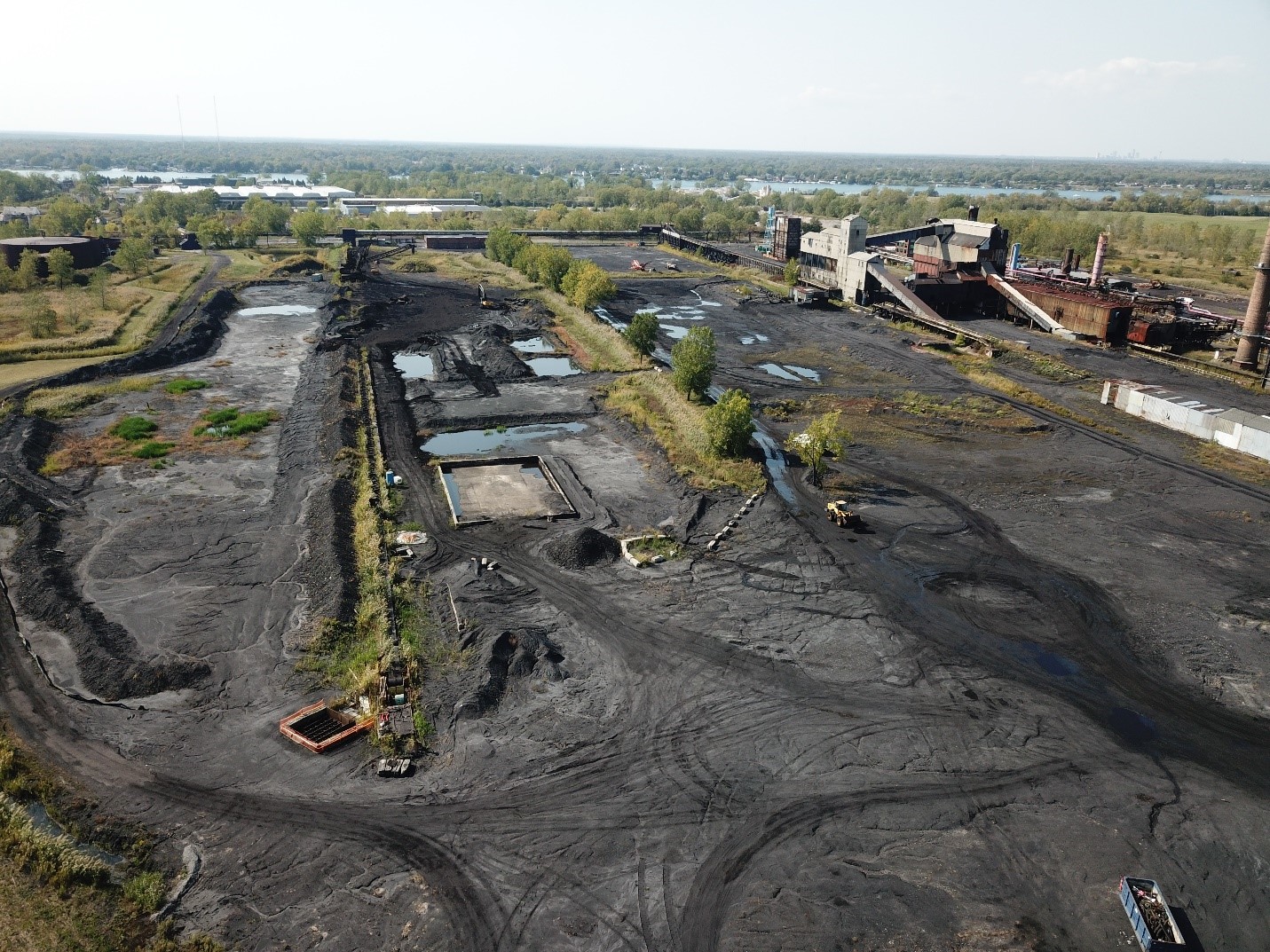

October 2020 - South Coal Yard dewatered in preparation for regrading
Site 108

Site Preparation and Clearing

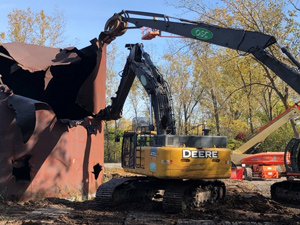

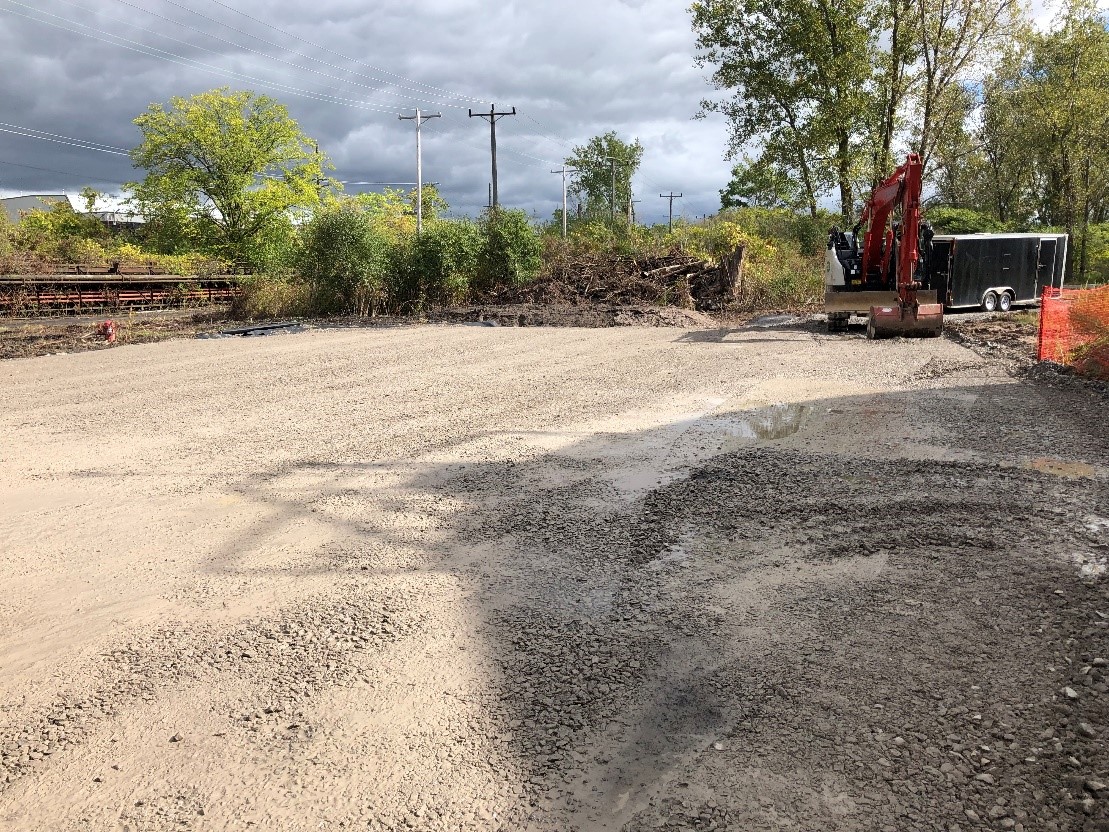

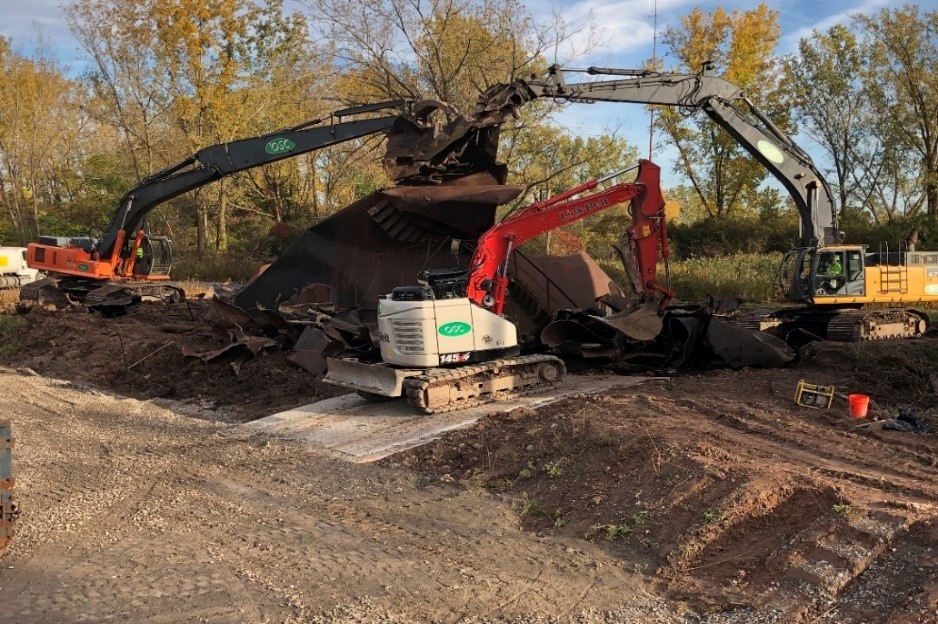

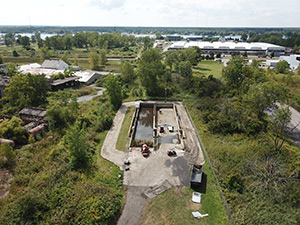

October 2019 - Site 108 - view looking northeast. Reconstruction of tank access ramp in preparation for loading of stabilized tar onto transport trucks.
October 2019 - Site 108 - view looking north. Completed expansion of the decontamination area; final compaction and grading ongoing.

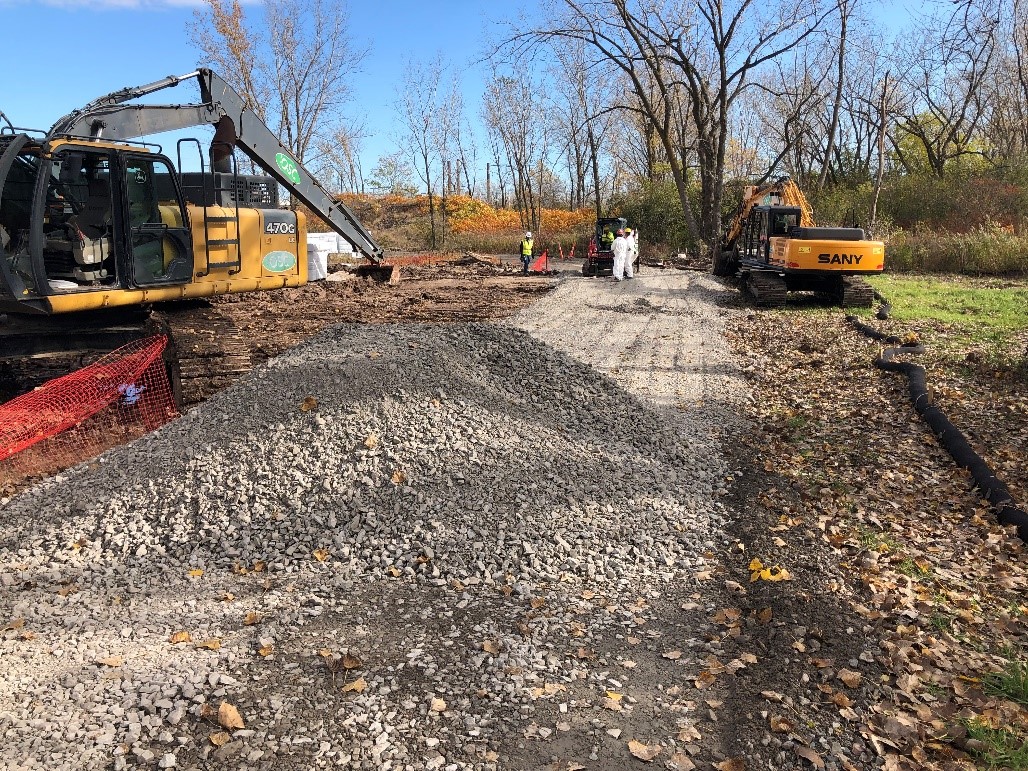

October 2019 - View looking north. Access road to the soil piles completed to the first soil pile (soil 1 on the right side of the photo). Staff preparing to remove the cover to allow waste characterization sample collection.

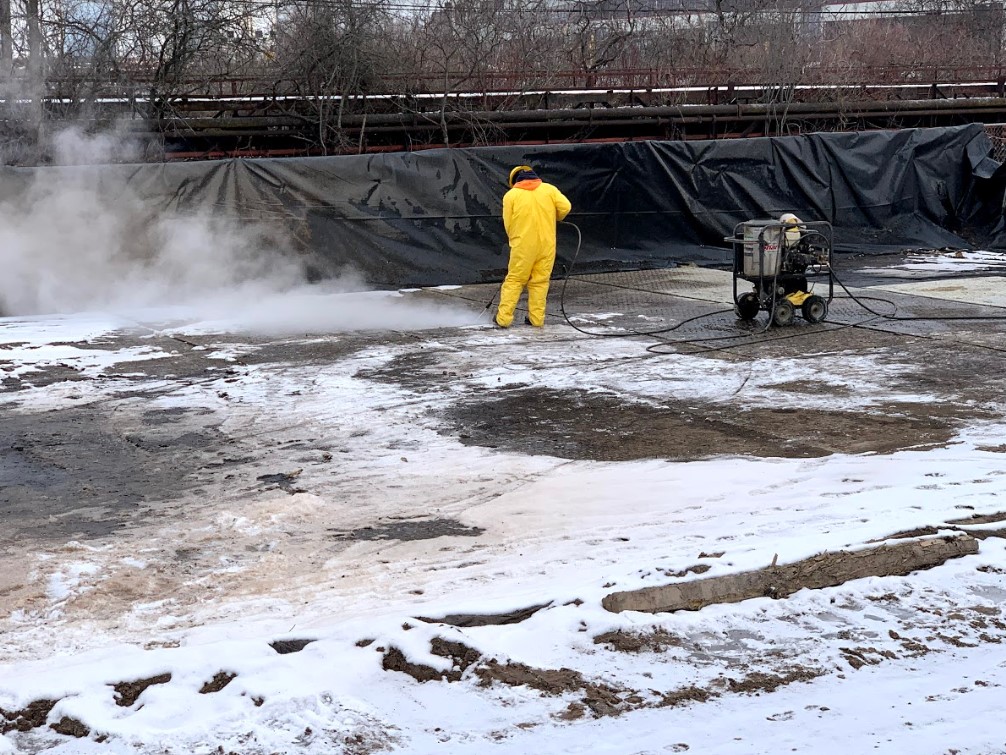

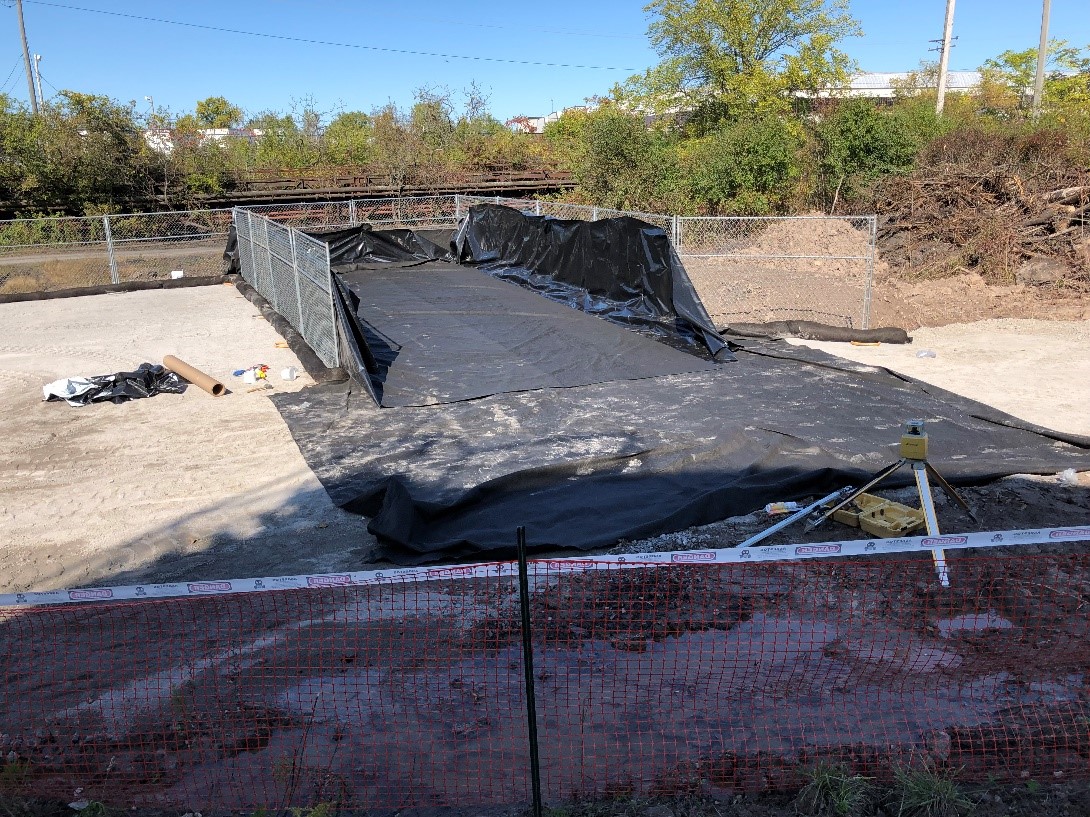

September 2019 - View looking northeast. Decon Pad area construction. Excavator used to install new access roadway from the access ramp to the decon area.
September 2019 - View looking west. Aggregate placed over geogrid and geotextile fabric to construct the access road connection to the ramp and adjacent to the tanks. Wet area to the right of the access road caused by early morning rain event.
September 2019 - View looking southwest. Geogrid material combined with geotextile fabric shown in the photo for decon pad area. Aggregate placed on top in a 4-6-inch lift, graded and compacted.
September 2019 - View looking west. Support zone construction, geotextile fabric and aggregate installation.

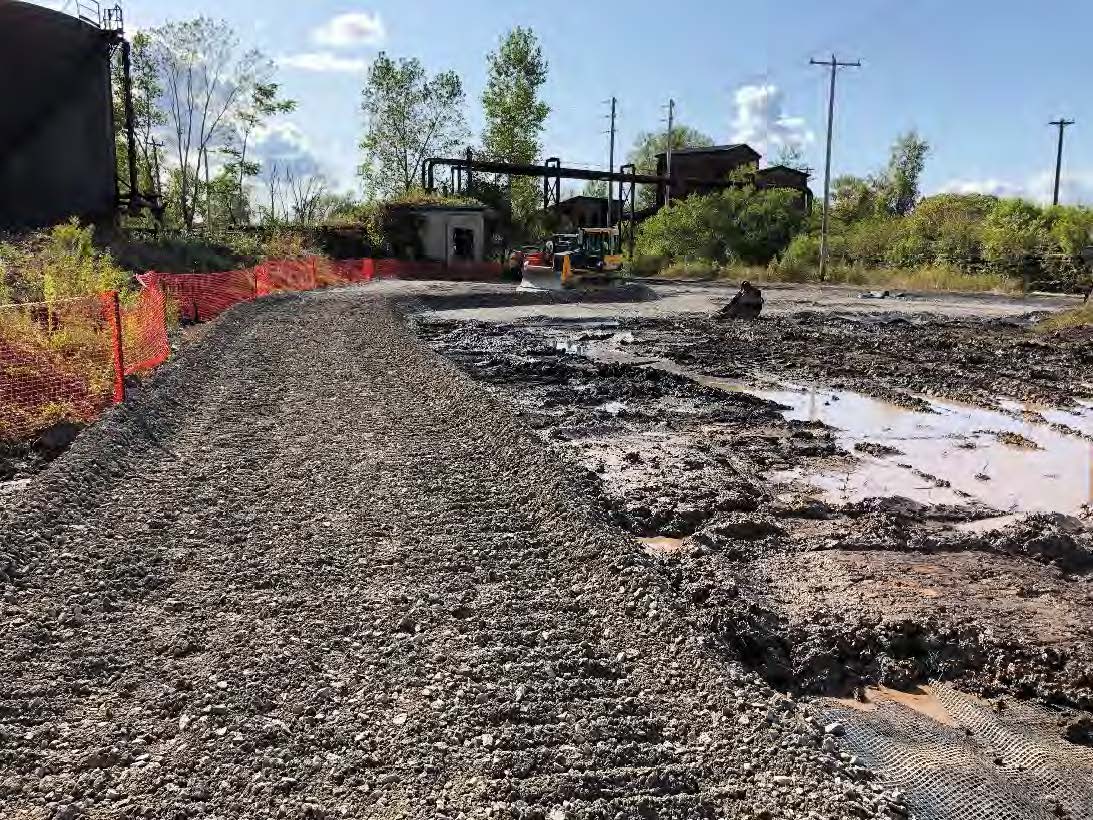

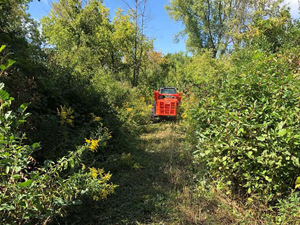

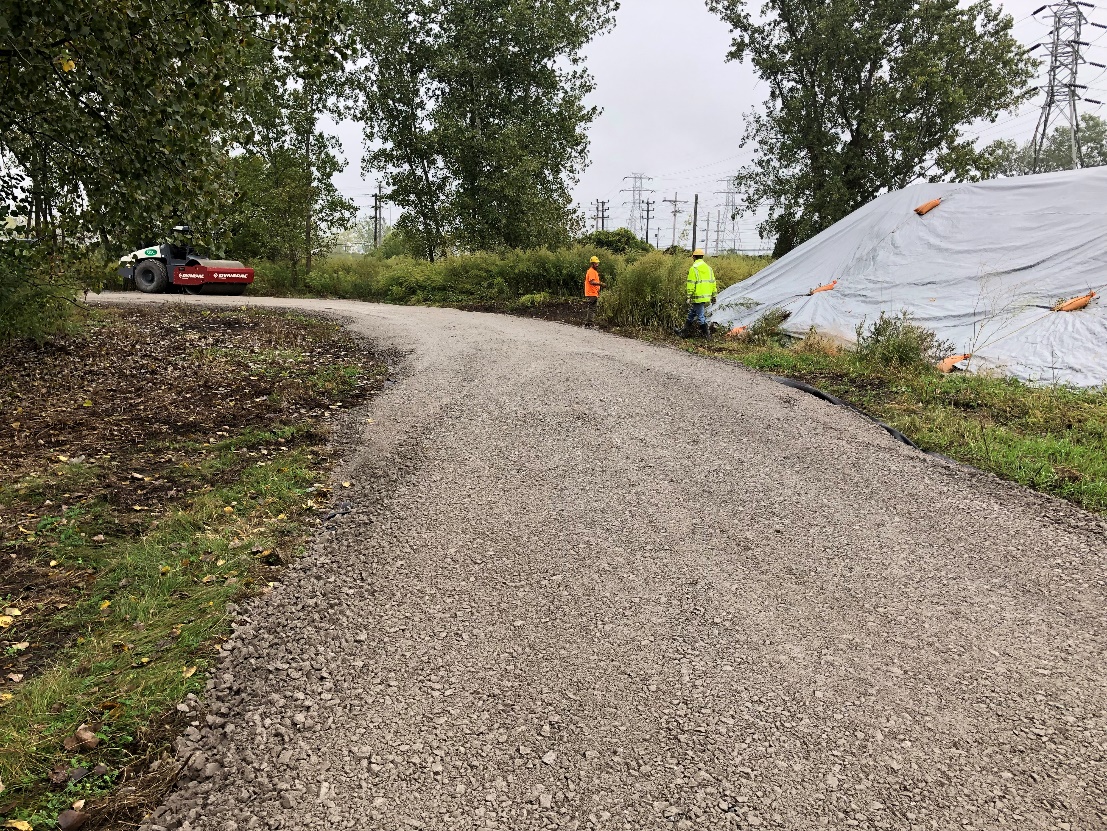

September 2019 - View looking west. Pathway cleared for access to other site piping.
Air Monitoring
January 2020

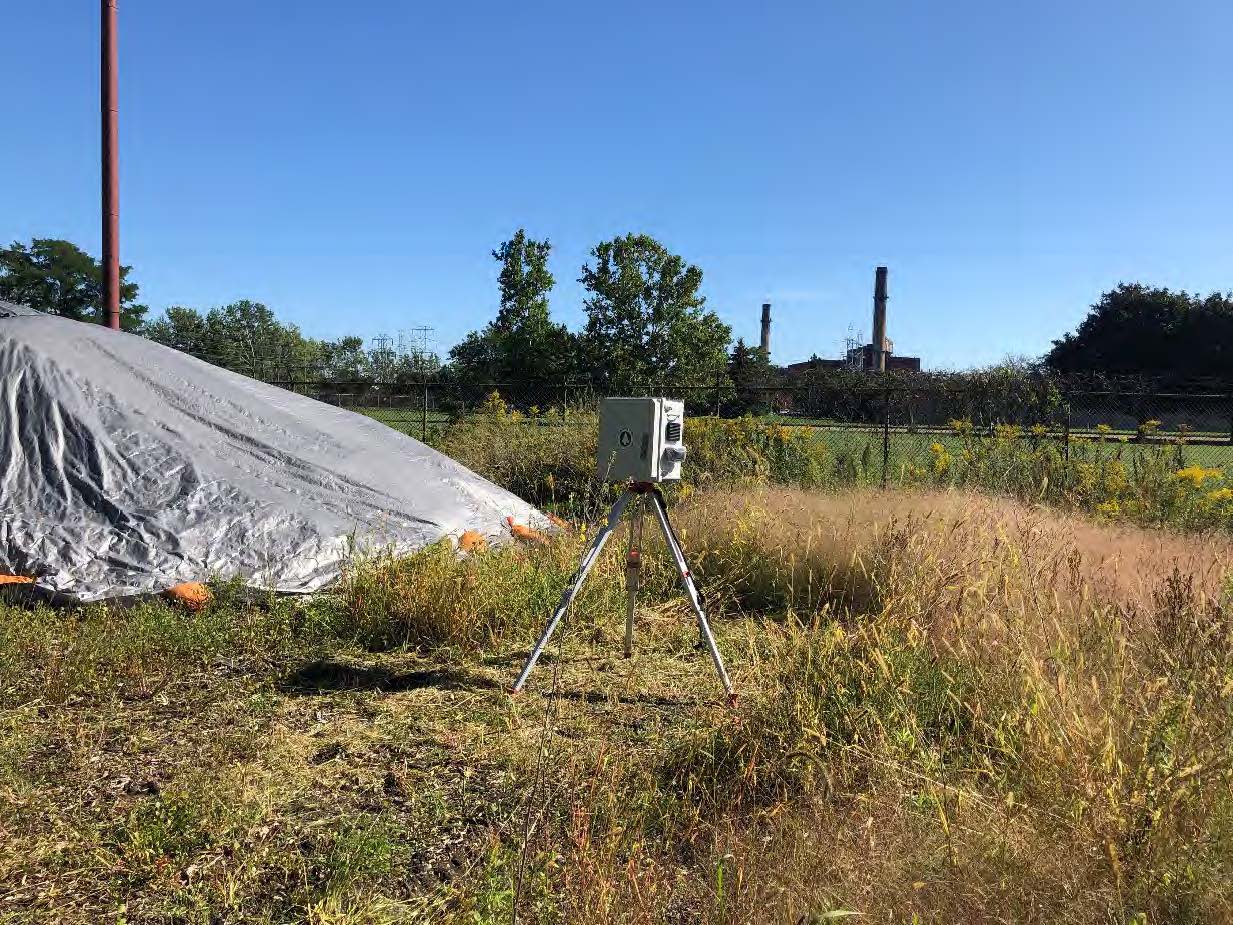

September 2019 - View looking north. Typical air monitoring station setup. Covered soil pile in the background.
Support Zones and Decontamination Pad
December 2019 - View looking north: Decontamination of mats. The mats are decontaminated prior to placement in staging area.

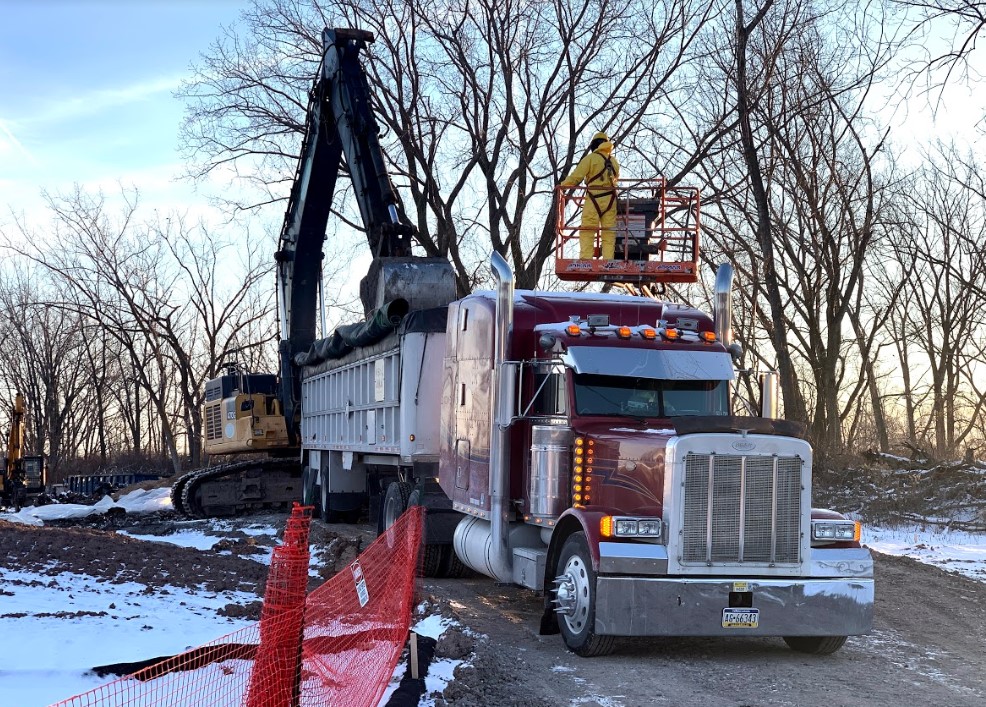

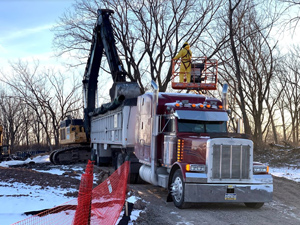

December 2019 - View looking south: On the extreme left, 4th frac tank is placed on the frac tank staging area.
December 2019 - View looking north: Decontamination of mats on the metal wash pad.
October 2019 - Site 108 - view looking northeast. Steel removed during tank demolition was stockpiled adjacent to Tank 3 within the berm area. Steel was picked up by the grapple and transferred to the decontamination pad for hot water high pressure cleaning.
October 2019 - Site 108 - view looking northwest. Steel decontamination pad with high pressure steam cleaner utilized to remove tar residuals from the tank steel.
October 2019 - Site 108 - view looking east. Durabase mats placed on top of nonwoven fabric.
October 2019 - Site 108 - view looking northwest. Decontamination area set up with nonwoven fabric and liner installed inside temporary construction fence.
October 2019 - Site 108 - view looking west. Setting up the pump and associated piping in preparation for discharge.
Tar Stabilization and Removal

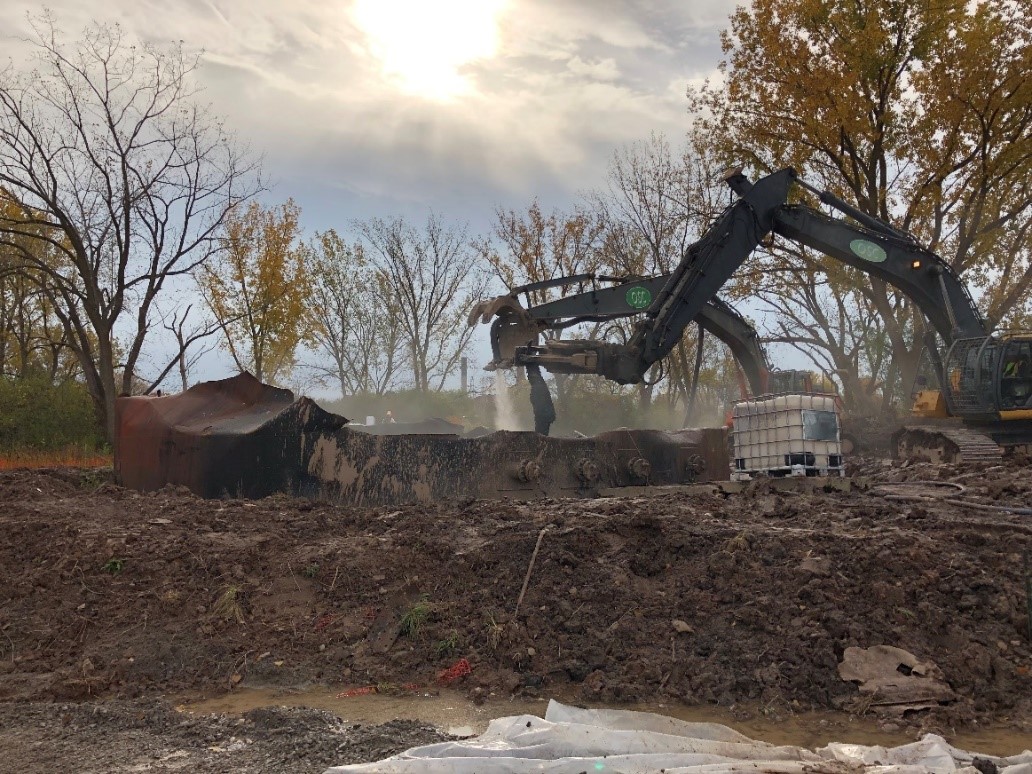

October 2019 - Site 108 - view looking north. Stabilized tar in Tank 3.
October 2019 - Site 108 - view looking west. Mixing and stabilizing tar in Tank 3.
October 2019 - Site 108 - view looking northwest. Mixing and stabilizing tar in Tank 3.
October 2019 - Site 108 - view looking east. Initiating stabilization of tar in Tank 3.
Tank Demolition

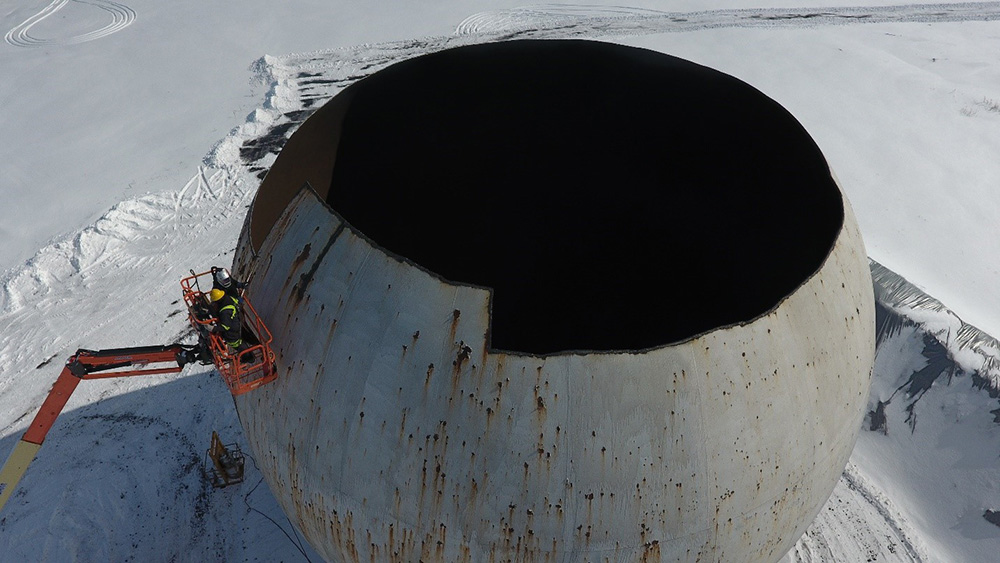

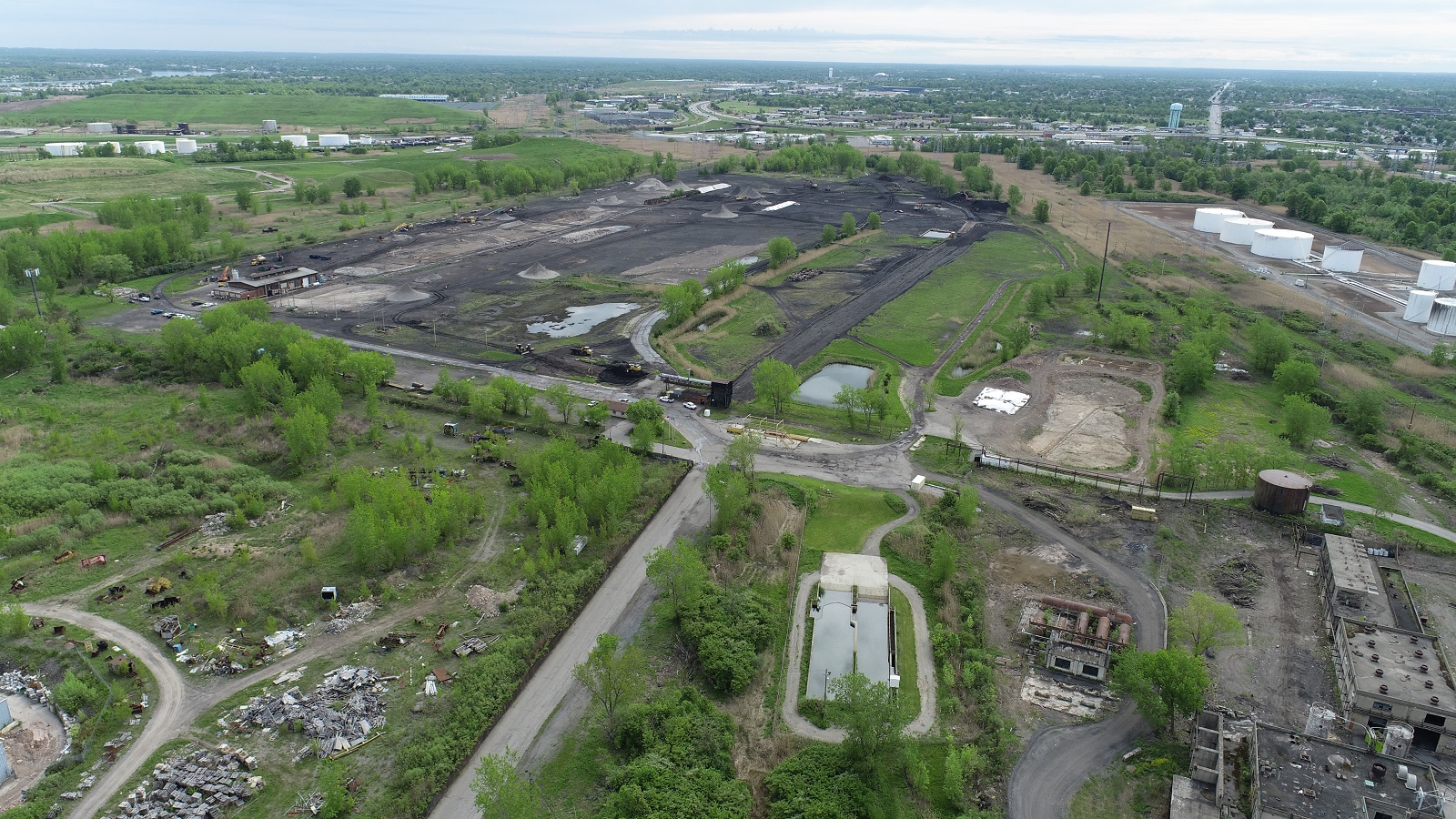

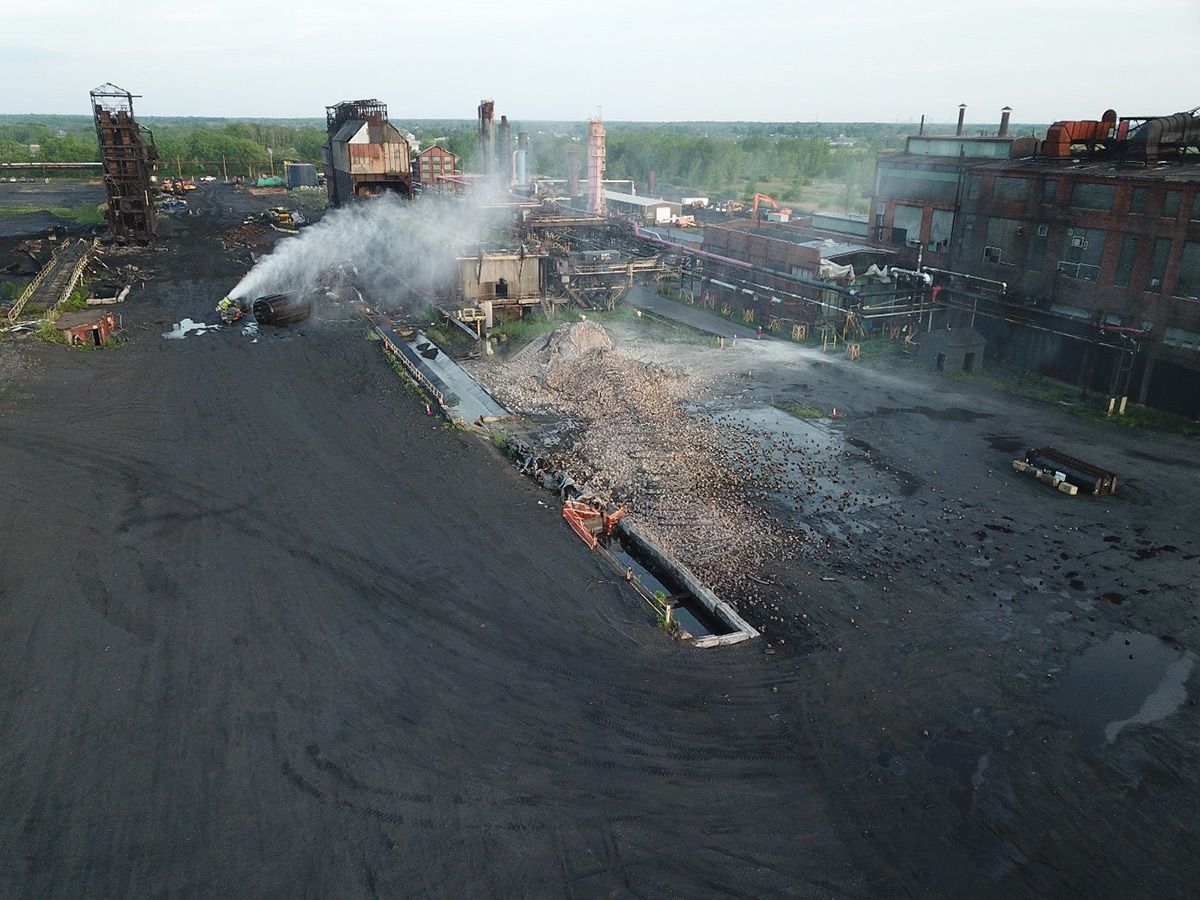

June 2020

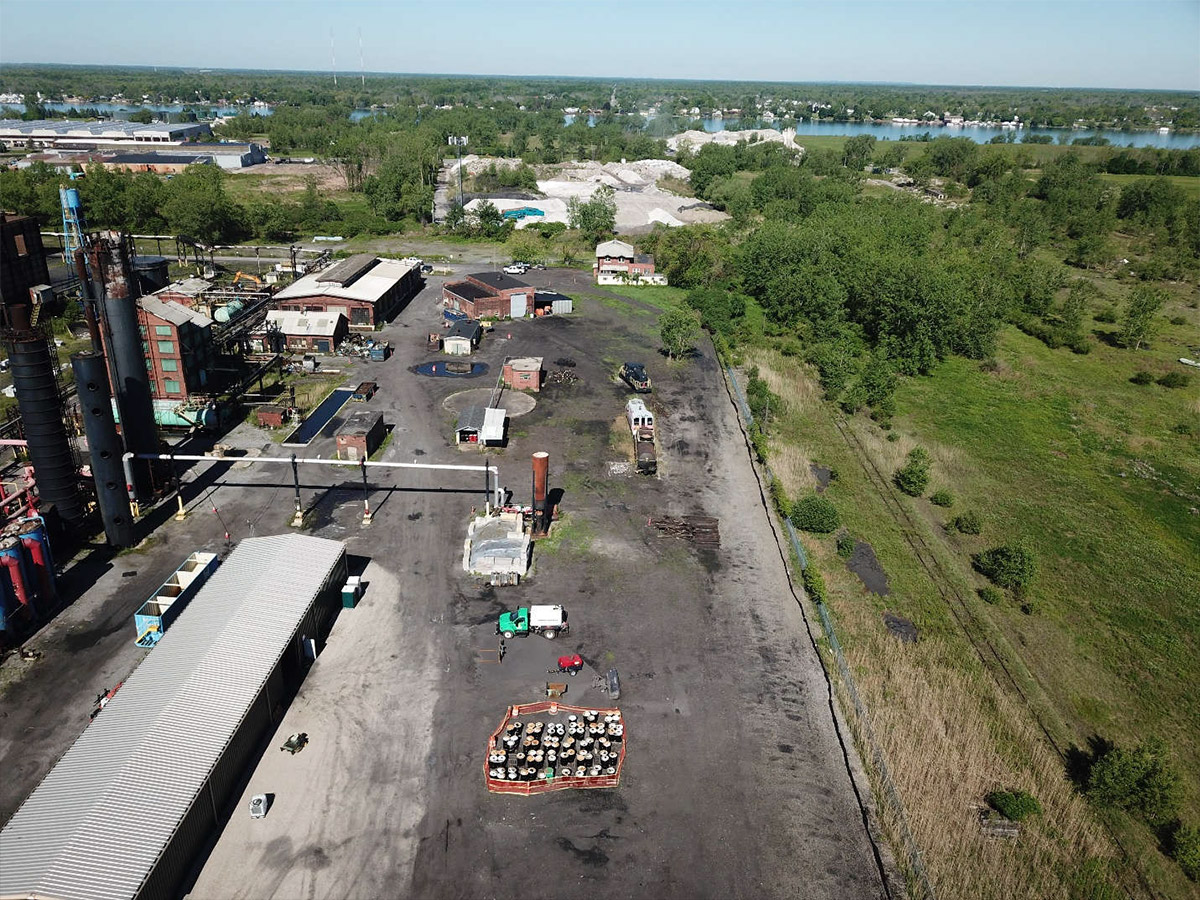

December 2019 - View looking north.

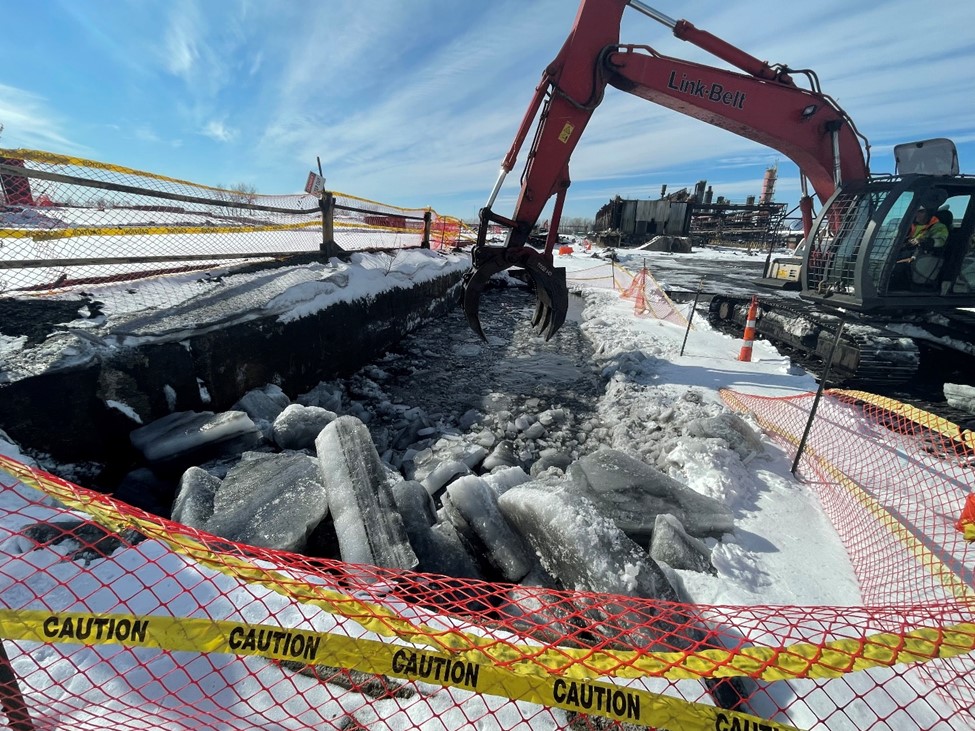

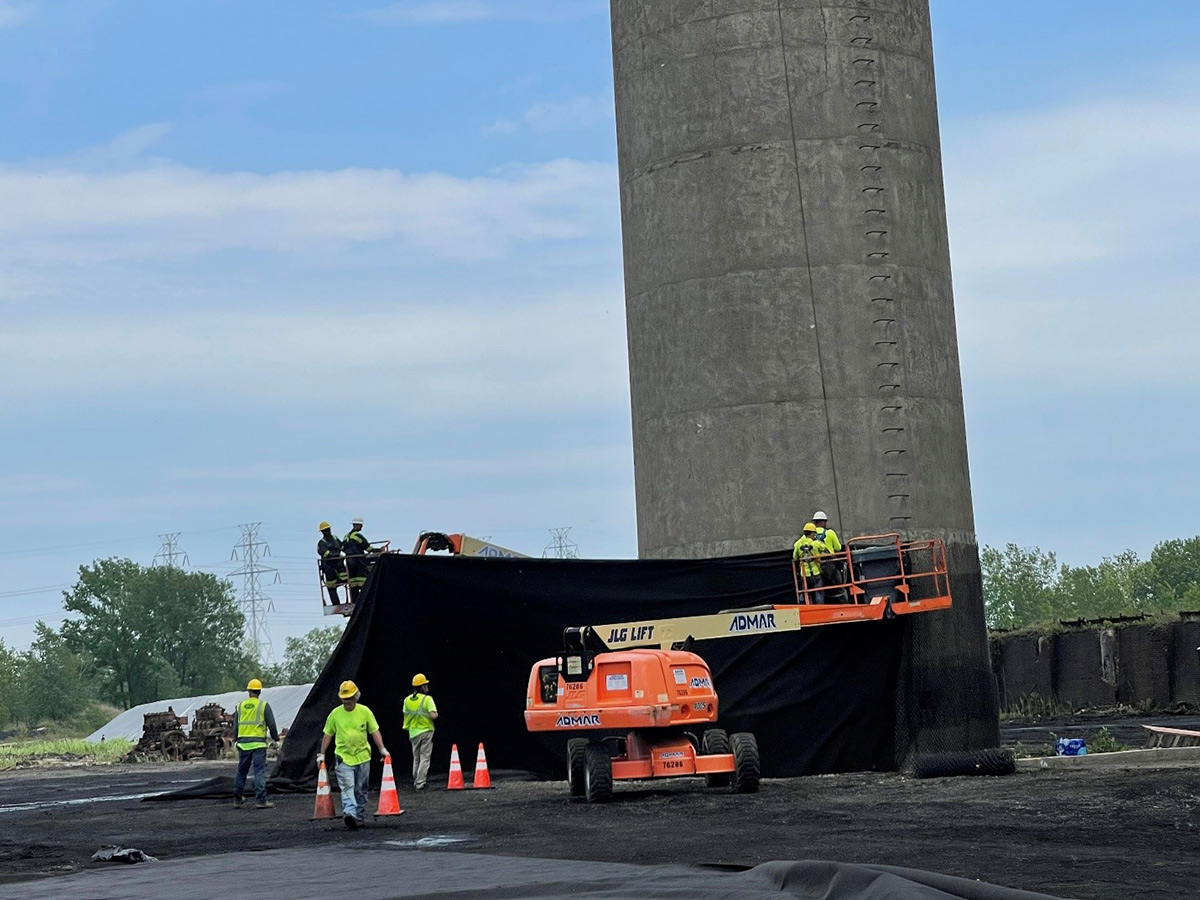

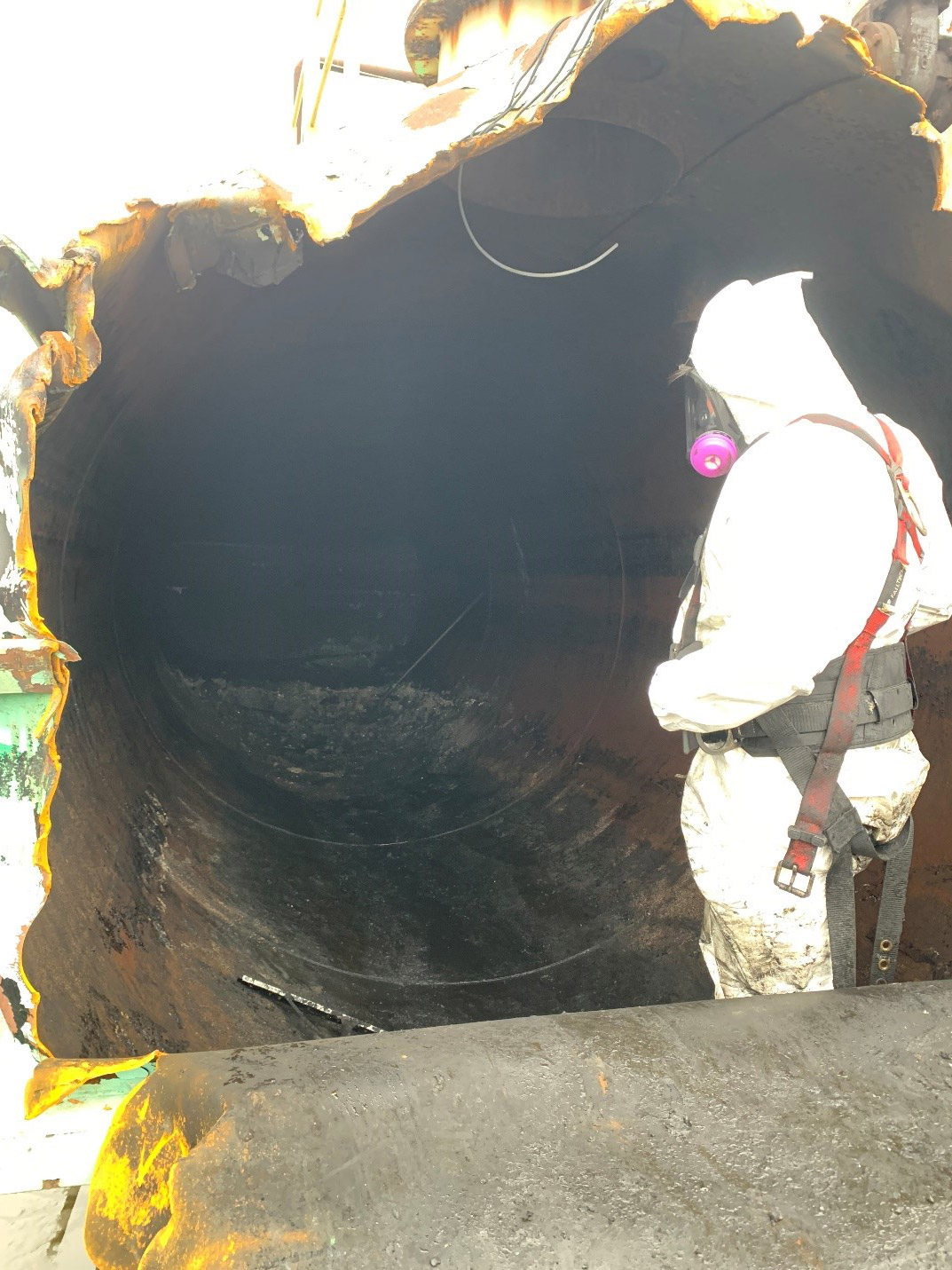

December 2019 - View looking north: Concrete in tank is broken up with the hydraulic hammer.
November 2019 - Site 108 - view looking northeast. Cutting and removal of Tank 2 sidewall.
November 2019 - Site 108 - view looking south. Tank 2 in the background; 60% of the sidewall panels have been removed.

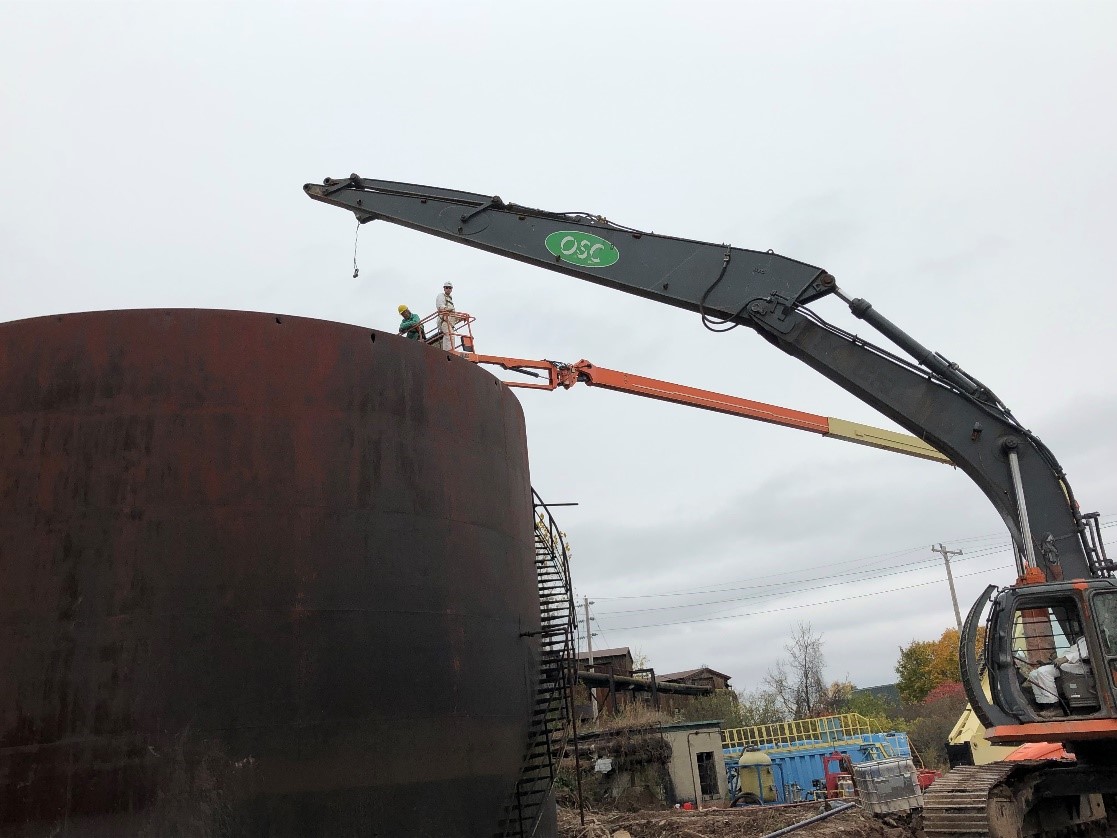

October 2019 - Site 108 - view looking west. Dry run for tank cutting operation. The manlift was used for transport and to evaluate reach and access. Long reach excavator was used to bring the cut pieces down from the top and side of the tank.
October 2019 - Site 108 - view looking northwest. Shear used to size steel piping impacted by tar from Tank 3.

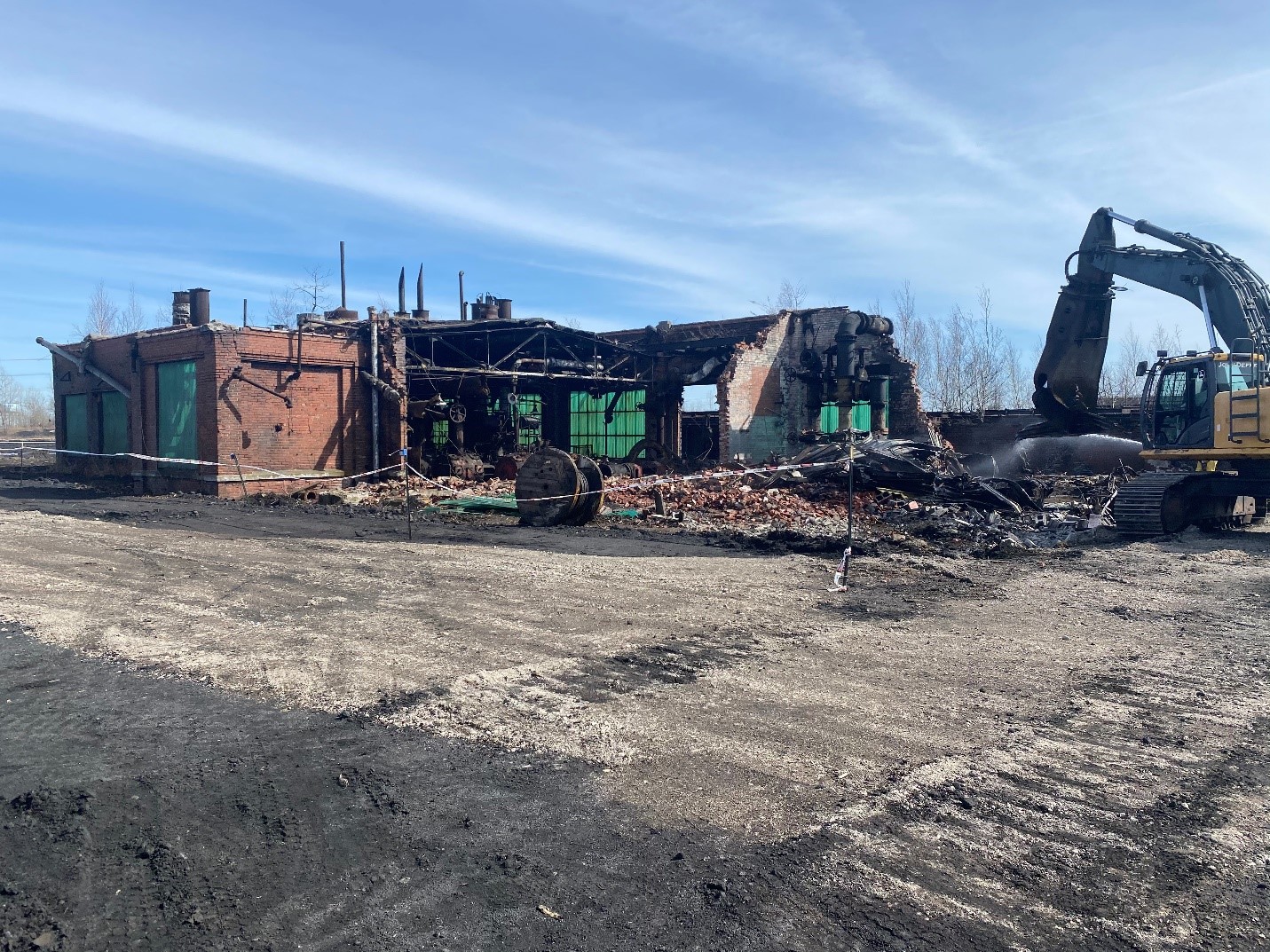

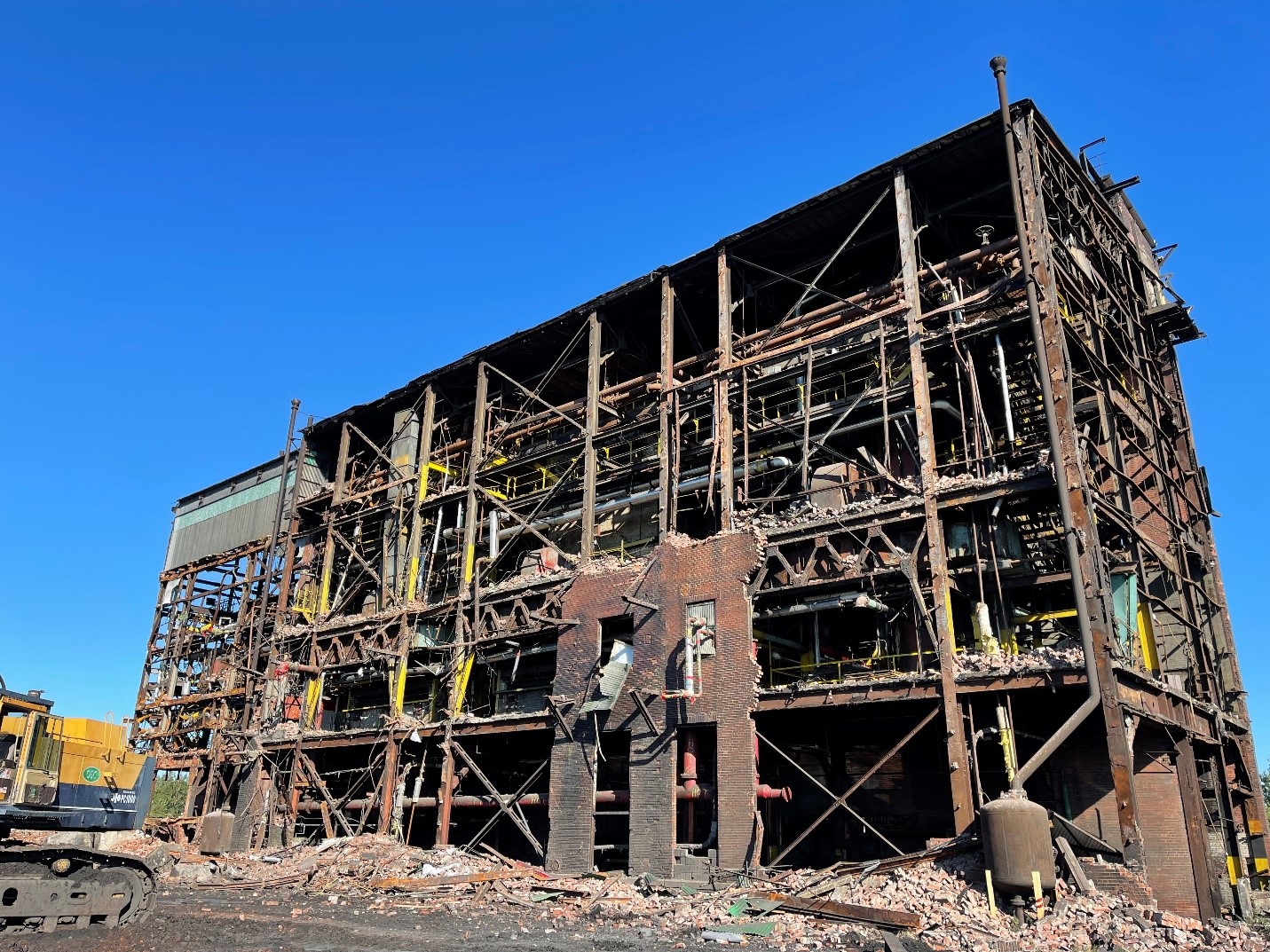

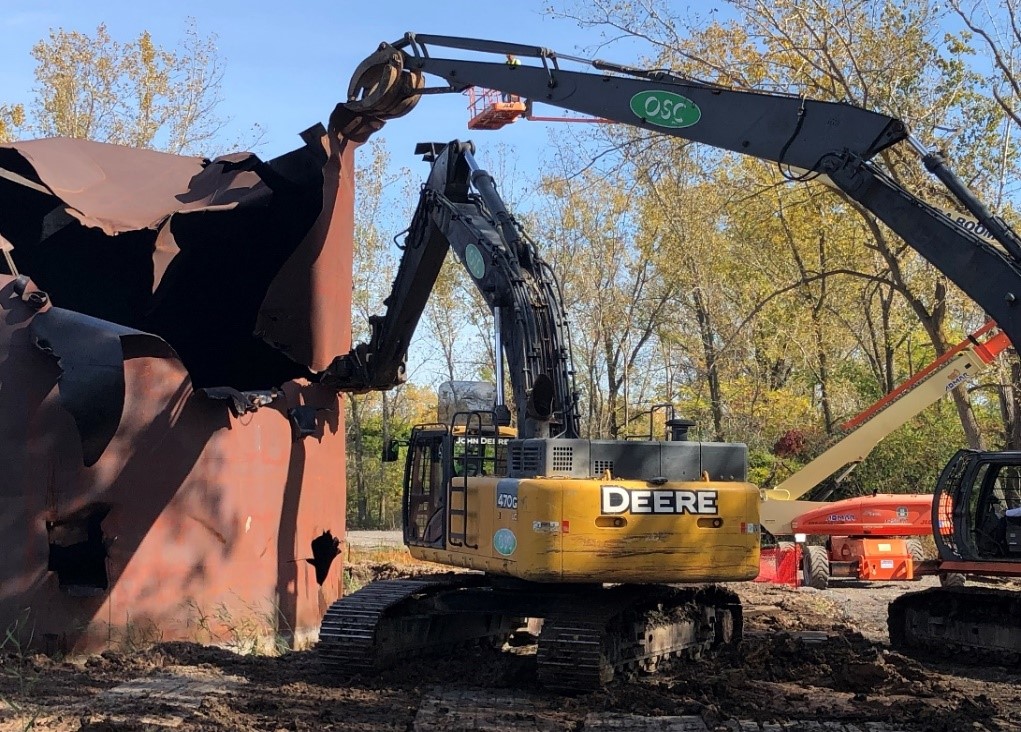

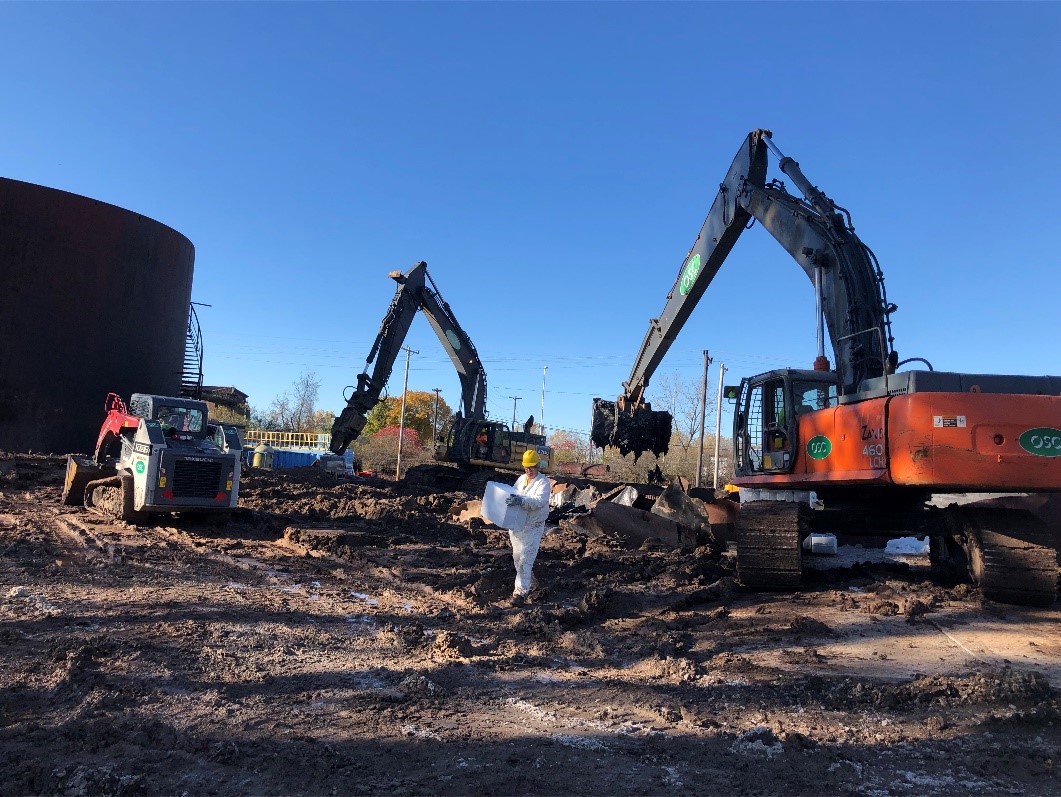

October 2019 - Site 108 - view looking east. Last stage of the tank demolition.

October 2019 - Site 108 - view looking northeast. Grapple can be seen holding the steel in place, while the shear attachment cuts the steel.
Transportation and Disposal
December 2019 - View looking north: Metal debris loaded into a sealed roll-off container for micro-encapsulation.
December 2019 - View looking north-east: Concrete from tank pad 1 and 2 is sent off the site for micro-encapsulation.
December 2019 - View looking West: Concrete loaded into trucks for transporting offsite.
December 2019 - View looking east: Fragmented concrete is sent off-site.
December 2019 - View looking North: Sheet steel is folded several times into manageable sections, then loaded into the roll-off containers. All steel is inspected by the EPA designee before loading into the container.

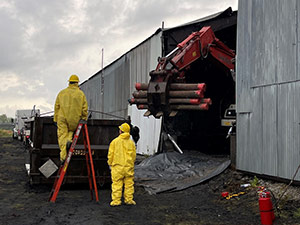

November 2019 - Site 108 - view looking south. Long stick excavator loading stabilized tar; manlift used to assist excavator operator in placing the load evenly in the bed of the trailer. Tank 3 is visible on the right side.
November 2019 - Site 108 - view looking west. Long stick excavator fitted with a smooth blade for loading stabilized tar into tractor trailers; Tank 2 is visible in the background.
November 2019 - Site 108 - view looking east. Truck loading area; Tank 3 is visible on the left side.

Asbestos Inspection and Removal

June 2020

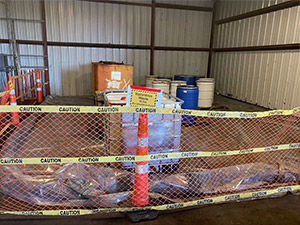

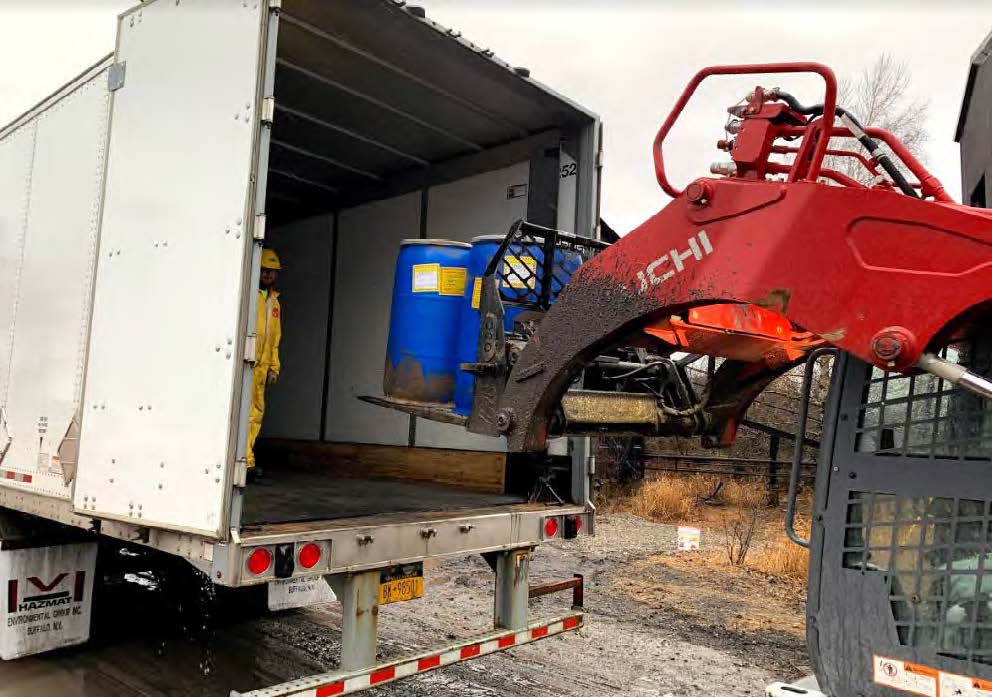

December 2019 - View looking west: Drums filled with mixed waste (asbestos and K142) loaded for disposal transport.

December 2019 - View looking north: Subsurface asbestos removal from south side of pump house.
December 2019 - View looking southwest: Careful inspection is conducted by the certified asbestos contractor on every excavator bucket of soil to ensure asbestos has been removed.

October 2019 - Site 108 -view looking west. Asbestos inspection and survey of the elevated piping.
Site 108 Investigations
December 2020 - Surveying of monitoring wells

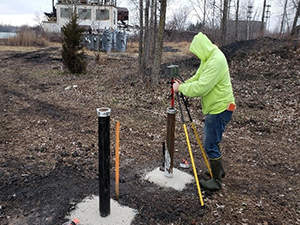

December 2020 - Installation of a monitoring well

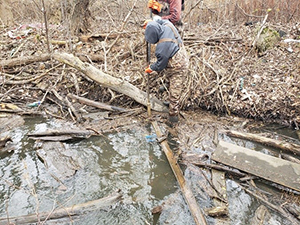

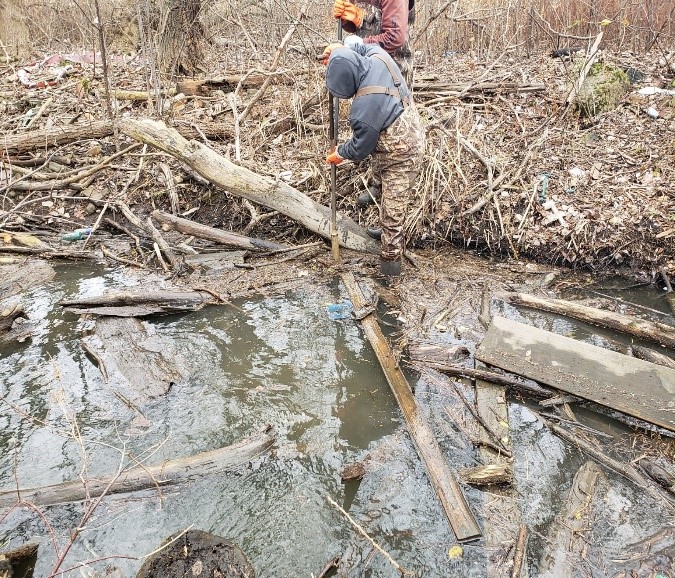

December 2020 - Collection of samples from ditch sediment by hand auger

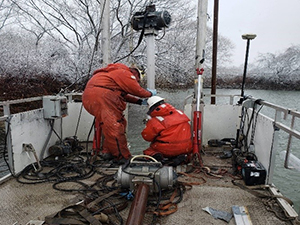

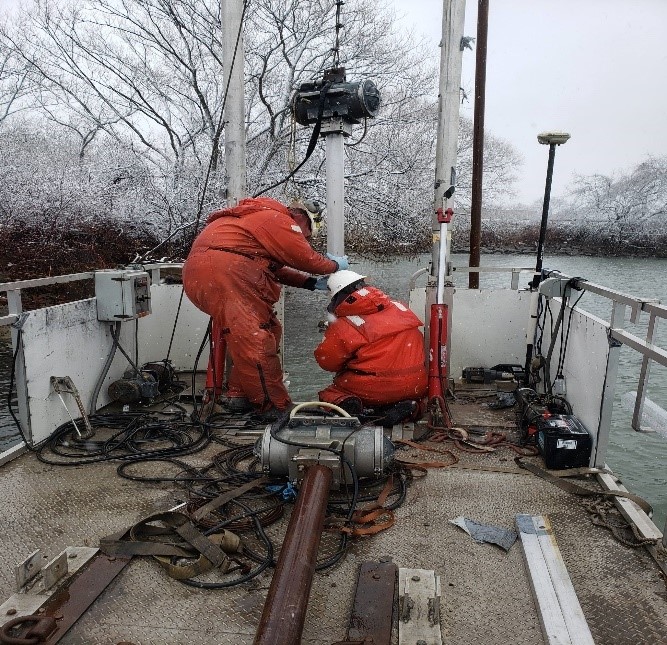

December 2020 - Collection of sediment cores on the Niagara River adjacent to Site 108
December 2020 - Removal of a sediment core from the drilling equipment

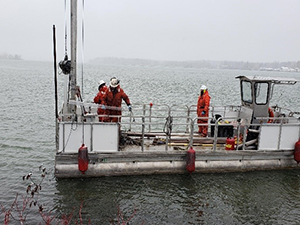

December 2020 - Collection of sediment samples on the Niagara River adjacent to Site 108

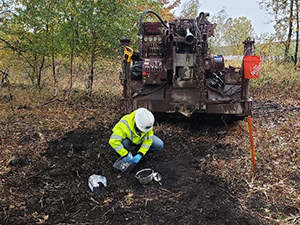

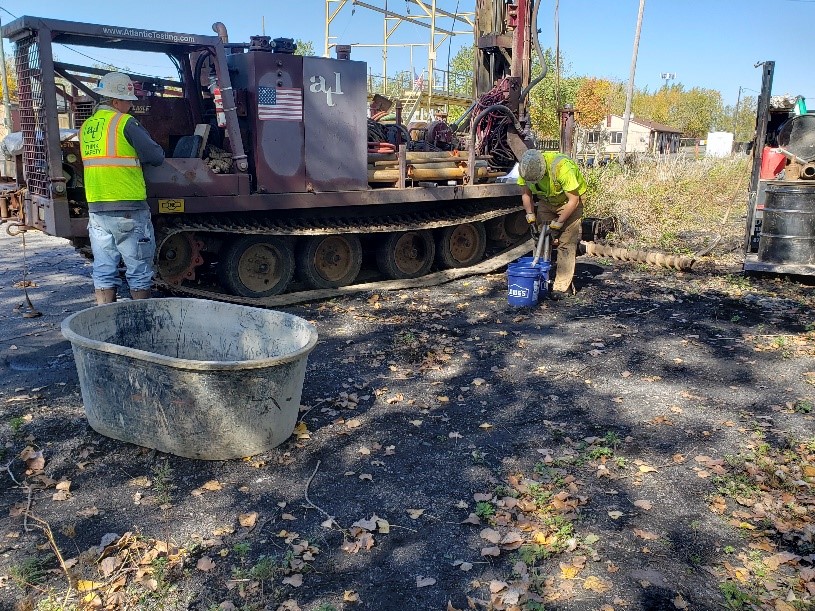

November 2020 - Using an air knife to hand clear for underground utilities prior to drilling
November 2020 - Installing the protective casing on a monitoring well

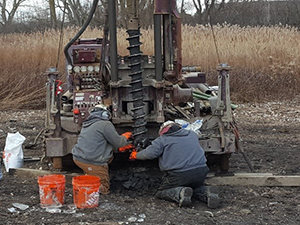

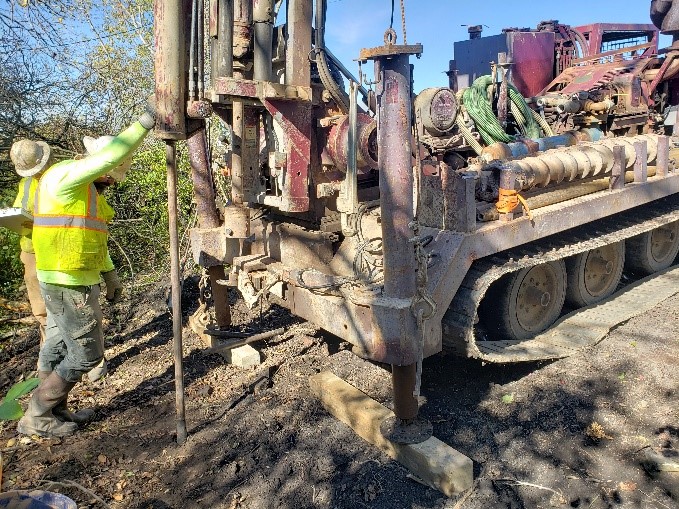

November 2020 - Drilling for monitoring well isntallation
November 2020 - Logging soil from a split spoon soil sample
November 2020 - Test pit excavation along the former conveyor
November 2020 - Excavating a test pit in the breeze stockpile
November 2020 - A survey contractor surveying the location and elevation of one end of a test pit
November 2020 - Test pit excavation
November 2020 - Test pit excavation
November 2020 - Test pit excavation
Backfilling / Grading
January 2020
January 2020
January 2020

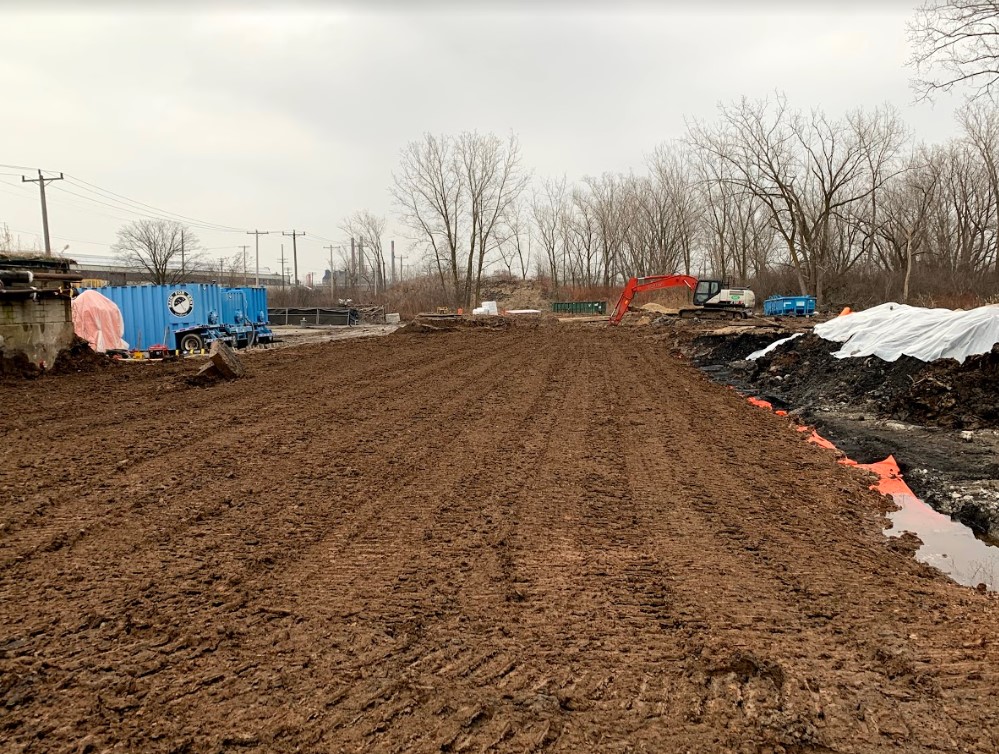

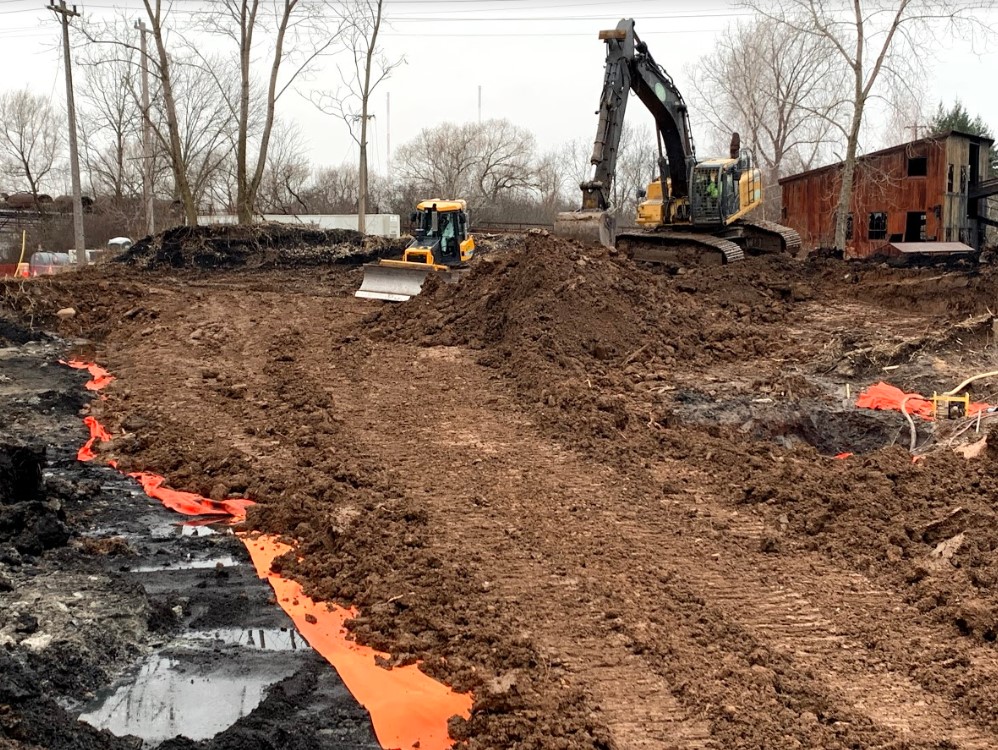

December 2019 - View looking north: Backfill and grading of Tank 1 area.
Fish and Wildlife Impact Analysis
October 2020
October 2020
October 2020
October 2020
October 2020
Site 109 & Site 110
October 2020 - Decontaminating spoons at Site 109
October 2020 - Collecting surface and near surface soil samples at a drilling location at Site 110
October 2020 - Logging a split spoon soil sample at Site 109
October 2020 - Drilling at Site 109
October 2020 - Hand clearing using an air knife prior to drilling at Site 109
